Table
of Contents                                                                                                                     Page
2......... Project Information
2.3                    Construction

Programme and Activities
2.5                    Status of
Environmental Licences, Notification and Permits
3......... Environmental Monitoring Requirements
3.1                    Construction Dust
Monitoring
3.2                    Construction Noise
Monitoring
4......... Implementation
Status of Environmental Mitigation Measures
5.1                    Construction Dust
Monitoring
5.2                    Regular
Construction Noise Monitoring
6......... ENVIRONMENTAL
SITE INSPECTION AND AUDIT
7......... Environmental Non-conformance
7.1                    Summary of
Monitoring Exceedances
7.2                    Summary of
Environmental Non-Compliance
7.3                    Summary of
Environmental Complaints
7.4                    Summary of
Environmental Summon and Successful Prosecutions
8.1                    Construction
Programme for the Next Three Months
8.2                    Key Issues for the
Coming Month
8.3                    Monitoring
Schedule for the Coming Month
9......... ConclusionS AND
RECOMMENDATIONS
List
of Tables
Table 2.1........... Construction
Activities in the reporting month
Table 2.2........... Contact Information of Key Personnel
Table 2.3........... Status of Environmental Licenses, Notifications and Permits
Table 3.1 ......... Air Quality Monitoring Equipment
Table 3.2 ......... Location of Construction Dust Monitoring Station
Table 3.3 ......... Noise
Monitoring Parameters, Frequency and Duration
Table 3.4 ......... Noise Monitoring Equipment for Regular Noise Monitoring
Table 3.5 ......... Noise
Monitoring Stations during Construction Phase
Table 3.6 ......... Noise
Monitoring Parameters, Frequency and Duration
Table 4.1........... Status of Required
Submission under Environmental Permit
Table 5.1 ......... Summary of
24-hour TSP Monitoring Result in the Reporting Period
Table 5.2 ......... Summary of
1-hour TSP Monitoring Result in the Reporting Period
Table 5.3 ......... Summary of
Construction Noise Monitoring Results in the Reporting Period
Table 6.1 ......... Observations
and Recommendations of Site Audit
Table 8.1........... Construction
Activities in the coming three months
List of Figures
| Site Layout Plan | |
| Location of Air
  Quality Monitoring Station | |
| Locations of Noise
  Monitoring Station |
List
of Appendices
| Construction Programme | |
| Project
  Organization Structure | |
| Implementation Schedule
  of Environmental Mitigation Measures | |
| Summary of Action
  and Limit Levels | |
| Calibration
  Certificates of Equipment | |
| EM&A Monitoring
  Schedules | |
| Air Quality
  Monitoring Results and their Graphical Presentations | |
| Noise Monitoring
  Results and their Graphical Presentations | |
| Event and Action
  Plan | |
| Cumulative
  Statistics on Complaints, Notification of Summons and Successful Prosecutions
   | |
| Monthly Summary
  Waste Flow Table |
Central Kowloon Route – Kai Tak West (CKR-KTW; Contract No. HY/2014/07)
(hereafter called “the Project”) covers part of the construction of the Central
Kowloon Route (CKR).
The Project comprises
the follow works:
·
50x30m access shaft with noise enclosure
at Ma Tau Kok (MTK);
·
100m long cut-and-cover (C&C) tunnel
at MTK;
·
Demolition and re-provisioning of MTK
Public Pier;
·
160m long underwater tunnel (UWT) (Stage 1);
·
210m long UWT (Stage 2);
·
60m long C&C tunnel at Kai Tak;
·
130m long depressed road and 200m long
underpass at Kai Tak;
·
390m long underground tunnel ventilation
audit at Kai Tak;
·
Seawall demolition and construction of new
landing steps; and
·
Barging Point enclosure and conveyor
system.
The EM&A programme commenced on 4 April 2018.The impact EM&A for the Project includes
air quality and noise monitoring.
This is the 80th
monthly EM&A Report presenting the EM&A works carried out during the
period between 1 and 30 November 2024. As informed by the Contractor, major
activities in the reporting period were:
| Locations | Site Activities |
| Kai Tak | - Defect rectification works at
  underpass, depressed road and C&C |
| Ma Tau Kok | - Temporary traffic management (TTM) implementation; |
| Kowloon Bay | - Removal of Excavation and
  Lateral Support (ELS) at Stage 2 UWT; |
Breaches
of Action and Limit Levels for Air Quality
All
24-hour TSP result was below the Action and Limit Levels at all monitoring
locations in the reporting month.
All
1-hour TSP result was below the Action and Limit Levels at all monitoring
locations in the reporting month.
Breaches
of Action and Limit Levels for Noise
Regular
Noise Monitoring
No exceedance of Action and Limit level of
noise was recorded in the reporting month.
Complaint,
Notification of Summons and Successful Prosecution
One (1) complaint was received in the reporting month (November 2024).
The complaint was investigated and have been provided in this reporting month
(November 2024).
Reporting
Changes
No report changes in the reporting period.
Future
Key Issues
Key issues to be
considered in the next three months included:
| Locations | Site Activities |
| Kai Tak | - Defect rectification works at
  underpass, depressed road and C&C |
| Ma Tau Kok | - TTM implementation; |
| Kowloon Bay | - Removal of Excavation and
  Lateral Support (ELS) at Stage 2 UWT; |
·     Section 1: Introduction
·     Section 2: Project Information
·     Section 3: Environmental Monitoring Requirement
·     Section 4: Implementation Status of Environmental Mitigation Measures
·     Section 5: Monitoring Results
·     Section 6: Environmental Site Inspection and Audit
·     Section 7: Environmental Non-conformance
·     Section 8: Future Key Issues
· Section 9: Conclusions and Recommendations
(a)
construction of approximately 160m long
cut-and-cover tunnel and 370m long underwater tunnel between the tunnel section
at Ma Tau Kok and the depressed road of the CKR within Kai Tak Development;
(b)
reconstruction of the seawall at Ma Tau
Kok public pier, and the sloping seawall at the Former Kai Tak Airport Runway;
(c)
construction of approximately 125m long
depressed road and 200m long underpass of the CKR within Kai Tak Development;
(d)
construction of approximately 360m long
underground tunnel ventilation adit of the CKR;
(e)
reconstruction of Kowloon City Ferry
Pier Public Transport Interchange; and
(f)
other associated works.
Table 2.1 Construction Activities in the reporting month
| Locations | Site Activities |
| Kai
  Tak | -
  Defect rectification works at underpass, depressed road and C&C |
| Ma
  Tau Kok | - Temporary
  traffic management (TTM) implementation; |
| Kowloon
  Bay | -
  Removal of Excavation and Lateral Support (ELS) at Stage 2 UWT; |
Table 2.2 Contact Information of Key Personnel
| Party | Role | Position | Name | Telephone | Fax |
| Arup-Mott
  MacDonald Joint Venture | Residential
  Engineer (ER) | Engineer’s Representative | Mr. Patrick Lo | 36195901 | 2268 3954 |
| ERM | Independent
  Environmental Checker (IEC) | Independent
  Environmental Checker | Ms. Mandy To | 2271 3113 | 3015 8052 |
| Gammon | Contractor | Contracts Manager | Mr. Kin Fai Tam | 2516 8823 | 2516 6260 |
| Environmental Manager | Ms. Michelle Tang | 9267 8866 | 2516 6260 | ||
| AECOM | Contractor’s
  Environmental Team (ET) | ET Leader | Mr. Y. W. Fung | 3856 5681 | 2317 7609 |
Table 2.3          Status of Environmental Licenses, Notifications and Permits
| Permit / License No. / Notification/
   Reference No. | Valid Period | Status | Remarks | |
| From | To | |||
| Further Environmental Permit | ||||
| FEP-01/457/2013/C | 28 Feb 2018 | End of Project | Valid | -- |
| Wastewater Discharge License | ||||
| WT00043692-2023 | 1 Apr 2023 | 31 Mar 2028 | Valid | Ma Tau Kok |
| WT00043881-2023 | 30 Jun 2023 | 30 Jun 2028 | Valid | Underwater Tunnel  Stage 2 |
| WT00044013-2023 | 1 May 2023 | 30 Apr 2028 | Valid | Kai Tak and Underwater Tunnel Stage 1 |
| Construction Noise Permit | ||||
| GW-RE0618-24 | 1 Jun 2024 | 30 Nov 2024 | Valid | General Works at Ma Tau Kok |
| GW-RE1173-24 | 1 Oct 2024 | 31 Mar 2025 | Valid | General Works at Kai Tak |
| GW-RE1300-24 | 21 Oct 2024 | 20 Apr 2025 | Valid | General Works at Promenade |
| GW-RE0585-24 GW-RE1423-24 | 19 May 2024 19 Nov 2024 | 18 Nov 2024 18 May 2025 | Expired Valid | General Works at Stage 1 Underwater Tunnel |
| GW-RE0627-24 | 7 Jun 2024 | 6 Dec 2024 | Valid | General Works at Stage 2 Underwater Tunnel |
| GW-RE1149-24 | 19 Sep 2024 | 18 Mar 2025 | Valid | Kai Tak Access Road |
| Chemical
  Waste Producer Registration | ||||
| 5118-247-G2347-47 | 30 Jan 2018 | End of Project | Valid | -- |
| 5118-247-G2347-48 | 30 Jan 2018 | End of Project | Valid | -- |
| Marine Dumping Permit | ||||
| -- | -- | -- | -- | -- |
| Billing Account for Construction
  Waste Disposal | ||||
| 7029909 | 22 Jan 2018 | End of Project | Account Active | -- |
| Notification Under Air Pollution
  Control (Construction Dust) Regulation | ||||
| 429442 | 5 Jan 2018 | 5 Jul 2025 | Notified | -- |
|  | ||||
Monitoring Requirements
Monitoring Equipment
Table 3.1 Air Quality Monitoring Equipment
| Tisch
  Total Suspended Particulate Mass Flow Controlled High Volume Air Sampler  | |
| Calibration
  Kit (24-hour
  TSP) | TISCH
  Environmental Orifice |
| Portable
  direct reading dust meter | Sibata Digital Dust Monitor  |
Monitoring Locations
Table 3.2 Location of Construction Dust Monitoring Station
| Location | Monitoring Station | Description |
| E-A14a
  [1] | Block
  B of Merit Industrial Centre  | Rooftop
  (13/F) |
[1] The air monitoring station proposed in the
EM&A Manual (i.e. Wyler Gardens with ID: E-A14) was not available for
impact dust monitoring, therefore impact monitoring was conducted at E-A14a as
an alternative which was agreed by the ER, IEC and EPD.
Monitoring
Methodology
(a)
The HVS was
installed in the vicinity of the air sensitive receivers.  The following criteria were considered in the
installation of the
HVS as far as practicable: -
(i)
A horizontal platform with appropriate
support to secure the sampler against gusty wind was provided.
(ii)
Two samplers should
not be placed less than 2m apart from each other;
(iii)
The distance between the HVS and
any obstacles, such as buildings, was at least twice the height that the
obstacle protrudes above the HVS.
(iv)
A minimum of 2 meters separation
from walls, parapets and penthouse for rooftop sampler.
(v)
A minimum of 2 meters separation from
any supporting structure, measured horizontally is required.
(vi)
No furnace or incinerator flues
nearby.
(vii)
Airflow around the sampler was
unrestricted.
(viii)
The sampler was located more than
20 meters from any dripline.
(ix)
Any wire fence and gate, required
to protect the sampler, did not obstruct the monitoring process.
(x)
Permission was obtained to set up
the samplers and access to the monitoring station.
(xi)
A secured supply of electricity
was obtained to operate the sampler.
(b)
Preparation of
Filter Papers
(i)
Glass fibre filters, G810 were
labelled and sufficient filters that were clean and without pinholes were
selected.
(ii)
All filters were equilibrated in
the conditioning environment for 24 hours before weighing. The conditioning
environment temperature was around 25 °C and not variable by more than ±3 °C;
the relative humidity (RH) was < 50% and not variable by more than ±5%. A
convenient working RH was 40%.
(iii)
All filter papers were prepared
and analysed by ALS Technichem
(HK) Pty Ltd., which is a HOKLAS accredited laboratory and has comprehensive quality assurance and quality control programmes.
(c)
Field
Monitoring
(i)
The power supply was checked to ensure the HVS works properly.
(ii)
The filter holder and the area
surrounding the filter were cleaned.
(iii)
The filter holder was removed by
loosening the four bolts and a new filter, with stamped number upward, on a
supporting screen was aligned carefully.
(iv)
The filter was properly aligned
on the screen so that the gasket formed an airtight seal on the outer edges of
the filter.
(v)
The swing bolts were fastened to
hold the filter holder down to the frame. The pressure applied was sufficient
to avoid air leakage at the edges.
(vi)
Then the shelter lid was closed
and was secured with the aluminium strip.
(vii)
The HVS was warmed-up for about 5
minutes to establish run-temperature conditions.
(viii)
A new flow rate record sheet was
set into the flow recorder.
(ix)
On site temperature and atmospheric
pressure readings were taken and the flow rate of the HVS was checked and
adjusted at around 1.3 m3/min, and complied
with the range specified in the EM&A Manual (i.e. 0.6-1.7 m3/min).
(x)
The programmable digital timer
was set for a sampling period of 24 hrs, and the starting time, weather
condition and the filter number were recorded.
(xi)
The initial elapsed time was
recorded.
(xii)
At the end of sampling, on site
temperature and atmospheric pressure readings were taken and the final flow
rate of the HVS was checked and recorded.
(xiii)
The final elapsed time was
recorded.
(xiv)
The sampled filter was removed
carefully and folded in half length so that only
surfaces with collected particulate matter were in contact.
(xv)
It was then placed in a clean
envelope and sealed.
(xvi)
All monitoring information was
recorded on a standard data sheet.
(xvii)       Filters were then sent to ALS Technichem (HK) Pty Ltd. for analysis.
(d)
Maintenance and
Calibration
(i)
The HVS and its accessories were maintained in good working condition, such as
replacing motor brushes routinely and checking electrical wiring to ensure a
continuous power supply.
(ii)
HVSs were calibrated using
TE-5025A Calibration Kit upon installation and thereafter at bi-monthly
intervals.
(iii)
Calibration certificate of the TE-5025A Calibration Kit and the HVSs are provided in Appendix E.
(a)
Measuring Procedures
The measuring procedures of the 1-hour dust meter are in accordance with
the Manufacturer’s Instruction Manual as follows:
(i)
Turn the power on.
(ii)
Close the air collecting opening cover.
(iii)
Push the “TIME SETTING” switch to [BG]
(iv)
Push “START/STOP”
switch to perform background measurement for 6 seconds.
(v)
Turn the knob at SENSI ADJ position to insert
the light scattering plate.
(vi)
Leave the equipment for 1 minute upon “SPAN
CHECK” is indicated in the display.
(vii)
Push “START/STOP” switch to perform automatic
sensitivity adjustment. This measurement takes 1 minute.
(viii)
Pull out the knob and return it to MEASURE
position.
(ix)
Push the “TIME SETTING” switch the time set
in the display to 3 hours.
(x)
Lower down the air collection opening cover.
(xi)
Push “START/STOP” switch to start
measurement.
(b)
Maintenance and Calibration
(i)
The 1-hour TSP meter was
calibrated at 1-year intervals against a High Volume
Samplers.  Calibration certificates of the Laser Dust Monitors are provided in Appendix E.
Monitoring Schedule for the
Reporting Month
Monitoring Requirements
Table 3.3 Noise Monitoring Parameters, Frequency and Duration
| Parameter and Duration | Frequency |
| 30-mins
  measurement at each monitoring station between 0700 and 1900 on normal
  weekdays. Leq, L10 and L90
  would be recorded. | At least once per week |
Table 3.4 Noise Monitoring Equipment for Regular Noise Monitoring
| B&K (Model No. 2250 & 2250L) | |
| Acoustic
  Calibrator | B&K (Model
  No. 4231) Rion(Model
  No. NC-74) MVI(Model
  No. CAL21) |
Monitoring Locations
Table 3.5 Noise Monitoring Stations during Construction Phase
| Location | Monitoring Station | Description | Measurement |
| E-N12a [1] | 19 Hing Yan Street | Rooftop (9/F) | Façade |
| E-N21a [1] | Block B of Merit Industrial Centre | Rooftop (13/F) | Free field[2] |
Notes:
[1] The noise monitoring stations proposed in the EM&A Manual
(i.e. Grand Waterfront Tower 3 with ID: E-N12 and Hang Chien Court Block J with
ID: E-N21) were not available for impact noise monitoring, therefore impact
monitoring was conducted at E-N12a and E-N21a as an alternative which was
agreed by the ER, IEC and EPD.
[2]  A correction of +3 dB(A)
was made to the free field measurements.
Monitoring Parameters, Frequency and Duration
Table 3.6 Noise Monitoring Parameters, Frequency and Duration
| Location | Parameter and Duration | Frequency |
| E-N12a
  and E-N21a | 30-mins measurement at each monitoring
  station between 0700 and 1900 on normal weekdays. Leq,
  L10 and L90 would be recorded. | At
  least once per week |
Monitoring Methodology
(a)
The sound level meter was set on
a tripod at a height of 1.2 m above the ground.
(b)
Façade measurement was made at
E-N12a.
(c)
Free field measurements was made at monitoring location E-N21a. A correction of +3
dB(A) shall be made to the free field measurements.
(d)
The battery condition was checked to ensure the correct
functioning of the meter.
(e)
Parameters such as frequency
weighting, the time weighting and the measurement time were set as follows:
(i)
frequency weighting
(ii)
time weighting: Fast
(iii)
time measurement: Leq(30-minutes) during non-restricted
hours i.e. 0700 – 1900 on normal weekdays.
(f)
Prior to and after each noise
measurement, the meter was calibrated using the acoustic calibrator for 94
dB(A) at 1000 Hz.  If the difference in
the calibration level before and after measurement was more than 1 dB(A), the
measurement would be considered invalid and repeat of noise measurement would
be required after re-calibration or repair of the equipment.
(g)
During the monitoring period, the
Leq, L10 and L90
were recorded.  In addition, site
conditions and noise sources were recorded on a standard record sheet.
(h)
Noise measurement was paused
during periods of high intrusive noise (e.g. dog barking, helicopter noise) if
possible. Observations were recorded when intrusive noise was unavoidable.
(i)
Noise monitoring was cancelled in
the presence of fog, rain, wind with a steady speed exceeding 5m/s, or wind
with gusts exceeding 10m/s.
(a)
The microphone
head of the sound level meter was cleaned with soft cloth at
regular intervals.
(b)
The meter and
calibrator were sent to the supplier or HOKLAS laboratory to check and
calibrate at yearly intervals.
(c)
Calibration
certificates of the sound level meters and acoustic
calibrators are provided in Appendix E.
Monitoring
Schedule for the Reporting Month
Table 4.1 Status of Required Submission under Environmental Permit
| EP Condition | Submission | Submission
   Date |
| Condition 3.4 of  | Monthly EM&A Report for  October
  2024 | 14 November 2024 |
Table 5.1         Summary of 24-hour
TSP Monitoring Result in the Reporting Period
| ID | Average (mg/m3) | Range (mg/m3) | Action Level (mg/m3) | Limit Level (mg/m3) |
| E-A14a | 42.2 | 26.0 - 60.8 | 197.3 | 260 |
Table 5.2 Summary of 1-hour TSP Monitoring Result in the Reporting Period
| ID | Average (mg/m3) | Range (mg/m3) | Action Level (mg/m3) | Limit Level (mg/m3) |
| E-A14a | 61.1 | 57.7 – 63.5 | 302.4 | 500 |
Table 5.3 Summary of Construction Noise Monitoring Results in the Reporting Period
| ID | Range, dB(A), Leq (30 mins) | Limit Level, dB(A), Leq (30 mins) |
| E-N12a | 62.9 – 64.2 | 75 |
| E-N21a | 58.0
  – 58.6 | 75 |
Table 6.1         Observations and Recommendations of Site Audit
| Parameters | Date | Observations and Recommendations | Follow-up |
| Air Quality | 6
  November 2024 | Reminder: The contractor
  was reminded to provide watering at MTK site regularly. | The
  item was rectified by the Contractor on  |
| Noise | Nil | Nil | Nil |
| Water Quality | 20
  November 2024 | Observation: The silt curtain
  was observed not fully enclosed at Kai Tak Promenade. The Contractor should
  ensure the silt curtain was fully enclosed to prevent marine pullution. | The
  item was rectified by the Contractor on  |
| Waste/ Chemical Management | 20
  November 2024 | Reminder: The
  Contractor was reminded to provide dirp tray for the chemical container at
  Stage 2 marine platform. | The
  item was rectified by the Contractor on  |
| 27
  November 2024 | Reminder: The
  Contractor was reminded to provide a cover for the general refuse container
  at Stage 2 marine platform. | The
  item was rectified by the Contractor on  | |
| Landscape & Visual | Nil | Nil | Nil |
| Permits/ Licenses | Nil | Nil | Nil |
*The
item was under rectification on last reporting month.
Table 8.1          Construction Activities in the coming three months
| Locations | Site Activities |
| Kai
  Tak | -
  Defect rectification works at underpass, depressed road and C&C |
| Ma
  Tau Kok | -
  TTM implementation; |
| Kowloon
  Bay | -
  Removal of Excavation and Lateral Support (ELS) at Stage 2 UWT; |

Document control record
Document prepared
by:
Unit 1608, 16/F, Tower B,
Manulife Financial Centre
223 -231 Wai Yip Street, Kwun Tong, Kowloon,
 Hong Kong.
| T | 3664 6888 |
A person using
a)
Using
the documents or data in electronic form without requesting and checking them
for accuracy
b)
Using
the documents or data for any purpose not agreed to in writing by
c)
against
the original hard copy version.

3   Air
 Quality and Noise Monitoring
6   Summary of
 Complaints, Notification of Summons and Prosecutions
9   Conclusion
 and Recommendations
Appendices
Appendix A        Alignment and Works Site in Kai Tak West
Area for the Contract No. HY/2023/08
Appendix B        Construction
Programme
Appendix C        Project Organization Chart
Appendix D         Event and Action Plan (EAP) (Air Quality Monitoring)
Appendix E        Event
and Action Plan (EAP) (Noise Monitoring)
Appendix F         Environmental
Mitigation Implementation Schedule (EMIS)
Appendix G         Waste
Flow Table
Appendix H         Statistics
on Complaint, Notifications of Summons and Successful Prosecutions
1.1.1
Build King - Lee Tung Joint Venture
(“Contractor”) commenced the construction works of Highway Department (HyD)
Central Kowloon Route Contract No. HY/2023/08 – Central Kowloon Route –
Remaining Works at Kai Tak West Area (“The Project”) on 11
November 2024.
This is the 1st
monthly Environmental Monitoring and Audit (EM&A) report presenting the
EM&A works carried out in the Kai Tak West Area during the period from 11
November 2024 to 30 November 2024.
1.1.2
A summary of major construction
activities informed by the Contractor for the Project during the reporting
period is presented below.
| Construction Activities Undertaken in Kai Tak West
  Area |
| ·
  Site preparation and access set up for Part of Site 4C at
  Kai Tak Phase 2B Landscape Deck |
Environmental Monitoring and Audit Works
1.1.3
Regular construction air quality monitoring (24-hour TSP and 1-hour
TSP) and noise monitoring works in Kai Tak West Area are currently covered
under the Contract No. HY/2014/07 – Central Kowloon Route – Kai Tak West.  The details of the monitoring works could be
referred to Sections 3 and 5 of the corresponding Monthly EM&A Report for
Contract No. HY/2014/07.
1.1.4
Joint weekly site inspections were conducted by representatives
of the Environmental team (ET), the Contractor and the Engineer on 15, 22 and 29 November 2024. A joint site inspection with
the Independent Environmental Checker (IEC) was undertaken on 15 November 2024.  Bi-weekly inspection of the implementation of
landscape and visual mitigation measures was conducted by the ET on 15 and 29 November 2024. Details of the audit
findings and implementation status are presented in Section 7.  Details of waste management are presented in Section
4.
1.1.5
A summary of the non-compliance (exceedance) during the
reporting period is provided below.
-
No Action / Limit Level exceedance for 1-hour TSP was
recorded.
-
No Action / Limit Level exceedance for 24-hour TSP was recorded.
-
No Action / Limit Level exceedance for construction noise was
recorded.
Complaints, Notification of Summons and Successful Prosecution
1.1.6
No environmental related complaints, notification of summons and
successful prosecution were received in the reporting period.
Reporting Changes
1.1.7
There were no reporting changes during the reporting period.
Future Key Issues
1.1.8
A summary of construction activities informed by the Contractor for
the next reporting period are listed below:
| Construction
  Activities Undertaken in Kai Tak West Area |
| ·
  To complete site preparation works and site survey at Kai
  Tak Phase 2B Landscaped Deck |
1.1.1
Central Kowloon Route (CKR) is a 4.7 km long dual 3-lane trunk
road in Central Kowloon linking Yau Ma Tei Interchange in West Kowloon with the
road network on Kai Tak Development and Kowloon Bay in East Kowloon.
1.1.2
The Central Kowloon Route – Design and Construction
Environmental Impact Assessment Report (Register No.: AEIAR-171/2013) was
approved with conditions by the Environmental Protection Department (EPD) on 11
July 2013. An Environmental Permit (EP 457/2013) was issued on 9 August 2013.  Variations of EP (VEP)
was subsequently applied for and the latest EP (EP-457/2013/D) was issued by
EPD on 15 June 2021.
1.1.3
The construction of the CKR had been divided into different
sections.  Contract No. HY/2023/08 – Central Kowloon
Route – Remaining Works covers part of the construction activities located at
Kai Tak West Area and Yau Ma Tei Area under the EP, including:
1.1.4
The works site at Kai Tak West Area for the Contract No.
HY/2023/08 are shown in Appendix A.
1.2 Purpose of the Report
1.2.1
This is the 1st monthly Environmental Monitoring and
Audit (EM&A) report presenting the EM&A works carried out for the
Project in the Kai Tak West Area during the period from 11 November 2024 to 30
November 2024.
1.3 Construction Activities Undertaken During the Reporting Period
1.3.1
A summary of major construction activities carried out during
the reporting period are presented in Table 1.1.  The construction
programme is presented in Appendix B.
Table 1.1    Summary of Construction Activities during
the Reporting Period
| Construction
  Activities Undertaken in Kai Tak West Area | Progress |
| ·
  Site preparation and access set up for Part of Site 4C at
  Kai Tak Phase 2B Landscaped Deck | 10% |
1.4 Project Organisation
1.4.1

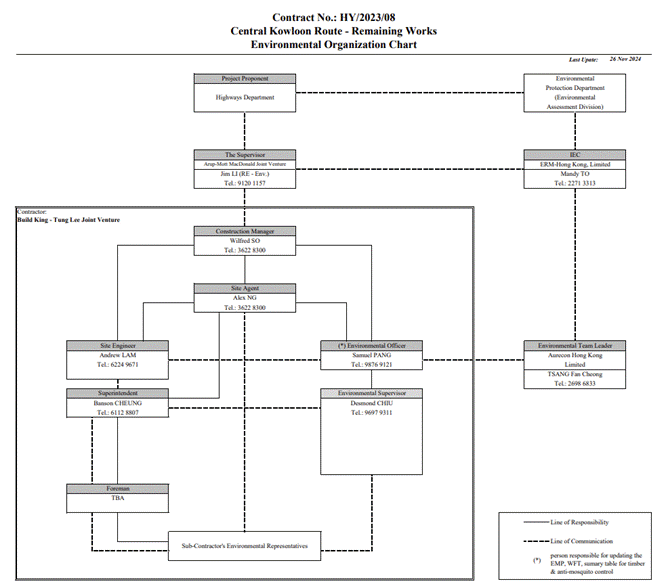

The project organization structure is shown in Appendix C.
The key personnel contact names and numbers for the Project are summarized in Table 1.2.
Table 1.2              Contact
Information of Key Personnel
| Party | Role | Position | Name | Contact
  No. |
| Arup – Mott MacDonald Joint Venture | Engineer’s Representative (“ER”) | Resident Engineer
  (Environmental) | Ms. Jim Li | 9120 1157 |
| ERM – Hong Long Limited | Independent Environmental Checker (“IEC”) | IEC | Ms. Mandy To | 2271 3313 |
| Aurecon Hong Kong Limited | Environmental Team (“ET”) | ET Leader | Mr. F. C. Tsang | 2698 6833 |
| Build King – Tung Lee Joint Venture | Contractor | Environmental Officer | Mr. Samuel Pang | 9876 9121 |
1.5 Status of Environmental
Licences, Notification and Permit
1.5.1
A summary of the valid permits, licences, and /or notifications
on environmental protection for this Project is presented in Table 1.3.
Table 1.3    Summary
of the Environmental Licence, Notification, Permit and Documentations
| Permit/ License/ Notification / Reference No. | Valid Period | Status | Remark | |
| From | To |  |  | |
| Environmental Permit | ||||
| EP-457/2013/D | 15 June 2021 | -- | Valid | -- |
| Wastewater Discharge License | ||||
| -- | -- | -- | To be applied | -- |
| Notification of Construction Works Under
  the Air Pollution Control (Construction Dust Regulation) | ||||
| 10007346 | -- | -- | Application submitted on 25 July 2024 | -- |
| Chemical Waste Producer Registration | ||||
| 5213-252-B2767-01 | 14 August 2024 | -- | Valid | -- |
| Billing Account for Disposal of
  Construction Waste | ||||
| 7051793 | 6 August 2024 | -- | Valid | -- |
| Y-Park Membership | ||||
| C0280 | 12 August 2024 | -- | Valid | -- |
| Construction Nosie Permit | ||||
| 2142643 | -- | -- | Application submitted on 18 Nov 2024 | General Activities at Kai Tak Phase 2B
  Landscaped Deck |

2.1 Environmental Permit (EP) Submission Status
2.2    Environmental permit (EP)
conditions under the EIAO, submission status under the EP and implementation
status of mitigation measures had been reviewed and implemented on schedule.
The status of required submissions under the EP (EP-457/2013/D) as of the reporting
period for the Project are summarised in Table 2.1.
Table 2.1  Summary of Status of Required Submission for EP-457/2013/D for the
Project
| EP Condition | Submission | Submission
  Date |
| 1.12 | Notification of Commencement Date of Construction of
  Project | 11 September 2024 |
| 2.3 | Community Liaison Group | Covered by other Contracts |
| 2.4 | Management Organization of the main construction companies | 11 September 2024 |
| 2.5 | Construction Programme and EPD Submission Schedule | 11 September 2024 |
| 2.6 | Design Drawing | 11 September 2024 |
| 2.8 | Landscape Mitigation Plan (LMP)  (Version 1) | 11 September 2024 |
| 2.9 | Construction Noise Mitigation Plan (CNMMP) (Version 1) | 11 September 2024 |
| 3.3 | Baseline Monitoring Report | (1) |
Notes:
(1)
The Baseline Monitoring Report for Contract No. HY/2014/07 Kai
Tak West will be adopted for the Kai Tak West Area of this Project.
3
Air Quality and Noise Monitoring
3.1 Air Quality
Monitoring Requirements and
Results
3.1.1
As the air quality (24-hour TSP, 1-hour TSP) monitoring works in
Kai Tak West Area are currently covered under Contract No. HY/2014/07 – Central
Kowloon Route – Kai Tak West.  The
details of the corresponding monitoring parameters, equipment, methodology,
monitoring schedule wind data, results and the established Action and Limit
Levels could be referred to Sections 3 and 5 of the corresponding Monthly EM&A
Report for Contract No. HY/2014/07.
Observations
3.1.2
No Action/Limit Level exceedance was recorded for all 1-hour TSP
and 24-hour TSP monitoring in the reporting period.
3.1.3
Site audits were carried out on a weekly basis to monitor and
audit the timely implementation of air quality mitigation measures within the
site boundaries of this Project.  A summary
of observation during the site audits is shown in Table 7.1 of this report.
3.2 Noise
Monitoring
Requirements and Results
3.2.1
As the construction noise monitoring works in Kai Tak West Area
are currently covered under Contract No. HY/2014/07 – Central Kowloon Route –
Kai Tak West.  The details of the
corresponding monitoring parameters, equipment, methodology, results and the
established Action and Limit Levels could be referred to Sections 3 and 5 of
the corresponding Monthly EM&A Report for Contract No. HY/2014/07.
Observations
3.2.2
No Action/Limit Level exceedance was recorded for construction
noise monitoring in the reporting period.
3.2.3
Site audits were carried out on a weekly basis to monitor and
audit the timely implementation of noise mitigation measures within the site
boundaries of this Project.  A summary of
observations during the site audits is shown in Table 7.1 of this report.
4
Waste Management
4.1.1
Waste generated from this Project includes inert C&D
materials and non-inert C&D materials. Non-inert C&D materials are made
up of general refuse, vegetative wastes and recyclable wastes such as plastics
and paper/cardboard packaging waste. Steel materials generated from the project
are also grouped into non-inert C&D materials as the materials were not
disposed of with other inert C&D materials. As advised by the Contractor, no
inert C&D materials, non-inert C&D materials nor chemical waste was
generated and disposed of during this reporting period.
4.1.2
With reference to relevant handling records and trip tickets of
this Project, the quantities of different types of waste generated in the
reporting period are summarised in Table 4.1. Details of cumulative waste management data are presented as a

waste flow table in Appendix G.
Table 4.1  Quantities of Waste Generated
from the Project in the Reporting Period
| Reporting  period  | Quantity  | |||||
| Inert
  C&D Materials (in
  ‘000 kg) | Chemical
  Waste  (in
  ‘kg) | Non-inert
  C&D Materials  | ||||
|  Others, e.g. General Refuse disposed at
  Landfill (in
  ‘000kg) | Recycled
  materials | |||||
| Paper/ cardboard (in
  ‘000kg) | Plastics (in
  ‘000 kg) | Metals (in
  ‘000 kg) | ||||
| Nov 2024 | 0.00 | 0.00 | 0.00 | 0.00 | 0.00 | 0.00 |
5.1.1
As per the EM&A Manuals, the landscape and visual mitigation
measures shall be implemented, and site inspections should be undertaken once
every two weeks during the construction period.
5.1.2
Bi-weekly inspection of the implementation of landscape and
visual mitigation measures was conducted on 15 and 29 November 2024. The observations and
recommendations made during the site inspections are presented in Table 7.1.    A summary of the implementation status is
presented in Appendix F.
6
Summary of Complaints, Notification of
Summons and Prosecutions
6.1.1
The environmental Complaints Handling Procedures is shown in
below.
| Complaint Received via Project Hotline | Complaint Received via 1823 or from other government
  departments | ||||
|  |  |  |  | ||
| Contractor notify ER, ET and IEC | ER notify Contractor, ET and IEC | ||||
|  |  |  |
 | ||
| Contractor log complaint and date of receipt onto the complaint
  database. Contractor, ER and
  ET to conduct investigation of complaint  | |||||
|  |  |  |
 | ||
| If complaint is considered not valid | If complaint is found valid | ||||
|  |  |  |
 | ||
| ET or ER to reply the
  complainant if necessary | Contractor to identify and implement remedial
  measures in consultation with the IEC, ET and ER.  | ||||
|  |  |  |
 | ||
|  |  | The ER, ET and IEC to review the
  effectiveness of the Contractor’s remedial measures and the updated
  situation; ET to undertake additional monitoring and audit to verify the
  situation if necessary and oversee that circumstances leading to the
  complaint do not recur. ER to conduct further inspection as necessary.
      | |||
|  |  |  |
 | ||
|  If the complaint is referred by the EPD, the Contractor to
  prepare interim report on the status of the complaint investigation and
  follow-up actions stipulated above, including the details of the remedial
  measures and additional monitoring identified or already taken, for
  submission to EPD within the time frame assigned by the EPD.  | |||||
|  |  |  | |||
| The ET to record the details of the complaint, results of the
  investigation, subsequent actions taken to address the complaint and updated
  situation including the effectiveness of the remedial measures, supported by
  regular and additional monitoring results in the monthly EM&A reports. | |||||
6.1.2
Should non-compliance of the criteria occur, action in
accordance with the Event and Action Plan in Appendix D and Appendix
E shall be carried out.
6.1.3
No exceedance of the Action and Limit Levels of air quality (1-hour
TSP and 24-hour TSP) monitoring and noise monitoring was recorded in the
reporting period.
6.1.4
No complaint was received in the reporting period.
6.1.5
No non-compliance was received in the reporting period.
6.1.6
No notification of summons and successful prosecution was
received in the reporting period.
6.1.7
Statistics on complaints, notifications of summons and
successful prosecutions are summarized in Appendix H.
7.1.1
Site inspections were carried out on a weekly basis to monitor
the implementation of proper environmental pollution control and mitigation
measures under the Contract. In the reporting period,
3 site inspections were carried out by the
representative of ET, Contractor and Engineer on 15, 22 and 29 November
2024, along with bi-weekly inspection of the
implementation of landscape and visual mitigation measures conducted on 15
and 29 November 2024.
7.1.2
One joint site inspection with the IEC was also undertaken on 15
September 2024. No deficiencies were observed
during weekly site inspection. Key observations during the site inspections are
summarized in Table 7.1.
Table 7.1  Summary of Site
Observation
| Date  | Environmental
  Observations | Follow-up
  Status |
| 15 November 2024 | Nil. | Nil. |
| 22 November 2024 | Nil. | Nil. |
| 29 November 2024 | Nil. | Nil. |
7.1.3
No observation was identified during the environmental site
inspection in the reporting period.
7.1.4
According to the EIA Study Report, Environmental Permit,
contract documents and EM&A Manual, the mitigation measures detailed in the
documents had been implemented as much as practical during the reporting
period. An updated Implementation Status of Environmental Mitigation Measures
(EMIS) is provided in Appendix F.
8.1.1
The construction activities to be undertaken in the next
reporting period are listed below:
| Construction
  Activities Undertaken in Kai Tak West Area |
| ·
  To complete site preparation works and site survey at Kai
  Tak Phase 2B Landscaped Deck |
8.1.2
Potential environmental impacts arising from the above
construction activities are mainly associated with dust and waste management.
8.1.3
The tentative schedule of air quality (1-hour TSP and 24-hour
TSP) monitoring and noise monitoring in the next reporting period is presented
in Appendix F of the corresponding Monthly EM&A Report for Contract No.
HY/2014/07.
8.1.4
The construction programme for the Project for the next
reporting period is presented in Appendix B.
9
Conclusion and Recommendations
9.1.1
This is the 1st monthly EM&A Report presents the EM&A works undertaken
in Kai Tak West Area during the period from 11 November 2024 to 30 November 2024 in accordance with the EM&A Manual and the requirement under
EP-457/2013/D.
9.1.2
Air quality monitoring (including 1-hour TSP and 24-hour TSP) and
noise monitoring were carried out in the reporting period under Contractor No. HY/2014/07.
 No exceedance of the Action and Limit
Level was recorded for air quality monitoring and noise during the reporting period.
9.1.3
Weekly environmental site inspections by the representative of
ET, Contractor and Engineer were conducted during the reporting period. One
joint site inspection with the IEC was carried out on 15 November 2024.  No observation was
identified during the reporting period. The environmental performance of the
Project was therefore considered satisfactory.
9.1.4
No complaint was received in the reporting period.
9.1.5
No non-compliance situation was received in the reporting period.
9.1.6
No notification of summons or prosecution was received since
commencement of the Contract.
9.1.7
The ET will keep track on the construction works to confirm
compliance of environmental requirements and the proper implementation of all
necessary mitigation measures.
Appendix A
Alignment and Works Site in Kai Tak West Area for the
Contract No. HY/2023/08
 Kai Tak Phase
    2B Landscaped Deck

Appendix B
Construction Programme

Appendix C
Project
Organisation Chart
 TSANG Fan
    Cheong Tel.: 3664 6801

Appendix
D
Event
and Action plan (EAP) (Air Quality Monitoring)
| EVENT | ACTION | |||
| ENVIRONMENTAL TEAM (ET)  | INDEPENDENT ENVIRONMENTAL CHECKER (IEC) | ENGINEER’S REPRESENTATIVE ER | CONTRACTOR | |
| ACTION LEVEL | ||||
| Exceedance for one sample | 1. Identify source, investigate the causes of exceedance
  and propose remedial measures; 2. Inform IEC and ER; 3. Repeat measurement
  to confirm finding; 4. Increase monitoring frequency to daily. | 1. Check monitoring
  data submitted by ET; 2. Check Contractor’s
  working method. | 1. Notify Contractor. | 1. Rectify any
  unacceptable practice; 2. Amend working
  methods if appropriate. |
| Exceedance for two or more consecutive
  samples | 1. Identify source; 2. Inform IEC and ER; 3. Advise the ER on
  the effectiveness of the proposed remedial measures; 4. Repeat
  measurements to confirm findings; 5. Increase monitoring frequency to daily; 6. Discuss with IEC
  and Contractor on remedial actions required; 7. If exceedance
  continues, arrange meeting with IEC and ER; 8. If exceedance stops,
  cease additional monitoring. | 1. Check monitoring
  data submitted by ET; 2. Check Contractor’s
  working method; 3. Discuss with ET
  and Contractor on possible remedial measures; 4. Advise the ET on
  the effectiveness of the proposed remedial measures; 5. Supervise
  Implementation of remedial measures. | 1. Confirm receipt of
  notification of failure in writing; 2. Notify Contractor; 3. Ensure remedial
  measures properly implemented.   | 1. Submit proposals
  for remedial to ER within 3 working days of notification; 2. Implement the
  agreed proposals; 3. Amend proposal if
  appropriate. |
| LIMIT
  LEVEL | ||||
| Exceedance for one sample | 1. Identify source, investigate the causes of exceedance
  and propose remedial measures; 2. Inform ER, Contractor and EPD; 3. Repeat measurement
  to confirm finding; 4. Increase monitoring frequency to daily; 5. Assess
  effectiveness of Contractor’s remedial actions and keep IEC, EPD and ER
  informed of the results. | 1. Check monitoring
  data submitted by ET; 2. Check Contractor’s
  working method; 3. Discuss with ET
  and Contractor on possible remedial measures; 4. Advise the ER on
  the effectiveness of the proposed remedial measures; 5. Supervise
  implementation of remedial measures. | 1. Confirm receipt of
  notification of failure in writing; 2. Notify Contractor; 3. Ensure remedial
  measures properly implemented. | 1. Take immediate
  action to avoid further exceedance; 2. Submit proposals
  for remedial actions to IEC within 3 working days of notification; 3. Implement the
  agreed proposals; 4. Amend proposal if
  appropriate. |
| Exceedance for two or more consecutive
  samples | 1.Notify IEC, ER, Contractor and EPD; 2. Identify source; 3. Repeat measurement
  to confirm findings; 4. Increase monitoring frequency to daily; 5. Carry out analysis
  of Contractor’s working procedures to determine possible mitigation to be implemented; 6. Arrange meeting
  with IEC and ER to discuss the remedial actions to be taken; 7. Assess
  effectiveness of Contractor’s remedial actions and keep IEC, EPD and ER
  informed of the results; 8. If exceedance stops, cease additional monitoring. | 1. Discuss amongst
  ER, ET, and Contractor on the potential remedial actions; 2. Review
  Contractor’s remedial actions whenever necessary to assure their
  effectiveness and advise the ER accordingly; 3. Supervise the
  implementation of remedial measures. | 1. Confirm receipt of
  notification of failure in writing; 2. Notify Contractor; 3. In consultation
  with the IEC, agree with the Contractor on the remedial measures to be implemented; 4. Ensure remedial
  measures properly implemented; 5. If exceedance
  continues, consider what portion of the work is responsible and instruct the
  Contractor to stop that portion of work until the exceedance is abated. | 1. Take immediate
  action to avoid further exceedance; 2. Submit proposals
  for remedial actions to IEC within 3 working days of notification; 3. Implement the
  agreed proposals; 4. Resubmit proposals
  if problem still not under control; 5. Stop the relevant
  portion of works as determined by the ER until the exceedance is abated. |
Appendix E
Event
and Action plan (EAP) (Noise Monitoring)
| EVENT | ACTION | |||
| ENVIRONMENTAL TEAM (ET)  | INDEPENDENT ENVIRONMENTAL CHECKER (IEC) | ENGINEER’S REPRESENTATIVE ER | CONTRACTOR | |
| Action Level | 1.
  Identify source, investigate the causes of exceedance and propose remedial measures; 2. Notify IEC and Contractor; 3. Report the results
  of investigation to the IEC, ER and Contractor; 4. Discuss with the
  Contractor and formulate remedial measures; 5. Increase
  monitoring frequency to check mitigation effectiveness. | 1. Review the analysed results submitted by the ET; 2. Review the proposed remedial measures by the
  Contractor and advise the ER accordingly; 3. Supervise the implementation of remedial
  measures. | 1. Confirm receipt of notification of failure in
  writing; 2. Notify Contractor; 3. Require Contractor
  to propose remedial measures for the analysed noise problem; 4. Ensure remedial
  measures are properly implemented | 1. Submit noise mitigation proposals to IEC; 2. Implement noise
  mitigation proposals. |
Appendix F
Environmental Mitigation Implementation Schedule (EMIS)
Environmental
Mitigation Implementation Schedule
| EIA Ref. | EM&A Log Ref. | Recommended
   Mitigation Measures | Objectives of the Recommended
   Measures & Main Concerns to address | Implementation
   Agent | Location / Timing | Implementation
   Stage | Requirements and/
   or standards to be achieved | Implementation
   Status |
| Construction Dust
  Impact | ||||||||
| S4.3.10 | D1 | The contractor
  shall follow the procedures and requirements given in the Air Pollution
  Control (Construction Dust) Regulation and Air Pollution Control (Non-road Mobile Machinery) (Emission) Regulation. | Minimize dust
  impact and adverse health effects at the nearby sensitive receivers | Contractor | All construction sites | Construction stage | ·
  APCO ·
  To control the dust impact to meet HKAQO and TM-EIA criteria | N/A |
| S4.3.10 | D2 | ·
  Mitigation measures in form of regular watering under a good site
  practice should be adopted.  Watering
  once per hour on exposed worksites and haul road should be conducted to
  achieve dust removal efficiencies of 91.7%. While the above watering
  frequencies are to be followed, the extent of watering may vary depending on
  actual site conditions but should be sufficient to maintain an equivalent
  intensity of no less than 1.3 L/m2 to achieve the dust removal
  efficiency. | Minimize dust
  impact at the nearby sensitive receivers | Contractor | All construction sites | Construction stage | ·
  APCO ·
  To control the dust impact to meet HKAQO and TM-EIA criteria | N/A |
| xS4.3.10 | D3 | ·
  Proper watering at exposed spoil should be undertaken throughout the
  construction phase; ·
  Any excavated or stockpile of dusty material should be covered
  entirely by impervious sheeting or sprayed with water to maintain the entire
  surface wet and then removed or backfilled or reinstated where practicable
  within 24 hours of the excavation or unloading; ·
  Any dusty materials remaining after a stockpile is removed should be
  wetted with water and cleared from the surface of roads; ·
  A stockpile of dusty material should not be extended beyond the
  pedestrian barriers, fencing or traffic cones; ·
  The load of dusty materials on a vehicle leaving a construction site
  should be covered entirely by impervious sheeting to ensure that the dusty
  materials do not leak from the vehicle. ·
  Where practicable, vehicle washing facilities with high pressure water
  jet should be provided at every discernible or designated vehicle exit
  point.  The area where vehicle washing
  takes place and the road section between the washing facilities and the exit
  point should be paved with concrete, bituminous materials or hardcores; ·
  When there are open excavation and reinstatement works, hoarding of
  not less than 2.4m high should be provided and properly maintained as far as
  practicable along the site boundary with provision for public crossing.  Good site practice shall also be adopted by
  the Contractor to ensure the conditions of the hoardings are properly
  maintained throughout the construction period; ·
  The portion of any road leading only to construction site that is
  within 30m of a vehicle entrance or exit should be kept clear of dusty materials; ·
  Surfaces where any pneumatic or power-driven drilling, cutting,
  polishing or other mechanical breaking operation takes place should be
  sprayed with water or a dust suppression chemical continuously; ·
  Any area that involves demolition activities should be sprayed with
  water or a dust suppression chemical immediately prior to, during and
  immediately after the activities so as to maintain the entire surface wet;  ·
  Any skip hoist for material transport should be totally enclosed by
  impervious sheeting; ·
  Every stock of more than 20 bags of cement or dry-pulverised fuel ash
  (PFA) should be covered entirely by impervious sheeting or placed in an area
  sheltered on the top and the 3 sides; ·
  Loading, unloading, transfer, handling or storage of bulk cement or
  dry PFA should be carried out in a totally enclosed system or facility, and
  any vent or exhaust should be fitted with an effective fabric filter or
  equivalent air pollution control system ·
  Exposed earth should be properly treated by compaction, turfing,
  hydroseeding, vegetation planting or sealing with latex, vinyl, bitumen,
  shotcrete or other suitable surface stabilizer within six months after the
  last construction activity on the construction site or part of the
  construction site where the exposed earth lies. | Minimize dust
  impact at the nearby sensitive receivers | Contractor | All construction sites | Construction stage | ·
  APCO ·
  To control the dust impact to meet HKAQO and TM-EIA criteria | N/A |
| S4.3.10 | D6 | Implement regular
  dust monitoring under EM&A programme during the construction stage. | Monitoring of dust impact | Contractor | Selected rep. dust monitoring station | Construction stage | ·
  TM-EIA | 10       Implemented |
| 11   Construction Noise (Airborne) | ||||||||
| S5.4.1 | N1 | Implement the following good site practices: ·
  Only well-maintained plant should be operated on-site, and plant
  should be serviced regularly during the construction programme; ·
  Machines and plant (such as trucks, cranes) that may be in
  intermittent use should be shut down between work periods or should be
  throttled down to a minimum; ·
  Plant known to emit noise strongly in one direction, where possible,
  be orientated so that the noise is directed away from nearby NSRs; ·
  Silencers or mufflers on construction equipment should be properly
  fitted and maintained during the construction works; ·
  Mobile plant should be sited as far away from NSRs as possible and practicable; ·
  Material stockpiles, mobile container site office and other structures
  should be effectively utilized, where practicable, to screen noise from
  on-site construction activities. | Control construction airborne noise | Contractor | All construction sites | Construction stage | ·
  Annex 5, TM-EIAO | N/A |
| S5.4.1 | N2 | Install temporary
  hoarding located on the site boundaries between noisy construction activities
  and NSRs.  The conditions of hoardings
  shall be properly maintained throughout the construction period. | 12       Reduce the construction noise levels
  at low-level zone of NSRs through partial screening | 13       Contractor | 14       All construction sites | 15       Construction stage | ·
  Annex 5, TM-EIAO | 16       Implemented |
| S5.4.1 | N3 | Install movable
  noise barriers (typical design is wooden framed barrier with a
  small-cantilevered on a skid footing with 25mm thick internal sound
  absorptive lining), acoustic mat or full enclosure, screen the noisy plants
  including air compressors, generators and handheld breakers, etc. | 17       Screen the noisy plant items to be
  used at all construction sites | 18       Contractor | 19       All construction sites where
  practicable | 20       Construction stage | ·
  Annex 5, TM-EIAO | 21       N/A |
| S5.4.1 | N4 | Use ‘Quiet plant’ | 22       Reduce the noise levels of plant
  items | 23       Contractor | 24       All construction sites where
  practicable | 25       Construction stage | ·
  Annex 5, TM-EIAO | 26       N/A |
| S5.4.1 | N5 | Loading/ unloading
  activities should be carried out inside the full enclosure of mucking out points. | 27       Reduce the noise levels of loading/
  unloading activities | 28       Contractor | 29       Mucking out locations | 30       Construction stage | ·
  Annex 5, TM-EIAO | 31       N/A |
| S5.4.1 | N6 | Sequencing
  operation of construction plants where practicable. | 32       Operate sequentially within the same
  work site to reduce the construction airborne noise  | 33       Contractor | 34       All construction sites where
  practicable | 35       Construction stage | ·
  Annex 5, TM-EIAO | 36       N/A |
| S5.4.1 | N7 | Implement a noise
  monitoring programme under EM&A programme.  | 37       Monitor the construction noise levels
  at the selected representative locations | 38       Contractor | 39       Selected rep. noise monitoring
  station | 40       Construction stage | ·
  TM-EIAO | 41       N/A |
| 42   Water Quality (Construction Phase) | ||||||||
| S6.9.1.1 | W1 | In accordance with
  the Practice Note for Professional Persons on Construction Site Drainage,
  Environmental Protection Department, 2023 (ProPECC
  PN 2/23), construction phase mitigation measures shall include the following: Construction Runoff ·
  At the start of site establishment, perimeter cut-off drains to direct
  off-site water around the site should be constructed with internal drainage
  works and erosion and sedimentation control facilities implemented.  Channels (both temporary and permanent
  drainage pipes and culverts), earth bunds or sandbag barriers should be
  provided on site to direct stormwater to silt removal facilities.  The design of the temporary on-site drainage
  system will be undertaken by the contractor prior to the commencement of construction; ·
  The dikes or embankments for flood protection should be implemented
  around the boundaries of earthwork areas.
  Temporary ditches should be provided to facilitate the runoff
  discharge into an appropriate watercourse, through a silt/ sediment
  trap.  The sediment/ silt traps should
  be incorporated in the permanent drainage channels to enhance deposition rates; ·
  The design of efficient silt removal facilities should be based on the
  guidelines in Appendix A1 of ProPECC PN 2/23, which
  states that the retention time for silt/ sand traps should be 5 minutes under
  maximum flow conditions.  Sizes may
  vary depending upon the flow rate, but for a flow rate of 0.1 m3/s
  a sedimentation basin of 30 m3 would be required and for a flow
  rate of 0.5 m3/s the basin would be 150 m3.  The detailed design of the sand/ silt traps
  shall be undertaken by the contractor prior to the commencement of construction;    ·
  All exposed earth areas should be completed and vegetated as soon as
  possible after earthworks have been completed, or alternatively, within 14
  days of the cessation of earthworks where practicable.  Exposed slope surfaces should be covered by
  tarpaulin or other means; ·
  The overall slope of the site should be kept to a minimum to reduce
  the erosive potential of surface water flows, and all traffic areas and
  access roads protected by coarse stone ballast.  An additional advantage accruing from the
  use of crushed stone is the positive traction gained during prolonged periods
  of inclement weather and the reduction of surface sheet flows; ·
  All drainage facilities and erosion and sediment control structures
  should be regularly inspected and maintained to ensure
  proper and efficient operation at all times and particularly following
  rainstorms.  Deposited silt and grit
  should be removed regularly and disposed of by spreading evenly over stable,
  vegetated areas; ·
  Measures should be taken to minimize the ingress of site drainage into
  excavations.  If the excavation of
  trenches in wet periods is necessary, they should be dug and backfilled in
  short sections wherever practicable.
  Water pumped out from trenches or foundation excavations should be
  discharged into storm drains via silt removal facilities; ·
  Open stockpiles of construction materials (for example, aggregates,
  sand and fill material) of more than 50m3 should be covered with
  tarpaulin or similar fabric during rainstorms.  Measures should be taken to prevent the
  washing away of construction materials, soil, silt or debris into any
  drainage system; ·
  Manholes should always be adequately covered and temporarily sealed so
  as to prevent silt, construction materials or debris being washed into the
  drainage system and storm runoff being directed into foul sewers; ·
  Precautions be taken at any time of year when rainstorms are likely,
  actions to be taken when a rainstorm is imminent or forecasted, and actions
  to be taken during or after rainstorms are summarized in Appendix A2 of ProPECC PN 2/23.
  Particular attention should be paid to the control of silty surface
  runoff during storm events, especially for areas located near steep slopes; ·
  All vehicles and plant should be cleaned before leaving a construction
  site to ensure no earth, mud, debris and the like is deposited by them on
  roads.  An adequately designed and site
  wheel washing facilities should be provided at every construction site exit
  where practicable.  Wash-water should
  have sand and silt settled out and removed at least on a weekly basis to
  ensure the continued efficiency of the process.  The section of access road leading to, and
  exiting from, the wheel wash bay to the public road should be paved with
  sufficient backfall toward the wheel wash bay to prevent vehicle tracking of
  soil and silty water to public roads and drains; ·
  Oil interceptors should be provided in the drainage system downstream
  of any oil/ fuel pollution sources.
  The oil interceptors should be emptied and cleaned regularly to
  prevent the release of oil and grease into the storm water drainage system
  after accidental spillage.  A bypass
  should be provided for the oil interceptors to prevent flushing during heavy rain; ·
  Construction solid waste, debris and rubbish on site should be
  collected, handled and disposed of properly to avoid water quality impacts; ·
  All fuel tanks and storage areas should be provided with locks and
  sited on sealed areas, within bunds of a capacity equal to 110% of the
  storage capacity of the largest tank to prevent spilled fuel oils from
  reaching water sensitive receivers nearby; ·
  Adopt best management practices; ·
  All earth works should be conducted sequentially to limit the amount
  of construction runoff generated from exposed areas during the wet season
  (April to September) as far as practicable.
   | 43       To minimize water quality impact from
  the construction site runoff and general construction activities | 44       Contractor | 45       All construction sites where
  practicable | 46       Construction stage | ·
  Water Pollution Control Ordinance ·
  ProPECC PN 2/23 ·
  TM-EIAO ·
  TM-DSS | 47       Implemented |
| S6.9.1.2 | W2 | Tunnelling Works and Underground Works ·
  Cut-&-cover tunnelling work should be
  conducted sequentially to limit the amount of
  construction runoff generated from exposed areas during the wet season (April to September)
  as far as practicable. ·
  Uncontaminated discharge should pass through sedimentation tanks prior
  to off-site discharge; ·
  The wastewater with a high concentration of SS should be treated (e.g.
  by sedimentation tanks with sufficient retention time) before discharge.  Oil interceptors would also be required to
  remove oil, lubricants and grease from the wastewater; ·
  Direct discharge of the bentonite slurry (as a
  result of D-wall) is not allowed.
  It should be reconditioned and reused wherever practicable.  Temporary storage locations (typically a
  properly closed warehouse) should be provided on site for any unused
  bentonite that needs to be transported away after all the related
  construction activities area completed.
  The requirements in ProPECC PN 2/23 should
  be adhered to in the handling and disposal of bentonite slurries.  | 48       To minimize construction water
  quality impact from tunnelling works | 49       Contractor | 50       All tunnelling portion | 51       Construction stage | ·
  Water Pollution Control Ordinance ·
  ProPECC PN 2/23 ·
  TM-DSS ·
  TM-EIAO | 52       N/A |
| S6.9.1.3 | W3 | Sewage Effluent ·
  Portable chemical toilets and sewage holding tanks are recommended for
  handling the construction sewage generated by the workforce.  A licensed contractor should be employed to
  provide appropriate and adequate portable toilets and be responsible for
  appropriate disposal and maintenance. | 53       To minimize water quality from sewage
  effluent | 54       Contractor | 55       All construction sites where
  practicable | 56       Construction stage | ·
  Water Pollution Control Ordinance ·
  TM-DSS | 57       Implemented |
| S6.9.1.5 | W4 | Groundwater from Potential Contaminated Area: ·
  No direct discharge of groundwater from contaminated areas should be adopted. ·
  A discharge license under the WPCO through the Regional Office of EPD for groundwater discharge should be
  applied. Prior to the excavation works within these
  potentially contaminated areas, the
  groundwater quality should be reviewed during the process of discharge license application. The
  compliance to the
  Technical Memorandum on Standards for
  Effluents Discharged into Drainage on
  Sewerage Systems, Inland and Coastal Waters (TM-DSS) and the existence of
  prohibited substance should be confirmed. If the
  review results indicated that the groundwater to be generated from the excavation works would be
  contaminated, the contaminated groundwater should
  be either properly treated in compliance with
  the requirements of the TM-DSS or properly recharged into the ground. ·
  If wastewater treatment is deployed, the wastewater treatment unit shall deploy suitable treatment process
  (e.g. oil interceptor / activated carbon)
  to reduce the pollution level to an acceptable standard and remove any prohibited substances
  (e.g. TPH) to undetectable range. All treated
  effluent from wastewater treatment plant
  shall meet the requirements as stated in TM-DSS and should be discharged into the foul sewers. ·
  If groundwater recharging wells are deployed, recharging wells should be installed as appropriate for recharging
  the contaminated groundwater back into
  the ground. The recharging wells should be
  selected at places where the groundwater quality will not be affected by the recharge operation as
  indicated in the Section 2.3 of TM-DSS. The baseline
  groundwater quality shall be determined prior
  to the selection of the recharge wells, and submit a working plan (including the laboratory
  analytical results
  showing the quality of groundwater at the proposed recharge location(s) as
  well as the pollutant levels of groundwater to be recharged) to EPD for
  agreement. Pollution levels of groundwater to be recharged shall not be
  higher than pollutant levels of ambient groundwater at the recharge well.
  Prior to recharge, any prohibited substances such as TPH products should be
  removed as necessary by installing the petrol interceptor. | 58       To minimize groundwater quality
  impact from contaminated area | 59       Contractor | 60       Excavation areas where contamination
  is found | 61       Construction stage | ·
  Water Pollution Control Ordinance ·
  TM-DSS ·
  TM-EIAO | 62       N/A |
| S6.9.1.6 | W6 | Accidental Spillage In order to prevent accidental spillage of chemicals, the following is
  recommended: ·
  All the tanks, containers, storage area should be bunded and the
  locations should be locked as far as possible from the sensitive watercourse
  and stormwater drains; ·
  The Contractor should register as a chemical waste producer if
  chemical wastes would be generated.
  Storage of chemical waste arising from the construction activities
  should be stored with suitable labels and warnings. Disposal of chemical wastes should be conducted in compliance with the
  requirements as stated in the Waste Disposal (Chemical Waste) (General)
  Regulation. | 63       To minimize water quality impact from
  accidental spillage | 64       Contractor | 65       All construction site where
  practicable | 66       Construction stage | ·
  Water Pollution Control Ordinance ·
  ProPECC PN 2/23 ·
  TM-EIAO ·
  TM-DSS | 67       N/A |
| 68   Waste Management (Construction Waste) | ||||||||
| S7.4.1 | WM1 | On-site sorting of C&D material ·
  Geological assessment should be carried out by competent persons on
  site during excavation to identify materials which are not suitable to use as
  aggregate in structural concrete (e.g. volcanic rock, Aplite dyke rock,
  etc.).  Volcanic rock and Aplite dyke
  rock should be separated at the source sites as far as practicable and stored
  at designated stockpile area preventing them from delivering to crushing
  facilities.  The crushing plant
  operator should also be reminded to set up measures to prevent unsuitable
  rock from ending up at concrete batching plants and be turned into concrete
  for structural use.  Details regarding
  control measures at source site and crushing facilities should be submitted
  by the Contractor for the Engineer to review and agree.  In addition, site records should also be
  kept for the types of rock materials excavated and the traceability of
  delivery will be ensured with the implementation of Trip Ticket System and
  enforced by site supervisory staff as stipulated under DEVB TC(W) No. 6/2010
  for tracking of the correct delivery to the rock crushing facilities for
  processing into aggregates.
  Alternative disposal option for the reuse of volcanic rock and Aplite
  Dyke rock, etc. should be explored.  | 69       Separation of unsuitable rock from ending
  up at concrete batching plants and be turned into concrete for structural use | 70       Contractor | 71       All construction sites | 72       Construction stage | ·
  DEVB (W) No. 6/2010 | 73       N/A |
| S7.5.1 | WM2 | Construction and Demolition Material ·
  Maintain temporary stockpiles and reuse excavated fill material for
  backfilling and reinstatement; ·
  Carry out on-site sorting; ·
  Make provisions in the Contract documents to allow and promote the use
  of recycled aggregates where appropriate; ·
  Adopt ‘selective demolition’ technique to demolish the existing
  structures and facilities with a view to recovering broken concrete
  effectively for recycling purpose, where possible; ·
  Implement a trip-ticket system for each works contract to ensure that
  the disposal of C&D materials is properly documented and verified; and ·
  Implement an enhanced Waste Management Plan similar
  to ETWBTC (Works) No. 19/2005 – “Environmental Management on
  Construction Sites” to encourage on-site sorting of C&D materials and to
  minimize their generation during the course of construction. | 74       Good site practice to minimize the
  waste generation and recycle the C&D materials as far as practicable so as to reduce the amount for final disposal | 75       Contractor | 76       All construction sites | 77       Construction stage | ·
  Land (Miscellaneous Provisions) Ordinance ·
  Waste Disposal Ordinance ·
  ETWB TCW No. 19/2005 | 78       N/A |
| S7.5.1 | WM3 | C&D Waste ·
  Standard formwork or pre-fabrication should be used as far as
  practicable in order to minimize the arising of
  C&D materials.  The use of more
  durable formwork or plastic facing for the construction works should be
  considered.  Use of wooden hoardings
  should not be used, as in other projects.
  Metal hoarding should be used to enhance the possibility of
  recycling.  The purchasing of
  construction materials will be carefully planned in order to avoid over
  ordering and wastage; ·
  The Contractor should recycle as much of the C&D materials as
  possible on-site. Public fill and C&D waste should be segregated and
  stored in different containers or skips to enhance reuse or recycling of
  materials and their proper disposal.
  Where practicable, concrete and masonry can be crushed and used as
  fill.  Steel reinforcement bar can be
  used by scrap steel mills.  Different
  areas of the sites should be considered for such segregation and storage. | 79       Good site practice to minimize the
  waste generation and recycle the C&D materials as far as practicable so as to reduce the amount for final disposal | 80       Contractor | 81       All construction sites | 82       Construction stage | ·
  Land (Miscellaneous Provisions) Ordinance ·
  Waste Disposal Ordinance ·
  ETWB TCW No. 19/2005 | 83       N/A |
| S7.5.1 | WM4 | Excavated Contaminated Soils ·
  Details of the mitigation measures on handling of the contaminated
  soil shall be referred to Section on Land Contamination below. | 84       The contaminated soil will be 85       excavated for on-site reuse | 86       Contractor | 87       PBH4 | 88       Prior to 89       commencement of 90       construction 91       works within the contaminated 92       area | ·
  Practice Guide (PG) for Investigation and Remediation of Contaminated
  Land ·
  GN/GM for land contamination | 93       N/A |
| S7.5.1 | WM5 | Land-based Sediment ·
  All construction plant and equipment shall be designed and maintained to minimize the risk of silt,
  sediments, contaminants or other pollutants
  being released into the water column or deposited in the locations other than designated location; ·
  All vessels shall be sized such that adequate draft is maintained between vessels and the sea bed
  at all states of the tide to ensure that undue
  turbidity is not generated by turbulence from vessel movement or propeller wash; ·
  Before moving the vessels which are used for
  transporting dredged material, excess material
  shall be cleaned from the decks and exposed
  fittings of vessels and the excess materials shall never be dumped into the sea except at the
  approved locations; ·
  Adequate freeboard shall be maintained on barges to ensure that decks are not washed by wave action. ·
  The Contractors shall monitor all vessels transporting material to ensure that no dumping outside the approved
  location takes place. The Contractor shall keep and
  produce logs and other records to
  demonstrate compliance and that journeys are consistent with designated locations and copies
  of such records shall be submitted to the engineers; ·
  The Contractors shall comply with the conditions in the dumping license. ·
  All bottom dumping vessels (Hopper barges) shall be fitted with tight fittings seals to their bottom openings to
  prevent leakage of
  material; ·
  The material shall be placed into the disposal pit by bottom dumping; ·
  Contaminated marine mud shall be transported by spit barge of not less than 750m3 capacity and
  capable of rapid opening and discharge at the
  disposal site; ·
  Discharge shall be undertaken rapidly, and the hoppers shall be closed immediately. Material adhering to the
  sides of the hopper
  shall not be washed out of the hopper
  and the hopper shall remain closed until
  the barge returns to the disposal site. ·
  For Type 3 special disposal treatment, sealing of contaminant with geosynthetic containment before dropping
  designated mud pit would be a possible
  arrangement. A geosynthetic containment method
  is a method whereby the sediments are sealed in geosynthetic containers and, the
  containers would be
  dropped into the designated
  contaminated mud pit where they would be covered by
  further mud disposal and later by the mud pit capping at the disposal site, thereby
  fulfilling the requirements for fully confined
  mud disposal. | 94       To control pollution due to marine
  sediment | 95       Contractor | 96       Along CKR alignment | 97       Construction stage | ·
  ETWB TCW No. 34/2002 | 98       N/A |
| S7.5.1 | WM6 | Chemical Waste ·
  Chemical waste that is produced, as defined by Schedule 1 of the Waste
  Disposal (Chemical Waste) (General) Regulation, should be handled in
  accordance with the Code of Practice on the Packaging, Labelling and Storage
  of Chemical Wastes; ·
  Containers used for the storage of chemical wastes should be suitable
  for the substance they are holding, resistant to corrosion, maintained in a
  good condition, and securely closed, have a capacity of less than 450 L
  unless the specification has been approved by EPD, and display a label in
  English and Chinese in accordance with instructions prescribed in Schedule 2
  of the regulation; ·
  The storage area for chemical wastes should be clearly labelled and
  used solely for the storage of chemical waste, enclosed on at least 3 sides,
  have an impermeable floor and bunding of sufficient capacity to accommodate
  110% of the volume of the largest container or 20% of the total volume of
  waste stored in that area, whichever is the greatest, have adequate
  ventilation, covered to prevent rainfall entering, and arranged so that
  incompatible materials are adequately separated; ·
  Disposal of chemical waste should be via a licensed waste collector,
  be to a facility licensed to receive chemical waste, such as the Chemical
  Waste Treatment Centre which also offers a chemical waste collection service
  and can supply the necessary storage containers, or be to a reuser of the waste, under approval from EPD.   | 99       Control the chemical waste and ensure
  proper storage, handling and disposal | 100    Contractor | 101    All construction sites | 102    Construction stage | ·
  Waste Disposal (Chemical Waste) (General) Regulation ·
  Code of Practice on the Packaging, Labelling and Storage of Chemical
  Waste | 103    N/A |
| S7.5.1 | WM7 | General Refuse ·
  General refuse generated on-site should be stored in enclosed bins or
  compaction units separately from construction and chemical wastes; ·
  A reputable waste collector should be employed by the Contractor to
  remove general refuse from the site, separately from construction and
  chemical wastes, on a daily basis to minimize odour,
  pest and litter impacts.  Burning of
  refuse on construction sites is prohibited by law. ·
  Aluminium cans are often recovered from the waste stream by individual
  collectors if they are segregated and made easily accessible.  Separate labelled bins for their deposit
  should be provided if feasible; ·
  Office wastes can be reduced through the recycling of paper if volumes
  are large enough to warrant collection.
  Participation in a local collection scheme should be considered by the
  Contractor. | 104    Minimize production of the general
  refuse and avoid odour, pest and litter impacts | 105    Contractor | 106    All construction sites | 107    Construction stage | ·
  Waste Disposal Ordinance | 108    N/A |
| 109 Hazard to Life | ||||||||
| H8 | The driver and his assistant should
  be physically healthy, experienced and have good safe driving records.  The driver should hold a proper driving
  licence for the approved transport truck.
  Dedicated training programme and regular road safety briefing
  sessions/ workshops should be provided to enhance their safe driving attitude
  and practice.  Smoking should be strictly
  prohibited. | To reduce the risk during explosives transport | Contractor | Works areas at which explosives would be used | Construction stage | - | 110    N/A | |
| S9.18 | H9 | Emergency response
  plans in case of road accident should be prepared and implemented.  The driver and his assistant should be
  familiar with the emergency procedures including evacuation, and proper
  communication/ fire-fighting equipment should be provided to the driver and
  his assistant. | To reduce the risk during explosives
  transport | Contractor | Works areas at which explosives would
  be used | Construction stage | - | 111    N/A |
| 112 Landscape & Visual | ||||||||
| S10.10.1 Table
  10.11 | LV3 | 113
  Good Site Management ·
  Large temporary stockpiles of excavated material shall be covered with
  unobtrusive sheeting to prevent dust and dirt spreading to adjacent landscape
  areas and vegetation, and to create a neat and tidy visual appearance. ·
  Construction plant and building material shall be orderly and
  carefully stored in order to create a neat and tidy
  visual appearance. | Minimize visual impact | Contractor | Within Project site | Construction stage | - | 114    N/A |
| LV4 | 115
  Screen Hoarding ·
  Decorative screen hoarding should be erected to screen the public from
  the construction area.  It should be
  designed to be compatible with the existing urban context.  | Minimize visual impact | Contractor | Within Project site | Construction stage | - | 116    N/A | |
| S10.10.1 Table
  10.11 | LV5 | 117
  Lighting Control during Construction ·
  All lighting in the construction site shall be carefully controlled to
  minimize light pollution and night-time glare to nearby residencies and
  GIC.  The Contractor shall consider
  other security measures, which shall minimize the visual impacts. | Minimize visual impact | Contractor | Within Project site | Construction stage | - | 118    N/A |
| S10.10.1 Table
  10.11 | LV6 | 119
  Erosion Control ·
  The potential for soil erosion shall be reduced by minimizing the extent
  of vegetation disturbance on site and by providing a protective cover over
  newly exposed soil. | 120 Minimize landscape impact | 121 Contractor | 122     Within Project site | 123     Construction stage | - | 124    N/A |
| S10.10.1 Table
  10.11 | LV7 | 125
  Tree Protection & Preservation ·
  Carefully protected during construction.  Tree protection measures will be detailed
  at the Tree Removal Application stage and plans submitted to the relevant
  Government Department for approval in due course in accordance with ETWB TC No.
  3/2006. | 126 Minimize landscape and visual impact | 127 Contractor | 128     Within Project site | 129 Construction stage | ·
  ‘Guidelines for Tree Risk Management and Assessment Arrangement on an
  Area Basis and on a Tree Basis’, Greening, Landscape and Tree Management
  (GLTM) Section, DEVB ·
  Latest recommended horticultural practices from GLTM Section, DEVB | 130    N/A |
| S10.10.1 Table
  10.11 | LV8 | 131
  Tree Transplantation ·
  For trees unavoidably affected by the Project that have
  to be removed, where practical transplantation will be chosen as the
  top priority method of removal.  If
  this is not possible or practical compensatory planting will be provided for
  trees unavoidably felled (See LV10).
  For trees unavoidably affected by the Project works that are
  transplanted, transplantation must be carried out in accordance with ETWB TCW
  2/2004 and 3/2006. | 132 Minimize landscape and visual impact | 133 Contractor | 134     Within Project site and designated
  off-site locations | 135     Prior to Construction stage | ·
  ETWB TCW 3/2006 ·
  Latest recommended horticultural practices from Greening, Landscape
  and Tree Management (GLTM) Section, DEVB ·
  ETWB TCW 2/2004 | 136    N/A |
| S10.10.1 Table
  10.11 | LV9 | 137
  Compensatory Planting ·
  For trees unavoidably affected by the Project that have
  to be removed, where practical transportation will be chosen as the
  top priority method of removal but if this is not possible or practical
  compensatory planting will be provided for trees unavoidably felled.  All felled trees shall be compensated for
  by planting trees to the satisfaction of relevant Government projects.  Required numbers and locations of
  compensatory trees shall be determined and agreed separately with Government
  during the Tree Felling Application process under ETWB TC 3/2006. ·
  Compensatory tree planting may be incorporated into public open spaces
  and along roadside amenity areas affected by the construction works and
  therefore be part of the bigger wider planting plans.  Onsite compensation planting is preferred but,
  if necessary, additional receptor sites outside the Works Area shall be
  agreed separately with the Government during the Tree Felling Application
  process. | 138 Minimize visual impact and also enhance landscape | 139 Contractor | 140     Within Project site  | 141     Construction stage | ·
  ETWB TCW 3/2006 ·
  Latest recommended horticultural practices from Greening, Landscape
  and Tree Management (GLTM) Section, DEVB ·
  ETWB TCW 2/2004 | 142    N/A |
| S10.10.1 Table 10.11 | LV10 | 143
  Screen Planting ·
  Tall screen/buffer trees, shrubs and climbers should be planted, in so
  far as is possible, to soften and screen proposed structures such as roads
  and central strip, vertical edges and buildings and to enhance streetscape
  greening effect where appropriate. Indiscriminate use of trees for screening
  must be avoided and the principle of ‘right tree for the right place’ must be
  followed. This detail will be provided at the Detailed Design stage. This
  measure may additionally form part of the compensatory planting and will
  improve and create a pleasant pedestrian environment. | 144 Minimize visual impact and 145 also enhance landscape. | 146 Contractor | 147     Within 148     Project Site | 149     Construction 150     Phase | ·
  Guidelines on Greening of Noise Barriers, issued April 2012, GLTMS, DevB  ·
  ETWB TCW 2/2004 | 151    N/A |
| S10.10.1 Table 10.11 | LV12 | 152
  Reinstatement ·
  All works areas, excavated areas and disturbed areas for tunnel
  construction and temporary road diversion or any other proposed works shall
  be reinstated to former conditions or better, with reasonable landscape
  treatment and to the satisfaction of the relevant Government departments.
  (Specific mitigation for disturbance to public open space is detailed
  separately under LV14.) | Minimize landscape impact | Contractor | 153     Within 154     Project Site | 155     Construction 156     Phase | ·
  N/A | 157 N/A |
| 158 Cultural Heritage Impact
  (Construction Phase) | ||||||||
| S11.4.4 | CH1 | The contractor should be alerted during the construction on the
  possibility of locating archaeological remains and as a precautionary
  measure, AMO shall be informed immediately in case of discovery of
  antiquities or supposed antiquities in the subject sites. | To preserve any cultural heritage
  items which may be removed and damaged by the excavation | Contractor | During construction works for cut and
  cover tunnels | Construction stage | ·
  AMOs requirements | N/A |
| 159      EM&A Project | ||||||||
| S13.2 | EM1 | An Independent Environmental Checker needs to be employed as per the
  EM&A Manual | Control EM&A Performance | Highways Department | All construction sites | Construction stage | ·
  EIAO Guidance Note No. 4/2010 ·
  TM-EIAO | 160    Implemented |
| S13.2-13.4 | EM2 | ·
  An Environmental Team needs to be employed as per the EM&A Manual; ·
  Prepare a systematic Environmental Management Plan to ensure effective
  implementation of the mitigation measures; ·
  An environmental impact monitoring needs to be implemented by the
  Environmental Team to ensure all the requirements given in the EM&A
  Manual are fully complied with. | Perform environmental monitoring
  & auditing | Highways Department/ Contractor | All construction sites | Construction stage | ·
  EIAO Guidance Note No. 4/2010 ·
  TM-EIAO | 161    Implemented |
Appendix G
Waste Flow Table

Appendix H
Statistics on Complaint, Notifications of Summons and Successful
Prosecution
Statistical
Summary of Environmental Complaints
| Reporting Period | Environmental Complaint
  Statistics | ||
| Frequency  | Cumulative | Complaint Nature | |
| 11 November 2024 - 30 November 2024 | 0 | 0 | N/A |
Statistical
Summary of Environmental Non-compliance
| Reporting Period | Environmental Non-compliance
  Statistics | ||
| Frequency  | Cumulative | Details | |
| 11 November 2024 - 30 November 2024 | 0 | 0 | N/A |
Statistical
Summary of Environmental Summons
| Reporting Period | Environmental Summons
  Statistics | ||
| Frequency  | Cumulative | Details | |
| 11 November 2024 - 30 November 2024 | 0 | 0 | N/A |
Statistical
Summary of Environmental Prosecution
| Reporting Period | Environmental
  Prosecution Statistics | ||
| Frequency  | Cumulative | Details | |
| 11 November 2024 - 30 November 2024 | 0 | 0 | N/A |
