Central Kowloon Route – Kai Tak West (CKR-KTW; Contract No. HY/2014/07) (hereafter called “the Project”) covers part of the construction of the Central Kowloon Route (CKR).
The Project comprises the follow works:
· 50x30m access shaft with noise enclosure at Ma Tau Kok (MTK);
· 100m long cut-and-cover (C&C) tunnel at MTK;
· Demolition and re-provisioning of MTK Public Pier;
· 160m long underwater tunnel (UWT) (Stage 1);
· 210m long UWT (Stage 2);
· 60m long C&C tunnel at Kai Tak;
· 130m long depressed road and 200m long underpass at Kai Tak;
· 390m long underground tunnel ventilation audit at Kai Tak;
· Seawall demolition and construction of new landing steps; and
· Barging Point enclosure and conveyor system.
The EM&A programme commenced on 4 April 2018.The impact EM&A for the Project includes air quality and noise monitoring.
This is the 83rd monthly EM&A Report presenting the EM&A works carried out during the period between 1 and 28 February 2025. As informed by the Contractor, major activities in the reporting period were:
Locations |
Site Activities |
Kai Tak |
- Defect rectification works at underpass, depressed road and C&C |
Ma Tau Kok |
-
TTM implementation; |
Kowloon Bay |
- Backfilling at Stage 2 UWT; |
Breaches of Action and Limit Levels for Air Quality
All 24-hour TSP result was below the Action and Limit Levels at all monitoring locations in the reporting month.
All 1-hour TSP result was below the Action and Limit Levels at all monitoring locations in the reporting month.
Breaches of Action and Limit Levels for Noise
Regular Noise Monitoring
One (1) action level exceedance was recorded regarding to complaint on noise nuisance received in the reporting month. No limit level exceedance was recorded at all monitoring stations in the reporting month.
Complaint, Notification of Summons and Successful Prosecution
One (1) complaint was received in the reporting month (February 2025). The complaint was investigated and have been provided in this reporting month (February 2025).
Reporting Changes
No report changes in the reporting period.
Future Key Issues
Key issues to be considered in the next three months included:
Locations |
Site Activities |
Kai Tak |
- Defect rectification works at underpass, depressed road and C&C |
Ma Tau Kok |
- TTM implementation; |
Kowloon Bay |
- Backfilling at Stage 2 UWT; |
· Section 1: Introduction
· Section 2: Project Information
· Section 3: Environmental Monitoring Requirement
· Section 4: Implementation Status of Environmental Mitigation Measures
· Section 5: Monitoring Results
· Section 6: Environmental Site Inspection and Audit
· Section 7: Environmental Non-conformance
· Section 8: Future Key Issues
· Section 9: Conclusions and Recommendations
(a) construction of approximately 160m long cut-and-cover tunnel and 370m long underwater tunnel between the tunnel section at Ma Tau Kok and the depressed road of the CKR within Kai Tak Development;
(b) reconstruction of the seawall at Ma Tau Kok public pier, and the sloping seawall at the Former Kai Tak Airport Runway;
(c) construction of approximately 125m long depressed road and 200m long underpass of the CKR within Kai Tak Development;
(d) construction of approximately 360m long underground tunnel ventilation adit of the CKR;
(e) reconstruction of Kowloon City Ferry Pier Public Transport Interchange; and
(f) other associated works.
Table 2.1 Construction Activities in the reporting month
Locations |
Site Activities |
Kai Tak |
- Defect rectification works at underpass, depressed road and C&C |
Ma Tau Kok |
- TTM implementation; |
Kowloon Bay |
- Backfilling at Stage 2 UWT; |
Table 2.2 Contact Information of Key Personnel
Party |
Role |
Position |
Name |
Telephone |
Fax |
Arup-Mott MacDonald Joint Venture |
Residential Engineer (ER) |
Engineer’s Representative |
Mr. Patrick Lo |
36195901 |
2268 3954 |
ERM |
Independent Environmental Checker (IEC) |
Independent Environmental Checker |
Ms. Mandy To |
2271 3113 |
3015 8052 |
Gammon |
Contractor |
Contracts Manager |
Mr. Kin Fai Tam |
2516 8823 |
2516 6260 |
Environmental Manager |
Ms. Michelle Tang |
9267 8866 |
2516 6260 |
||
AECOM |
Contractor’s Environmental Team (ET) |
ET Leader |
Mr. Y. W. Fung |
3856 5681 |
2317 7609 |
Table 2.3 Status of Environmental Licenses, Notifications and Permits
Permit / License No. / Notification/ Reference No. |
Valid Period |
Status |
Remarks |
|
From |
To |
|||
Further Environmental Permit |
||||
FEP-01/457/2013/C |
28 Feb 2018 |
End of Project |
Valid |
-- |
Wastewater Discharge License |
||||
WT00043692-2023 |
1 Apr 2023 |
31 Mar 2028 |
Valid |
Ma Tau Kok |
WT00043881-2023 |
30 Jun 2023 |
30 Jun 2028 |
Valid |
Underwater Tunnel Stage 2 |
WT00044013-2023 |
1 May 2023 |
30 Apr 2028 |
Valid |
Kai Tak and Underwater Tunnel Stage 1 |
Construction Noise Permit |
||||
GW-RE1491-24 |
1 Dec 2024 |
31 May 2025 |
Valid |
General Works at Ma Tau Kok |
GW-RE1561-24 |
15 Dec 2024 |
14 Jun 2025 |
Valid |
General Works at Kai Tak |
GW-RE1300-24 |
21 Oct 2024 |
20 Apr 2025 |
Valid |
General Works at Promenade |
GW-RE1423-24 |
19 Nov 2024 |
18 May 2025 |
Valid |
General Works at Stage 1 Underwater Tunnel |
GW-RE1515-24 |
7 Dec 2024 |
6 Jun 2025 |
Valid |
General Works at Stage 2 Underwater Tunnel |
GW-RE1149-24 |
19 Sep 2024 |
18 Mar 2025 |
Valid |
Kai Tak Access Road |
Chemical Waste Producer Registration |
||||
5118-247-G2347-47 |
30 Jan 2018 |
End of Project |
Valid |
-- |
5118-247-G2347-48 |
30 Jan 2018 |
End of Project |
Valid |
-- |
Marine Dumping Permit |
||||
-- |
-- |
-- |
-- |
-- |
Billing Account for Construction Waste Disposal |
||||
7029909 |
22 Jan 2018 |
End of Project |
Account Active |
-- |
Notification Under Air Pollution Control (Construction Dust) Regulation |
||||
429442 |
5 Jan 2018 |
5 Jul 2025 |
Notified |
-- |
|
Monitoring Requirements
Monitoring Equipment
Table 3.1 Air Quality Monitoring Equipment
Tisch
Total Suspended Particulate Mass Flow Controlled High Volume Air Sampler |
|
Calibration Kit (24-hour TSP) |
TISCH
Environmental Orifice |
Portable
direct reading dust meter |
Sibata
Digital Dust Monitor |
Monitoring Locations
Table 3.2 Location of Construction Dust Monitoring Station
Location |
Monitoring Station |
Description |
E-A14a [1] |
Block B of Merit Industrial Centre |
Rooftop (13/F) |
[1] The air monitoring station proposed in the EM&A Manual (i.e. Wyler Gardens with ID: E-A14) was not available for impact dust monitoring, therefore impact monitoring was conducted at E-A14a as an alternative which was agreed by the ER, IEC and EPD.
Monitoring Methodology
(a) The HVS was installed in the vicinity of the air sensitive receivers. The following criteria were considered in the installation of the HVS as far as practicable: -
(i) A horizontal platform with appropriate support to secure the sampler against gusty wind was provided.
(ii) Two samplers should not be placed less than 2m apart from each other;
(iii) The distance between the HVS and any obstacles, such as buildings, was at least twice the height that the obstacle protrudes above the HVS.
(iv) A minimum of 2 meters separation from walls, parapets and penthouse for rooftop sampler.
(v) A minimum of 2 meters separation from any supporting structure, measured horizontally is required.
(vi) No furnace or incinerator flues nearby.
(vii) Airflow around the sampler was unrestricted.
(viii) The sampler was located more than 20 meters from any dripline.
(ix) Any wire fence and gate, required to protect the sampler, did not obstruct the monitoring process.
(x) Permission was obtained to set up the samplers and access to the monitoring station.
(xi) A secured supply of electricity was obtained to operate the sampler.
(b) Preparation of Filter Papers
(i) Glass fibre filters, G810 were labelled and sufficient filters that were clean and without pinholes were selected.
(ii) All filters were equilibrated in the conditioning environment for 24 hours before weighing. The conditioning environment temperature was around 25 °C and not variable by more than ±3 °C; the relative humidity (RH) was < 50% and not variable by more than ±5%. A convenient working RH was 40%.
(iii) All filter papers were prepared and analysed by ALS Technichem (HK) Pty Ltd., which is a HOKLAS accredited laboratory and has comprehensive quality assurance and quality control programmes.
(c) Field Monitoring
(i) The power supply was checked to ensure the HVS works properly.
(ii) The filter holder and the area surrounding the filter were cleaned.
(iii) The filter holder was removed by loosening the four bolts and a new filter, with stamped number upward, on a supporting screen was aligned carefully.
(iv) The filter was properly aligned on the screen so that the gasket formed an airtight seal on the outer edges of the filter.
(v) The swing bolts were fastened to hold the filter holder down to the frame. The pressure applied was sufficient to avoid air leakage at the edges.
(vi) Then the shelter lid was closed and was secured with the aluminium strip.
(vii) The HVS was warmed-up for about 5 minutes to establish run-temperature conditions.
(viii) A new flow rate record sheet was set into the flow recorder.
(ix) On site temperature and atmospheric pressure readings were taken and the flow rate of the HVS was checked and adjusted at around 1.3 m3/min, and complied with the range specified in the EM&A Manual (i.e. 0.6-1.7 m3/min).
(x) The programmable digital timer was set for a sampling period of 24 hrs, and the starting time, weather condition and the filter number were recorded.
(xi) The initial elapsed time was recorded.
(xii) At the end of sampling, on site temperature and atmospheric pressure readings were taken and the final flow rate of the HVS was checked and recorded.
(xiii) The final elapsed time was recorded.
(xiv) The sampled filter was removed carefully and folded in half length so that only surfaces with collected particulate matter were in contact.
(xv) It was then placed in a clean envelope and sealed.
(xvi) All monitoring information was recorded on a standard data sheet.
(xvii) Filters were then sent to ALS Technichem (HK) Pty Ltd. for analysis.
(d) Maintenance and Calibration
(i) The HVS and its accessories were maintained in good working condition, such as replacing motor brushes routinely and checking electrical wiring to ensure a continuous power supply.
(ii) HVSs were calibrated using TE-5025A Calibration Kit upon installation and thereafter at bi-monthly intervals.
(iii) Calibration certificate of the TE-5025A Calibration Kit and the HVSs are provided in Appendix E.
(a) Measuring Procedures
The measuring procedures of the 1-hour dust meter are in accordance with the Manufacturer’s Instruction Manual as follows:
(i) Turn the power on.
(ii) Close the air collecting opening cover.
(iii) Push the “TIME SETTING” switch to [BG]
(iv) Push “START/STOP” switch to perform background measurement for 6 seconds.
(v) Turn the knob at SENSI ADJ position to insert the light scattering plate.
(vi) Leave the equipment for 1 minute upon “SPAN CHECK” is indicated in the display.
(vii) Push “START/STOP” switch to perform automatic sensitivity adjustment. This measurement takes 1 minute.
(viii) Pull out the knob and return it to MEASURE position.
(ix) Push the “TIME SETTING” switch the time set in the display to 3 hours.
(x) Lower down the air collection opening cover.
(xi) Push “START/STOP” switch to start measurement.
(b) Maintenance and Calibration
(i) The 1-hour TSP meter was calibrated at 1-year intervals against a High Volume Samplers. Calibration certificates of the Laser Dust Monitors are provided in Appendix E.
Monitoring Schedule for the Reporting Month
Monitoring Requirements
Table 3.3 Noise Monitoring Parameters, Frequency and Duration
Parameter and Duration |
Frequency |
30-mins measurement at each monitoring station between 0700 and 1900 on normal weekdays. Leq, L10 and L90 would be recorded. |
At least once per week |
Table 3.4 Noise Monitoring Equipment for Regular Noise Monitoring
B&K (Model No. 2250 & 2250L) |
|
Acoustic Calibrator |
B&K (Model No. 4231) Rion(Model No. NC-74) MVI(Model No. CAL21) |
Monitoring Locations
Table 3.5 Noise Monitoring Stations during Construction Phase
Location |
Monitoring Station |
Description |
Measurement |
E-N12a [1] |
19 Hing Yan Street |
Rooftop (9/F) |
Façade |
E-N21a [1] |
Block B of Merit Industrial Centre |
Rooftop (13/F) |
Free field[2] |
Notes:
[1] The noise monitoring stations proposed in the EM&A Manual (i.e. Grand Waterfront Tower 3 with ID: E-N12 and Hang Chien Court Block J with ID: E-N21) were not available for impact noise monitoring, therefore impact monitoring was conducted at E-N12a and E-N21a as an alternative which was agreed by the ER, IEC and EPD.
[2] A correction of +3 dB(A) was made to the free field measurements.
Monitoring Parameters, Frequency and Duration
Table 3.6 Noise Monitoring Parameters, Frequency and Duration
Location |
Parameter and Duration |
Frequency |
E-N12a and E-N21a |
30-mins measurement at each monitoring station between 0700 and 1900 on normal weekdays. Leq, L10 and L90 would be recorded. |
At least once per week |
Monitoring Methodology
(a) The sound level meter was set on a tripod at a height of 1.2 m above the ground.
(b) Façade measurement was made at E-N12a.
(c) Free field measurements was made at monitoring location E-N21a. A correction of +3 dB(A) shall be made to the free field measurements.
(d) The battery condition was checked to ensure the correct functioning of the meter.
(e) Parameters such as frequency weighting, the time weighting and the measurement time were set as follows:
(i) frequency weighting
(ii) time weighting: Fast
(iii) time measurement: Leq(30-minutes) during non-restricted hours i.e. 0700 – 1900 on normal weekdays.
(f) Prior to and after each noise measurement, the meter was calibrated using the acoustic calibrator for 94 dB(A) at 1000 Hz. If the difference in the calibration level before and after measurement was more than 1 dB(A), the measurement would be considered invalid and repeat of noise measurement would be required after re-calibration or repair of the equipment.
(g) During the monitoring period, the Leq, L10 and L90 were recorded. In addition, site conditions and noise sources were recorded on a standard record sheet.
(h) Noise measurement was paused during periods of high intrusive noise (e.g. dog barking, helicopter noise) if possible. Observations were recorded when intrusive noise was unavoidable.
(i) Noise monitoring was cancelled in the presence of fog, rain, wind with a steady speed exceeding 5m/s, or wind with gusts exceeding 10m/s.
(a) The microphone head of the sound level meter was cleaned with soft cloth at regular intervals.
(b) The meter and calibrator were sent to the supplier or HOKLAS laboratory to check and calibrate at yearly intervals.
(c) Calibration certificates of the sound level meters and acoustic calibrators are provided in Appendix E.
Monitoring Schedule for the Reporting Month
Table 4.1 Status of Required Submission under Environmental Permit
EP Condition |
Submission |
Submission Date |
Condition 3.4 of |
Monthly EM&A Report for January 2025 |
14 February 2025 |
Table 5.1 Summary of 24-hour TSP Monitoring Result in the Reporting Period
ID |
Average (mg/m3) |
Range (mg/m3) |
Action Level (mg/m3) |
Limit Level (mg/m3) |
E-A14a |
31.6 |
17.8 - 72.8 |
197.3 |
260 |
Table 5.2 Summary of 1-hour TSP Monitoring Result in the Reporting Period
ID |
Average (mg/m3) |
Range (mg/m3) |
Action Level (mg/m3) |
Limit Level (mg/m3) |
E-A14a |
61.1 |
57.7 – 64.3 |
302.4 |
500 |
Table 5.3 Summary of Construction Noise Monitoring Results in the Reporting Period
ID |
Range, dB(A), Leq (30 mins) |
Limit Level, dB(A), Leq (30 mins) |
E-N12a |
63.1 – 70.1 |
75 |
E-N21a |
58.7 – 62.2 |
75 |
Table 6.1 Observations and Recommendations of Site Audit
Parameters |
Date |
Observations and Recommendations |
Follow-up |
Air Quality |
Nil |
Nil |
Nil |
Noise |
5 February 2025 |
Reminder: The contractor was reminded to wrap with acoustic sheet on the breaker head at stage 2 marine platform. |
The item was rectified by the
Contractor on |
19 February 2025 |
Reminder: The contractor was reminded to wrap with acoustic sheet on the breaker head at stage 2 marine platform. |
The item was rectified by the
Contractor on |
|
Water Quality |
Nil |
Nil |
Nil |
Waste/ Chemical Management |
12 February 2025 |
Reminder: The Contractor was reminded provide drip tray at stage 2 marine platform. |
The item was rectified by the
Contractor on |
26 February 2025 |
Reminder: The contractor was reminded to provide drip tray to contain the oil hose at stage 2 marine platform. |
The item was rectified by the
Contractor on |
|
Landscape & Visual |
Nil |
Nil |
Nil |
Permits/ Licenses |
Nil |
Nil |
Nil |
*The item was under rectification on last reporting month.
Table 8.1 Construction Activities in the coming three months
Locations |
Site Activities |
Kai Tak |
- Defect rectification works at underpass, depressed road and C&C |
Ma Tau Kok |
- TTM implementation; |
Kowloon Bay |
- Backfilling at Stage 2 UWT; |
Document control record
Document prepared by:
Aurecon Hong Kong Limited
Unit 1608, 16/F, Tower B,
Manulife Financial Centre
223 -231 Wai Yip Street, Kwun Tong, Kowloon, Hong Kong.
T |
3664
6888 |
A person using Aurecon documents or data accepts the risk of:
a) Using the documents or data in electronic form without requesting and checking them for accuracy
b) Using the documents or data for any purpose not agreed to in writing by Aurecon.
c) against the original hard copy version.
Document control |
|
|||||
Report title |
Monthly Environmental Monitoring and Audit – Kai Tak Phase 2B Landscape Deck – Report No. 4 (Period from 1st to 28th February 2025) |
|||||
Document code |
|
Project number |
P528199 |
|||
File path |
|
|||||
Client |
Build King – Tung Lee Joint Venture |
|||||
Client contact |
|
Client reference |
|
|||
Rev |
Date |
Revision details/status |
Author |
Reviewer |
Verifier |
Approver |
0 |
2025-03-05 |
First issue |
Kisten Ma |
F.C. Tsang |
|
F.C. Tsang |
1 |
2025-03-10 |
Second issue |
Kisten Ma |
F.C. Tsang |
|
F.C. Tsang |
|
|
|
|
|
|
|
|
|
|
|
|
|
|
Current revision |
1 |
Approval |
|||
Author signature |
|
Approver signature |
|
Name |
Kisten Ma |
Name |
F.C. Tsang |
Title |
Senior Consultant |
Title |
Environmental Team Leader |
3 Air Quality and Noise Monitoring
6 Summary of Complaints, Notification of Summons and Prosecutions
9 Conclusion and Recommendations
·
Appendices
Appendix A Alignment and Works Site in Kai Tak West Area for the Contract No. HY/2023/08

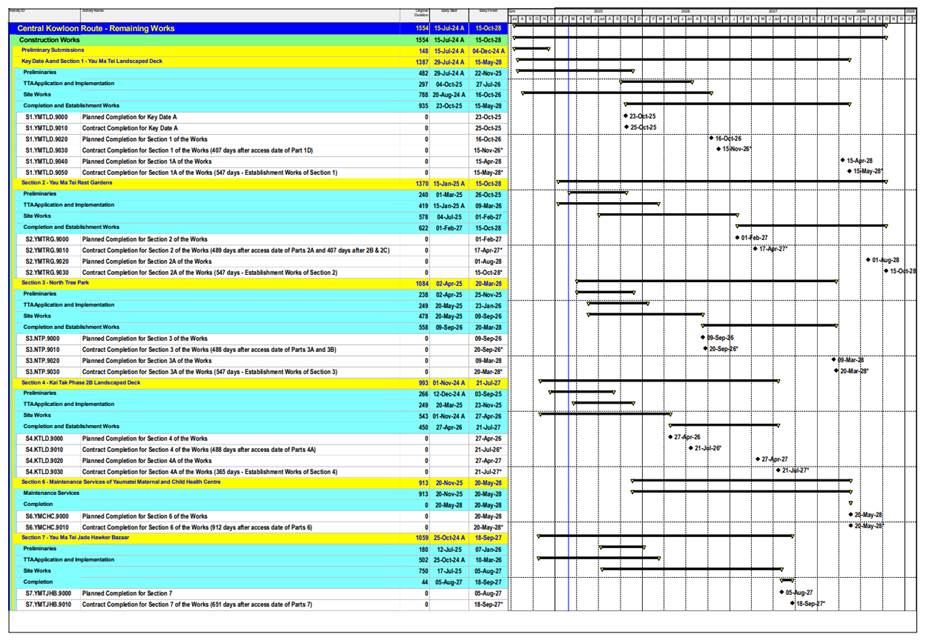

Appendix B Construction Programme

Appendix C Project Organization Chart
Appendix D Event and Action Plan (EAP) (Air Quality Monitoring)
Appendix E Event and Action Plan (EAP) (Noise Monitoring)
Appendix F Environmental Mitigation Implementation Schedule (EMIS)
Appendix G Waste Flow Table
Appendix H Statistics on Complaint, Notifications of Summons and Successful Prosecutions
1.1.1 Build King - Lee Tung Joint Venture (“Contractor”) commenced the construction works of Highway Department (HyD) Central Kowloon Route Contract No. HY/2023/08 – Central Kowloon Route – Remaining Works at Kai Tak West Area (“The Project”) on 11 November 2024. This is the 4th monthly Environmental Monitoring and Audit (EM&A) report presenting the EM&A works carried out in the Kai Tak West Area during the period from 1 February 2025 to 28 February 2025.
1.1.2 A summary of major construction activities informed by the Contractor for the Project during the reporting period is presented below.
Construction Activities Undertaken in Kai Tak West Area |
· Planter wall construction at Kai Tak Phase 2B Landscaped Deck |
Environmental Monitoring and Audit Works
1.1.3 Regular construction air quality monitoring (24-hour TSP and 1-hour TSP) and noise monitoring works in Kai Tak West Area are currently covered under the Contract No. HY/2014/07 – Central Kowloon Route – Kai Tak West. The details of the monitoring works could be referred to Sections 3 and 5 of the corresponding Monthly EM&A Report for Contract No. HY/2014/07.
1.1.4 Joint weekly site inspections were conducted by representatives of the Environmental team (ET), the Contractor and the Engineer on 7, 14, 21 and 28 February 2025. A joint site inspection with the Independent Environmental Checker (IEC) was undertaken on 14 February 2025. Bi-weekly inspection of the implementation of landscape and visual mitigation measures was conducted by the ET on 7 and 21 February 2025. Details of the audit findings and implementation status are presented in Section 7. Details of waste management are presented in Section 4.
1.1.5 A summary of the non-compliance (exceedance) during the reporting period is provided below.
- No Action / Limit Level exceedance for 1-hour TSP was recorded.
- No Action / Limit Level exceedance for 24-hour TSP was recorded.
- No Action / Limit Level exceedance for construction noise was recorded.
Complaints, Notification of Summons and Successful Prosecution
1.1.6 No environmental related complaints, notification of summons and successful prosecution were received in the reporting period.
Reporting Changes
1.1.7 There were no reporting changes during the reporting period.
Future Key Issues
1.1.8 A summary of construction activities informed by the Contractor for the next reporting period are listed below:
Construction Activities To be Undertaken in Kai Tak West Area |
· Planter wall construction at Kai Tak Phase 2B Landscaped Deck · Preparation works prior to the Ramp Construction |
1.1.1 Central Kowloon Route (CKR) is a 4.7 km long dual 3-lane trunk road in Central Kowloon linking Yau Ma Tei Interchange in West Kowloon with the road network on Kai Tak Development and Kowloon Bay in East Kowloon.
1.1.2 The Central Kowloon Route – Design and Construction Environmental Impact Assessment Report (Register No.: AEIAR-171/2013) was approved with conditions by the Environmental Protection Department (EPD) on 11 July 2013. An Environmental Permit (EP 457/2013) was issued on 9 August 2013. Variations of EP (VEP) was subsequently applied for and the latest EP (EP-457/2013/D) was issued by EPD on 15 June 2021.
1.1.3 The construction of the CKR had been divided into different sections. Contract No. HY/2023/08 – Central Kowloon Route – Remaining Works covers part of the construction activities located at Kai Tak West Area and Yau Ma Tei Area under the EP, including:
1.1.4 The works site at Kai Tak West Area for the Contract No. HY/2023/08 are shown in Appendix A.
1.2 Purpose of the Report
1.2.1 This is the 4th monthly Environmental Monitoring and Audit (EM&A) report presenting the EM&A works carried out for the Project in the Kai Tak West Area during the period from 1 February 2025 to 28 February 2025.
1.3 Construction Activities Undertaken During the Reporting Period
1.3.1 A summary of major construction activities carried out during the reporting period are presented in Table 1.1. The construction programme is presented in Appendix B.
Table 1.1 Summary of Construction Activities during the Reporting Period
Construction Activities Undertaken in Kai Tak West Area |
Progress |
· Planter Wall construction at Kai Tak Phase 2B Landscaped Deck |
25% |
1.4 Project Organisation
1.4.1 The project organization structure is shown in Appendix C. The key personnel contact names and numbers for the Project are summarized in Table 1.2.
Table 1.2 Contact Information of Key Personnel
Party |
Role |
Position |
Name |
Contact No. |
Arup – Mott MacDonald Joint Venture |
Engineer’s Representative (“ER”) |
Resident Engineer (Environmental) |
Ms. Jim Li |
9120 1157 |
ERM – Hong Kong Limited |
Independent Environmental Checker (“IEC”) |
IEC |
Ms. Mandy To |
2271 3313 |
Aurecon Hong Kong Limited |
Environmental Team (“ET”) |
ET Leader |
Mr. F. C. Tsang |
3664 6801 |
Build King – Tung Lee Joint Venture |
Contractor |
Environmental Officer |
Mr. Samuel Pang |
9876 9121 |
1.5 Status of Environmental Licences, Notification and Permit
1.5.1 A summary of the valid permits, licences, and/ or notifications on environmental protection for this Project is presented in Table 1.3.
Table 1.3 Summary of the Environmental Licence, Notification, Permit and Documentations
Permit/ License/ Notification / Reference No. |
Valid Period |
Status |
Remark |
|
From |
To |
|
|
|
Environmental Permit |
||||
EP-457/2013/D |
15 June 2021 |
-- |
Valid |
-- |
Wastewater Discharge License |
||||
10012153 |
-- |
-- |
Application submitted on 11 December 2024 |
-- |
Notification of Construction Works Under the Air Pollution Control (Construction Dust Regulation) |
||||
10007346 |
25 July 2024 |
End of Project |
Notified |
-- |
Chemical Waste Producer Registration |
||||
5213-252-B2767-01 |
14 August 2024 |
-- |
Valid |
-- |
Billing Account for Disposal of Construction Waste |
||||
7051793 |
6 August 2024 |
-- |
Valid |
-- |
Y-Park Membership |
||||
C0280 |
12 August 2024 |
-- |
Valid |
-- |
Construction Nosie Permit |
||||
GW-RE0080-25 |
3 February 2025 |
31 July 2025 |
Valid |
General Activities at Kai Tak Phase 2B Landscaped Deck |
2.1 Environmental Permit (EP) Submission Status
2.2 Environmental permit (EP) conditions under the EIAO, submission status under the EP and implementation status of mitigation measures had been reviewed and implemented on schedule. The status of required submissions under the EP (EP-457/2013/D) during the reporting period for the Project are summarised in Table 2.1.
Table 2.1 Summary of Status of Required Submission for EP-457/2013/D for the Project
EP Condition |
Submission |
Submission Date |
2.9 |
Construction Noise Mitigation Plan (CNMMP) (Version 3.0) |
27 February 2025 |
3.4 |
Monthly EM&A Report – Kai Tak Phase 2B Landscape Deck (January 2025) |
14 February 2025 |
3 Air Quality and Noise Monitoring
3.1 Air Quality
Monitoring Requirements and Results
3.1.1 The air quality (24-hour TSP, 1-hour TSP) monitoring works in Kai Tak West Area are currently covered under Contract No. HY/2014/07 – Central Kowloon Route – Kai Tak West. Details of the corresponding monitoring parameters, equipment, methodology, monitoring schedule wind data, results and the established Action and Limit Levels could be referred to Sections 3 and 5 of the corresponding Monthly EM&A Report for Contract No. HY/2014/07.
Observations
3.1.2 No Action/ Limit Level exceedance was recorded for all 1-hour TSP and 24-hour TSP monitoring in the reporting period.
3.1.3 Site audits were carried out on a weekly basis to monitor and audit the timely implementation of air quality mitigation measures within the site boundaries of this Project. A summary of observation during the site audits is shown in Table 7.1 of this report.
3.2 Noise
Monitoring Requirements and Results
3.2.1 The construction noise monitoring works in Kai Tak West Area are currently covered under Contract No. HY/2014/07 – Central Kowloon Route – Kai Tak West. Details of the corresponding monitoring parameters, equipment, methodology, results and the established Action and Limit Levels could be referred to Sections 3 and 5 of the corresponding Monthly EM&A Report for Contract No. HY/2014/07.
Observations
3.2.2 No Action/ Limit Level exceedance was recorded for construction noise monitoring in the reporting period.
3.2.3 Site audits were carried out on a weekly basis to monitor and audit the timely implementation of noise mitigation measures within the site boundaries of this Project. A summary of observations during the site audits is shown in Table 7.1 of this report.
4 Waste Management
4.1.1 Waste generated from this Project includes inert C&D materials and non-inert C&D materials. Non-inert C&D materials are made up of general refuse, vegetative wastes and recyclable wastes such as plastics and paper/ cardboard packaging waste. Steel materials generated from the project are also grouped into non-inert C&D materials as the materials were not disposed of with other inert C&D materials. As advised by the Contractor, no inert C&D materials, non-inert C&D materials nor chemical waste was generated and disposed of during this reporting period.
4.1.2 With reference to relevant handling records and trip tickets of this Project, the quantities of different types of waste generated in the reporting period are summarised in Table 4.1. Details of cumulative waste management data are presented as a waste flow table in Appendix G.
Table 4.1 Quantities of Waste Generated from the Project in the Reporting Period
Reporting period |
Quantity |
|||||
Inert C&D Materials (in ‘000 kg) |
Chemical Waste (in ‘kg) |
Non-inert C&D Materials |
||||
Others, e.g. General Refuse disposed of at Landfill (in ‘000kg) |
Recycled materials |
|||||
Paper/ cardboard (in ‘000kg) |
Plastics (in ‘000 kg) |
Metals (in ‘000 kg) |
||||
Feb 2025 |
0.00 |
0.00 |
0.00 |
0.00 |
0.00 |
0.00 |
5.1.1 As per the EM&A Manuals, the landscape and visual mitigation measures shall be implemented, and site inspections should be undertaken once every two weeks during the construction period.
5.1.2 Bi-weekly inspection of the implementation of landscape and visual mitigation measures was conducted on 7 and 21 February 2025. The observations and recommendations made during the site inspections are presented in Table 7.1. A summary of the implementation status is presented in Appendix F.
6 Summary of Complaints, Notification of Summons and Prosecutions
6.1.1 The environmental Complaints Handling Procedures is shown below.
Complaint Received via Project Hotline |
Complaint Received via 1823 or from other government departments |
||||
|
|
|
|
||
Contractor notify ER, ET and IEC |
ER notify Contractor, ET and IEC |
||||
|
|
|
|
||
Contractor log complaint and date of receipt onto the complaint database. Contractor, ER and ET to conduct investigation of complaint |
|||||
|
|
|
|
||
If complaint is considered not valid |
If complaint is found valid |
||||
|
|
|
|
||
ET or ER to reply to the complainant if necessary |
Contractor to identify and implement remedial measures in consultation with the IEC, ET and ER. |
||||
|
|
|
|
||
|
|
The ER, ET and IEC to review the effectiveness of the Contractor’s remedial measures and the updated situation; ET to undertake additional monitoring and audit to verify the situation if necessary and oversee that circumstances leading to the complaint do not recur. ER to conduct further inspection as necessary. |
|||
|
|
|
|
||
If the complaint is referred by the EPD, the Contractor to prepare interim report on the status of the complaint investigation and follow-up actions stipulated above, including the details of the remedial measures and additional monitoring identified or already taken, for submission to EPD within the timeframe assigned by the EPD |
|||||
|
|
|
|||
The ET to record the details of the complaint, results of the investigation, subsequent actions taken to address the complaint and updated situation including the effectiveness of the remedial measures, supported by regular and additional monitoring results in the monthly EM&A reports |
|||||
6.1.2 Should non-compliance of the criteria occur, action in accordance with the Event and Action Plan in Appendix D and Appendix E shall be carried out.
6.1.3 No exceedance of the Action and Limit Levels of air quality (1-hour TSP and 24-hour TSP) monitoring and noise monitoring was recorded in the reporting period.
6.1.4 No complaint was received in the reporting period.
6.1.5 No non-compliance was received in the reporting period.
6.1.6 No notification of summons and successful prosecution was received in the reporting period.
6.1.7 Statistics on complaints, notifications of summons and successful prosecutions are summarized in Appendix H.
7.1.1 Site inspections were carried out on a weekly basis to monitor the implementation of proper environmental pollution control and mitigation measures under the Contract. In the reporting period, 4 site inspections were carried out by the representative of ET, Contractor and Engineer on 7, 14, 21 and 28 February 2025, along with bi-weekly inspection of the implementation of landscape and visual mitigation measures conducted on 7 and 21 February 2025.
7.1.2 One joint site inspection with the IEC was also undertaken on 14 February 2025. No deficiencies were observed during weekly site inspection. Key observations during the site inspections are summarized in Table 7.1.
Table 7.1 Summary of Site Observation
Date |
Environmental Observations |
Follow-up Status |
7 February 2025 |
1. A breaker head was observed placed on ground without protection, tarpaulin sheet should be placed underneath the breaker head to prevent leakage. |
1. Tarpaulin sheet was provided underneath and wrapped around breaker head (Rectified on 7 February 2025). |
14 February 2025 |
Nil |
Nil |
21 February 2025 |
1. A breaker head was observed directly placed on ground, impervious sheet should be placed underneath for protection. |
1. Tarpaulin sheet was provided underneath and wrapped around breaker head (Rectified on 21 February 2025). |
28 February 2025 |
Nil |
Nil |
7.1.3 The Contractor has rectified all observation identified during environmental site inspection.
7.1.4 According to the EIA Study Report, Environmental Permit, contract documents and EM&A Manual, the mitigation measures detailed in the documents had been implemented as much as practical during the reporting period. An updated Implementation Status of Environmental Mitigation Measures (EMIS) is provided in Appendix F.
8.1.1 The construction activities to be undertaken in the next reporting period are listed below:
Construction Activities To be Undertaken in Kai Tak West Area |
· Planter wall construction at Kai Tak Phase 2B Landscaped Deck · Preparation works prior to the Ramp Construction |
8.1.2 Potential environmental impacts arising from the above construction activities are mainly associated with dust and waste management.
8.1.3 The tentative schedule of air quality (1-hour TSP and 24-hour TSP) monitoring and noise monitoring in the next reporting period is presented in Appendix F of the corresponding Monthly EM&A Report for Contract No. HY/2014/07.
8.1.4 The construction programme for the Project for the next reporting period is presented in Appendix B.
9 Conclusion and Recommendations
9.1.1 This is the 4th monthly EM&A Report presenting the EM&A works undertaken in Kai Tak West Area during the period from 1 February 2025 to 28 February 2025 in accordance with the EM&A Manual and the requirement under EP-457/2013/D.
9.1.2 Air quality monitoring (including 1-hour TSP and 24-hour TSP) and noise monitoring were carried out in the reporting period under Contract No. HY/2014/07. No exceedance of the Action or Limit Level was recorded for air quality monitoring and noise during the reporting period.
9.1.3 Weekly environmental site inspections by representatives of the ET, the Contractor and the Engineer were conducted during the reporting period. One joint site inspection with the IEC was carried out on 14 February 2025. Minor deficiency was observed during site inspection and was rectified within specified deadlines. The environmental performance of the Project was therefore considered satisfactory.
9.1.4 No complaint was received in the reporting period.
9.1.5 No non-compliance situation was received in the reporting period.
9.1.6 No notification of summons or prosecution was received since commencement of the Contract.
9.1.7 The ET will keep track on the construction works to confirm compliance of environmental requirements and the proper implementation of all necessary mitigation measures.
Appendix A
Alignment and Works Site in Kai Tak West Area for the Contract No. HY/2023/08
Kai Tak Phase
2B Landscaped Deck
Appendix B
Construction Programme
Appendix C
Project Organisation Chart
Appendix D
Event and Action plan (EAP) (Air Quality Monitoring)
EVENT |
ACTION |
|||
ENVIRONMENTAL TEAM (ET) |
INDEPENDENT ENVIRONMENTAL CHECKER (IEC) |
ENGINEER’S REPRESENTATIVE (ER) |
CONTRACTOR |
|
ACTION LEVEL |
||||
Exceedance for one sample |
1. Identify source, investigate the causes of exceedance and propose remedial measures; 2. Inform IEC and ER; 3. Repeat measurement to confirm finding; 4. Increase monitoring frequency to daily. |
1. Check monitoring data submitted by ET; 2. Check Contractor’s working method. |
1. Notify Contractor. |
1. Rectify any unacceptable practice; 2. Amend working methods if appropriate. |
Exceedance for two or more consecutive samples |
1. Identify source; 2. Inform IEC and ER; 3. Advise the ER on the effectiveness of the proposed remedial measures; 4. Repeat measurements to confirm findings; 5. Increase monitoring frequency to daily; 6. Discuss with IEC and Contractor on remedial actions required; 7. If exceedance continues, arrange meeting with IEC and ER; 8. If exceedance stops, cease additional monitoring. |
1. Check monitoring data submitted by ET; 2. Check Contractor’s working method; 3. Discuss with ET and Contractor on possible remedial measures; 4. Advise the ET on the effectiveness of the proposed remedial measures; 5. Supervise Implementation of remedial measures. |
1. Confirm receipt of notification of failure in writing; 2. Notify Contractor; 3. Ensure remedial measures properly implemented.
|
1. Submit proposals for remedial to ER within 3 working days of notification; 2. Implement the agreed proposals; 3. Amend proposal if appropriate. |
LIMIT LEVEL |
||||
Exceedance for one sample |
1. Identify source, investigate the causes of exceedance and propose remedial measures; 2. Inform ER, Contractor and EPD; 3. Repeat measurement to confirm finding; 4. Increase monitoring frequency to daily; 5. Assess effectiveness of Contractor’s remedial actions and keep IEC, EPD and ER informed of the results. |
1. Check monitoring data submitted by ET; 2. Check Contractor’s working method; 3. Discuss with ET and Contractor on possible remedial measures; 4. Advise the ER on the effectiveness of the proposed remedial measures; 5. Supervise implementation of remedial measures. |
1. Confirm receipt of notification of failure in writing; 2. Notify Contractor; 3. Ensure remedial measures properly implemented. |
1. Take immediate action to avoid further exceedance; 2. Submit proposals for remedial actions to IEC within 3 working days of notification; 3. Implement the agreed proposals; 4. Amend proposal if appropriate. |
Exceedance for two or more consecutive samples |
1. Notify IEC, ER, Contractor and EPD; 2. Identify source; 3. Repeat measurement to confirm findings; 4. Increase monitoring frequency to daily; 5. Carry out analysis of Contractor’s working procedures to determine possible mitigation to be implemented; 6. Arrange meeting with IEC and ER to discuss the remedial actions to be taken; 7. Assess effectiveness of Contractor’s remedial actions and keep IEC, EPD and ER informed of the results; 8. If exceedance stops, cease additional monitoring. |
1. Discuss amongst ER, ET, and Contractor on the potential remedial actions; 2. Review Contractor’s remedial actions whenever necessary to assure their effectiveness and advise the ER accordingly; 3. Supervise the implementation of remedial measures. |
1. Confirm receipt of notification of failure in writing; 2. Notify Contractor; 3. In consultation with the IEC, agree with the Contractor on the remedial measures to be implemented; 4. Ensure remedial measures properly implemented; 5. If exceedance continues, consider what portion of the work is responsible and instruct the Contractor to stop that portion of work until the exceedance is abated. |
1. Take immediate action to avoid further exceedance; 2. Submit proposals for remedial actions to IEC within 3 working days of notification; 3. Implement the agreed proposals; 4. Resubmit proposals if problem still not under control; 5. Stop the relevant portion of works as determined by the ER until the exceedance is abated. |
Appendix E
Event and Action plan (EAP) (Noise Monitoring)
EVENT |
ACTION |
|||
ENVIRONMENTAL TEAM (ET) |
INDEPENDENT ENVIRONMENTAL CHECKER (IEC) |
ENGINEER’S REPRESENTATIVE ER |
CONTRACTOR |
|
Action Level |
1. Identify source, investigate the causes of exceedance and propose remedial measures; 2. Notify IEC and Contractor; 3. Report the results of investigation to the IEC, ER and Contractor; 4. Discuss with the Contractor and formulate remedial measures; 5. Increase monitoring frequency to check mitigation effectiveness. |
1. Review the analysed results submitted by the ET; 2. Review the proposed remedial measures by the Contractor and advise the ER accordingly; 3. Supervise the implementation of remedial measures. |
1. Confirm receipt of notification of failure in writing; 2. Notify Contractor; 3. Require Contractor to propose remedial measures for the analysed noise problem; 4. Ensure remedial measures are properly implemented |
1. Submit noise mitigation proposals to IEC; 2. Implement noise mitigation proposals. |
Appendix F
Environmental Mitigation Implementation Schedule (EMIS)
Environmental Mitigation Implementation Schedule
EIA Ref. |
EM&A Log Ref. |
Recommended Mitigation Measures |
Objectives of the Recommended Measures & Main Concerns to address |
Implementation Agent |
Location / Timing |
Implementation Stage |
Requirements and/ or standards to be achieved |
Implementation Status |
|
Construction Dust Impact |
|||||||||
S4.3.10 |
D1 |
The contractor shall follow the procedures and requirements given in the Air Pollution Control (Construction Dust) Regulation and Air Pollution Control (Non-road Mobile Machinery) (Emission) Regulation. |
Minimize dust impact and adverse health effects at the nearby sensitive receivers |
Contractor |
All construction sites |
Construction stage |
· APCO · To control the dust impact to meet HKAQO and TM-EIA criteria |
Implemented. |
|
S4.3.10 |
D2 |
· Mitigation measures in form of regular watering under a good site practice should be adopted. Watering once per hour on exposed worksites and haul road should be conducted to achieve dust removal efficiencies of 91.7%. While the above watering frequencies are to be followed, the extent of watering may vary depending on actual site conditions but should be sufficient to maintain an equivalent intensity of no less than 1.3 L/m2 to achieve the dust removal efficiency. |
Minimize dust impact at the nearby sensitive receivers |
Contractor |
All construction sites |
Construction stage |
· APCO · To control the dust impact to meet HKAQO and TM-EIA criteria |
Implemented. |
|
xS4.3.10 |
D3 |
·
Proper
watering at exposed spoil should be undertaken throughout the construction
phase; · Any excavated or stockpile of dusty material should be covered entirely by impervious sheeting or sprayed with water to maintain the entire surface wet and then removed or backfilled or reinstated where practicable within 24 hours of the excavation or unloading; · Any dusty materials remaining after a stockpile is removed should be wetted with water and cleared from the surface of roads; ·
A
stockpile of dusty material should not be extended beyond the pedestrian
barriers, fencing or traffic cones; · The load of dusty materials on a vehicle leaving a construction site should be covered entirely by impervious sheeting to ensure that the dusty materials do not leak from the vehicle. ·
Where
practicable, vehicle washing facilities with high pressure water jet should
be provided at every discernible or designated vehicle exit point. The area
where vehicle washing takes place and the road section between the washing
facilities and the exit point should be paved with concrete, bituminous
materials or hardcores; · When there are open excavation and reinstatement works, hoarding of not less than 2.4m high should be provided and properly maintained as far as practicable along the site boundary with provision for public crossing. Good site practice shall also be adopted by the Contractor to ensure the conditions of the hoardings are properly maintained throughout the construction period; · The portion of any road leading only to construction site that is within 30m of a vehicle entrance or exit should be kept clear of dusty materials; · Surfaces where any pneumatic or power-driven drilling, cutting, polishing or other mechanical breaking operation takes place should be sprayed with water or a dust suppression chemical continuously; · Any area that involves demolition activities should be sprayed with water or a dust suppression chemical immediately prior to, during and immediately after the activities so as to maintain the entire surface wet; · Any skip hoist for material transport should be totally enclosed by impervious sheeting; · Every stock of more than 20 bags of cement or dry-pulverised fuel ash (PFA) should be covered entirely by impervious sheeting or placed in an area sheltered on the top and the 3 sides; · Loading, unloading, transfer, handling or storage of bulk cement or dry PFA should be carried out in a totally enclosed system or facility, and any vent or exhaust should be fitted with an effective fabric filter or equivalent air pollution control system · Exposed earth should be properly treated by compaction, turfing, hydroseeding, vegetation planting or sealing with latex, vinyl, bitumen, shotcrete or other suitable surface stabilizer within six months after the last construction activity on the construction site or part of the construction site where the exposed earth lies. |
Minimize dust impact at the nearby sensitive receivers |
Contractor |
All construction sites |
Construction stage |
·
APCO · To control the dust impact to meet HKAQO and TM-EIA criteria |
Implemented, deficiency rectified after reminder for the 1st to 3rd bullets.
Implemented for the 4th bullet.
N/A for other bullets. |
|
S4.3.10 |
D6 |
Implement regular dust monitoring under EM&A programme during the construction stage. |
Monitoring of dust impact |
Contractor |
Selected rep. dust monitoring station |
Construction stage |
· TM-EIA |
Implemented |
|
Construction Noise (Airborne) |
|||||||||
S5.4.1 |
N1 |
Implement the following good site practices: · Only well-maintained plant should be operated on-site, and plant should be serviced regularly during the construction programme; · Machines and plant (such as trucks, cranes) that may be in intermittent use should be shut down between work periods or should be throttled down to a minimum; · Plant known to emit noise strongly in one direction, where possible, be orientated so that the noise is directed away from nearby NSRs; · Silencers or mufflers on construction equipment should be properly fitted and maintained during the construction works; · Mobile plant should be sited as far away from NSRs as possible and practicable; · Material stockpiles, mobile container site office and other structures should be effectively utilized, where practicable, to screen noise from on-site construction activities. |
Control construction airborne noise |
Contractor |
All construction sites |
Construction stage |
· Annex 5, TM-EIAO |
Implemented for the 1st, 2nd, 5th bullets, N/A for other bullets |
|
S5.4.1 |
N2 |
Install temporary hoarding located on the site boundaries between noisy construction activities and NSRs. The conditions of hoardings shall be properly maintained throughout the construction period. |
Reduce the construction noise levels at low-level zone of NSRs through partial screening |
Contractor |
All construction sites |
Construction stage |
· Annex 5, TM-EIAO |
N/A |
|
S5.4.1 |
N3 |
Install movable noise barriers (typical design is wooden framed barrier with a small-cantilevered on a skid footing with 25mm thick internal sound absorptive lining), acoustic mat or full enclosure, screen the noisy plants including air compressors, generators and handheld breakers, etc. |
Screen the noisy plant items to be used at all construction sites |
Contractor |
All construction sites where practicable |
Construction stage |
· Annex 5, TM-EIAO |
N/A |
|
S5.4.1 |
N4 |
Use ‘Quiet plant’ |
Reduce the noise levels of plant items |
Contractor |
All construction sites where practicable |
Construction stage |
· Annex 5, TM-EIAO |
N/A |
|
S5.4.1 |
N5 |
Loading/ unloading activities should be carried out inside the full enclosure of mucking out points. |
Reduce the noise levels of loading/ unloading activities |
Contractor |
Mucking out locations |
Construction stage |
· Annex 5, TM-EIAO |
N/A |
|
S5.4.1 |
N6 |
Sequencing operation of construction plants where practicable. |
Operate sequentially within the same work site to reduce the construction airborne noise |
Contractor |
All construction sites where practicable |
Construction stage |
· Annex 5, TM-EIAO |
N/A |
|
S5.4.1 |
N7 |
Implement a noise monitoring programme under EM&A programme. |
Monitor the construction noise levels at the selected representative locations |
Contractor |
Selected rep. noise monitoring station |
Construction stage |
· TM-EIAO |
Implemented |
|
Water Quality (Construction Phase) |
|||||||||
S6.9.1.1 |
W1 |
In accordance with the Practice Note for Professional Persons on Construction Site Drainage, Environmental Protection Department, 2023 (ProPECC PN 2/23), construction phase mitigation measures shall include the following:
Construction Runoff · At the start of site establishment, perimeter cut-off drains to direct off-site water around the site should be constructed with internal drainage works and erosion and sedimentation control facilities implemented. Channels (both temporary and permanent drainage pipes and culverts), earth bunds or sandbag barriers should be provided on site to direct stormwater to silt removal facilities. The design of the temporary on-site drainage system will be undertaken by the contractor prior to the commencement of construction; · The dikes or embankments for flood protection should be implemented around the boundaries of earthwork areas. Temporary ditches should be provided to facilitate the runoff discharge into an appropriate watercourse, through a silt/ sediment trap. The sediment/ silt traps should be incorporated in the permanent drainage channels to enhance deposition rates; · The design of efficient silt removal facilities should be based on the guidelines in Appendix A1 of ProPECC PN 2/23, which states that the retention time for silt/ sand traps should be 5 minutes under maximum flow conditions. Sizes may vary depending upon the flow rate, but for a flow rate of 0.1 m3/s a sedimentation basin of 30 m3 would be required and for a flow rate of 0.5 m3/s the basin would be 150 m3. The detailed design of the sand/ silt traps shall be undertaken by the contractor prior to the commencement of construction; · All exposed earth areas should be completed and vegetated as soon as possible after earthworks have been completed, or alternatively, within 14 days of the cessation of earthworks where practicable. Exposed slope surfaces should be covered by tarpaulin or other means; · The overall slope of the site should be kept to a minimum to reduce the erosive potential of surface water flows, and all traffic areas and access roads protected by coarse stone ballast. An additional advantage accruing from the use of crushed stone is the positive traction gained during prolonged periods of inclement weather and the reduction of surface sheet flows; · All drainage facilities and erosion and sediment control structures should be regularly inspected and maintained to ensure proper and efficient operation at all times and particularly following rainstorms. Deposited silt and grit should be removed regularly and disposed of by spreading evenly over stable, vegetated areas; · Measures should be taken to minimize the ingress of site drainage into excavations. If the excavation of trenches in wet periods is necessary, they should be dug and backfilled in short sections wherever practicable. Water pumped out from trenches or foundation excavations should be discharged into storm drains via silt removal facilities; · Open stockpiles of construction materials (for example, aggregates, sand and fill material) of more than 50m3 should be covered with tarpaulin or similar fabric during rainstorms. Measures should be taken to prevent the washing away of construction materials, soil, silt or debris into any drainage system; · Manholes should always be adequately covered and temporarily sealed so as to prevent silt, construction materials or debris being washed into the drainage system and storm runoff being directed into foul sewers; · Precautions be taken at any time of year when rainstorms are likely, actions to be taken when a rainstorm is imminent or forecasted, and actions to be taken during or after rainstorms are summarized in Appendix A2 of ProPECC PN 2/23. Particular attention should be paid to the control of silty surface runoff during storm events, especially for areas located near steep slopes; · All vehicles and plant should be cleaned before leaving a construction site to ensure no earth, mud, debris and the like is deposited by them on roads. An adequately designed and site wheel washing facilities should be provided at every construction site exit where practicable. Wash-water should have sand and silt settled out and removed at least on a weekly basis to ensure the continued efficiency of the process. The section of access road leading to, and exiting from, the wheel wash bay to the public road should be paved with sufficient backfall toward the wheel wash bay to prevent vehicle tracking of soil and silty water to public roads and drains; · Oil interceptors should be provided in the drainage system downstream of any oil/ fuel pollution sources. The oil interceptors should be emptied and cleaned regularly to prevent the release of oil and grease into the storm water drainage system after accidental spillage. A bypass should be provided for the oil interceptors to prevent flushing during heavy rain; · Construction solid waste, debris and rubbish on site should be collected, handled and disposed of properly to avoid water quality impacts; · All fuel tanks and storage areas should be provided with locks and sited on sealed areas, within bunds of a capacity equal to 110% of the storage capacity of the largest tank to prevent spilled fuel oils from reaching water sensitive receivers nearby; · Adopt best management practices; · All earth works should be conducted sequentially to limit the amount of construction runoff generated from exposed areas during the wet season (April to September) as far as practicable. |
To minimize water quality impact from the construction site runoff and general construction activities |
Contractor |
All construction sites where practicable |
Construction stage |
· Water Pollution Control Ordinance · ProPECC PN 2/23 · TM-EIAO · TM-DSS |
Implemented for the 1st, 3rd, 6th, 8th, 9th, 13th, 15th bullets
N/A for other bullets
|
|
S6.9.1.2 |
W2 |
Tunnelling Works and Underground Works
· Cut-&-cover tunnelling work should be conducted sequentially to limit the amount of construction runoff generated from exposed areas during the wet season (April to September) as far as practicable. · Uncontaminated discharge should pass through sedimentation tanks prior to off-site discharge; · The wastewater with a high concentration of SS should be treated (e.g. by sedimentation tanks with sufficient retention time) before discharge. Oil interceptors would also be required to remove oil, lubricants and grease from the wastewater; · Direct discharge of the bentonite slurry (as a result of D-wall) is not allowed. It should be reconditioned and reused wherever practicable. Temporary storage locations (typically a properly closed warehouse) should be provided on site for any unused bentonite that needs to be transported away after all the related construction activities area completed. The requirements in ProPECC PN 2/23 should be adhered to in the handling and disposal of bentonite slurries. |
To minimize construction water quality impact from tunnelling works |
Contractor |
All tunnelling portion |
Construction stage |
· Water Pollution Control Ordinance · ProPECC PN 2/23 · TM-DSS · TM-EIAO |
N/A |
|
S6.9.1.3 |
W3 |
Sewage Effluent
· Portable chemical toilets and sewage holding tanks are recommended for handling the construction sewage generated by the workforce. A licensed contractor should be employed to provide appropriate and adequate portable toilets and be responsible for appropriate disposal and maintenance. |
To minimize water quality from sewage effluent |
Contractor |
All construction sites where practicable |
Construction stage |
· Water Pollution Control Ordinance · TM-DSS |
Implemented |
|
S6.9.1.5 |
W4 |
Groundwater from Potential Contaminated Area:
· No direct discharge of groundwater from contaminated areas should be adopted. · A discharge license under the WPCO through the Regional Office of EPD for groundwater discharge should be applied. Prior to the excavation works within these potentially contaminated areas, the groundwater quality should be reviewed during the process of discharge license application. The compliance to the Technical Memorandum on Standards for Effluents Discharged into Drainage on Sewerage Systems, Inland and Coastal Waters (TM-DSS) and the existence of prohibited substance should be confirmed. If the review results indicated that the groundwater to be generated from the excavation works would be contaminated, the contaminated groundwater should be either properly treated in compliance with the requirements of the TM-DSS or properly recharged into the ground. · If wastewater treatment is deployed, the wastewater treatment unit shall deploy suitable treatment process (e.g. oil interceptor / activated carbon) to reduce the pollution level to an acceptable standard and remove any prohibited substances (e.g. TPH) to undetectable range. All treated effluent from wastewater treatment plant shall meet the requirements as stated in TM-DSS and should be discharged into the foul sewers. · If groundwater recharging wells are deployed, recharging wells should be installed as appropriate for recharging the contaminated groundwater back into the ground. The recharging wells should be selected at places where the groundwater quality will not be affected by the recharge operation as indicated in the Section 2.3 of TM-DSS. The baseline groundwater quality shall be determined prior to the selection of the recharge wells, and submit a working plan (including the laboratory analytical results showing the quality of groundwater at the proposed recharge location(s) as well as the pollutant levels of groundwater to be recharged) to EPD for agreement. Pollution levels of groundwater to be recharged shall not be higher than pollutant levels of ambient groundwater at the recharge well. Prior to recharge, any prohibited substances such as TPH products should be removed as necessary by installing the petrol interceptor. |
To minimize groundwater quality impact from contaminated area |
Contractor |
Excavation areas where contamination is found |
Construction stage |
· Water Pollution Control Ordinance · TM-DSS · TM-EIAO |
N/A |
|
S6.9.1.6 |
W6 |
Accidental Spillage
In order to prevent accidental spillage of chemicals, the following is recommended: · All the tanks, containers, storage area should be bunded and the locations should be locked as far as possible from the sensitive watercourse and stormwater drains; · The Contractor should register as a chemical waste producer if chemical wastes would be generated. Storage of chemical waste arising from the construction activities should be stored with suitable labels and warnings. Disposal of chemical wastes should be conducted in compliance with the requirements as stated in the Waste Disposal (Chemical Waste) (General) Regulation. |
To minimize water quality impact from accidental spillage |
Contractor |
All construction site where practicable |
Construction stage |
· Water Pollution Control Ordinance · ProPECC PN 2/23 · TM-EIAO · TM-DSS |
Implemented |
|
Waste Management (Construction Waste) |
|||||||||
S7.4.1 |
WM1 |
On-site sorting of C&D material
· Geological assessment should be carried out by competent persons on site during excavation to identify materials which are not suitable to use as aggregate in structural concrete (e.g. volcanic rock, Aplite dyke rock, etc.). Volcanic rock and Aplite dyke rock should be separated at the source sites as far as practicable and stored at designated stockpile area preventing them from delivering to crushing facilities. The crushing plant operator should also be reminded to set up measures to prevent unsuitable rock from ending up at concrete batching plants and be turned into concrete for structural use. Details regarding control measures at source site and crushing facilities should be submitted by the Contractor for the Engineer to review and agree. In addition, site records should also be kept for the types of rock materials excavated and the traceability of delivery will be ensured with the implementation of Trip Ticket System and enforced by site supervisory staff as stipulated under DEVB TC(W) No. 6/2010 for tracking of the correct delivery to the rock crushing facilities for processing into aggregates. Alternative disposal option for the reuse of volcanic rock and Aplite Dyke rock, etc. should be explored. |
Separation of unsuitable rock from ending up at concrete batching plants and be turned into concrete for structural use |
Contractor |
All construction sites |
Construction stage |
· DEVB (W) No. 6/2010 |
N/A |
|
S7.5.1 |
WM2 |
Construction and Demolition Material · Maintain temporary stockpiles and reuse excavated fill material for backfilling and reinstatement; · Carry out on-site sorting; · Make provisions in the Contract documents to allow and promote the use of recycled aggregates where appropriate; · Adopt ‘selective demolition’ technique to demolish the existing structures and facilities with a view to recovering broken concrete effectively for recycling purpose, where possible; · Implement a trip-ticket system for each works contract to ensure that the disposal of C&D materials is properly documented and verified; and · Implement an enhanced Waste Management Plan similar to ETWBTC (Works) No. 19/2005 – “Environmental Management on Construction Sites” to encourage on-site sorting of C&D materials and to minimize their generation during the course of construction. |
Good site practice to minimize the waste generation and recycle the C&D materials as far as practicable so as to reduce the amount for final disposal |
Contractor |
All construction sites |
Construction stage |
· Land (Miscellaneous Provisions) Ordinance · Waste Disposal Ordinance · ETWB TCW No. 19/2005 |
Implemented for the 1st, 2nd, 5th, 6th bullets
N/A for other bullets
|
|
S7.5.1 |
WM3 |
C&D Waste · Standard formwork or pre-fabrication should be used as far as practicable in order to minimize the arising of C&D materials. The use of more durable formwork or plastic facing for the construction works should be considered. Use of wooden hoardings should not be used, as in other projects. Metal hoarding should be used to enhance the possibility of recycling. The purchasing of construction materials will be carefully planned in order to avoid over ordering and wastage; · The Contractor should recycle as much of the C&D materials as possible on-site. Public fill and C&D waste should be segregated and stored in different containers or skips to enhance reuse or recycling of materials and their proper disposal. Where practicable, concrete and masonry can be crushed and used as fill. Steel reinforcement bar can be used by scrap steel mills. Different areas of the sites should be considered for such segregation and storage. |
Good site practice to minimize the waste generation and recycle the C&D materials as far as practicable so as to reduce the amount for final disposal |
Contractor |
All construction sites |
Construction stage |
· Land (Miscellaneous Provisions) Ordinance · Waste Disposal Ordinance · ETWB TCW No. 19/2005 |
N/A |
|
S7.5.1 |
WM4 |
Excavated Contaminated Soils · Details of the mitigation measures on handling of the contaminated soil shall be referred to Section on Land Contamination below. |
The contaminated soil will be excavated for on-site reuse |
Contractor |
PBH4 |
Prior to commencement of construction works within the contaminated area |
· Practice Guide (PG) for Investigation and Remediation of Contaminated Land · GN/GM for land contamination |
N/A |
|
S7.5.1 |
WM5 |
Land-based Sediment · All construction plant and equipment shall be designed and maintained to minimize the risk of silt, sediments, contaminants or other pollutants being released into the water column or deposited in the locations other than designated location; · All vessels shall be sized such that adequate draft is maintained between vessels and the sea bed at all states of the tide to ensure that undue turbidity is not generated by turbulence from vessel movement or propeller wash; · Before moving the vessels which are used for transporting dredged material, excess material shall be cleaned from the decks and exposed fittings of vessels and the excess materials shall never be dumped into the sea except at the approved locations; · Adequate freeboard shall be maintained on barges to ensure that decks are not washed by wave action. · The Contractors shall monitor all vessels transporting material to ensure that no dumping outside the approved location takes place. The Contractor shall keep and produce logs and other records to demonstrate compliance and that journeys are consistent with designated locations and copies of such records shall be submitted to the engineers; · The Contractors shall comply with the conditions in the dumping license. · All bottom dumping vessels (Hopper barges) shall be fitted with tight fittings seals to their bottom openings to prevent leakage of material; · The material shall be placed into the disposal pit by bottom dumping; · Contaminated marine mud shall be transported by spit barge of not less than 750m3 capacity and capable of rapid opening and discharge at the disposal site; · Discharge shall be undertaken rapidly, and the hoppers shall be closed immediately. Material adhering to the sides of the hopper shall not be washed out of the hopper and the hopper shall remain closed until the barge returns to the disposal site. · For Type 3 special disposal treatment, sealing of contaminant with geosynthetic containment before dropping designated mud pit would be a possible arrangement. A geosynthetic containment method is a method whereby the sediments are sealed in geosynthetic containers and, the containers would be dropped into the designated contaminated mud pit where they would be covered by further mud disposal and later by the mud pit capping at the disposal site, thereby fulfilling the requirements for fully confined mud disposal. |
To control pollution due to marine sediment |
Contractor |
Along CKR alignment |
Construction stage |
· ETWB TCW No. 34/2002 |
N/A |
|
S7.5.1 |
WM6 |
Chemical Waste · Chemical waste that is produced, as defined by Schedule 1 of the Waste Disposal (Chemical Waste) (General) Regulation, should be handled in accordance with the Code of Practice on the Packaging, Labelling and Storage of Chemical Wastes; · Containers used for the storage of chemical wastes should be suitable for the substance they are holding, resistant to corrosion, maintained in a good condition, and securely closed, have a capacity of less than 450 L unless the specification has been approved by EPD, and display a label in English and Chinese in accordance with instructions prescribed in Schedule 2 of the regulation; · The storage area for chemical wastes should be clearly labelled and used solely for the storage of chemical waste, enclosed on at least 3 sides, have an impermeable floor and bunding of sufficient capacity to accommodate 110% of the volume of the largest container or 20% of the total volume of waste stored in that area, whichever is the greatest, have adequate ventilation, covered to prevent rainfall entering, and arranged so that incompatible materials are adequately separated; · Disposal of chemical waste should be via a licensed waste collector, be to a facility licensed to receive chemical waste, such as the Chemical Waste Treatment Centre which also offers a chemical waste collection service and can supply the necessary storage containers, or be to a reuser of the waste, under approval from EPD. |
Control the chemical waste and ensure proper storage, handling and disposal |
Contractor |
All construction sites |
Construction stage |
· Waste Disposal (Chemical Waste) (General) Regulation · Code of Practice on the Packaging, Labelling and Storage of Chemical Waste |
Implemented for the 2nd, 3rd bullets.
N/A for other bullet.
|
|
S7.5.1 |
WM7 |
General Refuse · General refuse generated on-site should be stored in enclosed bins or compaction units separately from construction and chemical wastes; · A reputable waste collector should be employed by the Contractor to remove general refuse from the site, separately from construction and chemical wastes, on a daily basis to minimize odour, pest and litter impacts. Burning of refuse on construction sites is prohibited by law. · Aluminium cans are often recovered from the waste stream by individual collectors if they are segregated and made easily accessible. Separate labelled bins for their deposit should be provided if feasible; · Office wastes can be reduced through the recycling of paper if volumes are large enough to warrant collection. Participation in a local collection scheme should be considered by the Contractor. |
Minimize production of the general refuse and avoid odour, pest and litter impacts |
Contractor |
All construction sites |
Construction stage |
· Waste Disposal Ordinance |
Implemented for the 1st bullet.
N/A for other bullets
|
|
Hazard to Life |
|||||||||
H8 |
The driver and his assistant should be physically healthy, experienced and have good safe driving records. The driver should hold a proper driving licence for the approved transport truck. Dedicated training programme and regular road safety briefing sessions/ workshops should be provided to enhance their safe driving attitude and practice. Smoking should be strictly prohibited. |
To reduce the risk during explosives transport |
Contractor |
Works areas at which explosives would be used |
Construction stage |
- |
N/A |
||
S9.18 |
H9 |
Emergency response plans in case of road accident should be prepared and implemented. The driver and his assistant should be familiar with the emergency procedures including evacuation, and proper communication/ fire-fighting equipment should be provided to the driver and his assistant. |
To reduce the risk during explosives transport |
Contractor |
Works areas at which explosives would be used |
Construction stage |
- |
N/A |
|
Landscape & Visual |
|||||||||
S10.10.1 Table 10.11 |
LV3 |
Good Site Management · Large temporary stockpiles of excavated material shall be covered with unobtrusive sheeting to prevent dust and dirt spreading to adjacent landscape areas and vegetation, and to create a neat and tidy visual appearance. · Construction plant and building material shall be orderly and carefully stored in order to create a neat and tidy visual appearance. |
Minimize visual impact |
Contractor |
Within Project site |
Construction stage |
- |
Implemented for the 2nd bullet
N/A for other bullet |
|
LV4 |
Screen Hoarding · Decorative screen hoarding should be erected to screen the public from the construction area. It should be designed to be compatible with the existing urban context. |
Minimize visual impact |
Contractor |
Within Project site |
Construction stage |
- |
N/A |
||
S10.10.1 Table 10.11 |
LV5 |
Lighting Control during Construction · All lighting in the construction site shall be carefully controlled to minimize light pollution and night-time glare to nearby residencies and GIC. The Contractor shall consider other security measures, which shall minimize the visual impacts. |
Minimize visual impact |
Contractor |
Within Project site |
Construction stage |
- |
N/A |
|
S10.10.1 Table 10.11 |
LV6 |
Erosion Control · The potential for soil erosion shall be reduced by minimizing the extent of vegetation disturbance on site and by providing a protective cover over newly exposed soil. |
Minimize landscape impact |
Contractor |
Within Project site |
Construction stage |
- |
N/A |
|
S10.10.1 Table 10.11 |
LV7 |
Tree Protection & Preservation · Carefully protected during construction. Tree protection measures will be detailed at the Tree Removal Application stage and plans submitted to the relevant Government Department for approval in due course in accordance with ETWB TC No. 3/2006. |
Minimize landscape and visual impact |
Contractor |
Within Project site |
Construction stage |
· ‘Guidelines for Tree Risk Management and Assessment Arrangement on an Area Basis and on a Tree Basis’, Greening, Landscape and Tree Management (GLTM) Section, DEVB · Latest recommended horticultural practices from GLTM Section, DEVB |
N/A |
|
S10.10.1 Table 10.11 |
LV8 |
Tree Transplantation · For trees unavoidably affected by the Project that have to be removed, where practical transplantation will be chosen as the top priority method of removal. If this is not possible or practical compensatory planting will be provided for trees unavoidably felled (See LV10). For trees unavoidably affected by the Project works that are transplanted, transplantation must be carried out in accordance with ETWB TCW 2/2004 and 3/2006. |
Minimize landscape and visual impact |
Contractor |
Within Project site and designated off-site locations |
Prior to Construction stage |
· ETWB TCW 3/2006 · Latest recommended horticultural practices from Greening, Landscape and Tree Management (GLTM) Section, DEVB · ETWB TCW 2/2004 |
N/A |
|
S10.10.1 Table 10.11 |
LV9 |
Compensatory Planting · For trees unavoidably affected by the Project that have to be removed, where practical transportation will be chosen as the top priority method of removal but if this is not possible or practical compensatory planting will be provided for trees unavoidably felled. All felled trees shall be compensated for by planting trees to the satisfaction of relevant Government projects. Required numbers and locations of compensatory trees shall be determined and agreed separately with Government during the Tree Felling Application process under ETWB TC 3/2006. · Compensatory tree planting may be incorporated into public open spaces and along roadside amenity areas affected by the construction works and therefore be part of the bigger wider planting plans. Onsite compensation planting is preferred but, if necessary, additional receptor sites outside the Works Area shall be agreed separately with the Government during the Tree Felling Application process. |
Minimize visual impact and also enhance landscape |
Contractor |
Within Project site |
Construction stage |
· ETWB TCW 3/2006 · Latest recommended horticultural practices from Greening, Landscape and Tree Management (GLTM) Section, DEVB · ETWB TCW 2/2004 |
N/A |
|
S10.10.1 Table 10.11 |
LV10 |
Screen Planting · Tall screen/buffer trees, shrubs and climbers should be planted, in so far as is possible, to soften and screen proposed structures such as roads and central strip, vertical edges and buildings and to enhance streetscape greening effect where appropriate. Indiscriminate use of trees for screening must be avoided and the principle of ‘right tree for the right place’ must be followed. This detail will be provided at the Detailed Design stage. This measure may additionally form part of the compensatory planting and will improve and create a pleasant pedestrian environment. |
Minimize visual impact and also enhance landscape. |
Contractor |
Within Project Site |
Construction Phase |
· Guidelines on Greening of Noise Barriers, issued April 2012, GLTMS, DevB · ETWB TCW 2/2004 |
N/A |
|
S10.10.1 Table 10.11 |
LV12 |
Reinstatement · All works areas, excavated areas and disturbed areas for tunnel construction and temporary road diversion or any other proposed works shall be reinstated to former conditions or better, with reasonable landscape treatment and to the satisfaction of the relevant Government departments. (Specific mitigation for disturbance to public open space is detailed separately under LV14.) |
Minimize landscape impact |
Contractor |
Within Project Site |
Construction Phase |
· N/A |
N/A |
|
Cultural Heritage Impact (Construction Phase) |
|||||||||
S11.4.4 |
CH1 |
The contractor should be alerted during the construction on the possibility of locating archaeological remains and as a precautionary measure, AMO shall be informed immediately in case of discovery of antiquities or supposed antiquities in the subject sites. |
To preserve any cultural heritage items which may be removed and damaged by the excavation |
Contractor |
During construction works for cut and cover tunnels |
Construction stage |
· AMOs requirements |
N/A |
|
EM&A Project |
|||||||||
S13.2 |
EM1 |
An Independent Environmental Checker needs to be employed as per the EM&A Manual |
Control EM&A Performance |
Highways Department |
All construction sites |
Construction stage |
· EIAO Guidance Note No. 4/2010 · TM-EIAO |
Implemented |
|
S13.2-13.4 |
EM2 |
· An Environmental Team needs to be employed as per the EM&A Manual; · Prepare a systematic Environmental Management Plan to ensure effective implementation of the mitigation measures; · An environmental impact monitoring needs to be implemented by the Environmental Team to ensure all the requirements given in the EM&A Manual are fully complied with. |
Perform environmental monitoring & auditing |
Highways Department/ Contractor |
All construction sites |
Construction stage |
· EIAO Guidance Note No. 4/2010 · TM-EIAO |
Implemented |
|
Appendix G
Waste Flow Table
Appendix H
Statistics on Complaint, Notifications of Summons and Successful Prosecution
Statistical Summary of Environmental Complaints
Reporting Period |
Environmental Complaint Statistics |
||
Frequency |
Cumulative |
Complaint Nature |
|
1 February 2025 - 28 February 2025 |
0 |
0 |
N/A |
Statistical Summary of Environmental Non-compliance
Reporting Period |
Environmental Non-compliance Statistics |
||
Frequency |
Cumulative |
Details |
|
1 February 2025 - 28 February 2025 |
0 |
0 |
N/A |
Statistical Summary of Environmental Summons
Reporting Period |
Environmental Summons Statistics |
||
Frequency |
Cumulative |
Details |
|
1 February 2025 - 28 February 2025 |
0 |
0 |
N/A |
Statistical Summary of Environmental Prosecution
Reporting Period |
Environmental Prosecution Statistics |
||
Frequency |
Cumulative |
Details |
|
1 February 2025 - 28 February 2025 |
0 |
0 |
N/A |
