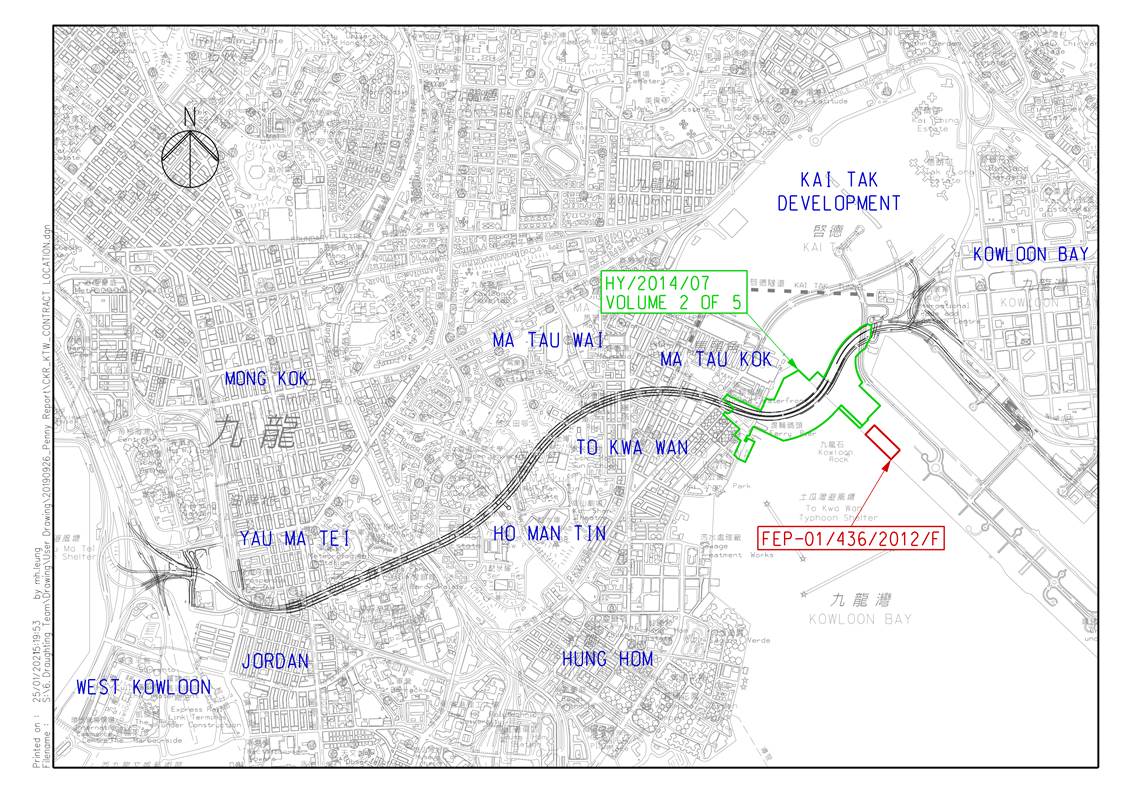

Facility under FEP-01/436/2012/F Monthly EM&A Report for September 2021 |
|
|
|
Central Kowloon Route – Kai Tak West (CKR-KTW; Contract No.
HY/2014/07) (hereafter called “the Project”) covers part of the construction of
the Central Kowloon Route (CKR).
The Project comprises
the follow works:
·
50x30m access shaft with noise enclosure
at Ma Tau Kok (MTK);
·
100m long cut-and-cover (C&C) tunnel
at MTK;
·
Demolition and re-provisioning of MTK Public
Pier;
·
160m long underwater tunnel (UWT) (Stage 1);
·
210m long UWT (Stage 2);
·
60m long C&C tunnel at Kai Tak;
·
130m long depressed road and 200m long
underpass at Kai Tak;
·
390m long underground tunnel ventilation adit at Kai Tak;
·
Seawall demolition and construction of new
landing steps; and
·
Barging Point enclosure and conveyor
system.
The EM&A programme commenced on 4 April 2018.The impact EM&A for the Project includes air
quality and noise monitoring.
This is the 42nd
monthly EM&A Report presenting the EM&A works carried out during the
period between 1 and 30 September 2021. As informed by the Contractor, major activities
in the reporting period were:
Locations |
Site Activities |
Kai Tak |
·
Wall and roof slab construction at cut & cover, underpass and
depressed road; ·
Backfilling and removal of ELS at Underpass and depressed road; ·
Waterproof works at depressed road; ·
Drainage construction at cut & cover; ·
Dismantle of working platform" |
Ma Tau Kok |
·
TTM implementation; ·
Trial trench for piling works; ·
Pre-grouting works for pipe piling works for MTK C&C Tunnel; ·
Pipe pilling works for MTK C&C tunnel |
Kowloon Bay |
·
Seawall Reinstatement at Stage 1 UWT; ·
Construction of remaining bulkhead wall at Stage 1 UWT; ·
Pipe pile removal at Stage 1 UWT; ·
Stage 1 Marine Platform Removal for Stage 2 UWT; ·
Piling Works for Stage 2 UWT; ·
Erect Marine Platform for Stage 2 UWT; ·
Marine King Post and Access Platform Construction. |
|
Breaches
of Action and Limit Levels for Air Quality
All
24-hour TSP result was below the Action and Limit Levels at all monitoring locations
in the reporting month.
All
1-hour TSP result was below the Action and Limit Levels at all monitoring locations
in the reporting month.
Breaches
of Action and Limit Levels for Noise
Two
(2) noise-related complaints were received in the reporting month. Based on the
investigation results from finalized investigation reports, it was concluded that:
(i) Proper implementation of noise mitigation
measures was implemented by the Contractor at Ma Tau Kok
to comply with the requirement of the approved Construction Noise Mitigation
Measures Plan such as acoustic sheet barrier on the specific Powered Mechanical
Equipment, and Quality PME were used to conduct the construction works.
(ii)
The
percussive piling method, pile type and time conducted were complied with the
CNP (No.: PP-RE0027-21) at the Stage 2
Underwater Tunnel.
(iii)
Based
on the monitoring results on September 2021, all readings were recorded under
the criteria stipulated in EIAO-TM.
Regular Noise Monitoring
No exceedance of Limit level of noise was
recorded in the reporting month.
Complaint,
Notification of Summons and Successful Prosecution
Three (3) environmental related complaints
were received in the reporting month as follows:
Date received |
Complaint No. |
Parameter |
Status |
18
September 2021 (Referred by the Gammon Construction Limited on 20 September 2021) |
EC-041-CKRKTW20210918_01_C084 |
Noise, Air (Dust) and Air (Odor) |
Closed |
17&18
September 2021 (Referred by Gammon Construction Limited on 21 September 2021) |
EC-042- KRKTW20210917_01_C083 |
Noise |
Closed |
29 September 2021 (Referred by Gammon Construction Limited on 5 October 2021) |
EC-043-CKRKTW20210614_01_C085 (EPD ref.: K10/RE/00023313-21) |
Water |
Under investigation and will be provided in
subsequent Monthly EM&A Report |
No notification of summons
and successful prosecution were received in the reporting month.
Reporting
Changes
No report changes in the reporting period.
Future
Key Issues
Key issues to be considered
in the next three months included:
Locations |
Site Activities |
Kai Tak |
- Wall and roof slab
construction at cut & cover and underpass; |
Ma Tau Kok |
- TTM implementation; |
Kowloon Bay |
- Seawall Reinstatement at
Stage 1 UWT; |
|
· Section 1: Introduction
· Section 2: Project Information
· Section 3: Environmental Monitoring Requirement
· Section 4: Implementation Status of Environmental Mitigation Measures
· Section 5: Monitoring Results
· Section 6: Environmental Site Inspection and Audit
· Section 7: Environmental Non-conformance
· Section 8: Future Key Issues
· Section 9: Conclusions and Recommendations
(a)
construction of approximately 160m long
cut-and-cover tunnel and 370m long underwater tunnel between the tunnel section
at Ma Tau Kok and the depressed road of the CKR
within Kai Tak Development;
(b)
reconstruction of the seawall at Ma Tau
Kok public pier, and the sloping seawall at the
Former Kai Tak Airport Runway;
(c)
construction of approximately 125m long
depressed road and 200m long underpass of the CKR within Kai Tak Development;
(d)
construction of approximately 360m long
underground tunnel ventilation adit of the CKR;
(e)
reconstruction of Kowloon City Ferry
Pier Public Transport Interchange; and
(f)
other associated works.
Table 2.1 Construction Activities in the reporting month
Locations |
Site Activities |
Kai
Tak |
·
Wall and roof slab construction at cut & cover, underpass and
depressed road; ·
Backfilling and removal of ELS at Underpass and depressed road; ·
Waterproof works at depressed road; ·
Drainage construction at cut & cover; ·
Dismantle of working platform |
Ma
Tau Kok |
·
TTM implementation; ·
Trial trench for piling works; ·
Pre-grouting works for pipe piling works for MTK C&C Tunnel; ·
Pipe pilling works for MTK C&C tunnel |
Kowloon
Bay |
·
Seawall Reinstatement at Stage 1 UWT; ·
Construction of remaining bulkhead wall at Stage 1 UWT; ·
Pipe pile removal at Stage 1 UWT; ·
Stage 1 Marine Platform Removal for Stage 2 UWT; ·
Piling Works for Stage 2 UWT; ·
Erect Marine Platform for Stage 2 UWT; ·
Marine King Post and Access Platform Construction. |
|
Table 2.2 Contact Information of Key Personnel
Party |
Role |
Position |
Name |
Telephone |
Fax |
Arup-Mott
MacDonald Joint Venture |
Residential
Engineer (ER) |
Engineer’s Representative |
Mr. Jeffrey
Lau |
2268 3640 |
2268 3954 |
ERM |
Independent
Environmental Checker (IEC) |
Independent
Environmental Checker |
Ms. Mandy To |
2271 3313 |
2723 5660 |
Gammon |
Contractor |
Contracts Manager |
Mr. Alan Yan |
2516 8823 |
2516 6260 |
Environmental Manager |
Ms Michelle Tang |
9267 8866 |
2516 6260 |
||
AECOM |
Contractor’s Environmental
Team (ET) |
ET Leader |
Mr. Y T Tang |
3922 9393 |
2317 7609 |
Table 2.3 Status of Environmental Licenses, Notifications and Permits
Permit / License No. / Notification/
Reference No. |
Valid Period |
Status |
Remarks |
|
From |
To |
|||
Further Environmental Permit |
||||
FEP-01/457/2013/C |
28 Feb 2018 |
End of Project |
Valid |
-- |
Wastewater Discharge License |
||||
WT00030290-2018 |
22 Mar 2018 |
31 May 2023 |
Valid |
Ma Tau Kok |
WT00030668-2018 |
27 Apr 2018 |
30 Apr 2023 |
Valid |
Site Office at Kai Tak West |
WT00030358-2018 |
27 Apr 2018 |
30 Apr 2023 |
Valid |
Kai Tak West |
WT00030330-2018 |
27 Apr 2018 |
30 Apr 2023 |
Valid |
Kowloon Bay |
Construction Noise Permit |
||||
GW-RE0732-21 |
3 Aug 2021 |
2-Feb-2022 |
Valid |
General Works at Ma Tau Kok |
GW-RE0658-21 |
11 Jul 2021 |
10 Jan 2022 |
Valid |
General Works at Kai Tak |
GW-RE0474-21 |
21 May 2021 |
20 Nov 2021 |
Valid |
ELS Removal at Stage 1 UWT |
PP-RE0027-21 |
2 Aug 2021 |
31 Jan 2022 |
Valid |
Percussive Piling at Stage 2 Underwater Tunnel |
GW-RE0259-21 |
1 Apr 2021 |
30 Sep 2021 |
Valid until 30
Sep 2021 |
Kai Tak Haul Road |
Chemical
Waste Producer Registration |
||||
5118-247-G2347-47 |
30 Jan 2018 |
End of Project |
Valid |
-- |
5118-247-G2347-48 |
30 Jan 2018 |
End of Project |
Valid |
-- |
Marine Dumping Permit |
||||
-- |
-- |
-- |
-- |
-- |
Billing Account for Construction
Waste Disposal |
||||
7029909 |
22 Jan 2018 |
End of Project |
Account Active |
-- |
7031949 |
27 Aug 2021 |
25 Nov 2021 |
Account Active |
Billing Account for Disposal of
Construction Waste (by vessels) |
Notification Under Air Pollution Control
(Construction Dust) Regulation |
||||
429442 |
5 Jan 2018 |
5 Jul 2025 |
Notified |
-- |
|
Monitoring Requirements
Monitoring Equipment
Table 3.1 Air Quality Monitoring Equipment
Tisch
Total Suspended Particulate Mass Flow Controlled High Volume Air Sampler |
|
Calibration
Kit (24-hour
TSP) |
TISCH
Environmental Orifice |
Portable
direct reading dust meter |
Sibata Digital Dust Monitor |
Monitoring Locations
Table 3.2 Location of Construction Dust Monitoring Station
Location |
Monitoring Station |
Description |
E-A14a
[1] |
Block
B of Merit Industrial Centre |
Rooftop
(13/F) |
[1] The air monitoring station proposed in the
EM&A Manual (i.e. Wyler Gardens with ID: E-A14) was
not available for impact dust monitoring, therefore impact monitoring was conducted
at E-A14a as an alternative which was agreed by the ER, IEC and EPD.
Monitoring
Methodology
(a)
The HVS was
installed in the vicinity of the air sensitive receivers. The following criteria were considered in the
installation of the HVS as far
as practicable: -
(i)
A horizontal platform with appropriate
support to secure the sampler against gusty wind was provided.
(ii)
Two samplers should not
be placed less than 2m apart from each other;
(iii)
The distance between the HVS and any
obstacles, such as buildings, was at least twice the height that the obstacle
protrudes above the HVS.
(iv)
A minimum of 2 meters separation from
walls, parapets and penthouse for rooftop sampler.
(v)
A minimum of 2 meters separation
from any supporting structure, measured horizontally is required.
(vi)
No furnace or incinerator flues
nearby.
(vii)
Airflow around the sampler was
unrestricted.
(viii)
The sampler was located more than
20 meters from any dripline.
(ix)
Any wire fence and gate, required
to protect the sampler, did not obstruct the monitoring process.
(x)
Permission was obtained to set up
the samplers and access to the monitoring station.
(xi)
A secured supply of electricity
was obtained to operate the sampler.
(b)
Preparation of Filter
Papers
(i)
Glass fibre filters, G810 were
labelled and sufficient filters that were clean and without pinholes were selected.
(ii)
All filters were equilibrated in
the conditioning environment for 24 hours before weighing. The conditioning environment
temperature was around 25 °C and not variable by more than ±3 °C; the relative
humidity (RH) was < 50% and not variable by more than ±5%. A convenient
working RH was 40%.
(iii)
All filter papers were prepared
and analysed by ALS Technichem
(HK) Pty Ltd., which is a HOKLAS accredited laboratory and has comprehensive quality assurance and quality control programmes.
(c)
Field Monitoring
(i)
The power supply was checked to ensure the HVS works properly.
(ii)
The filter holder and the area surrounding
the filter were cleaned.
(iii)
The filter holder was removed by
loosening the four bolts and a new filter, with stamped number upward, on a
supporting screen was aligned carefully.
(iv)
The filter was properly aligned
on the screen so that the gasket formed an airtight seal on the outer edges of
the filter.
(v)
The swing bolts were fastened to
hold the filter holder down to the frame.
The pressure applied was sufficient to avoid air leakage at the edges.
(vi)
Then the shelter lid was closed and
was secured with the aluminium strip.
(vii)
The HVS was warmed-up for about 5
minutes to establish run-temperature conditions.
(viii)
A new flow rate record sheet was
set into the flow recorder.
(ix)
On site temperature and
atmospheric pressure readings were taken and the flow rate of the HVS was checked
and adjusted at around 1.3 m3/min, and complied with the range specified
in the EM&A Manual (i.e. 0.6-1.7 m3/min).
(x)
The programmable digital timer
was set for a sampling period of 24 hrs, and the starting time, weather condition
and the filter number were recorded.
(xi)
The initial elapsed time was
recorded.
(xii)
At the end of sampling, on site
temperature and atmospheric pressure readings were taken and the final flow rate
of the HVS was checked and recorded.
(xiii)
The final elapsed time was recorded.
(xiv)
The sampled filter was removed carefully
and folded in half length so that only surfaces with
collected particulate matter were in contact.
(xv)
It was then placed in a clean envelope
and sealed.
(xvi)
All monitoring information was recorded
on a standard data sheet.
(xvii) Filters were then sent to ALS Technichem (HK) Pty Ltd. for analysis.
(d)
Maintenance and
Calibration
(i)
The HVS and its accessories were maintained in good working condition, such as replacing
motor brushes routinely and checking electrical wiring to ensure a continuous power
supply.
(ii)
HVSs were calibrated using TE-5025A
Calibration Kit upon installation and thereafter at bi-monthly intervals.
(iii)
Calibration certificate
of the TE-5025A Calibration
Kit and the HVSs are provided in Appendix
E.
(a)
Measuring Procedures
The measuring procedures of the 1-hour dust meter are in accordance with
the Manufacturer’s Instruction Manual as follows:
(i)
Turn the power on.
(ii)
Close the air collecting opening cover.
(iii)
Push the “TIME SETTING” switch to [BG]
(iv)
Push “START/STOP”
switch to perform background measurement for 6 seconds.
(v)
Turn the knob at SENSI ADJ position to insert
the light scattering plate.
(vi)
Leave the equipment for 1 minute upon “SPAN CHECK”
is indicated in the display.
(vii)
Push “START/STOP” switch to perform automatic
sensitivity adjustment. This measurement takes 1 minute.
(viii)
Pull out the knob and return it to MEASURE position.
(ix)
Push the “TIME SETTING” switch the time set
in the display to 3 hours.
(x)
Lower down the air collection opening cover.
(xi)
Push “START/STOP” switch to start measurement.
(b)
Maintenance and Calibration
(i)
The 1-hour TSP meter was calibrated
at 1-year intervals against a continuous particulate TEOM Monitor, Series
1400ab. Calibration certificates of the Laser Dust Monitors are provided in Appendix E.
Monitoring Schedule for the Reporting
Month
Monitoring Requirements
Table 3.3 Noise Monitoring Parameters, Frequency and Duration
Parameter and Duration |
Frequency |
30-mins
measurement at each monitoring station between 0700 and 1900 on normal weekdays.
Leq, L10 and L90 would
be recorded. |
At least once per week |
Table 3.4 Noise Monitoring Equipment for Regular Noise Monitoring
B&K (Model No. 2250 & 2270) |
|
Acoustic
Calibrator |
Rion (Model No.
NC-74) & B&K (Model No. 4231) |
Monitoring Locations
Table 3.5 Noise Monitoring Stations during Construction Phase
Location |
Monitoring Station |
Description |
Measurement |
E-N12a [1] |
19 Hing Yan Street |
Rooftop (9/F) |
Façade |
E-N21a [1] |
Block B of Merit Industrial Centre |
Rooftop (13/F) |
Free field[2] |
Notes:
[1] The noise monitoring stations proposed in the EM&A Manual (i.e. Grand Waterfront Tower 3 with ID: E-N12 and Hang Chien Court Block J with ID: E-N21) were not available for impact
noise monitoring, therefore impact monitoring was conducted at E-N12a and
E-N21a as an alternative which was agreed by the ER, IEC and EPD.
[2] A correction of +3 dB(A)
was made to the free field measurements.
Monitoring Parameters, Frequency and Duration
Table 3.6 Noise Monitoring Parameters, Frequency and Duration
Location |
Parameter and Duration |
Frequency |
E-N12a
and E-N21a |
30-mins measurement at each monitoring
station between 0700 and 1900 on normal weekdays. Leq,
L10 and L90 would be recorded. |
At
least once per week |
Monitoring Methodology
(a)
The sound level meter was set on
a tripod at a height of 1.2 m above the ground.
(b)
Façade measurement was made at E-N12a.
(c)
Free field measurements was made at monitoring location E-N21a. A correction of +3 dB(A)
shall be made to the free field measurements.
(d)
The battery condition was checked to ensure the correct
functioning of the meter.
(e)
Parameters such as frequency weighting,
the time weighting and the measurement time were set as follows:
(i)
frequency weighting
(ii)
time weighting: Fast
(iii)
time measurement: Leq(30-minutes) during non-restricted
hours i.e. 0700 – 1900 on normal weekdays.
(f)
Prior to and after each noise
measurement, the meter was calibrated using the acoustic calibrator for 94 dB(A)
at 1000 Hz. If the difference in the calibration
level before and after measurement was more than 1 dB(A), the measurement would
be considered invalid and repeat of noise measurement would be required after
re-calibration or repair of the equipment.
(g)
During the monitoring period, the
Leq, L10 and L90
were recorded. In addition, site conditions
and noise sources were recorded on a standard record sheet.
(h)
Noise measurement was paused during
periods of high intrusive noise (e.g. dog barking,
helicopter noise) if possible. Observations were recorded when intrusive noise
was unavoidable.
(i)
Noise monitoring was cancelled in
the presence of fog, rain, wind with a steady speed exceeding 5m/s, or wind with
gusts exceeding 10m/s.
(a)
The microphone
head of the sound level meter was cleaned with soft cloth
at regular intervals.
(b)
The meter and
calibrator were sent to the supplier or HOKLAS laboratory to check and
calibrate at yearly intervals.
(c)
Calibration
certificates of the sound level meters and acoustic
calibrators are provided in Appendix E.
Monitoring
Schedule for the Reporting Month
Table 4.1 Status of Required Submission under Environmental Permit
EP Condition |
Submission |
Submission Date |
Condition 3.4 of |
Monthly EM&A Report for August 2021 |
14 September 2021 |
Table 5.1 Summary of 24-hour TSP
Monitoring Result in the Reporting Period
ID |
Average (mg/m3) |
Range (mg/m3) |
Action Level (mg/m3) |
Limit Level (mg/m3) |
E-A14a |
33.6 |
20.2 – 46.6 |
197.3 |
260 |
Table 5.2 Summary of 1-hour TSP Monitoring Result in the Reporting Period
ID |
Average (mg/m3) |
Range (mg/m3) |
Action Level (mg/m3) |
Limit Level (mg/m3) |
E-A14a |
60.4 |
52.4
– 67.6 |
302.4 |
500 |
Table 5.3 Summary of Construction Noise Monitoring Results in the Reporting Period
ID |
Range, dB(A), Leq (30 mins) |
Limit Level, dB(A), Leq (30 mins) |
E-N12a |
63.2
– 71.8 |
75 |
E-N21a |
61.1
– 64.5 |
75 |
i. Proper implementation of noise mitigation measures was implemented by the Contractor at Ma Tau Kok to comply with the requirement of the approved Construction Noise Mitigation Measures Plan such as acoustic sheet barrier on the specific Powered Mechanical Equipment, and Quality PME were used to conduct the construction works.
ii. The percussive piling method, pile type and time conducted were complied with the CNP (No.: PP-RE0027-21) at the Stage 2 Underwater Tunnel.
iii. Based on the monitoring results on September 2021, all readings were recorded under the criteria stipulated in EIAO-TM.
Table 6.1 Observations and Recommendations of Site Audit
Parameters |
Date |
Observations and Recommendations |
Follow-up |
Air Quality |
Nil |
Nil |
Nil |
Noise |
8 Sep 2021 |
· The Contractor was reminded to apply noise
barrier for the PMEs at Ma Tau Kok properly. |
The
item was rectified by the Contractor on 15 Sep 2021. |
Water Quality |
1 Sep 2021 |
· The
plug of the drip tray for the generator was missing on the Marine Platform of
Stage 2 of UWT. The contractor was reminded to apply a plug on the drip tray. |
The
item was rectified by the Contractor on 8 Sep 2021. |
8 Sep 2021 |
· Gap
of silt curtain was observed at Ma Tau Kok. |
The
item was rectified by the Contractor on 15 Sep 2021. |
|
29 Sep 2021 |
· Floating
refuse was observed at MTK site. The Contractor should maintain the cleanliness
of embayed marine water. |
The
item was rectified by the Contractor on 6 Oct 2021. |
|
29 Sep 2021 |
· Drip
tray should be provided for chemicals on the Marine Platform. |
The
item was rectified by the Contractor on 6 Oct 2021. |
|
Waste/ Chemical Management |
Nil |
Nil |
Nil |
Landscape & Visual |
Nil |
Nil |
Nil |
Permits/ Licenses |
Nil |
Nil |
Nil |
Table 6.2 Reminders and Recommendations of Site Audit
Parameters |
Date |
Reminder and Recommendations |
Follow-up |
Air Quality |
Nil |
Nil |
Nil |
Noise |
Nil |
Nil |
Nil |
Water Quality |
15 Sep 2021 |
Reminder: · Bunding
at site boundary was reminded to prevent any material dropping to the marine
at MTK. |
The
item was rectified by the Contractor on 21 Sep 2021. |
21 Sep 2021 |
Reminder: · The
Contractor was reminded to clean the mud near the entrance at MTK site. |
The
item was rectified by the Contractor on 29 Sep 2021. |
|
21 Sep 2021 |
Reminder: · The
Contractor was reminded to provide precautionary measure to prevent any
material dropping to the marine at the marine platform. |
The
item was rectified by the Contractor on 29 Sep 2021. |
|
29 Sep 2021 |
Reminder: · The
Contractor was reminded to plug the drip tray at Marine Platform. |
The
item was rectified by the Contractor on 6 Oct 2021. |
|
Waste/ Chemical Management |
15 Sep 2021 |
Reminder: · Precaution
measure was reminded for the breaker’s head to prevent oil leakage. |
The
item was rectified by the Contractor on 21 Sep 2021. |
Landscape & Visual |
Nil |
Nil |
Nil |
Permits/ Licenses |
29 Sep 2021 |
Reminder: ·
The Contractor was reminded to
provide a NRMM label with suitable size (200mm (W) x 130mm (H)) on the
excavator at MTK site. |
The
item was rectified by the Contractor on 6 Oct 2021. |
Date received |
Complaint No. |
Parameter |
Status |
18 September 2021 (Referred by the Gammon Construction Limited on 20 September 2021) |
EC-041-CKRKTW20210918_01_C084 |
Noise, Air (Dust) and Air (Odor) |
Closed |
17&18 September 2021 (Referred by Gammon Construction Limited on 21 September 2021) |
EC-042- KRKTW20210917_01_C083 |
Noise |
Closed |
29 September 2021 (Referred by Gammon Construction Limited on 5 October 2021) |
EC-043-CKRKTW20210614_01_C085 (EPD ref.: K10/RE/00023313-21) |
Water |
Under
investigation and will be provided in subsequent Monthly EM&A Report |
Table 8.1 Construction Activities in the coming three months
Locations |
Site Activities |
Kai
Tak |
-
Wall and roof slab construction at cut & cover and underpass; |
Ma
Tau Kok |
-
TTM implementation; |
Kowloon
Bay |
-
Seawall Reinstatement at Stage 1 UWT; |
|
Date received |
Complaint No. |
Parameter |
Status |
18 September 2021 (Referred by the Gammon Construction Limited on 20 September 2021) |
EC-041-CKRKTW20210918_01_C084 |
Noise, Air (Dust) and Air (Odor) |
Closed |
17&18 September 2021 (Referred by Gammon Construction Limited on 21 September 2021) |
EC-042- KRKTW20210917_01_C083 |
Noise |
Closed |
29 September 2021 (Referred by Gammon Construction Limited on 5 October 2021) |
EC-043-CKRKTW20210614_01_C085 (EPD ref.: K10/RE/00023313-21) |
Water |
Under
investigation and will be provided in subsequent Monthly EM&A Report |
Chemical and Waste
Management
