EXECUTIVE SUMMARY
4. Summary of Complaints, Notification of Summons and
Prosecutions21
7. Conclusion and Recommendations25
List of Appendices
A. Alignment and Works Area for the Contract
No. HY/2014/20
B. Construction
Programme
C. Project

Organization Chart
D. Dust
Event-Action Plan (EAP)
E. Noise
Event-Action Plan (EAP)
F. Environmental

Mitigation Implementation Schedule (EMIS)
G. Monitoring
Schedules of the Reporting Month
H. Calibration
Certificate (Air Monitoring)
I. Calibration
Certificate (Noise)
J. The
Certification of Laboratory with HOKLAS Accredited Analytical Tests
K. Location
Plan of Noise and Air Quality Monitoring Station
L. Monitoring
Data (Air Monitoring)
M.
Monitoring Data (Noise)
N. Waste
Flow Table
O. Statistics
on Complaint, Notifications of Summons and Successful Prosecutions
P. Monitoring
Schedule of the Coming Month
Executive Summary
A.1 Build King – SK ecoplant Joint Venture (“Contractor”) commenced the construction works of Highway Department (HyD) Central Kowloon Route Contract No. HY/2014/20 – Section of Yau Ma Tei West (“The Project”) on 12 February 2019. This is the 62nd monthly Environmental Monitoring and Audit (EM&A) report presenting the EM&A works carried out during the period from 1 March 2024 to 31 March 2024.
A.2
A summary of the construction works reported by
Main Contractor for the Project during the reporting month is listed below.
Construction Activities undertaken |
·
Socket H-Pile (Landscaped Deck and Bridges) at Portion
1B and 1D ·
Noise Barrier C02, C03 & S01 (along Lin Cheung
Road) at Portion 1E ·
Slip Road A (Reinforced Concrete works for Noise
Barrier C06 & V09) at Portion 1E ·
Bridge C2 Deck 5 construction at Portion 1B and 1G ·
Parapet Wall at Bridge B, B2, C, C2 and D at Portion 1B ·
Vent. Adit Ch 175~240 at Zone
4B, 4C and A1 at Portion 1E ·
Parapet Wall at Abutment Wall Slip Road E &
Installation of NB-C01 & C03 in Portion 1B ·
Slip Road E in Portion 1A ·
Slip Road E and F Widening
Works (Variation Order) ·
Subway Construction at
Portion 1B ·
Pier and Upstand Wall at
Segments 1 & 2 in Portion 1B ·
Landscaped construction at
Segment 1 & 2 in Portion 1B ·
Pile Cap, Pier and Upstand
Wall at Segment 3 including B2P5 & C2P6 in Portion 1B ·
Landscaped Deck at Segment 4 at Portion 1B ·
Fire Separation Wall FSW-4 and FSW-5 at Elevated Road
at Segment 7 in Portion 1D ·
Sump Pit Construction at Segment 10 in Portion 1F ·
Escape Route Staircase No. 4 at Portion 1F ·
Landscaped
Construction at Segment 10 and 11 in Portion 1F ·
Landscaped Construction at
Segment 12B in Portion 1F ·
Reinforced Concrete Works for Escape Route 1 and 2 in
Portion 1F ·
Segments 8 and 9 Pile Cap,
Upstand Wall and Column (West Side) including Hoi Wang Road Plant Room at
Portion 1D |
A.3
A summary of regular construction noise and

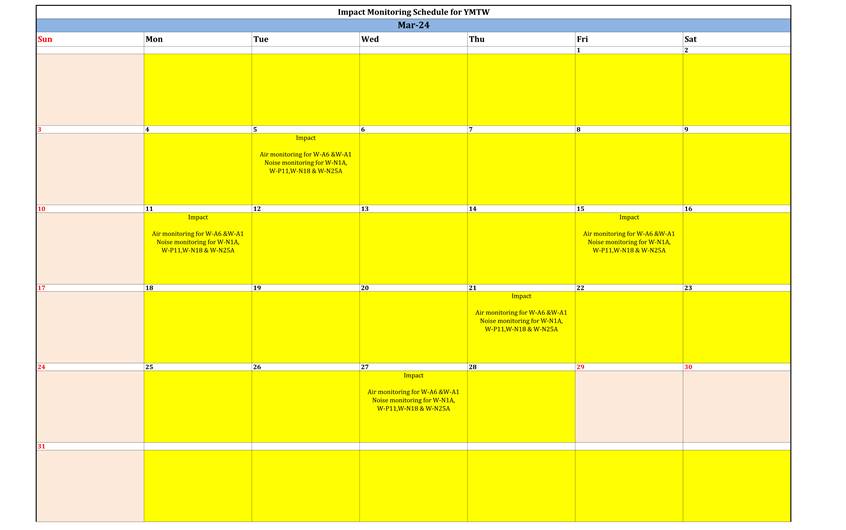

construction dust monitoring activities in this reporting period is listed
below:

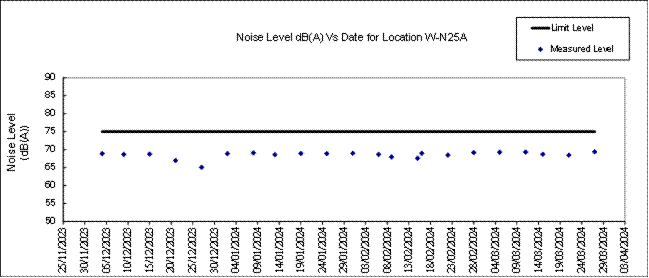

Regular construction noise monitoring during
normal working hours
W-N1A, W-P11, W-N18, W-N25A |
5 times |

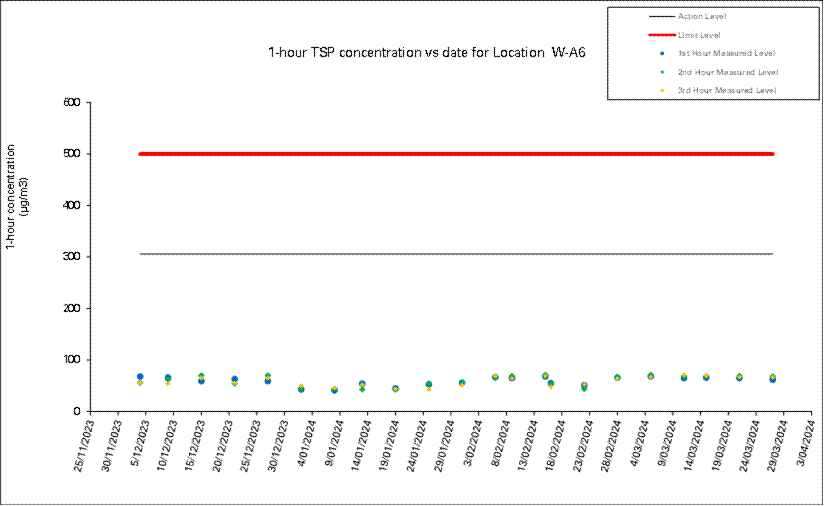

Construction dust (24-hour TSP) monitoring
W-A1 W-A6 |
5 times 5 times |
Construction dust (1-hour TSP) monitoring
W-A1, W-A6 |
15 times |
A.4
Bi-weekly inspection of the implementation of
landscape and visual mitigation measures was conducted on 7 and 21 March
2024. Details of the audit findings and implementation
status are presented in Section 5.
A.5 Joint weekly site inspections were conducted by representatives of the Contractor, Engineer and Contractor’s ET on 7, 14, 21 and 28 March 2024. A joint site inspection with IEC was undertaken on 21 March 2024. Details of the audit findings and implementation status are presented in Section 5.
A.6 Details of waste management are presented in Section 3.

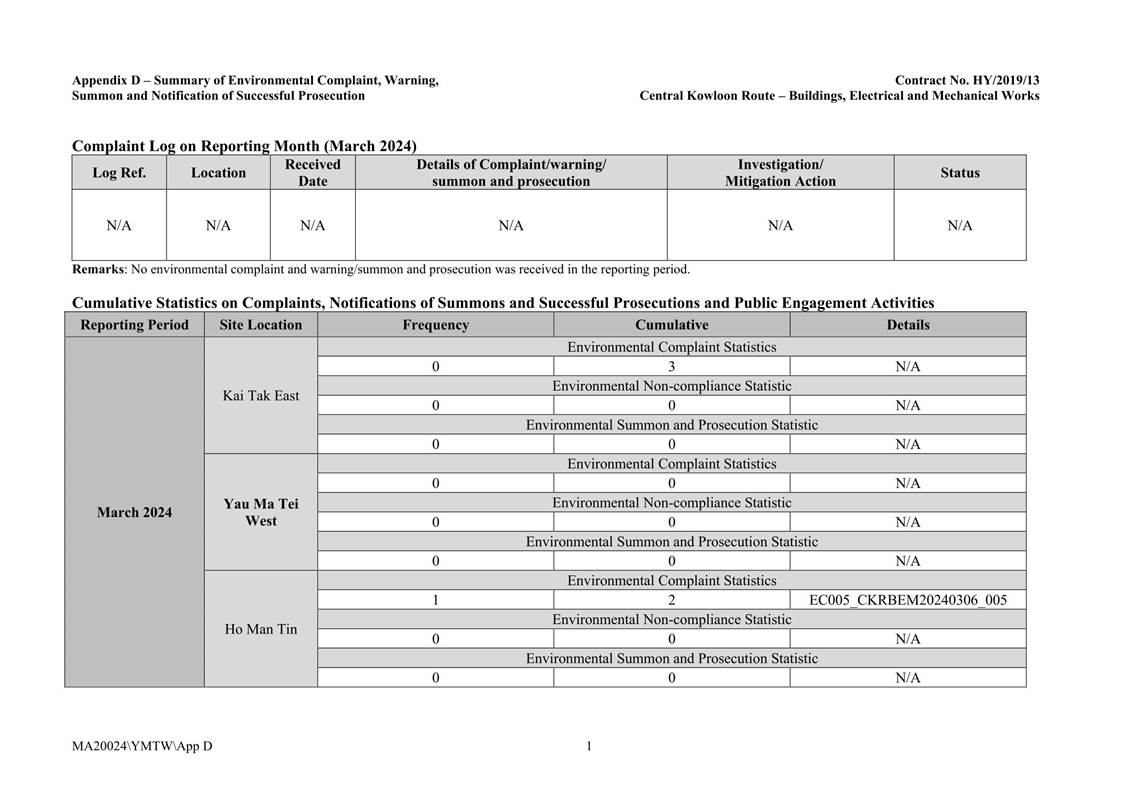

A.7 No exceedance of Action and Limit Level of construction noise, 24 hour TSP and 1 hour TSP was recorded in the reporting month.
A.8 No non-compliance was reported in the reporting month.
A.9 No notification of summon or prosecution was received in this reporting period.
A.10
A summary of the construction activities provided by
Main Contractor in the next reporting month is listed below:
·
Remaining Socket H-Pile at
Segments 5 (to complete) at Portion 1D ·
Along Lin Cheung Road – remaining
road works at Portion 1E ·
Noise Barrier C02 Road Works
in progress at Portion 1E ·
Slip Road A excavation,
backfilling, footing & wall construction for NB-C06 & V09 at Portion 1E ·
Parapet Wall at Bridge B, B2,
C, C2, D, E & F at Portion 1B, 1G ·
Remaining FSW-3 Footing &
Upstand Wall at Portion 1 ·
Road D Structure I
Construction at Portion 1E ·
Backfilling at Vent. Adit Ch 175~240 at Zone 4C at Portion 1E ·
Remaining Foundation and
Abutment Wall AW05 at Recovery Area in Portion 1B ·
Road Widening Works at Slip
Road E & F in Portion 1A & 1B ·
Slip Road E & F Road
Works and Sign Gantry Installation in Portion 1A & 1B ·
Backfilling at Subway
Staircase South in Portion 1B ·
Remaining Upstand Wall and
Column Construction at Segments 1 to 3 in Portion 1B & 1D ·
Fire Separation Wall FSW-4
and FSW-5 at Elevated Road at Segment 7 in Portion 1D ·
Reinforced Concrete works for
Escape Route Staircase No. 4 in Portion 1F ·
Roadworks at Segment 3, 4, 7,
10, 11 & 12A in Portion 1B & 1F ·
Landscaped Deck Construction
at Segment 12b (OHVA & Landscaped Deck) in Portion 1F ·
Reinforced Concrete works for
Escape Route Staircase No. 1 to 2 at Portion 1F and 10 ·
Pile Cap construction at
Segment 5 (West side) in Portion 1D ·
Sheet Piling works prior to
Pile Cap construction at Segments 8 & 9 and Washout Chamber in Portion 1D ·
Construction at HWR Plant
Room Building in Portion 1D |
1. Basic Project Information
1.1. Central Kowloon Route (CKR) is a 4.7 km long dual 3-lane trunk road in Central Kowloon linking Yau Ma Tei Interchange in West Kowloon with the road network on Kai Tak Development and Kowloon Bay in East Kowloon.
1.2. The Central Kowloon Route – Design and Construction Environmental Impact Assessment Report (Register No.: AEIAR-171/2013) was approved with conditions by the Environmental Protection Department (EPD) on 11 July 2013. An Environmental Permit (EP 457/2013) was issued on 9 December 2013. Variations of EP (VEP) was subsequently applied for and the latest EP (EP-457/2013/D) was issued by EPD on 15 June 2021.
1.3. The construction of the CKR had been divided into different sections. This Contract No. HY/2014/20 – Section of Yau Ma Tei West (YMTW) covers part of the construction activities located at Yau Ma Tei under the EP which includes:
-
Section of Yau Ma Tei West
i. Construction of an approximately 250m long Depressed Road at the western tunnel portal of CKR;
ii. Construction of a Landscaped Deck structure above the western tunnel portal and Hoi Wang Road, including the associated civil engineering provisions and coordination with CKR-RMW contractor in respect of the remaining works for the Landscaped Deck;
iii. Construction of an underground Ventilation Adit connecting the tunnel ventilation system with the Yau Ma Tei Ventilation Building;
iv. Construction of approach roads and slip roads, including bridges and other associated structures, connecting CKR with the existing road networks:
l Diversion of a section of existing drainage box culvert of approximately 215m in length;
v. Design and construction of the noise mitigation measures at Slip Roads A, C2, D, E, G, Hoi Wang Road, Lai Cheung Road and Lin Cheung Road;
vi. Design and construction of Smoke Ventilation System including Smoke Ventilator System including Smoke Ventilator System, Linear Heat Detection System, Pneumatic Air Supply System, the associated plant rooms, control system and power supply system for part of the Landscaped Deck;
vii. Design and construction of the façade system of the Landscaped Deck;
viii. Design and construction of lifts at the Landscaped Deck;
ix. Associated roadworks, footpath, drainage, sewerage, watermains, street lighting, traffic aids, landscaping, electrical and mechanical works, instrument monitoring works and utility diversion works;
x. Construction of civil engineering provisions and coordination with future tunnel E&M and TCSS contractor for installation of tunnel E&M and TCSS equipment;
The alignment and works area for

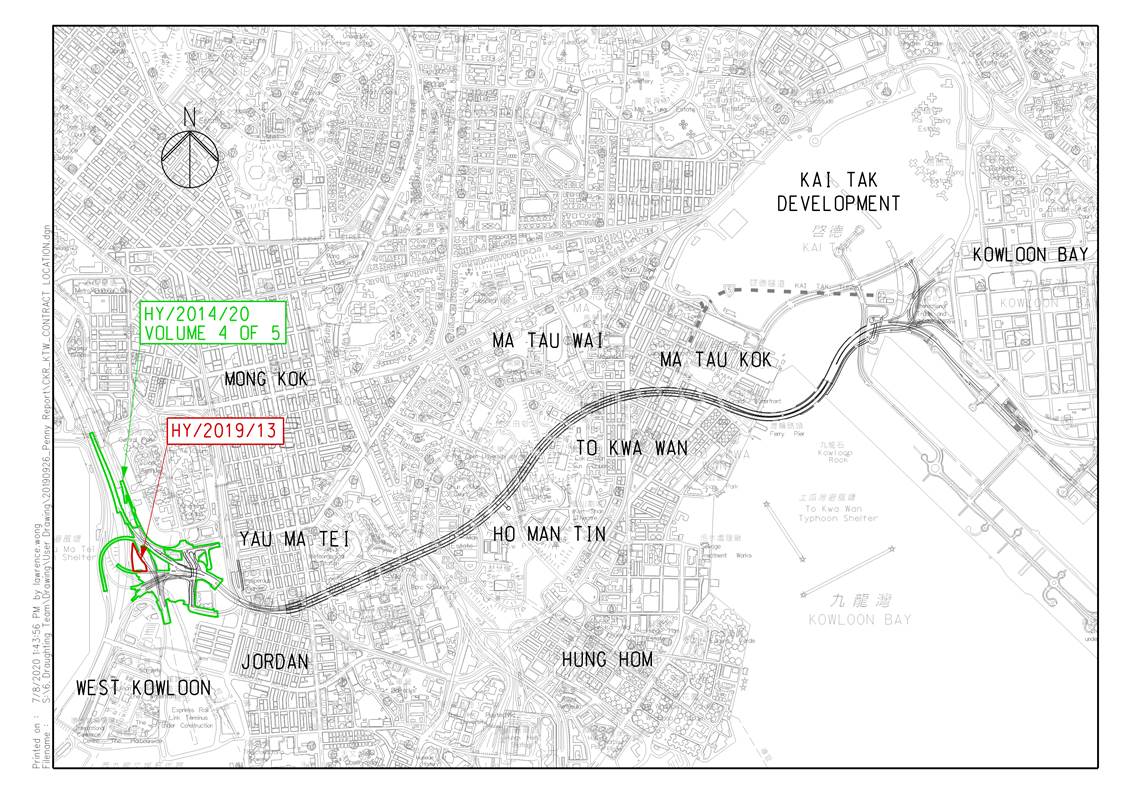

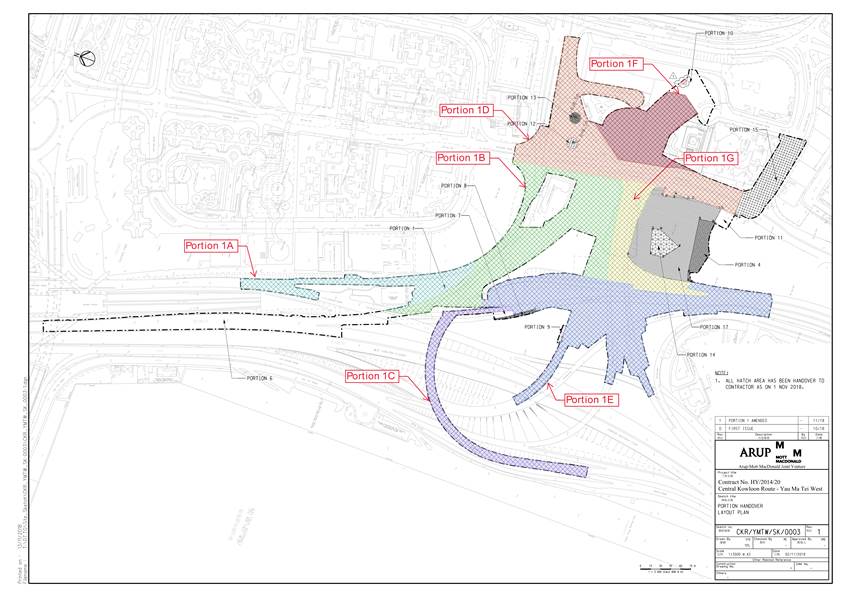

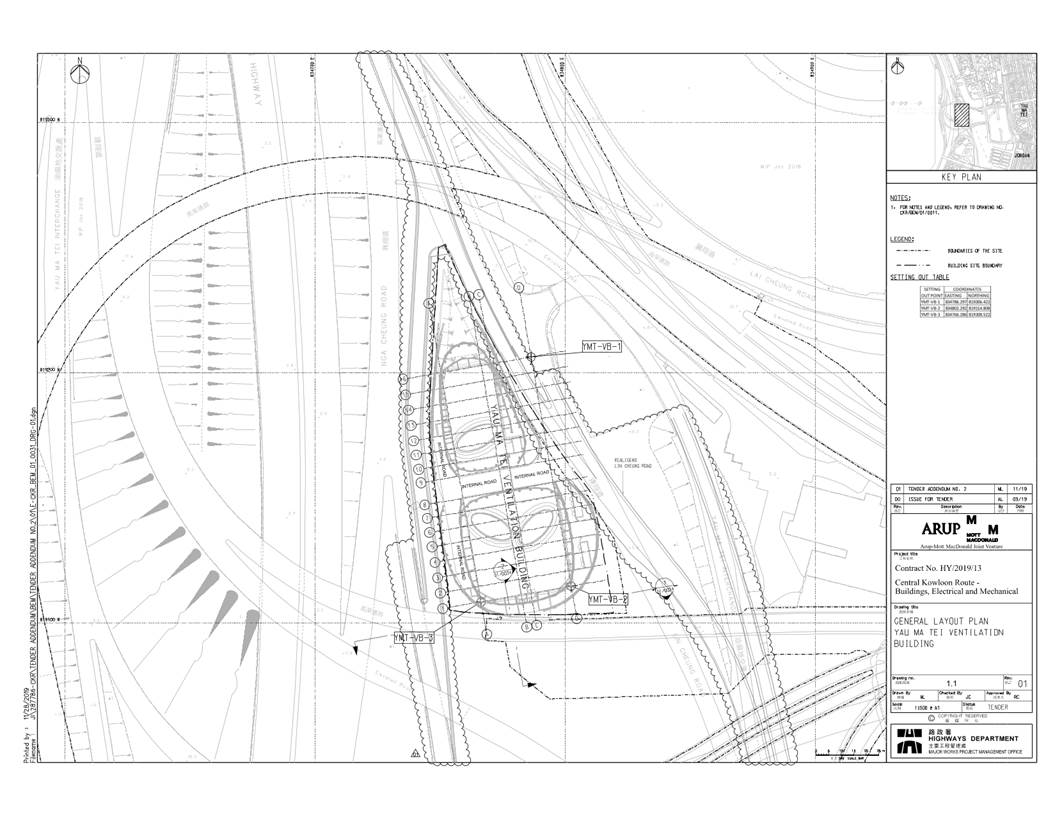

the Contract No. HY/2014/20 – are shown
in Appendix A.
1.4. A summary of the major construction activities undertaken in this reporting period is shown in Table 1.1. The construction programme is presented in Appendix B.

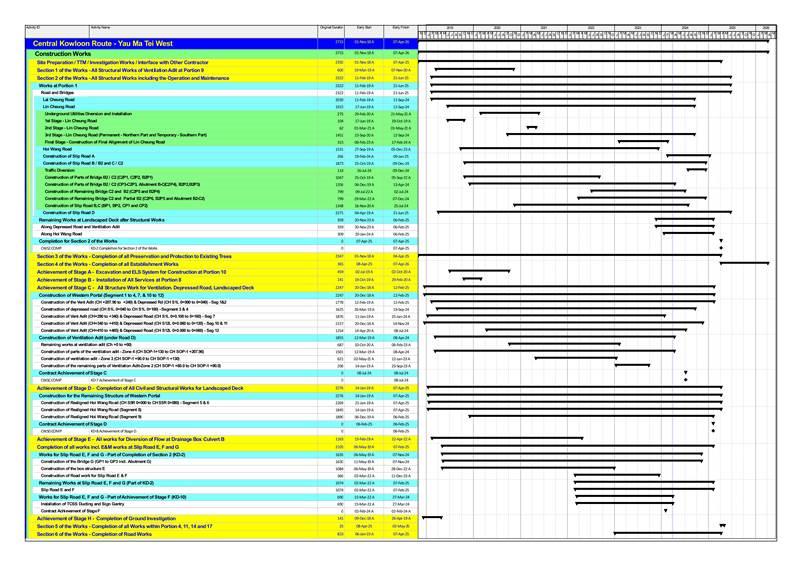

Table 1.1 Summary of the construction activities reported by Main Contractor during the Reporting Month.
·
Socket H-Pile (Landscaped Deck and Bridges) at Portion
1B and 1D ·
Noise Barrier C02, C03 & S01 (along Lin Cheung
Road) at Portion 1E ·
Slip Road A (Reinforced Concrete works for Noise
Barrier C06 & V09) at Portion 1E ·
Bridge C2 Deck 5 construction at Portion 1B and 1G ·
Parapet Wall at Bridge B, B2, C, C2 and D at Portion 1B ·
Vent. Adit Ch 175~240 at Zone
4B, 4C and A1 at Portion 1E ·
Parapet Wall at Abutment Wall Slip Road E &
Installation of NB-C01 & C03 in Portion 1B ·
Slip Road E in Portion 1A ·
Slip Road E and F Widening
Works (Variation Order) ·
Subway Construction at
Portion 1B ·
Pier and Upstand Wall at
Segments 1 & 2 in Portion 1B ·
Landscaped construction at
Segment 1 & 2 in Portion 1B ·
Pile Cap, Pier and Upstand
Wall at Segment 3 including B2P5 & C2P6 in Portion 1B ·
Landscaped Deck at Segment 4 at Portion 1B ·
Fire Separation Wall FSW-4 and FSW-5 at Elevated Road
at Segment 7 in Portion 1D ·
Sump Pit Construction at Segment 10 in Portion 1F ·
Escape Route Staircase No. 4 at Portion 1F ·
Landscaped
Construction at Segment 10 and 11 in Portion 1F ·
Landscaped Construction at
Segment 12B in Portion 1F ·
Reinforced Concrete Works for Escape Route 1 and 2 in
Portion 1F ·
Segments 8 and 9 Pile Cap,
Upstand Wall and Column (West Side) including Hoi Wang Road Plant Room at
Portion 1D |

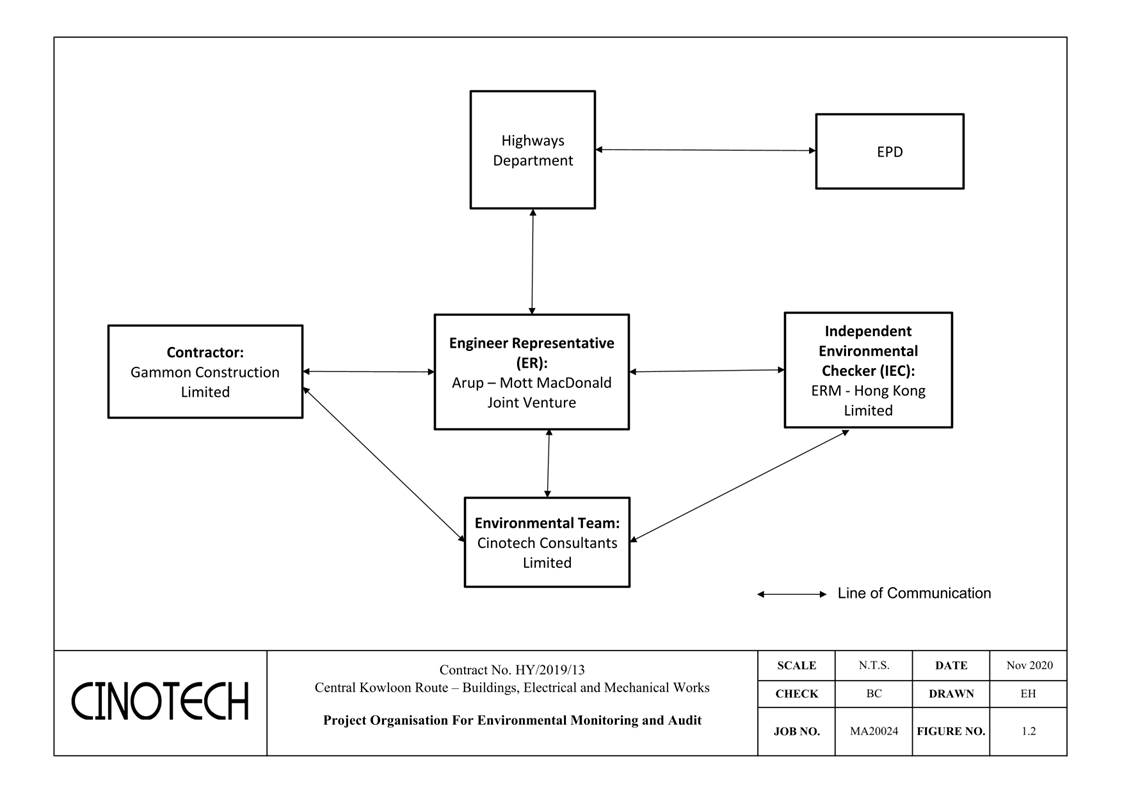

1.5. The project organisational chart specifying management structure and contact details are shown in Appendix C.
1.6. A summary of the valid permits, licences, and /or notifications on environmental protection for this Project is presented in Table 1.2
Table 1.2
Summary of the Status of Valid Environmental Licence
Notification, Permit and Documentations
Permit/ Licences/ Notification /Reference No. |
Valid Period |
Status |
Remark |
|
From |
To |
|||
Environmental Permit |
||||
EP-457/2013/D |
15 Jun 2021 |
End of Project |
Valid |
- |
Wastewater Discharge License |
||||
WT00033736-2019 |
1 May 2020 |
31 May 2024 |
Valid |
- |
Notification of Construction Works under the Air Pollution Control
(Construction Dust) Regulation |
||||
438845 |
31 Oct 2018 |
End of Project |
Notified |
- |
Chemical Waste Producer Registration |
||||
WPN5213-229-B2527-02 |
31 Oct 2018 |
End of Project |
Valid |
- |
Billing Account for Disposal of Construction Waste |
||||
7032430 |
2 Nov 2018 |
End of Project |
Valid |
- |
Disposal of Special Waste at
Landfills Admission Ticket |
||||
Nil |
- |
- |
- |
- |
Collection of Public Fill at
Public Fill |
||||
TM38-HY/2014/20-05 |
1 Jan 2024 |
30 Jun 2024 |
Valid |
- |
GW-RE1540-23 |
15 Dec 2023 |
14 Mar 2024 |
Superseded by GW-RE0191-24 |
|
GW-RE0191-24 |
15 Mar 2024 |
14 Jun 2024 |
Valid |
|
GW-RE0039-24 |
23 Jan 2024 |
20 Apr 2024 |
Valid |
Portal
Frame Erection at Hoi Wang Road Southbound |
GW-RE0042-24 |
28 Jan 2024 |
31 Mar 2024 |
Expired during the reporting
month |
Road
Marking and Resurfacing Works for Lin Cheung Road Southbound Realignment |
GW-RE0119-24 |
14 Feb 2024 |
20 Apr 2024 |
Valid |
Road
Marking Works at West Kowloon Highway (Stage 2) |
GW-RE0199-24 |
27 Feb 2024 |
31 May 2024 |
Valid |
Erection of
Sign Gantry G18 at Yau Ma Tei Interchange |
GW-RE0204-24 |
27 Feb 2024 |
31 May 2024 |
Valid |
TCSS
Crossroad Ducts Laying for Sign Gantry G18 at Yau Ma Tei Interchange |

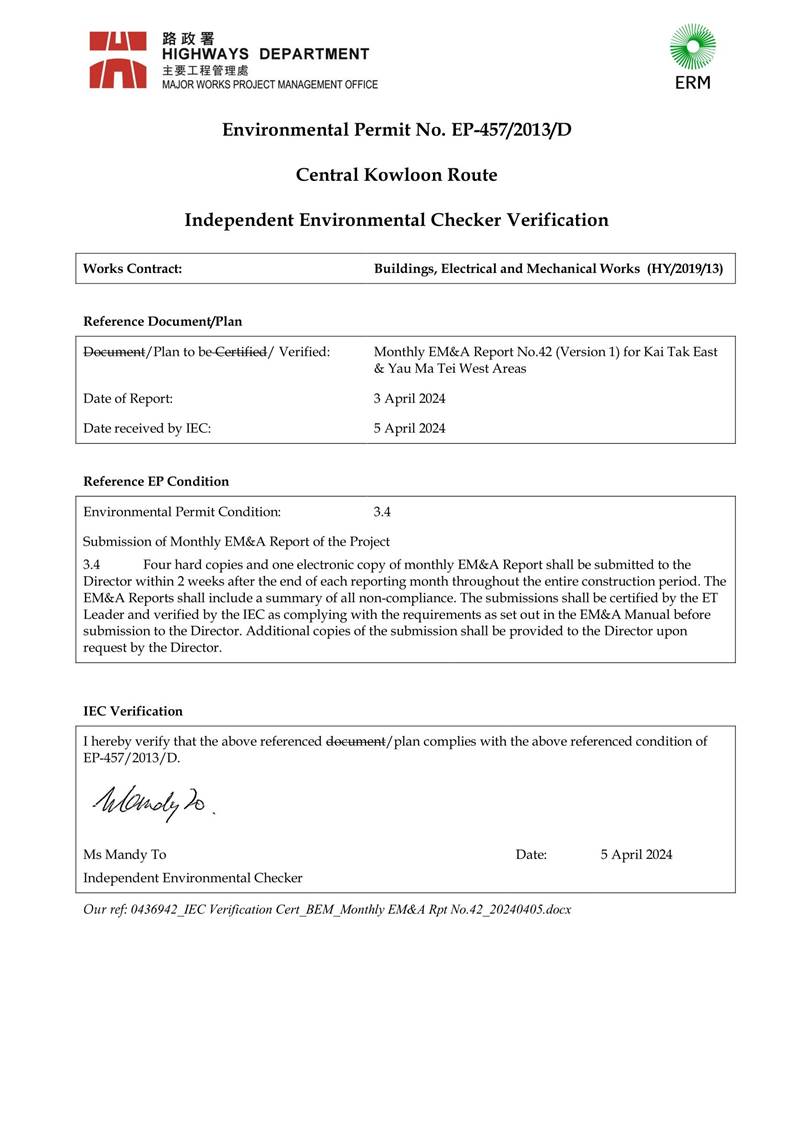

2.1. Environmental permit (EP) conditions under the EIAO, submission status under the EP and implementation status of mitigation measures had been reviewed and implemented on schedule. The status of required submissions under the EP (EP-457/2013/D) as of the reporting period for the Project are summarised in Table 2.1.
Table 2.1 Summary of
Status of Required Submission for EP-457/2013/D for the Project
EP Condition (EP-457/2013/D) |
Submission |
Submission date |
14 March 2024 |
2.2. Details of the major construction activities undertaken in this reporting period are shown in Table 2.2.
Table 2.2 Summary of the Construction Activities Undertaken during the Reporting Month.
Construction activities
undertaken |
Remarks on
progress |
·
Socket H-Pile (Landscaped Deck and Bridges) at Portion
1B and 1D |
·
99%
completion |
· Noise Barrier C02, C03
& S01 (along Lin Cheung Road) at Portion 1E |
·
99% completion |
· Slip Road A
(Reinforced Concrete works for Noise Barrier C06 & V09) at Portion 1E |
·
8% completion |
· Bridge C2 Deck 5
Construction at Portion 1B and 1G |
·
99% completion |
· Parapet Wall at Bridge
B, B2, C, C2 and D at Portion 1B |
·
48% completion |
· Vent. Adit Ch 175~240 at Zone 4B, 4C and A1 at Portion 1E |
·
98% completion |
· Parapet Wall at Abutment
Wall Slip Road E & Installation of NB-C01 & C03 in Portion 1B |
·
40% completion |
· Slip Road E in Portion 1A |
· 93% completion |
·
Slip Road E and F Widening
Works (Variation Order) |
· 12% completion |
·
Subway Construction at
Portion 1B |
· 95% completion |
· Pier & Upstand Wall at Segments 1 & 2 in Portion 1B |
· 94% completion |
·
Landscaped Construction at
Segment 1 & 2 in Portion 1B |
· 10% completion |
· Pile Cap, Pier and Upstand Wall at Segment 3 including B2P5 & C2P6
in Portion 1B |
· 99% completion |
·
Landscaped Deck at Segment 4
in Portion 1B |
· 15% completion |
·
Fire Separation Wall FSW-4
and FSW-5 at Elevated Road at Segment 7 in Portion 1D |
· 70% completion |
· Sump Pit Construction
at Segment 10 at Portion 1F |
· 95% completion |
· Escape Route Staircase
No. 4 at Portion 1F |
· 10% completion |
· Landscaped Construction at Segment 10 & 11 in
Portion 1F |
· 90% completion |
· Landscaped
Construction at Segment 12B in Portion 1F |
· 35% completion |
·
Reinforced Concrete Works for Escape Route 1 and 2 in
Portion 1F |
· 58% completion |
·
Segments 8 and 9 Pile Cap,
Upstand Wall and Column (West Side) including Hoi Wang Road Plant Room at
Portion 1D |
· 15% completion |

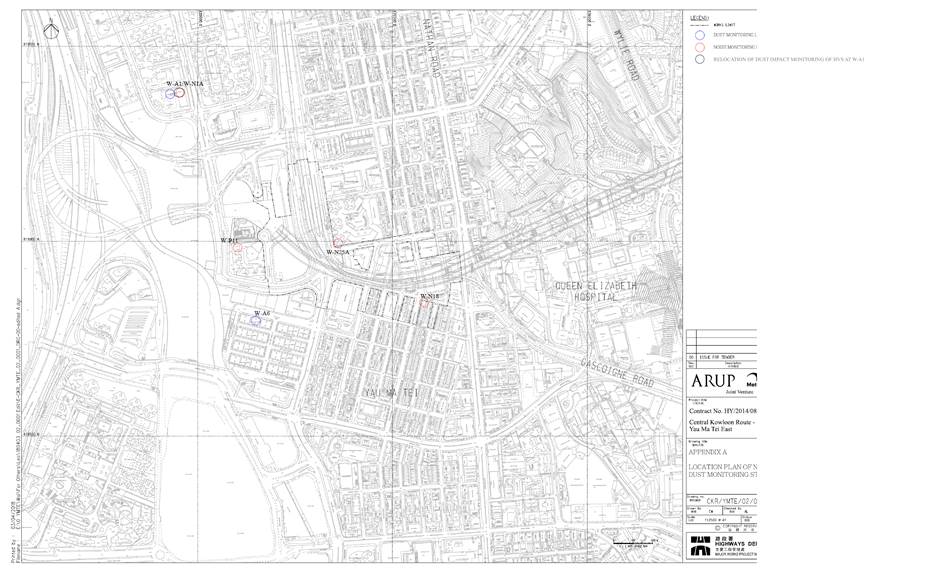

2.3. The drawing showing the project layout and the location of the monitoring station and environmental sensitive receivers are attached in Appendix A and Appendix K. Co-ordinates of the monitoring location are shown in Table 2.3.
Table 2.3 Summary of the location of the monitoring stations
Monitoring Location |
Location ID |
Latitude |
Longitude |
Yau Ma
Tei Catholic Primary School (Hoi Wang Road)* |
W-A1/ W-N1A |
22.31345 |
114.16409 |
Man Cheong Building |
W-A6 |
||
Hydan
Place |
W-N18 |
||
Prosperous
Garden Block 1 |
W-N25A |
||
The
Coronation Tower 1 |
W-P11 |
||
Remark: *The High Volume Sampler (HVS) at
dust impact monitoring location W-A1 had been relocated on 6 Sep 2022 due to
installation work of PV panel at Yau Ma Tei Catholic Primary School. The
relocation of HVS was approved by ER and agreed with IEC. |
Air Quality
3.1.1. The impact monitoring had been carried out in accordance with section 5.8 of the approved EM&A Manual to determine the 1-hour and 24-hour total suspended particulates (TSP) levels at the monitoring locations in the reporting month.
3.1.2. The sampling frequency of at least once in every 6 days, shall be strictly observed at the monitoring stations for 24-hour TSP monitoring. For 1-hour TSP monitoring, the sampling frequency of at least 3 times in every 6 days should be undertaken when the highest dust impact occurs.
3.1.3. General meteorological conditions (wind speed, direction and precipitation) and notes regarding any significant adjacent dust producing sources had also been recorded throughout the impact monitoring period.
Noise
3.1.4. Construction noise level shall be measured in terms of the A-weighted equivalent continuous sound pressure level (Leq). Leq (30min) shall be used as the monitoring parameter for the time period between 0700 and 1900 hours on normal weekdays.
3.1.5. For all other time periods, Leq (5min) shall be employed for comparison with the Noise Control Ordinance (NCO) criteria.
3.1.6. As supplementary information for data auditing, statistical results such as L10 and L90 shall also be obtained for reference.
Air Quality
3.2.1. 1-hour TSP levels and 24-hour TSP had been measured with direct reading dust meter and High Volume Samplers respectively. It has been demonstrated its capability in achieving comparable results with high volume sampling method as set out in the Title 40 of the Code of Federal Regulations, Chapter 1 (Part 50).
3.2.2. The 1-hour TSP meter was calibrated by the manufacturer prior to purchasing. Zero response of the instrument was checked before and after each monitoring event. Operation of the 1-hour TSP meter followed manufacturer’s Operation and Service Manual. The 24-hour TSP meter was calibrated against firmware 80570-8100-V1.0.4, annually. Operation of the 24-hour TSP meter followed manufacturer’s Operation and Service Manual. Valid calibration certificates of dust monitoring equipment are attached in Appendix H.
3.2.3. A summary of the equipment that was deployed for the 24- hour averaged monitoring is shown in Table 3.1. The TSP monitoring was conducted as per the schedule presented in Appendix G.
3.2.4. The equipment used for 1-hour TSP and 24-hour TSP measurement and calibration are summarised in Table 3.1
Table 3.1 Construction
Dust Monitoring Equipment
Monitoring Parameter |
Monitoring Equipment |
Serial Number |
Date of Calibration |
1-hour TSP |
LD-5R Digital Dust Indicator |
761172 |

28 Nov 2023 |
LD-5R Digital Dust Indicator |
992821 |
28 Nov 2023 |
|
PC-3A(E) Digital Dust Indicator |
JC2002225 |
8 Apr 2023 |
|
PC-3A(E) Digital Dust Indicator |
JC220710222 |
22 Jun 2023 |
|
24-hour TSP |
TE-5170X High Volume Sampler |

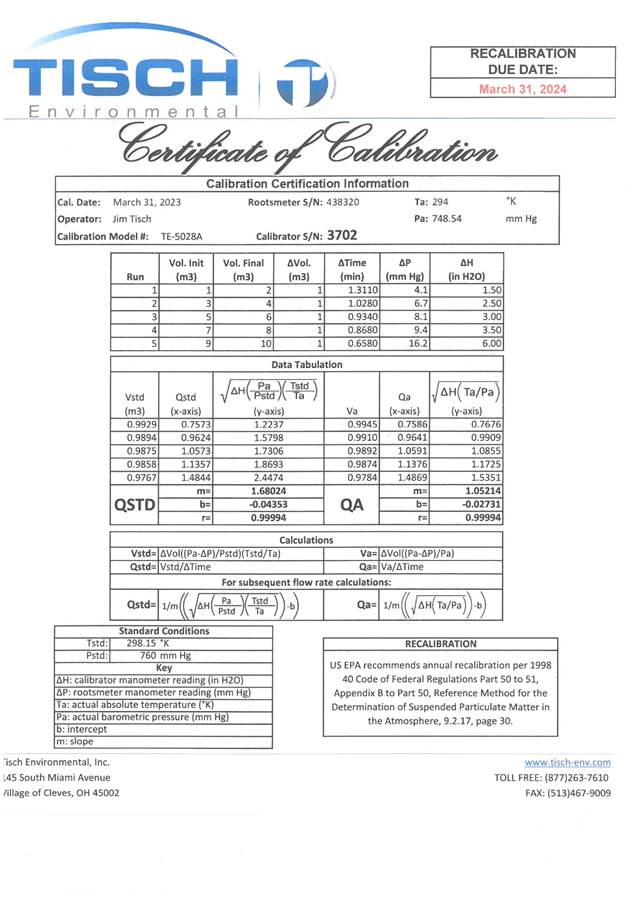

1084 |
4 Mar 2024 and 20 Mar 2024 |

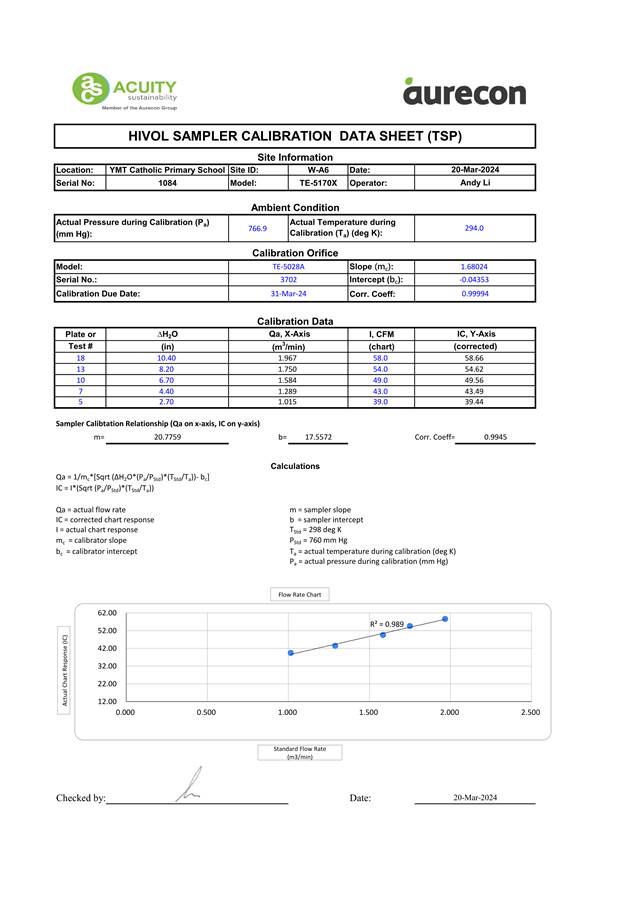

TE-5170X High Volume Sampler |
1050 |
4 Mar 2024 and 20 Mar 2024 |
|
TE-5028A Calibration Kit |
3702 |
31 Mar 2023 |
Noise
3.2.5. Sound level meter in compliance with the International Electrotechnical Commission Publications 651: 1979 (Type 1) and 804: 1985 (Type 1) specifications has been used for carrying out the noise monitoring. The sound level meter has been checked using an acoustic calibrator. The wind speed and other metrological data has been recorded from Hong Kong Observatory- King’s Park meteorological station, along with portable wind speed meter stand by as back up when the information are not available from HKO.
3.2.6. Acoustic calibrators and sound level meters using for the monitoring is within the valid period and were calibrated per year. Valid calibration certificate of noise monitoring equipment is attached in Appendix I.
3.2.7. The details of equipment using for monitoring are listed in Table 3.2, as below:
Table 3.2 Monitoring Equipment Used in Monitoring
Monitoring Equipment |
Serial Number |
Date of Calibration |
Nti XL2 Sound
Level Meter |
A2A-09696-E0 |
4 Apr 2023 |
Rion NC-75 Sound Level Calibrator |
34724244 |
3 Aug 2023 |

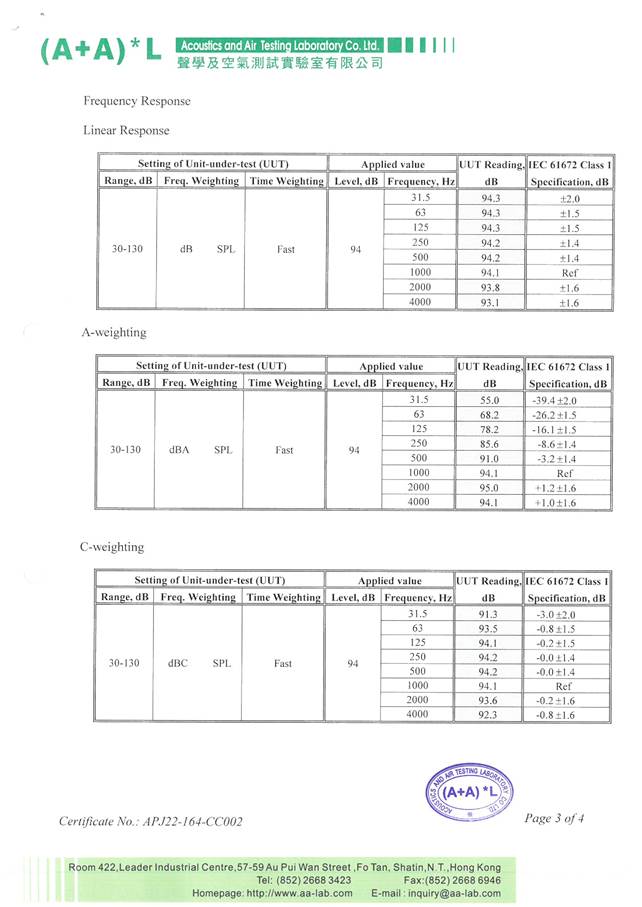

3.3. Monitoring Methodology and QA/QC results
Air Quality
3.3.1. The 1-hour TSP monitor, portable dust meters (Sibata Digital Dust Indicator Model LD-5R and PC-3A(E) digital dust indicator) was used for the impact monitoring. The 1-hour TSP meters provides a real time 1-hour TSP measurement based on 90o light scattering. Three 1-hour TSP level were logged per every six days.
3.3.2. The 24-hour TSP monitor, High Volume Samplers (Tisch TE-5170X High Volume Air Sampler) were used for the impact monitoring. The 24-hour TSP monitoring consists of the following:
u The HVS was set at the monitoring location, with electricity supply
connected and secured;
u HVS was calibrated before commencing the 1st measurement;
u The filter paper was weight and provided by HOKLAS lab (Acumen
Laboratory and Testing Limited and ALS Technichem
(HK) Pty Ltd) before and after the sampling. Certificate of HOKLAS accredited
laboratory can be referred to Appendix J;
u The airflow over time during sampling process was recorded by the HVS.
3.3.3. HVSs was free-standing with no obstruction. The following criteria were considered in the installation of the HVS:
u Appropriate support to secure the samples against gusty wind needed to
be provided the monitoring station;
u A minimum of 2m separation from walls, parapets and penthouses was required
for rooftop samplers;
u No furnace or incinerator flues was nearby;
u Airflow around the sampler was unrestricted; and
u Permission could be obtained to set up the samplers and gain access to
the monitoring station.
3.3.4. Preparation of Filter Papers
u Glass fiber filters were labelled and sufficient filters that were clean
and without pinholes were selected;
u All filters were equilibrated in the conditioning environment for 24
hours before weighing. The conditioning environment temperature was around
25℃ and not varied by more than ±3℃; the relative humidity (RH)was
40%; and
u Acumen Laboratory and Testing Limited and ALS Technichem
(HK) Pty Limited, as HOKLAS accredited laboratory, implemented comprehensive
quality assurance and quality control programmes on
the filters.
u The power supply was checked to ensure that the HVS was working properly;
u The filter holder and area surrounding the filter were cleaned;
u The filter holder was removed by loosening the foul bolts and a new
filter, with stamped number upward, on a supporting screen was aligned carefully;
u The filter was properly aligned on the screen so that the gasket formed
an airtight seal on the outer edges of the filter;
u The swing bolts were fastened to hold the filter holder down to the
frame. The pressure applied should be sufficient to avoid air leakage at the edges;
u The shelter lid was closed and secured with an aluminum strip;
u The HVS was warmed- up for about 5 minutes to establish run- temperature
conditions;
u A new flow rate record sheet was inserted into the flow recorder;
u The flow rates of the HVS was checked and
adjusted to between 0.64-1.52m3min-1, which was within the range specified in the EM&A Manual (i.e. 0.6-
1.7 m3min-1);
u The programmable timer was set for a sampling period of 24 hours, and
the starting time, weather condition and filter number were recorded;
u The initial elapsed time was recorded;
u At the end of sampling, the sampled filter was removed carefully and
folded in half so that only surfaces with collected particulate matter were in contact;
u The filter paper was placed in a clean plastic envelope and sealed; all
monitoring information was recorded on a standard data sheet and
u The filters were sent to (Acumen Laboratory and Testing Ltd and ALS Technichem (HK) Pty Ltd) for analysis.
3.3.6. Maintenance and Calibration
u The HVS and their accessories were maintained in a good working
condition. For example, motor brushes were replaced routinely
and electrical wiring was checked to ensure a continuous power supply; and
u The flow rate of each HVS with mass flow controller was calibrated using
an orifice calibrator, Initial calibrations of the dust monitoring equipment
were conducted upon installation and prior to commissioning. Five- point
calibration was carried out for HVS using TE-5025 Calibration Kit. HVS is
calibrated bimonthly. The calibration records for the HVS is
given in Appendix H.
u The wind speed has been recorded from Hong Kong Observatory- King’s Park
meteorological station, along with portable wind speed meter stand by as back
up when the information are
not available from HKO.
Noise
3.3.8. All noise measurements by the meter were set to FAST response and on the A-weighted equivalent continuous sound pressure level (Leq) in decibels dB(A). LAeq(30mins) was used as the monitoring metric for the time period between 0700 –1900 hours on normal weekdays. The measured noise levels were logged every 5 minutes throughout the monitoring period.
3.3.9. Prior to the noise measurement, the accuracy of the sound level meter was checked using an acoustic calibrator generating a known sound pressure level at a known frequency. Checking was conducted before and after the monitoring. The calibration level before and after the noise measurement is agreed to within 1.0 dB(A).
3.3.10. Noise measurements should not be made in presence of fog, rain, wind with a steady speed exceeding 5 ms-1 or wind with gusts exceeding 10 ms-1. The wind speed was checked with a portable wind speed meter capable of measuring with speeds in ms-1.
Air Quality
3.4.1. During the site visit, both of the original proposed dust monitoring locations were rejected due to the condition at The Coronation was not favourable for monitoring and the access was declined by the management office of Hong Kong Community College (HKCC) of PolyU. Two alternative air monitoring stations Yau Ma Tei Catholic Primary School (Hoi Wang Road) and Man Cheong Building had been proposed by ET and approved by IEC. 2 designated air monitoring locations were identified and agreed with IEC and EPD. Details of air monitoring stations are described in Table 3.3. The location plan of air quality monitoring stations is shown in Appendix K.
Table 3.3
Location of the Dust Monitoring Stations
Air Quality Monitoring Station |
Dust Monitoring |
W-A1 |
Yau Ma
Tei Catholic Primary School (Hoi Wang Road) |
W-A6 |
Man Cheong Building |
Noise
3.4.2.
During the site visit, one of
the original proposed noise monitoring locations Tak Cheong Building was
rejected by the president of the owner’s corporation. Alternative noise
monitoring station Hydan place had been proposed by ET and approved by IEC. 4 noise
sensitive receivers designated noise monitoring locations were identified and
agreed with IEC and EPD. The designated monitoring stations are identified and access was granted by the premises. The details of noise
monitoring stations are described in Table 3.4 and the location plan of noise
monitoring station is shown in Appendix K.
Table 3.4
Noise Monitoring Stations
Noise Monitoring Station |
Identified Noise Monitoring Station |
Type of Measurement |
W-N1A |
Yau Ma
Tei Catholic Primary School (Hoi Wang Road) |
Façade |
W-N18 |
Hydan
Place |
Façade |
W-N25A |
Prosperous
Garden Block 1 |
Façade |
W-P11 |
The
Coronation Tower 1 |
Façade |

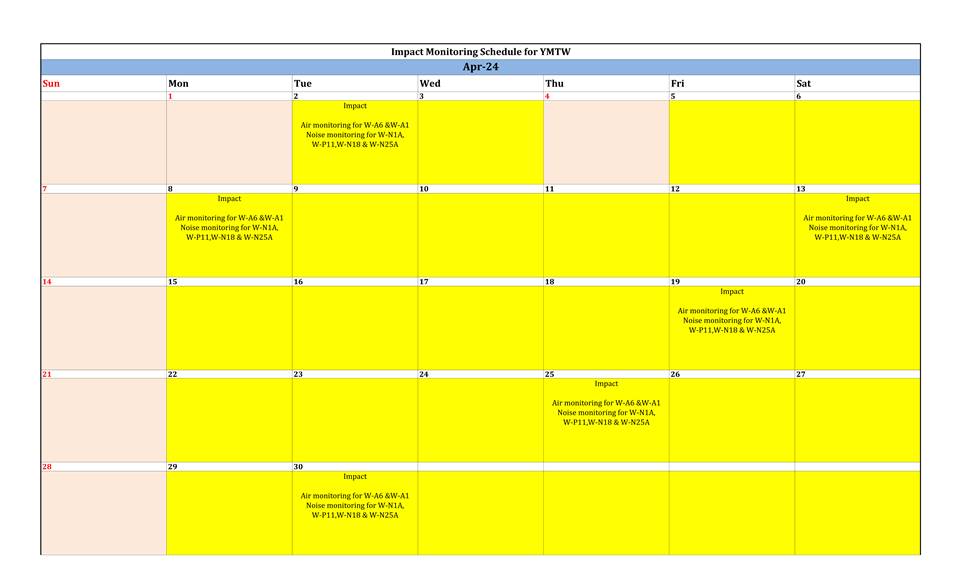

3.5. Monitoring date, time, frequency and duration
3.5.1. A summary of impact monitoring duration, sampling parameter and frequency is presented in Table 3.5.
Table 3.5 Summary of Impact
Monitoring Programme
Impact Monitoring |
Duration |
Sampling
Parameter |
Frequency |
Dust |
1-hour continuous measurement |
1-hour TSP |
3 times per six days |
Dust |
24-hour continuous sampling |
24-hour TSP |
Once per six days |
Noise |
30-minute continuous measurement |
Leq 30 min, L10 and L90 as
reference. |
Once per week
(0700-1900) |
Air Quality
3.6.1. According to our field observations, the major dust source identified at the designated air quality monitoring stations in the reporting month are summarised in Table 3.6.
Table 3.6
Observation at Dust Monitoring Stations
Monitoring Station |
Major Dust Source |
W-A1 |
Nearby traffic |
W-A6 |
Nearby traffic |

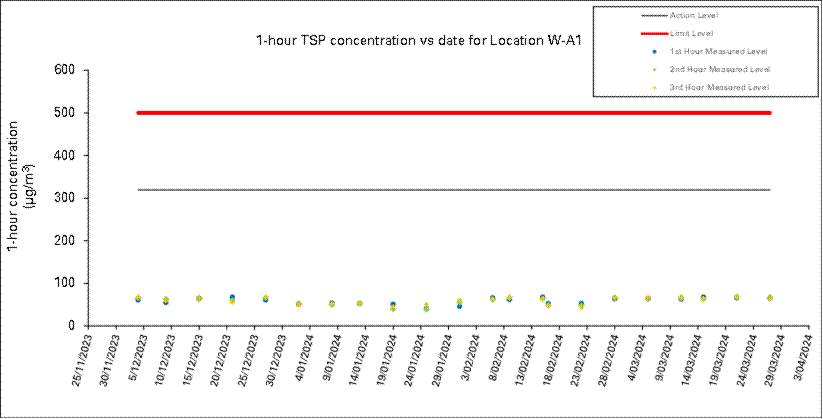

3.6.2. Air quality impact monitoring for the reporting month was carried out on 5, 11, 15, 21 and 27 March 2024.

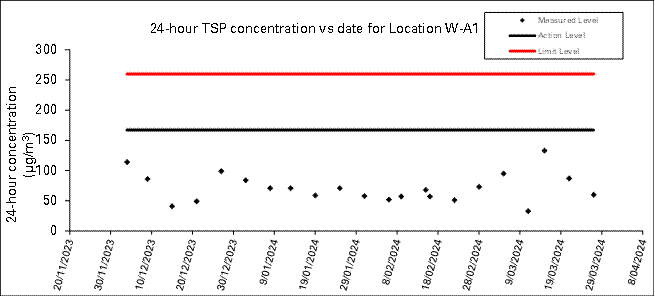

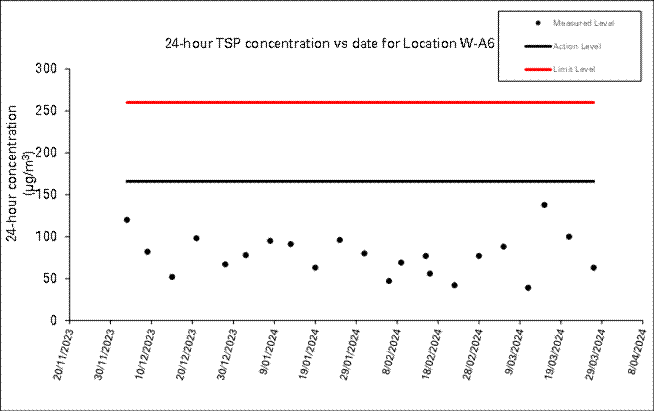

3.6.3. The results for 1-hour TSP and 24-hour TSP are summarized in Table 3.7 and Table 3.8. The measurement data and details of influencing factors such as weather conditions and site observation are presented in Appendix L.
Table 3.7 Summary of
1-hour TSP Monitoring Results
Monitoring Location |
Range(μg/m3) |
Action Level(μg/m3) |
Limit Level(μg/m3) |
W-A1 |
63 – 69 |
319 |
500 |
W-A6 |
62 – 71 |
306 |
500 |
Table 3.8 Summary
of 24-hour TSP Monitoring Results
Monitoring Location |
Range(μg/m3) |
Action Level(μg/m3) |
Limit Level(μg/m3) |
W-A1 |
33 – 133 |
167 |
260 |
W-A6 |
39 – 138 |
166 |
260 |
Noise
3.6.4. According to our field observations, the major noise source identified at the designated noise monitoring station in the reporting month are summarised in Table 3.9:
Table 3.9 Observation at Noise Monitoring Stations
Monitoring Station |
Major Noise Source |
W-N1A |
Nearby traffic |
W-N18 |
Nearby traffic |
W-N25A |
Nearby traffic |
W-P11 |
Nearby traffic |

3.6.5. The construction noise impact monitoring for the reporting month was carried out on 5, 11, 15, 21 and 27 March 2024.
Table 3.10 Summary of Noise Monitoring Results
Time
Period |
Monitoring
location |
Parameter |
Range,
dB(A) |
|
|
||
Leq |
L10 |
L90 |
Action
Level |
Limit
Level# |
|||
Normal working hour from
0700- 1900 |
W-N1A* |
Leq
30min |
63.0 – 66.8 |
68.1 – 72.8 |
60.0 – 62.6 |
When one documented complaint is received |
70dB(A) or 65 dB(A) during examination |

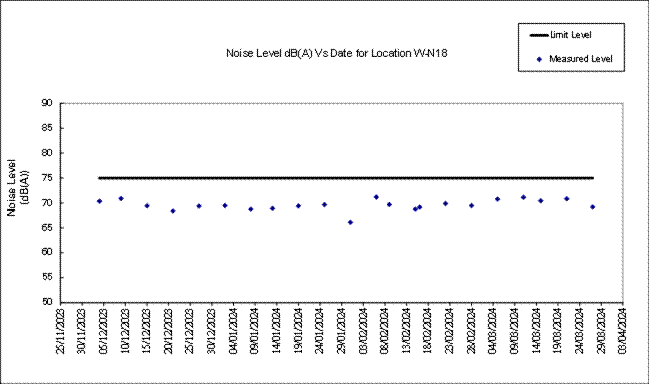

W-N18 |
69.2 – 71.2 |
72.7 – 76.4 |
64.1 – 69.0 |
75dB(A)# |
|||
W-N25A |
68.5 – 69.4 |
72.3 – 73.5 |
64.3 – 65.3 |
||||

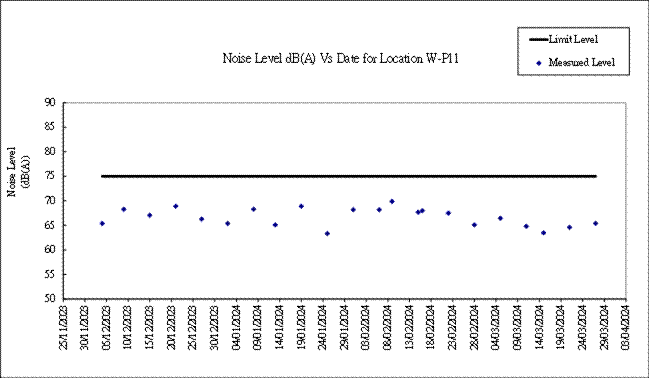

W-P11 |
63.5 – 66.5 |
68.7 – 72.7 |
59.2 – 62.5 |
Waste management
3.6.7.
The waste generated from this
Project includes inert C&D materials, and non-inert C&D materials.
Non-inert C&D materials are made up of general refuse, vegetative wastes
and recyclable wastes such as plastics and paper/cardboard packaging waste.
Steel materials generated from the project are also grouped into non-inert
C&D materials as the materials were not disposed of with other inert
C&D materials. With reference to relevant handling records and trip tickets
of this Project, the quantities of different types of waste generated in the
reporting month are summarised in Table 3.11.

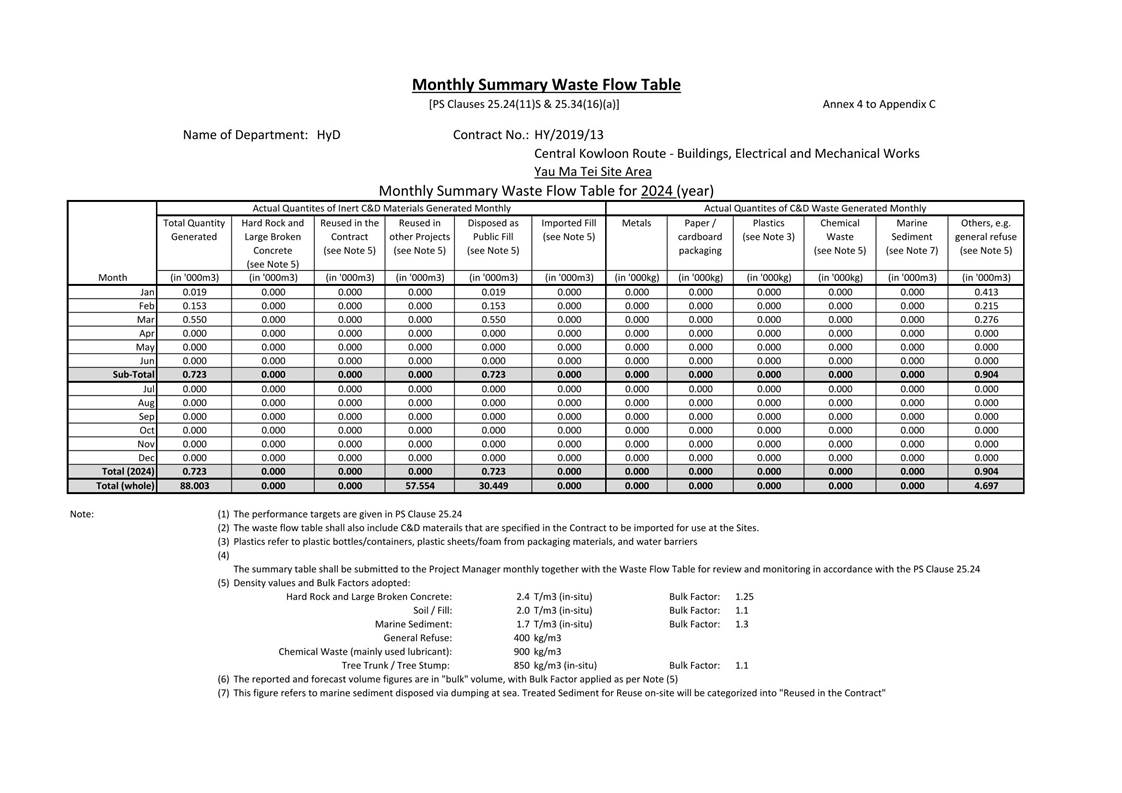

Details of cumulative waste management data are presented as a waste flow table in Appendix N.
Table 3.11 Quantities
of waste generated from the Project
Reporting period |
Quantity |
|||||
Inert C&D Materials (in ‘tonnes) |
Chemical Waste (in‘000 Kg) |
Non-inert C&D Materials |
||||
Others, e.g. General Refuse disposed at Landfill (in ‘tonnes) |
Recycled materials |
|||||
Paper/card board (in ‘000 Kg) |
Plastics (in ‘000 Kg) |
Metals (in ‘000 Kg ) |
||||
Mar 2024 |
3359.54 |
0.00 |
167.99 |
0.0063 |
0.76 |
78.31 |
4.
Summary of Complaints,
Notification of Summons and Prosecutions
4.1. The Environmental Complaint Handling Procedure is shown in below Table 4.1:
Table 4.1 Environmental
Complaint Handling Procedure
Complaint Received via Project Hotline |
Complaint Received via 1823 or from other government departments |
|||||
|
|
|
|
|||
Contractor notify ER, ET and IEC |
ER notify Contractor, ET and IEC |
|||||
|
|
|
|
|||
Contractor log complaint and date of receipt onto the complaint database. Contractor, ER and ET to conduct investigation of complaint |
||||||
|
|
|
|
|||
If complaint is considered not valid |
If complaint is found valid |
|||||
|
|
|
|
|||
ET or ER to reply the complainant if necessary |
Contractor to identify and implement remedial measures in consultation with the IEC, ET and ER. |
|||||
|
|
|
|
|||
|
|
The ER, ET and IEC to review the effectiveness of the Contractor’s remedial measures and the updated situation; ET to undertake additional monitoring and audit to verify the situation if necessary, and oversee that circumstances leading to the complaint do not recur. ER to conduct further inspection as necessary. |
||||
|
|
|
|
|||
If the complaint is referred by the EPD, the Contractor to prepare interim report on the status of the complaint investigation and follow-up actions stipulated above, including the details of the remedial measures and additional monitoring identified or already taken, for submission to EPD within the time frame assigned by the EPD |
||||||
|
|
|
||||
The ET to record the details of the complaint, results of
the investigation, subsequent actions taken to address the complaint and
updated situation including the effectiveness of the remedial measures,
supported by regular and additional monitoring results in the monthly
EM&A reports |
||||||
4.2.
Should non-compliance of the
criteria occur, action in accordance with the Event and Action Plan in Appendix
D and Appendix E shall be carried out.
4.3. No exceedance of Action and Limit Level of construction noise, 24 hour TSP and 1 hour TSP was recorded in the reporting month.
4.4. No non-compliance was reported in the reporting month.
4.5. Statistics on complaints, notifications of summons and successful prosecutions are summarized in Appendix O.
5.1. Site inspections were carried out on a weekly basis to monitor the implementation of proper environmental pollution control and mitigation measures under the Contract. In the reporting period, four (4) site inspections were carried out on 7, 14, 21 and 28 March 2024, along with bi-weekly inspection of the implementation of landscape and visual mitigation measures conducted on 7 and 21 March 2024.
5.2. A joint site inspection with IEC were undertaken on 21 March 2024. Minor deficiency was observed during weekly site inspection. Key observations during the site inspections are summarized in Table 5.1.
Table 5.1 Site
Observations
Date |
Environmental
Observations |
Follow-up
Status |
7 March 2024 |
1.
Soil stockpile
should be covered with impervious sheeting at Lin Cheung Road Noise Barrier. 2.
Housekeeping to
be done at Landscaping Deck rest shelter & Gate 2. |
1.
Stockpile had
been covered 2.
Housekeeping
had been arranged. |
14 March 2024 |
1.
Additional
watering to be applied at Depressed Road. |
1.
Additional
watering had been applied. |
21 March 2024 |
1.
Dusty materials
to be covered with impervious sheeting at Segment 3. 2.
Oil stain on
ground to be cleaned at Portion 17 near wheel washing facility. |
1.
Dusty materials
had been covered. 2.
Oil stain had
been removed. |
28 March 2024 |
1.
Drip tray to be
provided under chemical containers under Bridge G and at electrical room. |
1.
Drip tray had
been provided. |
5.3. The Contractor had rectified all observation identified during environmental site inspections in the reporting period.
5.4. According to the EIA Study Report, Environmental Permit, contract documents and EM&A Manual, the mitigation measures detailed in the documents are implemented as much as practical during the reporting period. An updated Implementation Status of Environmental Mitigation Measures (EMIS) is provided in Appendix F.
6. Future Key Issues
6.1. Work to be undertaken in the next reporting month are:
·
Remaining Socket H-Pile at
Segments 5 (to complete) at Portion 1D ·
Along Lin Cheung Road –
remaining road works at Portion 1E ·
Noise Barrier C02 Road Works
in progress at Portion 1E ·
Slip Road A excavation,
backfilling, footing & wall construction for NB-C06 & V09 at Portion 1E ·
Parapet Wall at Bridge B, B2,
C, C2, D, E & F at Portion 1B, 1G ·
Remaining FSW-3 Footing &
Upstand Wall at Portion 1 ·
Road D Structure I
Construction at Portion 1E ·
Backfilling at Vent. Adit Ch 175~240 at Zone 4C at Portion 1E ·
Remaining Foundation and
Abutment Wall AW05 at Recovery Area in Portion 1B ·
Road Widening Works at Slip
Road E & F in Portion 1A & 1B ·
Slip Road E & F Road
Works and Sign Gantry Installation in Portion 1A & 1B ·
Backfilling at Subway
Staircase South in Portion 1B ·
Remaining Upstand Wall and
Column Construction at Segments 1 to 3 in Portion 1B & 1D ·
Fire Separation Wall FSW-4
and FSW-5 at Elevated Road at Segment 7 in Portion 1D ·
Reinforced Concrete works for
Escape Route Staircase No. 4 in Portion 1F ·
Roadworks at Segment 3, 4, 7,
10, 11 & 12A in Portion 1B & 1F ·
Landscaped Deck Construction
at Segment 12b (OHVA & Landscaped Deck) in Portion 1F ·
Reinforced Concrete works for
Escape Route Staircase No. 1 to 2 at Portion 1F and 10 ·
Pile Cap construction at
Segment 5 (West side) in Portion 1D ·
Sheet Piling works prior to
Pile Cap construction at Segments 8 & 9 and Washout Chamber in Portion 1D ·
Construction at HWR Plant
Room Building in Portion 1D |
6.2. Potential environmental impacts arising from the above construction activities are mainly associated with dust, construction noise and waste management.
6.3. The tentative schedule of regular construction noise monitoring, 1-hour TSP and 24-hour TSP monitoring in the next reporting period is presented in Appendix P.
7. Conclusion and Recommendations
7.1. This 62nd monthly EM&A Report presents the EM&A works undertaken during the period from 1 March 2024 to 31 March 2024 in accordance with the EM&A Manual and the requirement under EP- 457/2013/D.
7.2. Air quality (including 1-hour TSP and 24-hour TSP) and noise impact monitoring were carried out in the reporting period.
7.3. Weekly environmental site inspections were conducted during the reporting period. A joint site inspection with IEC were carried out on 21 March 2024. Minor deficiency was observed during site inspection and was rectified within the specified deadlines. The environmental performance of the Project was therefore considered satisfactory.
7.4. No exceedance of Action and Limit Level of construction noise, 24 hour TSP and 1 hour TSP was recorded in the reporting month.
7.5. No non-compliance was reported in the reporting month.
7.6. The ET will keep track on the construction works to confirm compliance of environmental requirements and the proper implementation of all necessary mitigation measures.
Appendix A
Alignment
and Works Area For the Contract No. HY/2014/20
Appendix B
Construction Programme
Appendix C
Project Organization Chart
Appendix D
Dust Event-Action Plan (EAP)
EVENT |
ACTION |
|||
ET |
IEC |
ER |
CONTRACTOR |
|
ACTION LEVEL |
||||
1.Exceedance for one sample |
1. Identify source, investigate
the causes of exceedance and propose remedial measures; 2. Inform IEC and ER; 3. Repeat measurement to confirm finding; 4. Increase monitoring frequency
to daily. |
1. Check monitoring data submitted
by ET; 2. Check Contractor’s working
method. |
1. Notify Contractor. |
1. Rectify any unacceptable practice; 2. Amend working methods if
appropriate. |
2.Exceedance for two or more
consecutive samples |
1. Identify source; 2. Inform IEC and ER; 3. Advise the ER on the
effectiveness of the proposed remedial measures; 4. Repeat measurements to confirm findings; 5. Increase monitoring frequency
to daily; 6. Discuss with IEC and Contractor
on remedial actions required; 7. If exceedance continues,
arrange meeting with IEC and ER; 8. If exceedance stops, cease
additional monitoring. |
1. Check monitoring data submitted
by ET; 2. Check Contractor’s working method; 3. Discuss with ET and Contractor
on possible remedial measures; 4. Advise the ET on the
effectiveness of the proposed remedial measures; 5. Supervise Implementation of
remedial measures. |
1. Confirm receipt of notification
of failure in writing; 2. Notify Contractor; 3. Ensure remedial measures
properly implemented. |
1. Submit proposals for remedial
to ER within 3 working days of notification; 2. Implement the agreed proposals; 3. Amend proposal if appropriate. |
LIMIT LEVEL |
||||
1.Exceedance for one sample |
1. Identify source, investigate
the causes of exceedance and propose remedial measures; 2. Inform ER, Contractor and EPD; 3. Repeat measurement to confirm finding; 4. Increase monitoring frequency
to daily; 5. Assess effectiveness of
Contractor’s remedial actions and keep IEC, EPD and ER informed of the
results. |
1. Check monitoring data submitted
by ET; 2. Check Contractor’s working method; 3. Discuss with ET and Contractor
on possible remedial measures; 4. Advise the ER on the
effectiveness of the proposed remedial measures; 5. Supervise implementation of
remedial measures. |
1. Confirm receipt of notification
of failure in writing; 2. Notify Contractor; 3. Ensure remedial measures
properly implemented. |
1. Take immediate action to avoid
further exceedance; 2. Submit proposals for remedial
actions to IEC within 3 working days of notification; 3. Implement the agreed proposals; 4. Amend proposal if appropriate. |
2.Exceedance for two or more
consecutive samples |
1. Notify IEC, ER, Contractor and EPD; 2. Identify source; 3. Repeat measurement to confirm findings; 4. Increase monitoring frequency
to daily; 5. Carry out analysis of
Contractor’s working procedures to determine possible mitigation to be implemented; 6. Arrange meeting with IEC and ER
to discuss the remedial actions to be taken; 7. Assess effectiveness of
Contractor’s remedial actions and keep IEC, EPD and ER informed of the results; 8. If exceedance stops, cease
additional monitoring. |
1. Discuss amongst ER, ET, and
Contractor on the potential remedial actions; 2. Review Contractor’s remedial
actions whenever necessary to assure their effectiveness and advise the ER accordingly; 3. Supervise the implementation of
remedial measures. |
1. Confirm receipt of notification
of failure in writing; 2. Notify Contractor; 3. In consultation with the IEC,
agree with the Contractor on the remedial measures to be implemented; 4. Ensure remedial measures
properly implemented; 5. If exceedance continues,
consider what portion of the work is responsible and instruct the Contractor
to stop that portion of work until the exceedance is abated. |
1. Take immediate action to avoid
further exceedance; 2. Submit proposals for remedial
actions to IEC within 3 working days of notification; 3. Implement the agreed proposals; 4. Resubmit proposals if problem
still not under control; 5. Stop the relevant portion of
works as determined by the ER until the exceedance is abated. |
Note:
ET – Environmental Team ER – Engineer’s Representative
IEC – Independent Environmental Checker
Appendix E
Noise Event-Action Plan (EAP)
EVENT |
ACTION |
|||
ET |
IEC |
ER |
CONTRACTOR |
|
Action Level |
1. Identify source, investigate the causes of
exceedance and propose remedial measures; 2. Notify IEC and Contractor; 3. Report the results of investigation to the IEC,
ER and Contractor; 4. Discuss with the Contractor and formulate
remedial measures; 5. Increase monitoring frequency to check mitigation
effectiveness. |
1.Review the analysed results submitted by the ET; 2. Review the proposed remedial measures by the
Contractor and advise the ER accordingly; 3. Supervise the implementation of remedial
measures. |
1. Confirm
receipt of notification of failure in writing; 2. Notify Contractor; 3. Require
Contractor to propose remedial measures for the analysed noise problem; 4. Ensure
remedial measures are properly implemented |
1. Submit noise mitigation proposals to IEC; 2. Implement noise mitigation proposals. |
Limit Level |
1. Identify source; 2. Inform IEC, ER, EPD and Contractor; 3. Repeat measurements to confirm findings; 4. Increase monitoring frequency; 5. Carry out analysis of Contractor’s working
procedures to determine possible mitigation to be implemented; 6. Inform IEC, ER and EPD the causes and actions
taken for the exceedances; 7. Assess effectiveness of Contractor’s remedial
actions and keep IEC, EPD and ER informed of the results; 8. If exceedance stops, cease additional monitoring. |
1. Discuss amongst ER, ET, and Contractor on the
potential remedial actions; 2. Review Contractors remedial actions whenever
necessary to assure their effectiveness and advise the ER accordingly; 3. Supervise the implementation of remedial
measures. |
1.Confirm receipt of notification of failure in writing; 2. Notify Contractor; 3. Require Contractor to propose remedial measures
for the analysed noise problem; 4. Ensure remedial measures properly implemented; 5. If exceedance continues, consider what portion of
the work is responsible and instruct the Contractor to stop that portion of
work until the exceedance is abated. |
1. Take immediate action to avoid
further exceedance; 2. Submit proposals for remedial
actions to IEC
within 3 working days of notification; 3. Implement the agreed proposals; 4. Resubmit proposals if problem
still not under control; 5. Stop the relevant portion of
works as determined by the ER until the exceedance is abated. |
Note:
ET – Environmental Team
IEC – Independent Environmental Checker
ER – Engineer’s Representative
Appendix F
Environmental
Mitigation Implementation Schedule (EMIS)
Environmental
Mitigation Implementation Schedule Contract No.
HY/2014/20 (Yau Ma Tei West) |
|
||||||||
|
|||||||||
EIA Ref. |
EM&A Log Ref. |
Recommended Mitigation Measures |
Objectives of the Recommended
Measures & Main Concerns to address |
Implementation Agent |
Location / Timing |
Implementation Stage |
Requirements and/ or standards to be
achieved |
Implementation Status |
|

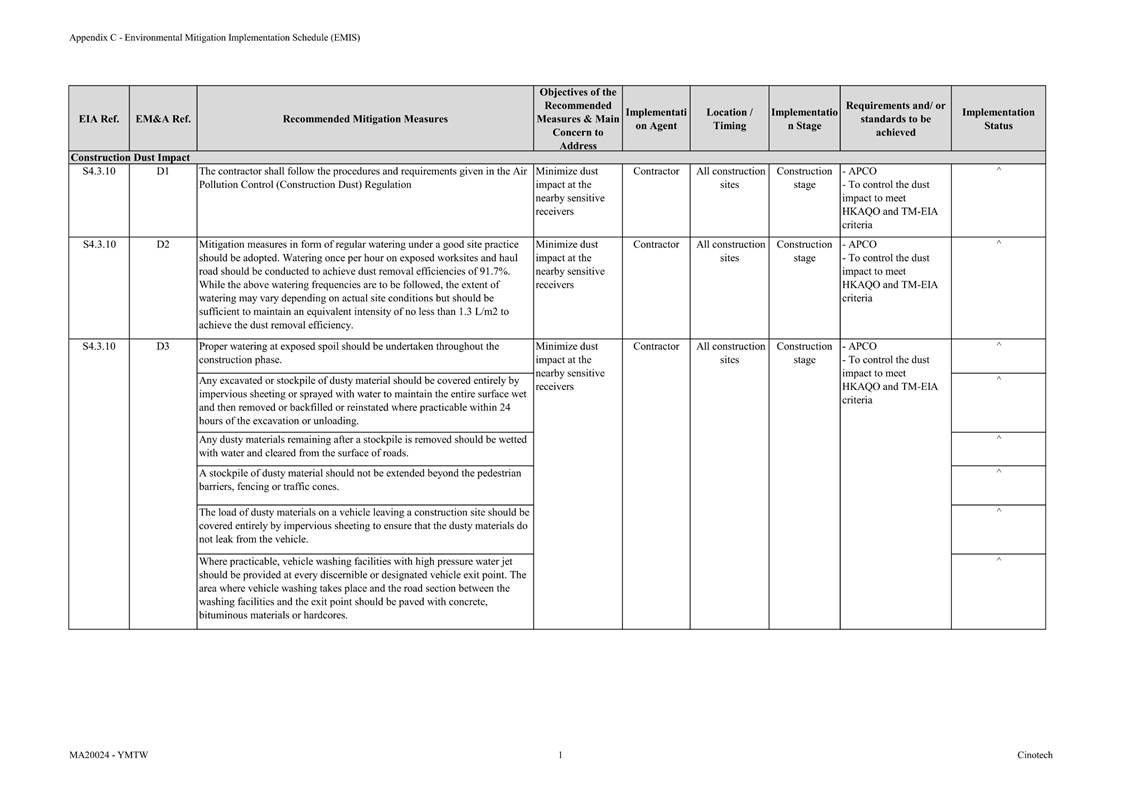

Construction Dust Impact |
|
||||||||
S4.3.10 |
D1 |
The contractor shall follow the
procedures and requirements given in the Air Pollution Control (Construction
Dust) Regulation |
Minimize dust impact at the nearby
sensitive receivers |
Contractor |
All
construction sites |
Construction
stage |
·
APCO ·
To control the dust impact To meet HKAQO and TM-EIA criteria |
·
Implemented |
|
S4.3.10 |
D2 |
·
Mitigation measures in form of
regular watering under a good site practice should be adopted. Watering once per hour on exposed worksites
and haul road should be conducted to achieve dust removal efficiencies of 91.7%. While the above watering frequencies are to
be followed, the extent of watering may vary depending on actual site
conditions but should be sufficient to maintain an equivalent intensity of no
less than 1.3 L/m2 to achieve the dust removal efficiency. |
Minimize dust impact at the nearby
sensitive receivers |
Contractor |
All
construction sites |
Construction
stage |
·
APCO ·
To control the dust impact To meet HKAQO and TM-EIA criteria |
·
Implemented deficiency rectified
after observation |
|
S4.3.10 |
D3 |
·Proper
watering at exposed spoil should be undertaken throughout the construction
phase; ·Any
excavated or stockpile of dusty material should be covered entirely by
impervious sheeting or sprayed with water to maintain the entire surface wet
and then removed or backfilled or reinstated where practicable within 24
hours of the excavation or unloading; ·Any
dusty materials remaining after a stockpile is removed should be wetted with
water and cleared from the surface of roads; ·A
stockpile of dusty material should not be extended beyond the pedestrian
barriers, fencing or traffic cones; ·The
load of dusty materials on a vehicle leaving a construction site should be
covered entirely by impervious sheeting to ensure that the dusty materials do
not leak from the vehicle. ·Where
practicable, vehicle washing facilities with high pressure water jet should
be provided at every discernible or designated vehicle exit point. The area where vehicle washing takes place
and the road section between the washing facilities and the exit point should

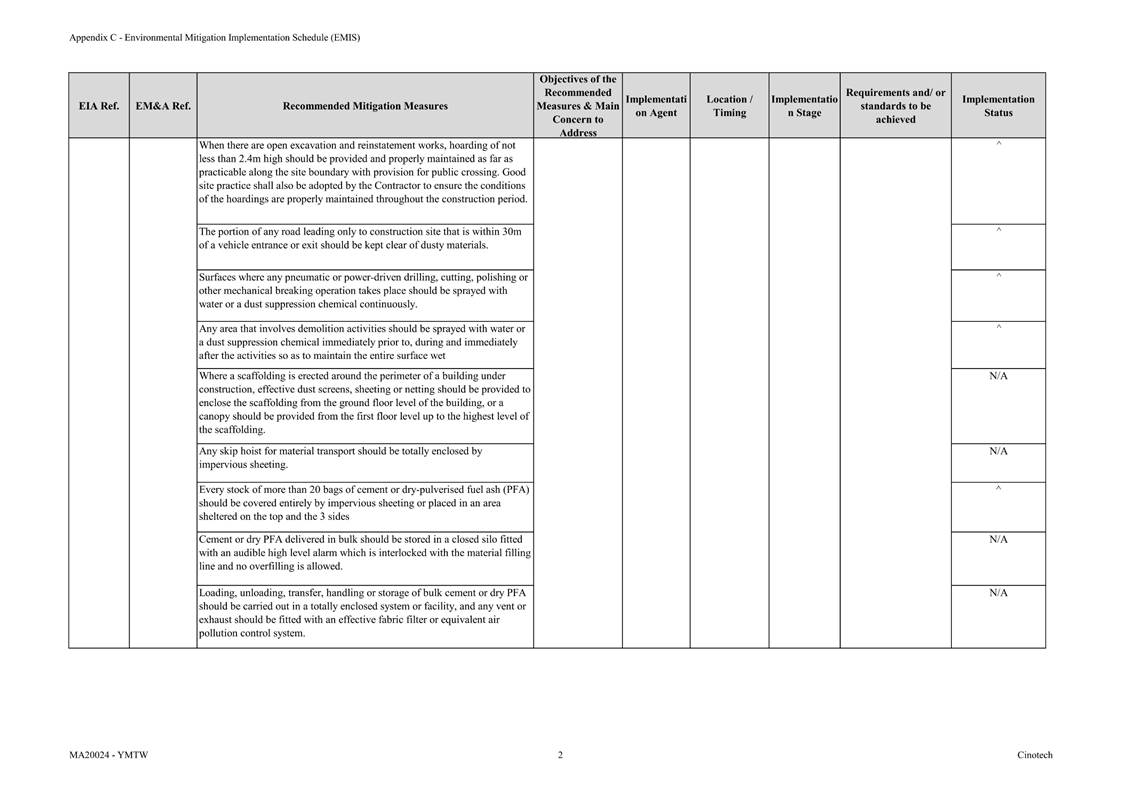

be paved with concrete, bituminous materials or hardcores; ·When
there are open excavation and reinstatement works, hoarding of not less than
2.4m high should be provided and properly maintained as far as practicable
along the site boundary with provision for public crossing. Good site practice shall also be adopted by
the Contractor to ensure the conditions of the hoardings are properly
maintained throughout the construction period; ·The
portion of any road leading only to construction site that is within 30m of a
vehicle entrance or exit should be kept clear of dusty materials; ·Surfaces
where any pneumatic or power-driven drilling, cutting, polishing or other
mechanical breaking operation takes place should be sprayed with water or a
dust suppression chemical continuously; ·Any
area that involves demolition activities should be sprayed with water or a
dust suppression chemical immediately prior to, during and immediately after
the activities so as to maintain the entire surface wet;
·
Any skip hoist for material transport
should be totally enclosed by impervious sheeting; ·
Every stock of more than 20 bags of
cement or dry-pulverised fuel ash (PFA) should be
covered entirely by impervious sheeting or placed in an area sheltered on the
top and the 3 sides; ·
Loading, unloading, transfer,
handling or storage of bulk cement or dry PFA should be carried out in a
totally enclosed system or facility, and any vent or exhaust should be fitted
with an effective fabric filter or equivalent air pollution control system ·
Exposed earth should be properly
treated by compaction, turfing, hydroseeding, vegetation planting or sealing
with latex, vinyl, bitumen, shotcrete or other suitable surface stabilizer
within six months after the last construction activity on the construction
site or part of the construction site where the exposed earth lies. |
Minimize dust impact at the nearby
sensitive receivers |
Contractor |
All
construction sites |
Construction
stage |
·
APCO ·
To control the dust impact To meet HKAQO and TM-EIA criteria |
·
Implemented, deficiency rectified
after observation |
|
S4.3.10 |
D6 |
Implement regular dust monitoring
under EM&A programme during the construction stage. |
Monitoring
of dust impact |
Contractor |
Selected
rep. dust monitoring station |
Construction
stage |
·
TM-EIA |
·
Implemented |
|

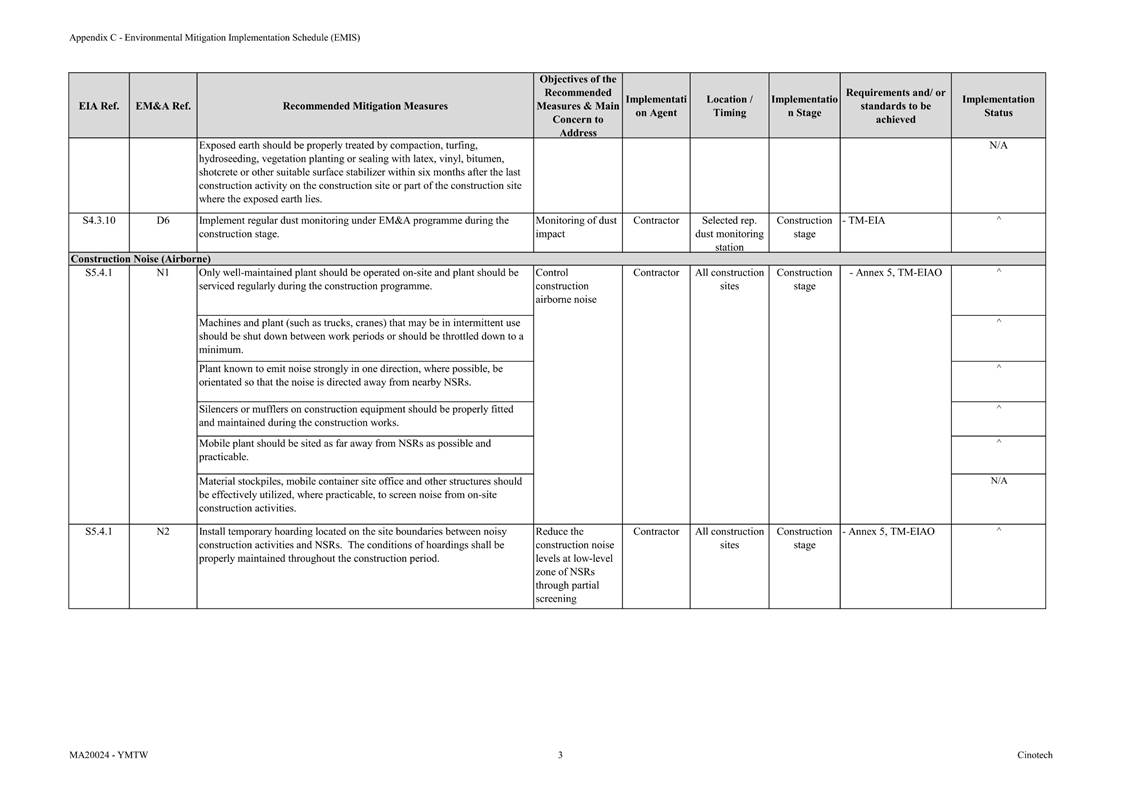

Construction Noise (Airborne) |
|
||||||||
S5.4.1 |
N1 |
Implement the following good site practices: ·
Only well-maintained plant should be
operated on-site and plant should be serviced
regularly during the construction programme; ·
Machines and plant (such as trucks,
cranes) that may be in intermittent use should be shut down between work
periods or should be throttled down to a minimum; ·
Plant known to emit noise strongly in
one direction, where possible, be orientated so that the noise is directed
away from nearby NSRs; ·
Silencers or mufflers on construction
equipment should be properly fitted and maintained during the construction works; ·
Mobile plant should be sited as far
away from NSRs as possible and practicable; ·
Material stockpiles, mobile container
site office and other structures should be effectively utilized, where
practicable, to screen noise from on-site construction activities. |
Control construction airborne noise |
Contractor |
All
construction sites |
Construction
stage |
·
Annex 5, TM-EIAO |
·
Implemented deficiency rectified
after reminder |
|
S5.4.1 |
N2 |
Install temporary hoarding located on
the site boundaries between noisy construction activities and NSRs. The conditions of hoardings shall be
properly maintained throughout the construction period. |
Reduce the construction noise levels
at low-level zone of NSRs through partial screening |
Contractor |
All
construction sites |
Construction
stage |
·
Annex 5, TM-EIAO |
·
Implemented |
|

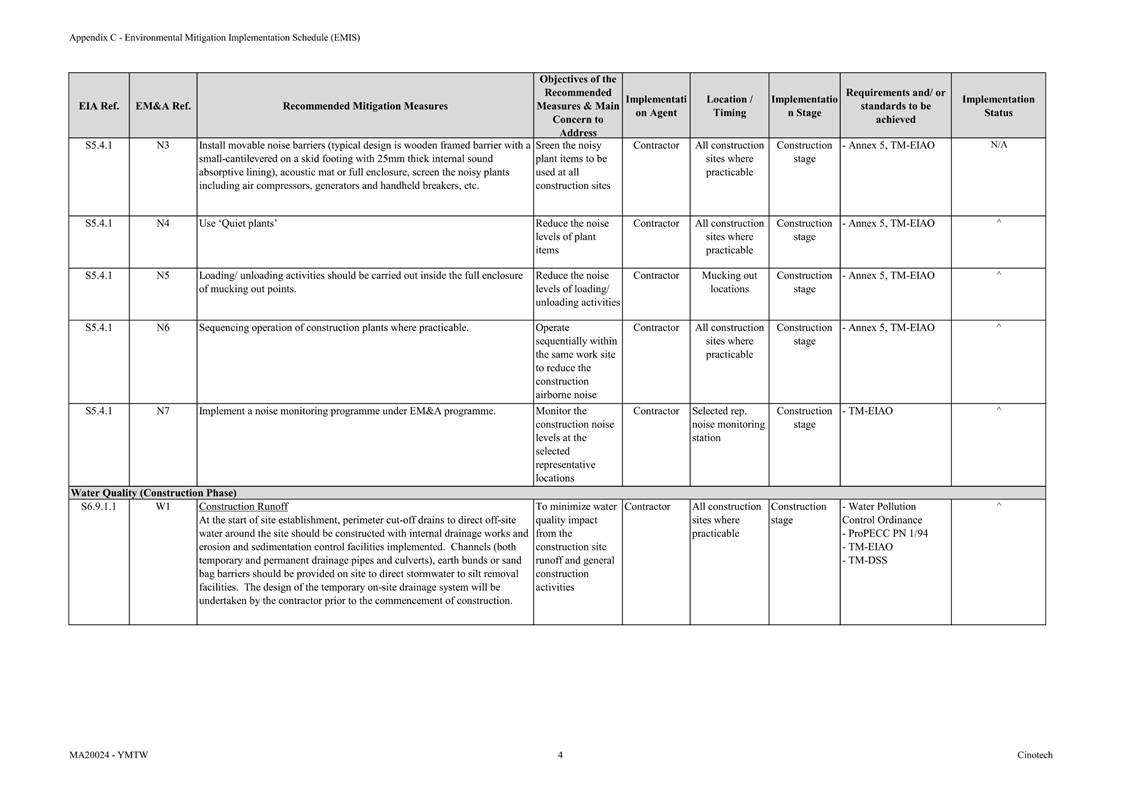

S5.4.1 |
N3 |
Install movable noise barriers
(typical design is wooden framed barrier with a small-cantilevered on a skid
footing with 25mm thick internal sound absorptive lining), acoustic mat or
full enclosure, screen the noisy plants including air compressors, generators
and handheld breakers, etc. |
Sreen the noisy plant items to be used at all
construction sites |
Contractor |
All
construction sites where practicable |
Construction
stage |
·
Annex 5, TM-EIAO |
·
Implemented |
|
S5.4.1 |
N4 |
Use ‘Quiet plant’ |
Reduce the noise levels of plant
items |
Contractor |
All
construction sites where practicable |
Construction
stage |
·
Annex 5, TM-EIAO |
·
Implemented |
|
S5.4.1 |
N5 |
Loading/ unloading activities should
be carried out inside the full enclosure of mucking out points. |
Reduce the noise levels of loading/
unloading activities |
Contractor |
Mucking
out locations |
Construction
stage |
·
Annex 5, TM-EIAO |
·
Implemented |
|
S5.4.1 |
N6 |
Sequencing operation of construction
plants where practicable. |
Operate sequentially within the same
work site to reduce the construction airborne noise |
Contractor |
All
construction sites where practicable |
Construction
stage |
·
Annex 5, TM-EIAO |
·
Implemented |
|
S5.4.1 |
N7 |
Implement a noise monitoring
programme under EM&A programme. |
Monitor the construction noise levels
at the selected representative locations |
Contractor |
Selected
rep. noise monitoring station |
Construction
stage |
·
TM-EIAO |
·
Implemented |
|
Water Quality (Construction Phase) |
|
||||||||
S6.9.1.1 |
W1 |
In
accordance with the Practice Note for Professional Persons on Construction
Site Drainage, Environmental Protection Department, 1994 (ProPECC PN1/94),

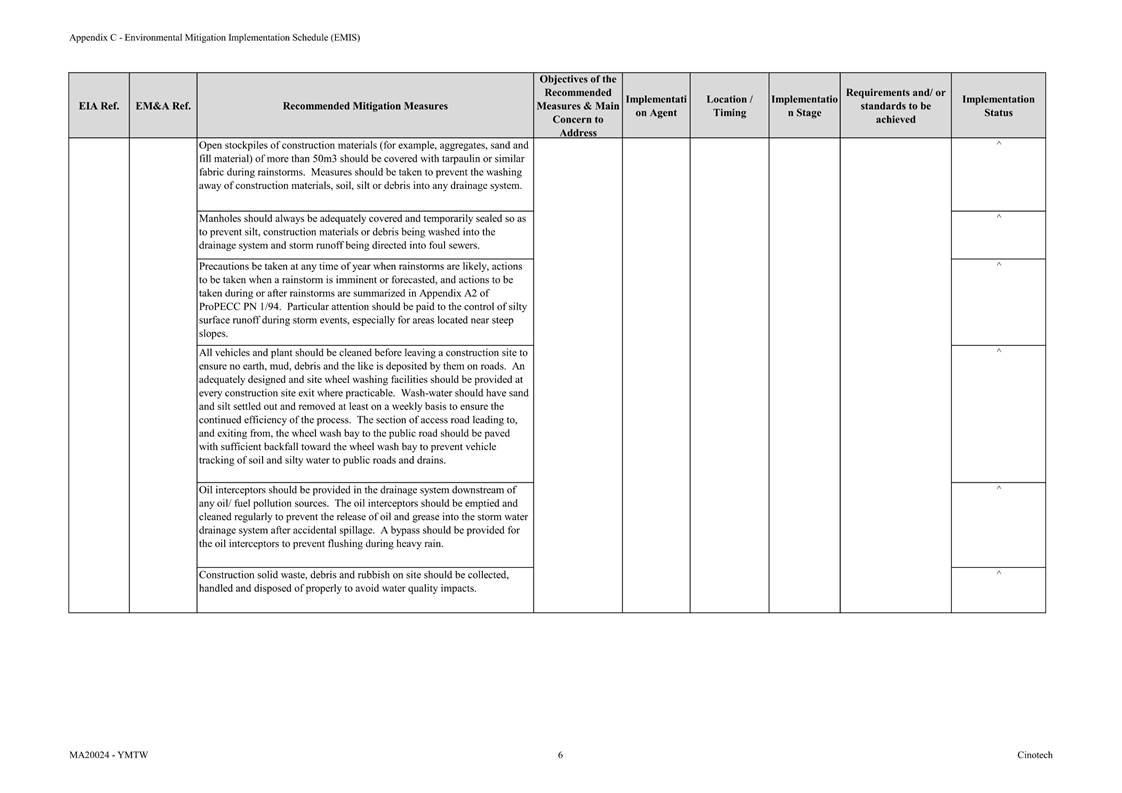

construction phase mitigation measures shall include the following: Construction
Runoff ·
At the start of site establishment,
perimeter cut-off drains to direct off-site water around the site should be
constructed with internal drainage works and erosion and sedimentation
control facilities implemented.
Channels (both temporary and permanent drainage pipes and culverts),
earth bunds or sand bag barriers should be provided
on site to direct stormwater to silt removal facilities. The design of the temporary on-site
drainage system will be undertaken by the contractor prior to the
commencement of construction; ·
The dikes or embankments for flood
protection should be implemented around the boundaries of earthwork
areas. Temporary ditches should be
provided to facilitate the runoff discharge into an appropriate watercourse, through
a silt/ sediment trap. The sediment/
silt traps should be incorporated in the permanent drainage channels to
enhance deposition rates; ·
The design of efficient silt removal
facilities should be based on the guidelines in Appendix A1 of ProPECC PN
1/94, which states that the retention time for silt/ sand traps should be 5
minutes under maximum flow conditions.
Sizes may vary depending upon the flow rate, but for a flow rate of
0.1 m3/s a sedimentation basin of 30 m3 would be
required and for a flow rate of 0.5 m3/s the basin would be 150 m3. The detailed design of the sand/ silt traps
shall be undertaken by the contractor prior to the commencement of construction; ·
All exposed earth areas should be
completed and vegetated as soon as possible after earthworks have been
completed, or alternatively, within 14 days of the cessation of earthworks
where practicable. Exposed slope surfaces
should be covered by tarpaulin or other means; ·
The overall slope of the site should
be kept to a minimum to reduce the erosive potential of surface water flows,
and all traffic areas and access roads protected by coarse stone
ballast. An additional advantage accruing
from the use of crushed stone is the positive traction gained during
prolonged periods of inclement weather and the reduction of surface sheet flows; ·
All drainage facilities and erosion
and sediment control structures should be regularly inspected and maintained
to ensure proper and efficient operation at all times and particularly
following rainstorms. Deposited silt
and grit should be removed regularly and disposed of by spreading evenly over
stable, vegetated areas; ·
Measures should be taken to minimize
the ingress of site drainage into excavations. If the excavation of trenches in wet
periods is necessary, they should be dug and backfilled in short sections
wherever practicable. Water pumped out
from trenches or foundation excavations should be discharged into storm
drains via silt removal facilities; ·
Open stockpiles of construction
materials (for example, aggregates, sand and fill material) of more than 50m3
should be covered with tarpaulin or similar fabric during rainstorms. Measures should be taken to prevent the
washing away of construction materials, soil, silt or debris into any
drainage system; ·
Manholes should always be adequately
covered and temporarily sealed so as to prevent silt, construction materials
or debris being washed into the drainage system and storm runoff being
directed into foul sewers; ·
Precautions be taken at any time of
year when rainstorms are likely, actions to be taken when a rainstorm is
imminent or forecasted, and actions to be taken during or after rainstorms
are summarized in Appendix A2 of ProPECC PN 1/94. Particular attention should be paid to the
control of silty surface runoff during storm events, especially for areas
located near steep slopes; ·
All vehicles and plant should be
cleaned before leaving a construction site to ensure no earth, mud, debris
and the like is deposited by them on roads.
An adequately designed and site wheel washing facilities should be
provided at every construction site exit where practicable. Wash-water should have sand and silt
settled out and removed at least on a weekly basis to ensure the continued
efficiency of the process. The section
of access road leading to, and exiting from, the wheel wash bay to the public
road should be paved with sufficient backfall toward the wheel wash bay to
prevent vehicle tracking of soil and silty water to public roads and drains; ·
Oil interceptors should be provided
in the drainage system downstream of any oil/ fuel pollution sources. The oil interceptors should be emptied and
cleaned regularly to prevent the release of oil and grease into the storm
water drainage system after accidental spillage. A bypass should be provided for the oil
interceptors to prevent flushing during heavy rain; ·
Construction solid waste, debris and
rubbish on site should be collected, handled and disposed of properly to
avoid water quality impacts; ·

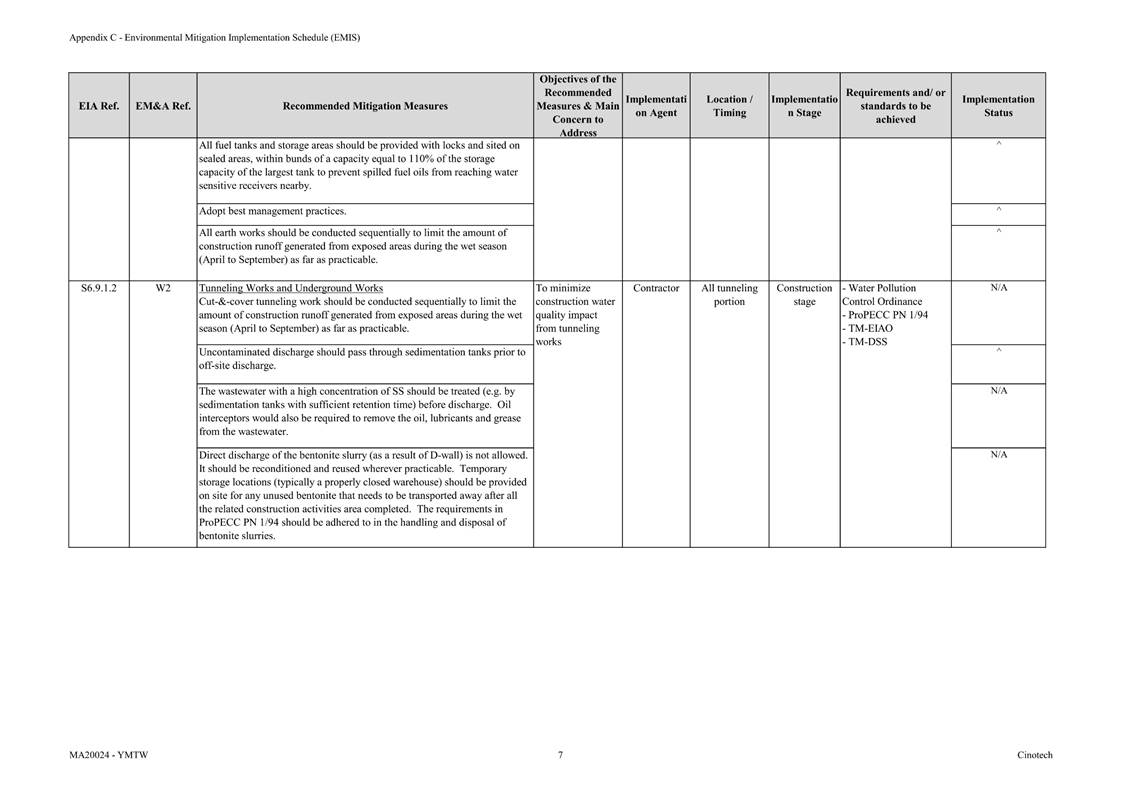

All fuel tanks and storage areas
should be provided with locks and sited on sealed areas, within bunds of a
capacity equal to 110% of the storage capacity of the largest tank to prevent
spilled fuel oils from reaching water sensitive receivers nearby; ·
Adopt best management practices; ·
All earth works should be conducted
sequentially to limit the amount of construction runoff generated from
exposed areas during the wet season (April to December) as far as
practicable. |
To minimize water quality impact from
the construction site runoff and general construction activities |
Contractor |
All
construction sites where practicable |
Construction
stage |
·
Water Pollution Control Ordinance ·
ProPECC PN 1/94 ·
TM-EIAO ·
TM-DSS |
·
Implemented |
|
S6.9.1.2 |
W2 |
Tunneling
Works and Underground Works ·
Cut-&-cover tunneling
work should be conducted sequentially to limit the amount of construction
runoff generated from exposed areas during the wet season (April to December)
as far as practicable. ·
Uncontaminated discharge should pass
through sedimentation tanks prior to off-site discharge; ·
The wastewater with a high
concentration of SS should be treated (e.g. by sedimentation tanks with
sufficient retention time) before discharge.
Oil interceptors would also be required to remove the oil, lubricants
and grease from the wastewater; ·
Direct discharge of the bentonite
slurry (as a result of D-wall) is not allowed. It should be reconditioned and reused
wherever practicable. Temporary
storage locations (typically a properly closed warehouse) should be provided
on site for any unused bentonite that needs to be transported away after all
the related construction activities area completed. The requirements in ProPECC PN 1/94 should
be adhered to in the handling and disposal of bentonite slurries. |
To minimize construction water
quality impact from tunneling works |
Contractor |
All
tunneling portion |
Construction
stage |
·
Water Pollution Control Ordinance ·
ProPECC PN 1/94 ·
TM-DSS ·
TM-EIAO |
·
N/A |
|
S6.9.1.3 |

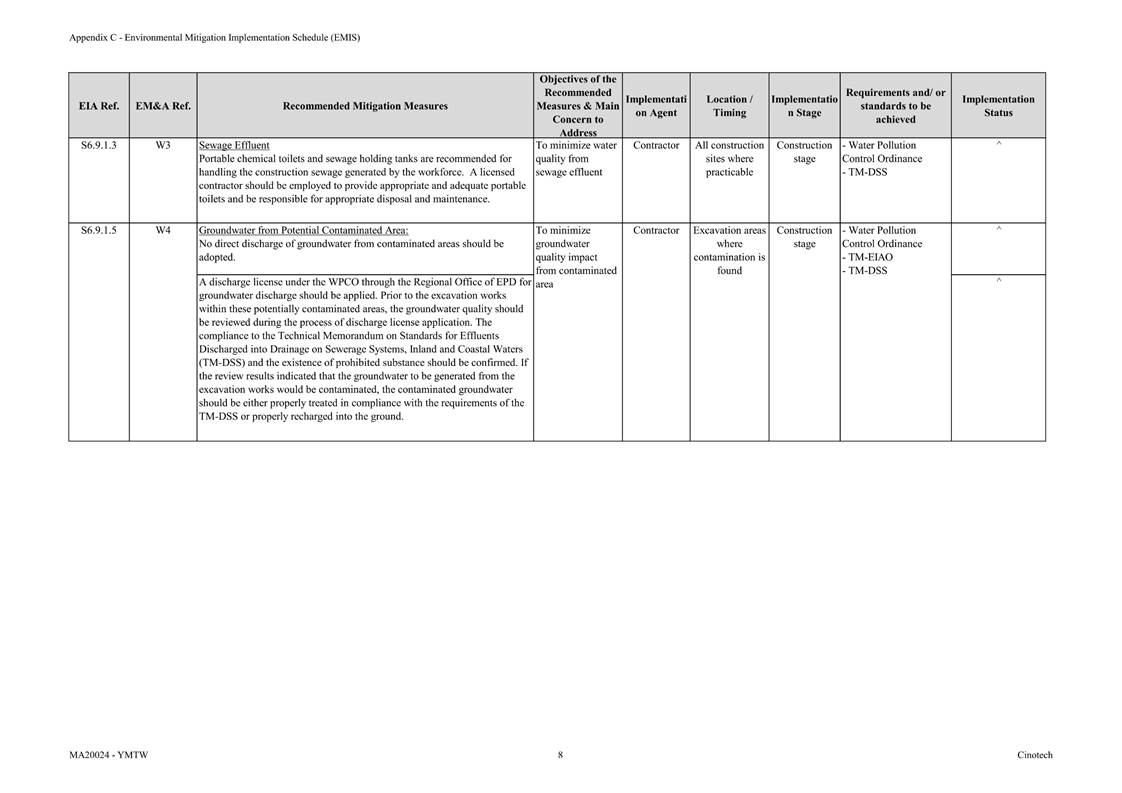

W3 |
Sewage
Effluent ·
Portable chemical toilets and sewage
holding tanks are recommended for handling the construction sewage generated
by the workforce. A licensed
contractor should be employed to provide appropriate and adequate portable
toilets and be responsible for appropriate disposal and maintenance. |
To minimize water quality from sewage
effluent |
Contractor |
All
construction sites where practicable |
Construction
stage |
·
Water Pollution Control Ordinance ·
TM-DSS |
·
Implemented |
|
S6.9.1.5 |
W4 |
Groundwater
from Potential Contaminated Area: · No direct discharge of groundwater from
contaminated areas should be adopted. ·
A discharge license under the WPCO
through the Regional Office of EPD for groundwater discharge should be
applied. Prior to the excavation works within these potentially
contaminated areas, the groundwater quality should be reviewed
during the process of discharge license application. The
compliance to the Technical Memorandum on Standards for Effluents
Discharged into Drainage on Sewerage Systems, Inland and
Coastal Waters (TM-DSS) and the existence of prohibited substance should be confirmed.
If the review results indicated that the groundwater to be
generated from the excavation works would be contaminated, the
contaminated groundwater should be either properly treated in
compliance with the requirements of the TM-DSS or properly recharged
into the ground. ·
If wastewater treatment is deployed,
the wastewater treatment unit shall deploy suitable treatment process
(e.g. oil interceptor / activated carbon) to reduce the pollution level
to an acceptable standard and remove any prohibited substances
(e.g. TPH) to undetectable range. All treated effluent from
wastewater treatment plant shall meet the requirements as
stated in TM-DSS and should be discharged into the foul sewers. ·
If groundwater recharging wells are
deployed, recharging wells should be installed as appropriate for recharging
the contaminated groundwater back into the ground.
The recharging wells should be selected at places where the
groundwater quality will not be affected by the recharge operation as
indicated in the Section 2.3 of TM-DSS. The baseline groundwater
quality shall be determined prior to the selection of the
recharge wells, and submit a working plan (including the
laboratory analytical results showing
the quality of groundwater at the proposed recharge location(s) as well as
the pollutant levels of groundwater to be recharged) to EPD for agreement.
Pollution levels of groundwater to be recharged shall not be higher than
pollutant levels of ambient groundwater at the recharge well. Prior to
recharge, any prohibited substances such as TPH products should be removed as
necessary by installing the petrol interceptor. |
To minimize groundwater quality impact from
contaminated area |
Contractor |
Excavation areas where contamination is found |
Construction
stage |
·
Water Pollution Control Ordinance ·
TM-DSS ·
TM-EIAO |
·
Implemented |
|
S6.9.1.6 |
W6 |
Accidental
Spillage In
order to prevent accidental spillage of chemicals, the following is
recommended: ·
All the tanks, containers, storage
area should be bunded and the locations should be locked as far as possible
from the sensitive watercourse and stormwater drains; ·
The Contractor should register as a
chemical waste producer if chemical wastes would be generated. Storage of chemical waste arising from the
construction activities should be stored with suitable labels and warnings. Disposal
of chemical wastes should be conducted in compliance with the requirements as
stated in the Waste Disposal (Chemical Waste) (General) Regulation. |
To minimize water quality impact from
accidental spillage |
Contractor |
All
construction site where practicable |
Construction
stage |
·
Water Pollution Control Ordinance ·
ProPECC PN 1/94 ·
TM-EIAO ·
TM-DSS |
·
Implemented deficiency rectified
after observation |
|

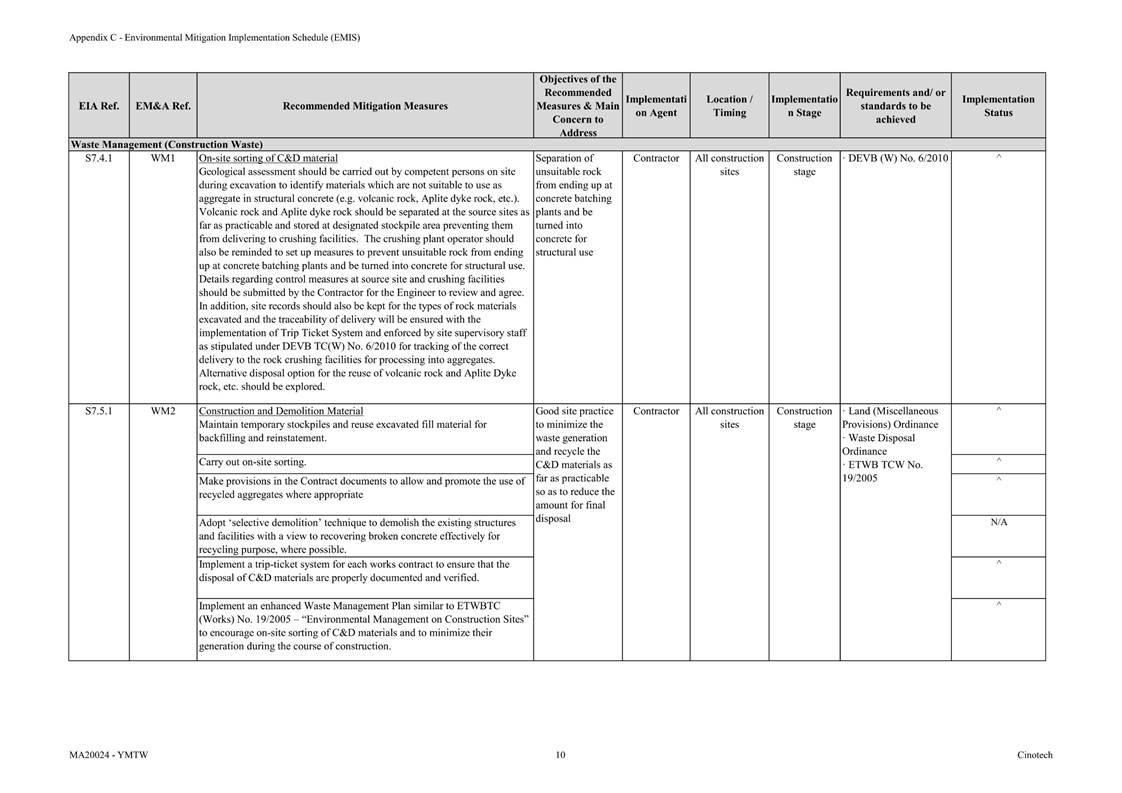

Waste Management (Construction Waste) |
|
||||||||
S7.4.1 |
WM1 |
On-site
sorting of C&D material ·
Geological assessment should be
carried out by competent persons on site during excavation to identify
materials which are not suitable to use as aggregate in structural concrete
(e.g. volcanic rock, Aplite dyke rock, etc.).
Volcanic rock and Aplite dyke rock should be separated at the source
sites as far as practicable and stored at designated stockpile area
preventing them from delivering to crushing facilities. The crushing plant operator should also be
reminded to set up measures to prevent unsuitable rock from ending up at
concrete batching plants and be turned into concrete for structural use. Details regarding control measures at
source site and crushing facilities should be submitted by the Contractor for
the Engineer to review and agree. In
addition, site records should also be kept for the types of rock materials
excavated and the traceability of delivery will be ensured with the
implementation of Trip Ticket System and enforced by site supervisory staff
as stipulated under DEVB TC(W) No. 6/2010 for tracking of the correct
delivery to the rock crushing facilities for processing into aggregates. Alternative disposal option for the reuse
of volcanic rock and Aplite Dyke rock, etc. should be explored. |
Separation of unsuitable rock from
ending up at concrete batching plants and be turned into concrete for
structural use |
Contractor |
All
construction sites |
Construction
stage |
·
DEVB (W) No. 6/2010 |
·
N/A |
|
S7.5.1 |
WM2 |
Construction
and Demolition Material ·
Maintain temporary stockpiles and
reuse excavated fill material for backfilling and reinstatement; ·
Carry out on-site sorting; ·
Make provisions in the Contract
documents to allow and promote the use of recycled aggregates where appropriate; ·
Adopt ‘selective demolition’
technique to demolish the existing structures and facilities with a view to
recovering broken concrete effectively for recycling purpose, where possible; ·
Implement a trip-ticket system for
each works contract to ensure that the disposal of C&D materials are properly documented and verified; and ·
Implement an enhanced Waste
Management Plan similar to ETWBTC (Works) No. 19/2005 – “Environmental
Management on Construction Sites” to encourage on-site sorting of C&D
materials and to minimize their generation during the course of construction. |
Good site practice to minimize the
waste generation and recycle the C&D materials as far as practicable so
as to reduce the amount for final disposal |
Contractor |
All
construction sites |
Construction
stage |
·
Land (Miscellaneous Provisions)
Ordinance ·
Waste Disposal Ordinance ·
ETWB TCW No. 19/2005 |
·
Implemented |
|
S7.5.1 |
WM3 |

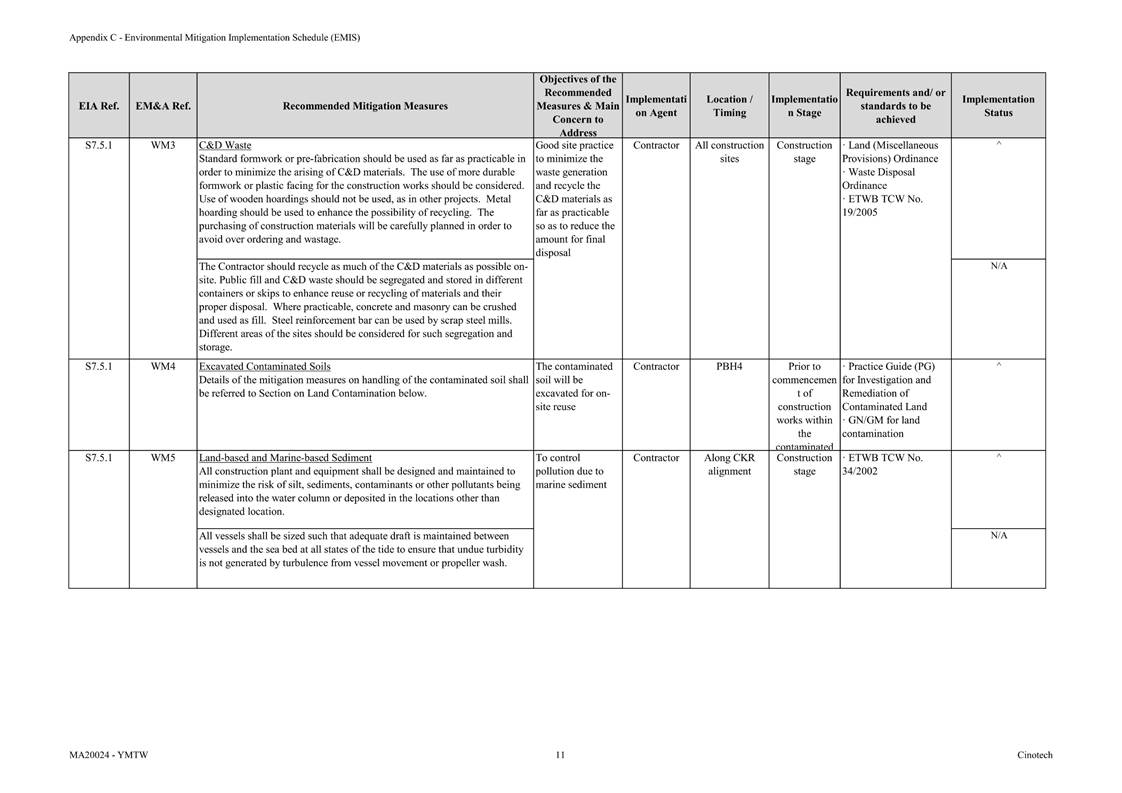

C&D
Waste ·
Standard formwork or pre-fabrication
should be used as far as practicable in order to minimize the arising of
C&D materials. The use of more
durable formwork or plastic facing for the construction works should be
considered. Use of wooden hoardings
should not be used, as in other projects.
Metal hoarding should be used to enhance the possibility of recycling. The purchasing of construction materials
will be carefully planned in order to avoid over ordering and wastage; ·
The Contractor should recycle as much
of the C&D materials as possible on-site. Public fill and C&D waste
should be segregated and stored in different containers or skips to enhance
reuse or recycling of materials and their proper disposal. Where practicable, concrete and masonry can
be crushed and used as fill. Steel
reinforcement bar can be used by scrap steel mills. Different areas of the sites should be

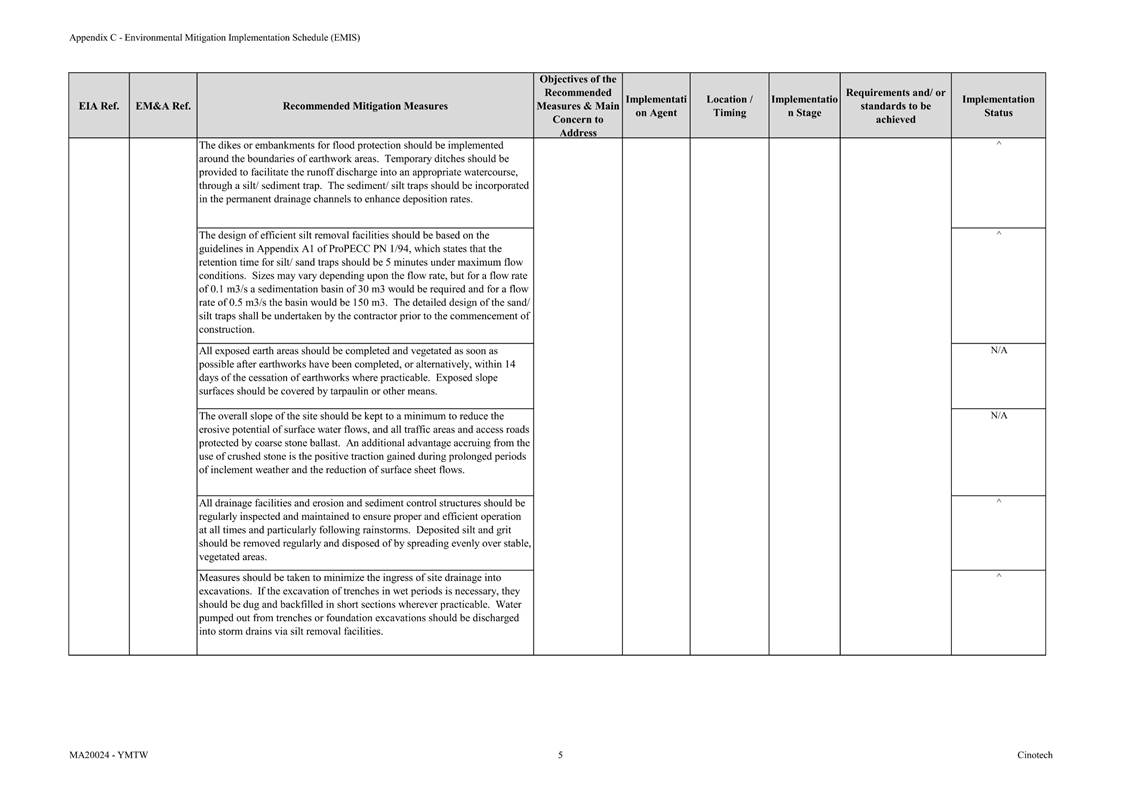

considered for such segregation and storage. |
Good site practice to minimize the
waste generation and recycle the C&D materials as far as practicable so
as to reduce the amount for final disposal |
Contractor |
All
construction sites |
Construction
stage |
·
Land (Miscellaneous Provisions)
Ordinance ·
Waste Disposal Ordinance ·
ETWB TCW No. 19/2005 |
·
Implemented |
|
S7.5.1 |
WM5 |
Land-based
Sediment ·
All construction plant and equipment
shall be designed and maintained to minimize the risk of silt,
sediments, contaminants or other pollutants being released into the water
column or deposited in the locations other than designated location; ·
All vessels shall be sized such that
adequate draft is maintained between vessels and the sea bed
at all states of the tide to ensure that undue turbidity is not generated by
turbulence from vessel movement or propeller wash; ·
Before moving the vessels
which are used for transporting dredged material, excess material
shall be cleaned from the decks and exposed fittings of vessels and the
excess materials shall never be dumped into the sea except at the
approved locations; ·
Adequate freeboard shall be
maintained on barges to ensure that decks are not washed by wave action. ·
The Contractors shall monitor all
vessels transporting material to ensure that no dumping outside the
approved location takes place. The Contractor shall keep and produce logs
and other records to demonstrate compliance and that
journeys are consistent with designated locations and copies
of such records shall be submitted to the engineers; ·
The Contractors shall comply with the
conditions in the dumping licence. ·
All bottom dumping vessels (Hopper
barges) shall be fitted with tight fittings seals to their bottom openings to
prevent leakage of material; ·
The material shall be placed into the
disposal pit by bottom dumping; ·
Contaminated marine mud shall be
transported by spit barge of not less than 750m3 capacity and capable of rapid
opening and discharge at the disposal site; ·
Discharge shall be undertaken rapidly and the hoppers shall be closed
immediately. Material adhering to the sides of the hopper shall
not be washed out of the hopper and the hopper shall remain
closed until the barge returns to the disposal site. ·
For Type 3 special disposal
treatment, sealing of contaminant with geosynthetic containment before dropping designated mud
pit would be a possible arrangement. A geosynthetic containment
method is a method whereby the sediments are sealed in geosynthetic containers
and, the containers would be dropped into the designated contaminated mud pit
where they would be covered by further mud disposal and
later by the mud pit capping at the disposal site, thereby
fulfilling the requirements for fully confined mud disposal. |
To control pollution due to marine
sediment |
Contractor |
Along CKR alignment |
Construction
stage |
·
ETWB TCW No. 34/2002 |
·
Implemented |
|
S7.5.1 |
WM6 |
Chemical
Waste ·
Chemical waste that is produced, as
defined by Schedule 1 of the Waste Disposal (Chemical Waste) (General)
Regulation, should be handled in accordance with the Code of Practice on the
Packaging, Labelling and Storage of Chemical Wastes; ·
Containers used for the storage of
chemical wastes should be suitable for the substance they are holding,
resistant to corrosion, maintained in a good condition, and securely closed,
have a capacity of less than 450 L unless the specification has been approved
by EPD, and display a label in English and Chinese in accordance with
instructions prescribed in Schedule 2 of the regulation; ·
The storage area for chemical wastes
should be clearly labelled and used solely for the storage of chemical waste,
enclosed on at least 3 sides, have an impermeable floor and bunding of
sufficient capacity to accommodate 110% of the volume of the largest
container or 20% of the total volume of waste stored in that area, whichever
is the greatest, have adequate ventilation, covered to prevent rainfall
entering, and arranged so that incompatible materials are adequately
separated; ·
Disposal of chemical waste should be
via a licensed waste collector, be to a facility licensed to receive chemical
waste, such as the Chemical Waste Treatment Centre which also offers a
chemical waste collection service and can supply the necessary storage
containers, or be to a reuser of the waste, under
approval from EPD. |
Control the chemical waste and ensure
proper storage, handling and disposal |
Contractor |
All
construction sites |
Construction
stage |
·
Waste Disposal (Chemical Waste)
(General) Regulation ·
Code of Practice on the Packaging,
Labelling and Storage of Chemical Waste |
·
Implemented, deficiency rectified
after observation |
|
S7.5.1 |
WM7 |
General
Refuse ·
General refuse generated on-site
should be stored in enclosed bins or compaction units separately from
construction and chemical wastes; ·
A reputable waste collector should be
employed by the Contractor to remove general refuse from the site, separately
from construction and chemical wastes, on a daily basis to minimize odour, pest and litter impacts. Burning of refuse on construction sites is
prohibited by law. ·
Aluminum cans are often recovered
from the waste stream by individual collectors if they are segregated and
made easily accessible. Separate
labelled bins for their deposit should be provided if feasible; ·
Office wastes can be reduced through
the recycling of paper if volumes are large enough to warrant
collection. Participation in a local
collection scheme should be considered by the Contractor. |
Minimize production of the general
refuse and avoid odour, pest and litter impacts |
Contractor |
All
construction sites |
Construction
stage |
·
Waste Disposal Ordinance |
·
Implemented, deficiency rectified
after observation |
|
Land Contamination |
|
||||||||

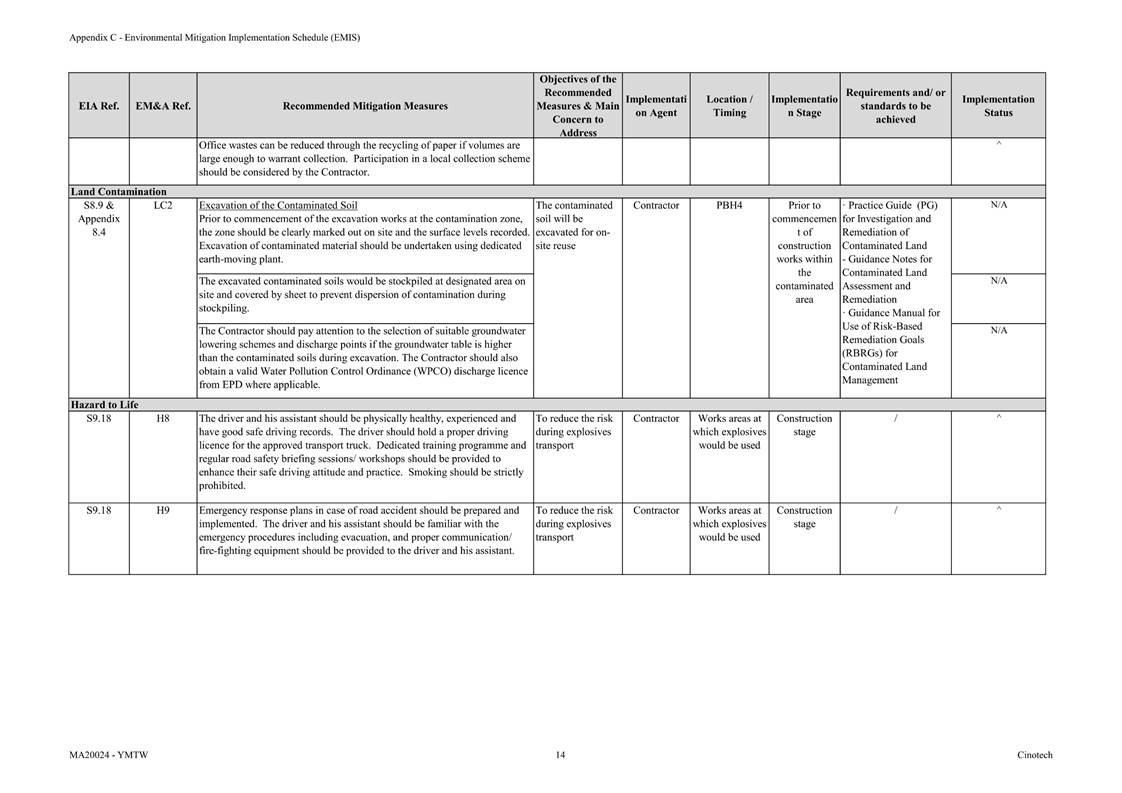

S8.9 & Appendix 8.4 |
LC2 |
Excavation
of the Contaminated Soil ·
Prior to commencement of the
excavation works at the contamination zone, the zone should be clearly marked
out on site and the surface levels recorded. Excavation of contaminated
material should be undertaken using dedicated earth-moving plant. ·
The excavated contaminated soils
would be stockpiled at designated area on site and covered by sheet to
prevent dispersion of contamination during stockpiling. ·
The Contractor should pay attention
to the selection of suitable groundwater lowering schemes and discharge
points if the groundwater table is higher than the contaminated soils during
excavation. The Contractor should also obtain a valid Water Pollution Control
Ordinance (WPCO) discharge licence from EPD where
applicable. |
The contaminated soil will be excavated for on-site reuse |
Contractor |
PBH4 |
Prior to commencement of construction works within the
contaminated area |
·
Practice Guide (PG) for Investigation
and Remediation of Contaminated Land ·
Guidance Notes for Contaminated
Land Assessment and Remediation ·
Guidance Manual for
Use of Risk-Based Remediation Goals
(RBRGs) for Contaminated Land Management |
·
Implemented |
|
S8.9 & Appendix 8.4 |
LC3 |
·
Following completion of the
excavation to the specified depth, at least one sample from the base of the
excavation and four samples evenly distributed along the boundary of
the excavation shall be taken for a closure
assessment testing. The
acceptance criterion is shown below:
·
If the results of analysis below the
RBRGs (Public Park), no further excavation will be required. If
the analysis indicates presence of contamination (i.e. noncompliance of
the acceptance criteria), further excavation shall be carried
out in 0.5m increment vertically and/or horizontally depending
on the location(s) of the sample(s) which has exceeded the acceptance criteria.
Further sampling shall also be conducted for compliance testing. The process of excavation,sampling and
compliance testing should continue until all contaminated materials are removed
and should be supervised by a Land Contamination Specialist. |
·
Implemented |
||||||
Appendix 8.4 |
LC4 |
·
A Remediation Report (RR) to
demonstrate adequate clean-up shall be prepared and submitted to EPD for
endorsement prior to the commencement of any construction/development works
within the sites. No construction/development works shall be carried out prior
to the endorsement of the RR by EPD. |
·
Implemented |
||||||
Hazard to Life |
|
||||||||
H8 |
The driver and his assistant should be physically
healthy, experienced and have good safe driving records. The driver should hold a proper driving licence for the approved transport truck. Dedicated training programme and regular
road safety briefing sessions/ workshops should be provided to enhance their
safe driving attitude and practice.
Smoking should be strictly prohibited. |
To reduce the risk during explosives transport |
Contractor |
Works areas at which explosives would
be used |
Construction stage |
- |
·
N/A |
||
S9.18 |
H9 |
Emergency
response plans in case of road accident should be prepared and
implemented. The driver and his
assistant should be familiar with the emergency procedures including
evacuation, and proper communication/ fire-fighting equipment should be
provided to the driver and his assistant. |
To reduce the risk during explosives
transport |
Contractor |
Works
areas at which explosives would be used |
Construction
stage |
- |
·
N/A |
|
Landscape & Visual |
|
||||||||
S10.10.1 Table 10.11 |

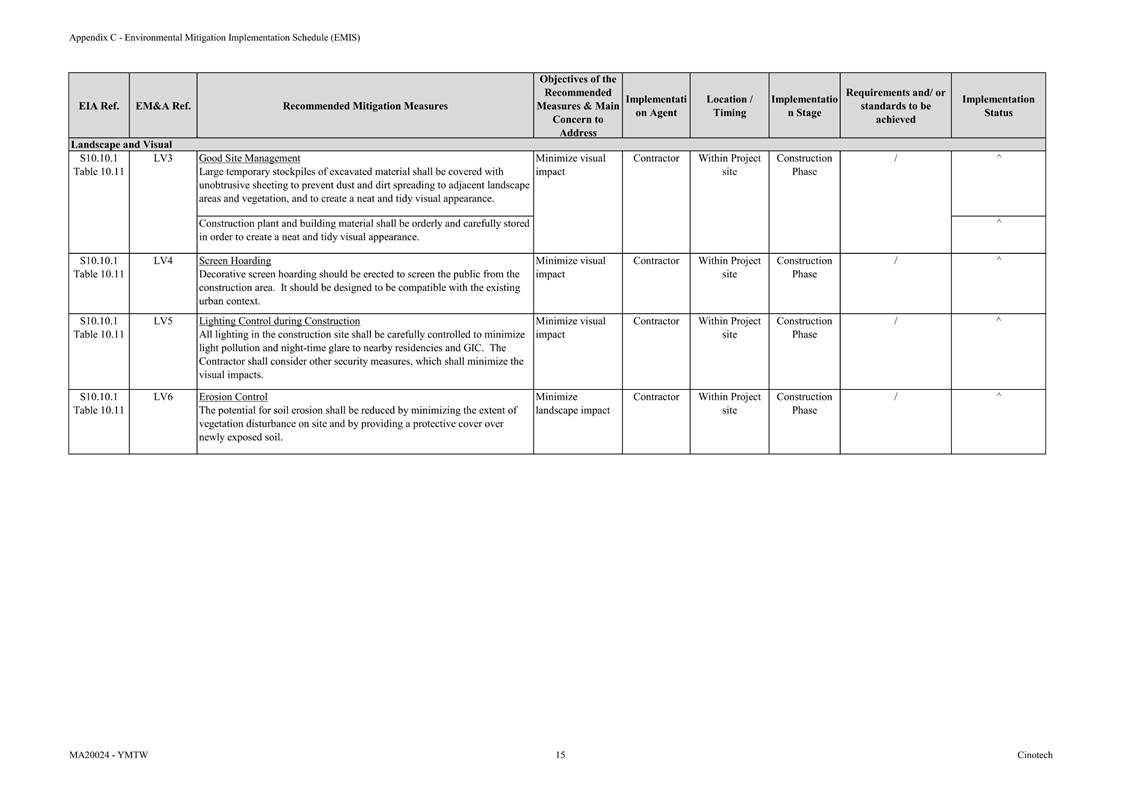

LV3 |
Good Site Management ·
Large temporary stockpiles of
excavated material shall be covered with unobtrusive sheeting to prevent dust
and dirt spreading to adjacent landscape areas and vegetation, and to create
a neat and tidy visual appearance. ·
Construction plant and building
material shall be orderly and carefully stored in order to create a neat and
tidy visual appearance. |
Minimize visual impact |
Contractor |
Within
Project site |
Construction
stage |
- |
·
Implemented |
|
LV4 |
Screen Hoarding ·
Decorative screen hoarding should be
erected to screen the public from the construction area. It should be designed to be compatible with
the existing urban context. |
Minimize visual impact |
Contractor |
Within Project site |
Construction stage |
- |
·
Implemented |
||
S10.10.1 Table 10.11 |
LV5 |
Lighting Control during Construction ·
All lighting in the construction site
shall be carefully controlled to minimize light pollution and night-time
glare to nearby residencies and GIC.
The Contractor shall consider other security measures, which shall minimize
the visual impacts. |
Minimize visual impact |
Contractor |
Within
Project site |
Construction
stage |
- |
·
Implemented |
|
S10.10.1 Table 10.11 |
LV6 |
Erosion Control ·
The potential for soil erosion shall
be reduced by minimizing the extent of vegetation disturbance on site and by
providing a protective cover over newly exposed soil. |
Minimize landscape impact |
Contractor |
Within
Project site |
Construction
stage |
- |
·
N/A |
|
S10.10.1 Table 10.11 |
LV7 |

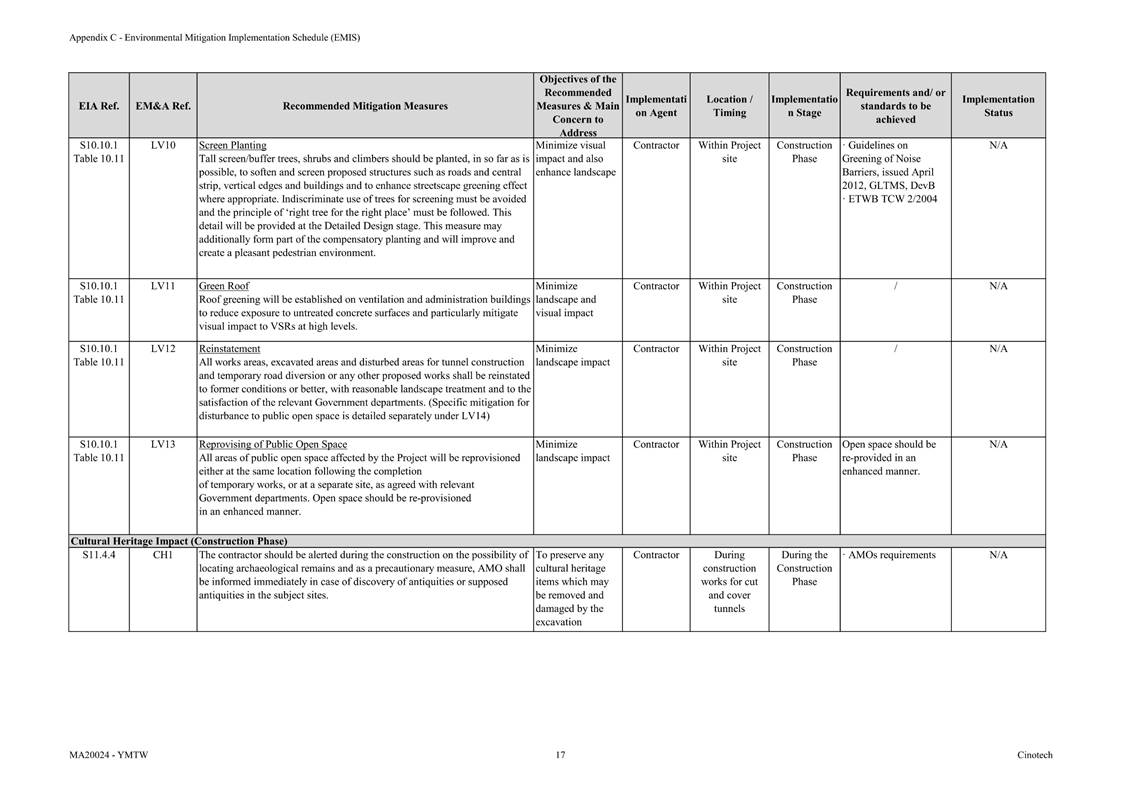

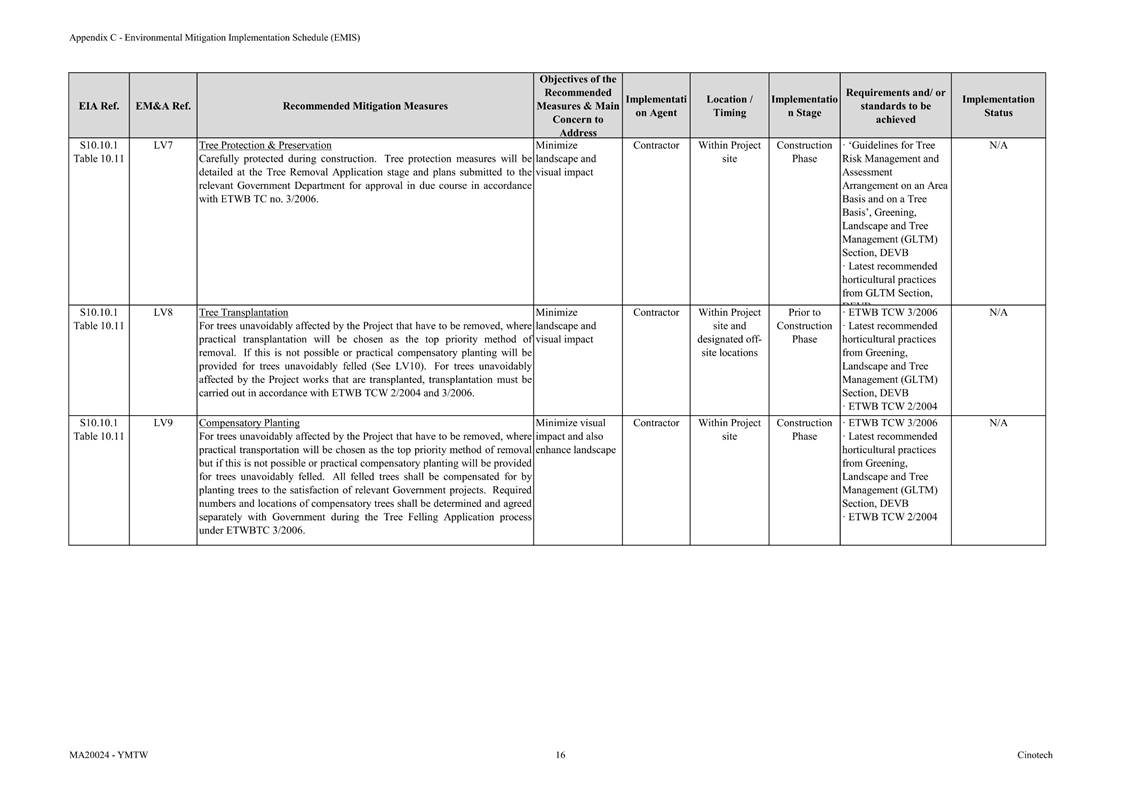

Tree Protection & Preservation ·
Carefully protected during
construction. Tree protection measures will be detailed at the Tree Removal
Application stage and plans submitted to the relevant Government Department
for approval in due course in accordance with ETWB TC no. 3/2006. |
Minimize landscape and visual impact |
Contractor |
Within
Project site |
Construction
stage |
·
‘Guidelines for Tree Risk Management
and Assessment Arrangement on an Area Basis and on a Tree Basis’, Greening,
Landscape and Tree Management (GLTM) Section, DEVB ·
Latest recommended horticultural
practices from GLTM Section, DEVB |
·
Implemented |
|
S10.10.1 Table 10.11 |
LV8 |
Tree Transplantation ·
For trees unavoidably affected by the
Project that have to be removed, where practical transplantation will be
chosen as the top priority method of removal.
If this is not possible or practical compensatory planting will be
provided for trees unavoidably felled (See LV10). For trees unavoidably affected by the
Project works that are transplanted, transplantation must be carried out in
accordance with ETWB TCW 2/2004 and 3/2006. |
Minimize landscape and visual impact |
Contractor |
Within
Project site and designated off-site locations |
Prior
to Construction stage |
·
ETWB TCW 3/2006 ·
Latest recommended horticultural
practices from Greening, Landscape and Tree Management (GLTM) Section, DEVB ·
ETWB TCW 2/2004 |
·
Implemented |
|
S10.10.1 Table 10.11 |
LV9 |
Compensatory Planting ·
For trees unavoidably affected by the
Project that have to be removed, where practical transportation will be
chosen as the top priority method of removal but if this is not possible or
practical compensatory planting will be provided for trees unavoidably
felled. All felled trees shall be
compensated for by planting trees to the satisfaction of relevant Government
projects. Required numbers and
locations of compensatory trees shall be determined and agreed separately
with Government during the Tree Felling Application process under ETWBTC
3/2006. ·
Compensatory tree planting may be
incorporated into public open spaces and along roadside amenity areas affected by the
construction works and therefore be part of the bigger wider planting
plans. Onsite compensation planting is
preferred but if necessary, additional receptor
sites outside the Works Area shall be agreed separately with Government
during the Tree Felling Application process. |
Minimize visual impact and also
enhance landscape |
Contractor |
Within
Project site |
Construction
stage |
·
ETWB TCW 3/2006 ·
Latest recommended horticultural
practices from Greening, Landscape and Tree Management (GLTM) Section, DEVB ·
ETWB TCW 2/2004 |
·
Implemented |
|
Cultural Heritage Impact
(Construction Phase) |
|
||||||||
S11.4.4 |
CH1 |
The
contractor should be alerted during the construction on the possibility of
locating archaeological remains and as a precautionary measure, AMO shall be
informed immediately in case of discovery of antiquities or supposed
antiquities in the subject sites. |
To preserve any cultural heritage
items which may be removed and damaged by the excavation |
Contractor |
During
construction works for cut and cover
tunnels |
Construction
stage |
·

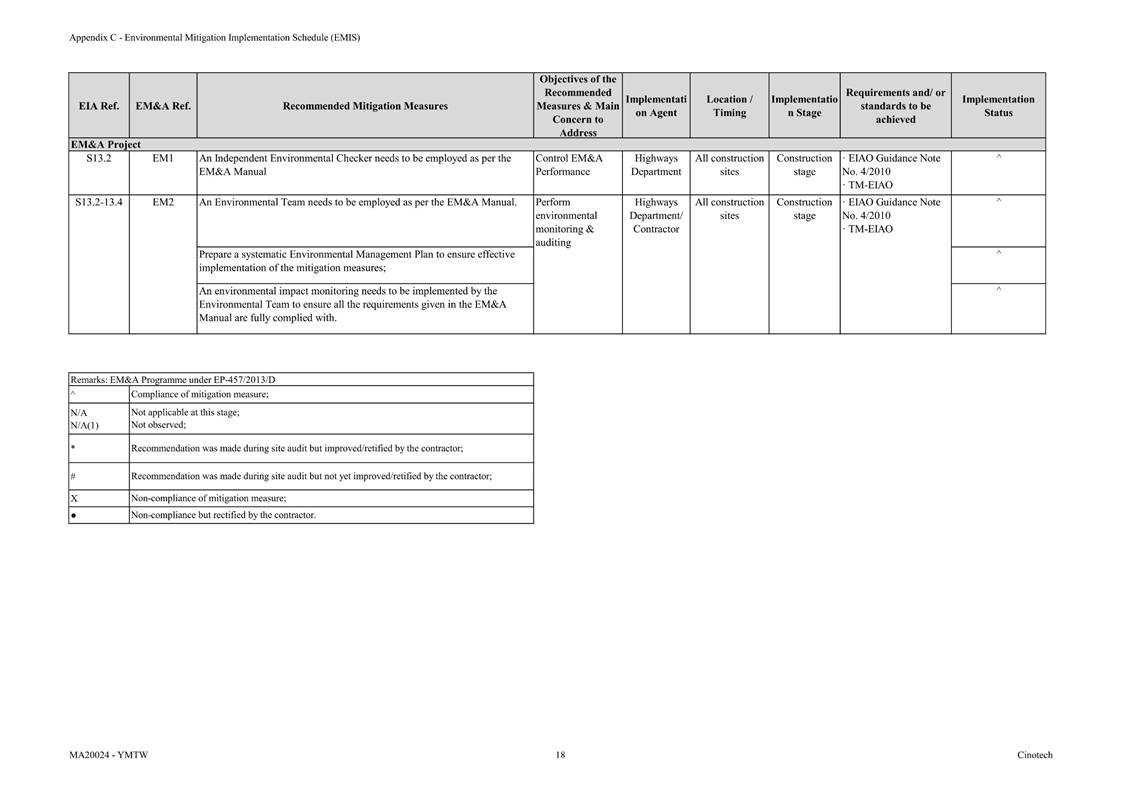

AMOs requirements |
·
N/A |
|
EM&A Project |
|
||||||||
S13.2 |
EM1 |
An
Independent Environmental Checker needs to be employed as per the EM&A
Manual |
Control EM&A Performance |
Highways
Department |
All
construction sites |
Construction
stage |
·
EIAO Guidance Note No. 4/2010 ·
TM-EIAO |
·
Implemented |
|
S13.2-13.4 |
EM2 |
·
An Environmental Team needs to be
employed as per the EM&A Manual; ·
Prepare a systematic Environmental
Management Plan to ensure effective implementation of the mitigation measures; ·
An environmental impact monitoring
needs to be implemented by the Environmental Team to ensure all the
requirements given in the EM&A Manual are fully complied with. |
Perform environmental monitoring
& auditing |
Highways
Department/ Contractor |
All
construction sites |
Construction
stage |
·
EIAO Guidance Note No. 4/2010 ·
TM-EIAO |
·
Implemented |
|
Appendix G
Monitoring Schedule of the Reporting Month
Appendix H

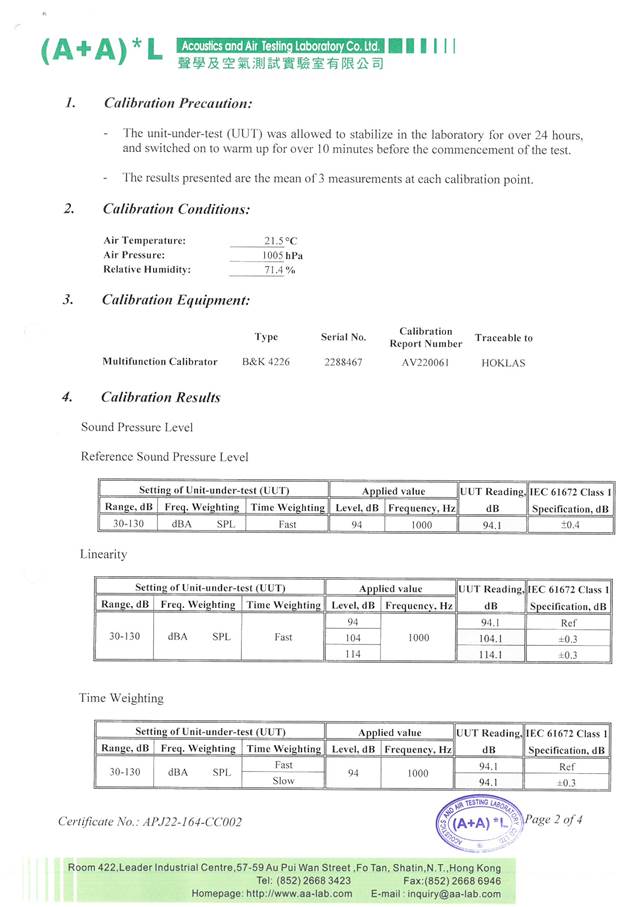

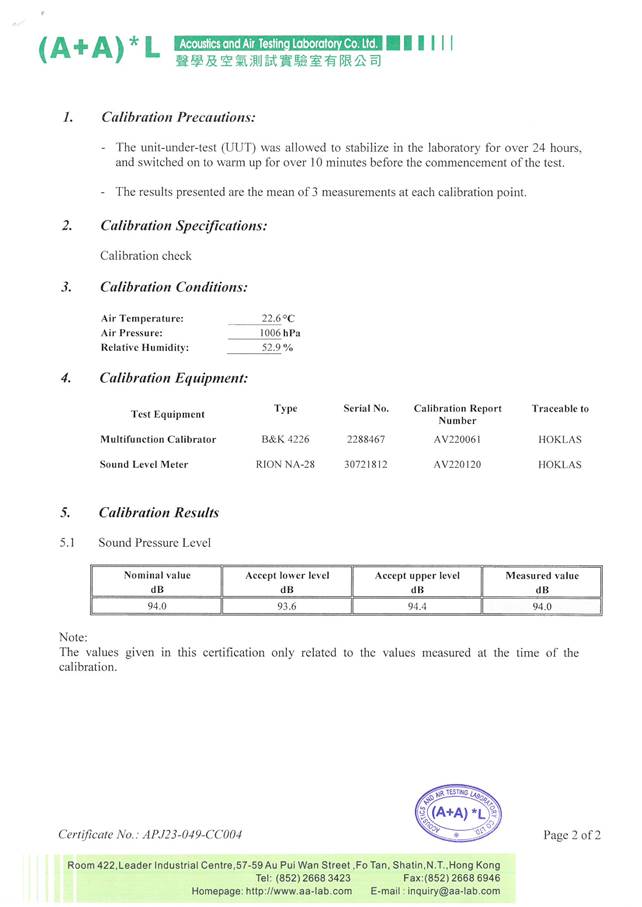

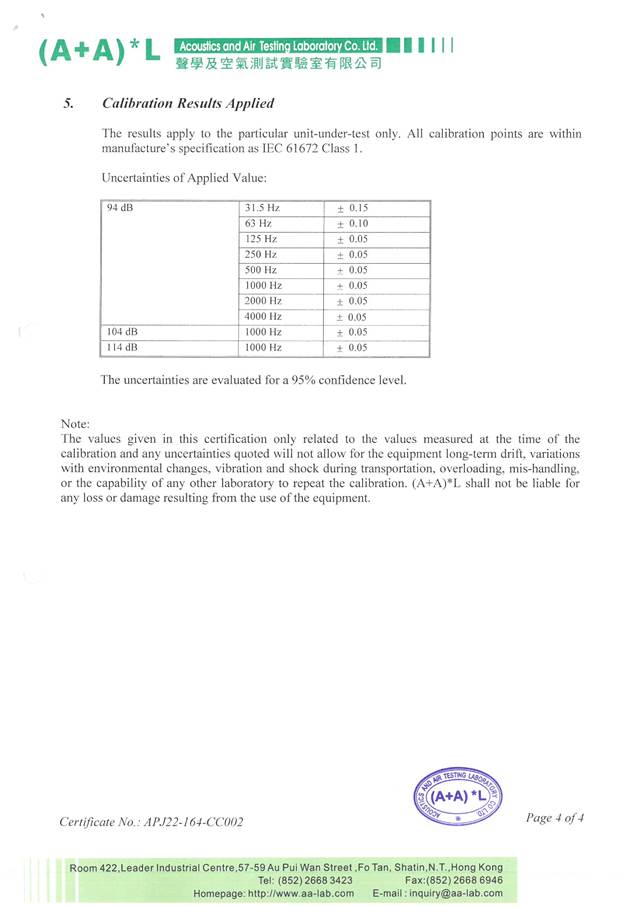

Calibration Certificates
(Air Monitoring)

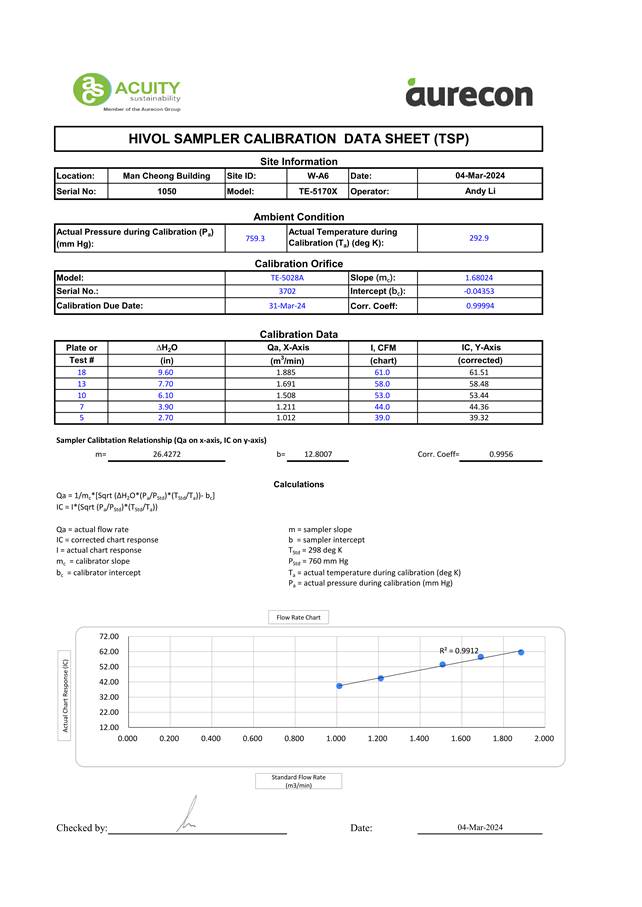

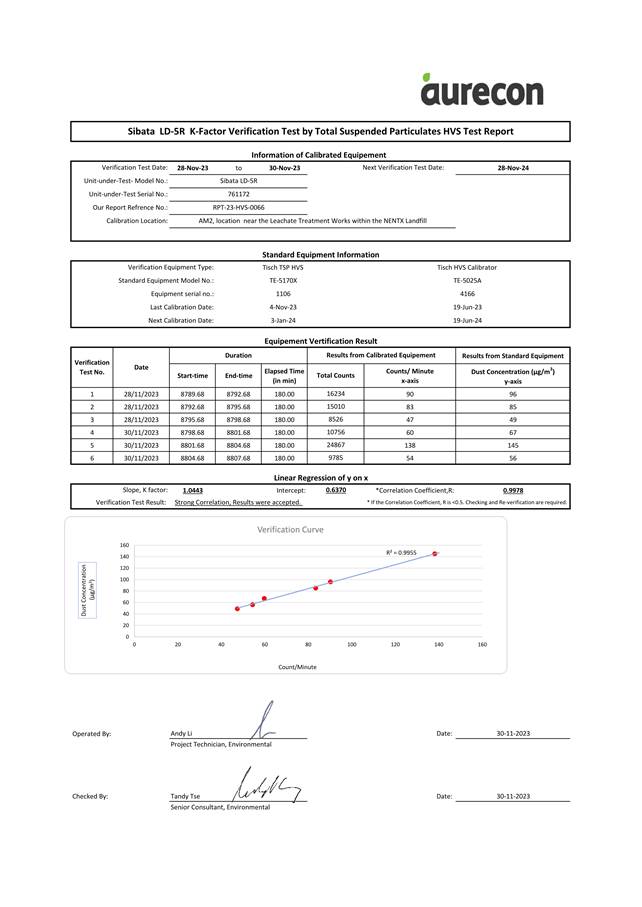

Appendix I
Calibration Certificates (Noise)
Appendix J
The Certification of Laboratory
with HOKLAS Accredited Analytical Tests
Appendix K
Location Plan of Noise and Air Quality Monitoring
Station
Appendix L
Monitoring Data (Air Monitoring)
Location: |
Yau Ma Tei Catholic Primary School (Hoi Wang Road) (W-A1) |
Monitoring date: |
5, 11, 15, 21 and 27 March 2024 |
Parameter : |
TSP 1-hour |
Other Factors |
Nearby traffic |
Date |
1-hour TSP (μg/m3) |
|||||
Weather |
Start Time |
1st Hour (μg/m3) |
2nd Hour (μg/m3) |
3rd Hour (μg/m3) |
||
05/03/2024 |
Fine |
9:03 |
65 |
63 |
68 |
|
11/03/2024 |
Fine |
9:05 |
63 |
67 |
65 |
|
15/03/2024 |
Fine |
9:06 |
68 |
63 |
65 |
|
21/03/2024 |
Fine |
9:04 |
66 |
69 |
67 |
|
27/03/2024 |
Fine |
9:06 |
65 |
68 |
63 |
|
Minimum: 63 μg/m3 |
Maximum: 69 μg/m3 |
|||||
Location: |
Man Cheong Building (W-A6) |
Monitoring date: |
5, 11, 15, 21 and 27 March 2024 |
Parameter : |
TSP 1-hour |
Other Factors |
Nearby traffic |
Date |
1-hour TSP (μg/m3) |
|||||
Weather |
Start Time |
1st Hour (μg/m3) |
2nd Hour (μg/m3) |
3rd Hour (μg/m3) |
||
05/03/2024 |
Fine |
10:20 |
68 |
71 |
67 |
|
11/03/2024 |
Fine |
10:23 |
65 |
69 |
71 |
|
15/03/2024 |
Fine |
10:25 |
66 |
68 |
70 |
|
21/03/2024 |
Fine |
10:26 |
65 |
69 |
67 |
|
27/03/2024 |
Fine |
10:29 |
62 |
68 |
67 |
|
Minimum: 62 μg/m3 |
Maximum: 71 μg/m3 |
|||||
Figure 2: Graphical Illustration of Measured
1-hour TSP (μg/m3) Levels at W-A6
Location: |
Yau
Ma Tei Catholic Primary School (Hoi Wang Road) (W-A1) |
Monitoring date:
|
5, 11, 15, 21 and 27 March 2024 |
Parameter : |
TSP
24-hour |
Other Factors |
Nearby
traffic |
|
|
Location: |
Man Cheong Building
(W-A6) |
Monitoring date:
|
5, 11, 15, 21 and 27 March 2024 |
Parameter : |
TSP 24-hour |
Other Factors |
Nearby traffic |
|
|
Figure 3: Graphical
Illustration of Measured 24-hour TSP (μg/m3)
Levels at W-A1
Figure 4: Graphical
Illustration of Measured 24-hour TSP (μg/m3)
Levels at W-A6

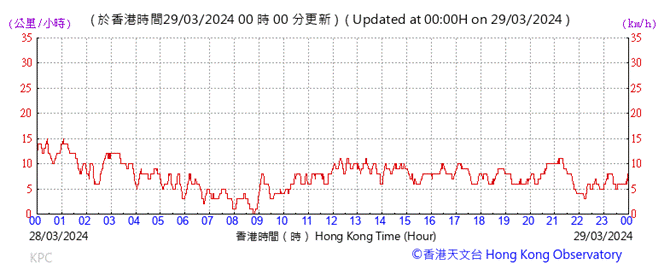

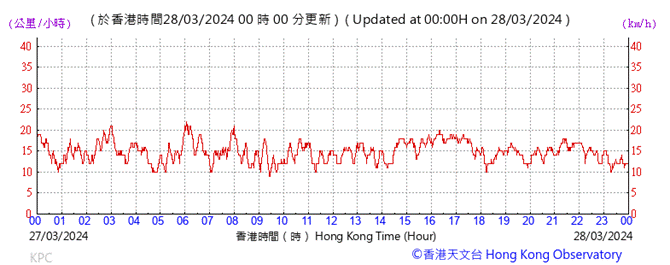

Wind direction data for 5, 6, 11, 12, 15, 16, 21, 22, 27 and 28 March 2024
Wind speed data for 5, 6, 11, 12, 15, 16, 21, 22, 27 and 28 March 2024
Appendix M
Monitoring Data (Noise)
Location: |
Yau Ma Tei
Catholic Primary School (Hoi Wang Road) (W-N1A) |
Monitoring date:
|
5, 11, 15, 21 and 27 March 2024 |
Parameter : |
Leq, L10,
L90 |
Other Factors |
Nearby traffic |
Noise Monitoring data:
Date |
Weather |
Start Time |
- |
End Time |
Leq |
L10 |
L90 |
Wind speed
(m/s) |
Limit
level |
05/03/2024 |
Fine |
9:03 |
- |
9:33 |
66.8 |
72.8 |
60.4 |
1.4 |
70.0 |
11/03/2024 |
Fine |
9:05 |
- |
9:35 |
64.9 |
70.9 |
60.3 |
1.7 |
65.0 |
15/03/2024 |
Fine |
9:06 |
- |
9:36 |
63.0 |
68.1 |
60.0 |
3.3 |
70.0 |
21/03/2024 |
Fine |
9:03 |
- |
9:33 |
65.3 |
68.5 |
62.6 |
3.9 |
70.0 |
27/03/2024 |
Fine |
9:06 |
- |
9:36 |
65.1 |
68.5 |
61.9 |
3.8 |
70.0 |
Location: |
Hydan Place
(W-N18) |
Monitoring date:
|
5, 11, 15, 21 and 27 March 2024 |
Parameter : |
Leq,
L10, L90 |
Other Factors |
Nearby traffic |
Noise Monitoring data:
Date |
Weather |
Start Time |
- |
End Time |
Leq |
L10 |
L90 |
Wind speed
(m/s) |
Limit
level |
05/03/2024 |
Fine |
11:15 |
- |
11:45 |
70.8 |
76.4 |
69.0 |
2.7 |
75.0 |
11/03/2024 |
Fine |
11:17 |
- |
11:47 |
71.2 |
75.1 |
67.0 |
1.1 |
75.0 |
15/03/2024 |
Fine |
11:16 |
- |
11:46 |
70.5 |
75.4 |
65.2 |
3.6 |
75.0 |
21/03/2024 |
Fine |
11:18 |
- |
11:48 |
70.9 |
74.6 |
65.0 |
2.8 |
75.0 |
27/03/2024 |
Fine |
11:20 |
- |
11:50 |
69.2 |
72.7 |
64.1 |
3.7 |
75.0 |
Location: |
Prosperous
Garden Block 1 (W-N25A) |
Monitoring date:
|
5, 11, 15, 21 and 27 March 2024 |
Parameter : |
Leq,
L10, L90 |
Other Factors |
Nearby traffic |
Noise Monitoring data:
Date |
Weather |
Start Time |
- |
End Time |
Leq |
L10 |
L90 |
Wind speed
(m/s) |
Limit
level |
05/03/2024 |
Fine |
10:36 |
- |
11:06 |
69.3 |
72.5 |
64.3 |
3.1 |
75.0 |
11/03/2024 |
Fine |
10:39 |
- |
11:09 |
69.3 |
72.4 |
65.3 |
2.1 |
75.0 |
15/03/2024 |
Fine |
10:41 |
- |
11:11 |
68.7 |
73.3 |
64.6 |
4.2 |
75.0 |
21/03/2024 |
Fine |
10:40 |
- |
11:10 |
68.5 |
72.3 |
64.7 |
3.3 |
75.0 |
27/03/2024 |
Fine |
10:43 |
- |
11:13 |
69.4 |
73.5 |
64.3 |
4.4 |
75.0 |
Location: |
The Coronation
Tower 1 (W-P11) |
Monitoring date:
|
5, 11, 15, 21 and 27 March 2024 |
Parameter : |
Leq,
L10, L90 |
Other Factors |
Nearby traffic |
Noise Monitoring data:
Date |
Weather |
Start Time |
- |
End Time |
Leq |
L10 |
L90 |
Wind speed
(m/s) |
Limit
level |
05/03/2024 |
Fine |
9:40 |
- |
10:10 |
66.5 |
72.2 |
59.8 |
2.5 |
75.0 |
11/03/2024 |
Fine |
9:43 |
- |
11:15 |
64.8 |
72.7 |
59.2 |
1.9 |
75.0 |
15/03/2024 |
Fine |
9:44 |
- |
10:14 |
63.5 |
72.3 |
59.8 |
3.1 |
75.0 |
21/03/2024 |
Fine |
9:42 |
- |
13:30 |
64.6 |
68.7 |
62.5 |
3.6 |
75.0 |
27/03/2024 |
Fine |
9:45 |
- |
10:15 |
65.4 |
68.7 |
62.1 |
3.5 |
75.0 |
Figure 1: Graphical
Illustration of Measured Noise Levels at W-N1A
Figure 2: Graphical
Illustration of Measured Noise Levels at W-N18
Figure 3:
Graphical Illustration of Measured Noise Levels at W-N25A
Figure 4: Graphical
Illustration of Measured Noise Levels at W-P11
Appendix N
Waste Flow Table
Monthly Summary Waste Flow Table
Name of Department:
Highways Department Contract
No. / Works Order No.: __HY/2014/20__
Monthly
Summary Waste Flow Table for March 2024
[to be submitted not later
than the 15th day of each month following reporting month] (All quantities shall be rounded off to 2
decimal place.)
Month |
|
Actual Quantities of Inert Construction Waste Generated Monthly |
|||||||||||||
(a)=(b)+(c)+(d)+I+ (f)+ (g)+
(h)+ (i)+ (j)+ (k) Total Quantity Generated |
(b) Hard Rock and Large Broken Concrete |
I Reused in the Contract |
(d) Reused in other Projects |
I Disposed of as Public Fill |
(f) Imported Fill |
||||||||||
(in ‘tonnes) |
(in ‘tonnes) |
(in ‘tonnes) |
(in ‘tonnes) |
(in ‘tonnes) |
(in ‘tonnes) |
||||||||||
Jan-24 |
3708.11 |
0.00 |
0.00 |
0.00 |
3482.35 |
0.00 |
|||||||||
Feb-24 |
3389.21 |
0.00 |
0.00 |
0.00 |
2397.59 |
466.88 |
|||||||||
Mar-24 |
3606.61 |
0.00 |
0.00 |
0.00 |
3359.54 |
0.00 |
|||||||||
Apr-24 |
0.00 |
|
|
|
|
|
|||||||||
May-24 |
0.00 |
|
|
|
|
|
|||||||||
Jun-24 |
0.00 |
|
|
|
|
|
|||||||||
Sub-total |
10703.93 |
0.00 |
0.00 |
0.00 |
9239.48 |
466.88 |
|||||||||
Jul-24 |
0.00 |
|
|
|
|
|
|||||||||
Aug-24 |
0.00 |
|
|
|
|
|
|||||||||
Sep-24 |
0.00 |
|
|
|
|
|
|||||||||
Oct-24 |
0.00 |
|
|
|
|
|
|||||||||
Nov-24 |
0.00 |
|
|
|
|
|
|||||||||
Dec-24 |
0.00 |
|
|
|
|
|
|||||||||
Total |
10703.93 |
0.00 |
0.00 |
0.00 |
9239.48 |
466.88 |
|||||||||
2018 |
15.65 |
0.00 |
0.00 |
0.00 |
0.00 |
0.00 |
|||||||||
2019 |
71691.85 |
0.00 |
5534.00 |
8066.88 |
57313.64 |
415.55 |
|||||||||
2020 |
168891.36 |
0.00 |
15437.30 |
84381.54 |
68187.83 |
180.00 |
|||||||||
2021 |
213790.30 |
0.00 |
16567.28 |
79780.37 |
114965.52 |
1002.03 |
|||||||||
2022 |
140806.50 |
0.00 |
22476.00 |
20553.85 |
51490.05 |
44771.11 |
|||||||||
2023 |
126731.90 |
0.00 |
27490.00 |
104.07 |
92991.04 |
4240.52 |
|||||||||
Accumulated Total |
732631.49 |
0.00 |
87504.58 |
192886.71 |
394187.56 |
51076.08 |
|||||||||
|
|
|
|
|
|
|
|
|
|||||||
Month |
Actual
Quantities of Non-inert Construction Waste Generated Monthly |
||||||||
(g) Metals |
(h) Paper/ cardboard packaging |
(i) Plastics |
(j) Chemical Waste |
(k) Others, e.g. General Refuse disposed at Landfill |
|||||
(in ‘000kg) |
(in ‘000kg) |
(in ‘000kg) |
(in ‘000kg) |
(in ‘tonnes) |
|||||
generated |
recycled |
generated |
recycled |
generated |
recycled |
generated |
recycled |
generated |
|
Jan-24 |
0.00 |
0.00 |
0.00 |
0.00 |
0.00 |
0.00 |
0.00 |
0.00 |
225.76 |
Feb-24 |
0.00 |
399.61 |
0.00 |
0.00 |
0.00 |
0.34 |
0.00 |
0.00 |
124.79 |
Mar-24 |
0.00 |
78.31 |
0.00 |
0.0063 |
0.00 |
0.76 |
0.00 |
0.00 |
167.99 |
Apr-24 |
|
|
|
|
|
|
|
|
|
May-24 |
|
|
|
|
|
|
|
|
|
Jun-24 |
|
|
|
|
|
|
|
|
|
Sub-total |
0.00 |
477.92 |
0.00 |
0.01 |
0.00 |
1.100 |
0.00 |
0.00 |
518.54 |
Jul-24 |
|
|
|
|
|
|
|
|
|
Aug-24 |
|
|
|
|
|
|
|
|
|
Sep-24 |
|
|
|
|
|
|
|
|
|
Oct-24 |
|
|
|
|
|
|
|
|
|
Nov-24 |
|
|
|
|
|
|
|
|
|
Dec-24 |
|
|
|
|
|
|
|
|
|
Total |
0.00 |
477.92 |
0.00 |
0.01 |
0.00 |
1.10 |
0.00 |
0.00 |
518.54 |
2018 |
0.00 |
0.00 |
0.00 |
0.00 |
0.00 |
0.00 |
0.00 |
0.00 |
15.65 |
2019 |
0.00 |
106.04 |
0.00 |
0.20 |
0.00 |
1.47 |
2.11 |
0.00 |
251.96 |
2020 |
359.10 |
0.00 |
0.35 |
0.00 |
3.16 |
0.00 |
0.88 |
0.00 |
341.20 |
2021 |
945.79 |
0.00 |
0.20 |
0.00 |
3.34 |
0.00 |
0.00 |
0.00 |
525.77 |
2022 |
615.75 |
159.28 |
0.75 |
0.08 |
2.12 |
1.49 |
0.00 |
0.00 |
736.02 |
2023 |
0.00 |
716.48 |
0.00 |
0.33 |
0.00 |
4.46 |
0.00 |
0.00 |
1185.01 |
Accumulated Total |
1920.64 |
1459.72 |
1.30 |
0.62 |
8.62 |
8.52 |
2.99 |
0.00 |
3574.15 |
Remark: Sub-total,
Total and Accumulated Total are corrected to 2 decimal places. Construction
waste records for January 2024 had been updated. |
Appendix O
Statistics
on Complaint, Notifications
of Summons and Successful Prosecutions
Statistical Summary of Exceedances
Air Quality |
||
Reporting Period |
Action Level |
Limit Level |
1 – 31 March 2024 |
0 |
0 |
Noise |
||
Reporting Period |
Action Level |
Limit Level |
1 – 31 March 2024 |
0 |
0 |
Statistical Summary of Environmental
Complaints
Reporting Period |
Environmental Complaint Statistics |
||
Frequency |
Cumulative |
Complaint Nature |
|
1 – 31 March 2024 |
0 |
17 |
N/A |
Statistical Summary of Environmental Non-compliance
Reporting Period |
Environmental Non-compliance Statistics |
||
Frequency |
Cumulative |
Details |
|
1 – 31 March 2024 |
0 |
0 |
N/A |
Statistical Summary of Environmental Summons
Reporting Period |
Environmental Summons Statistics |
||
Frequency |
Cumulative |
Details |
|
1 – 31 March 2024 |
0 |
0 |
N/A |
Statistical Summary of Environmental
Prosecution
Reporting Period |
Environmental Prosecution Statistics |
||
Frequency |
Cumulative |
Details |
|
1 – 31 March 2024 |
0 |
0 |
N/A |
Appendix P
Monitoring
Schedule of the Coming Month
TABLE OF CONTENTS
Construction
Activities undertaken during the Reporting Month
Statues
of Environmental Licensing and Permitting
Implementation
Status of Environmental Mitigation Measures
Implementation
Status of Event and Action Plans
Summary
of Complaint, Warning, Notification of any Summons and Successful Prosecution
Status
of Required Submission under Environmental Permit
8 Conclusions
and recommendations
lIST OF TABLES
Table I Summary
of Complaint/Summons/Prosecution in the Reporting Month
Table 1.1 Key Project Contacts
Table 1.2 Summary of Environmental Licensing
and Permit Status
Table 4.1 Quantities of Waste Generated from
the Project
Table 6.1 Observations and Recommendations of
Site Inspections
Table 6.2 Status of Required Submission under
Environmental Permit
lIST OF FIGUREs
Figure 1.1 Site
Layout Plan
Figure 1.2 Project
Organisation for Environmental Monitoring and Audit
lIST OF APPENDIces

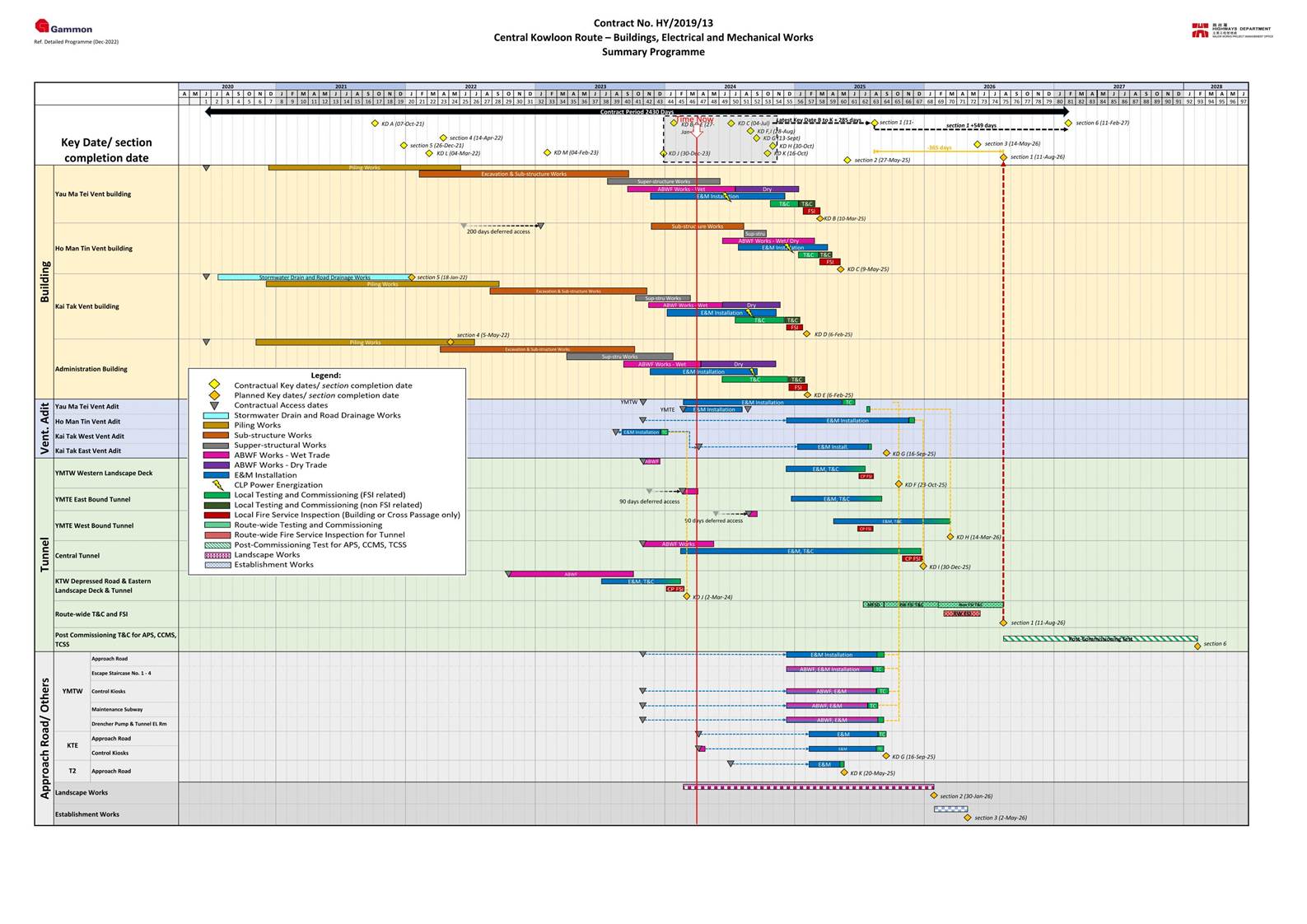

Appendix A Construction Programme
Appendix B Summary of Waste Generation and Disposal Records
Appendix C Environmental Mitigation Implementation Schedule (EMIS)
Appendix D Summaries of Environmental Complaint, Warning, Summon and Notification of Successful Prosecution
Introduction
Environmental Monitoring Works
Complaint Handling, Prosecution and Public Engagement
5. Summary of complaint/summons/prosecution in the reporting month is tabulated in Table I.
Event |
Event Details |
Follow-up/ Remedial Actions |
Status/ Remarks |
||
Number |
Brief Description |
||||
Complaints Received |
0 |
- |
- |
- |
|
Notification of Summons
and Prosecutions Received |
0 |
- |
- |
- |
|
Reporting Changes
Future Key Issues
Party |
Role |
Contact Person |
Phone No. |
AMMJV |
Engineer Representative |
Mr. Tommy Wong |
3695 0419 |
Cinotech |
Environmental Team |
Ms. Betty Choi |
2151 2072 |
ERM |
Independent Environmental Checker |
Ms. Mandy To |
2271 3113 |
GCL |
Contractor |
Mr. Sampson Lo |
9752 9118 |
Permit /
License No. |
Valid Period |
Status |
|
From |
To |
||
Environmental
Permit (EP) |
|||
EP-457/2013/D |
15 Jun 2021 |
N/A |
Valid |
Notification
of Construction Works under Air Pollution Control Ordinance (APCO) |
|||
457325 |
19 Jun 2020 |
End of Project |
Valid |
Billing
Account for Construction Waste Disposal |
|||
7037679 |
26 Jun 2020 |
N/A |
Valid |
Registration
of Chemical Waste Producer – YVB |
|||
5117-253-G2347-55 |
25 Aug 2020 |
N/A |
Valid |
Wastewater
Discharge Licence - YMT |
|||
WT00036898-2020 |
25 Nov 2020 |
30 Nov 2025 |
Valid |
Construction
Noise Permit (YVB Site - General Works) |
|||
GW-RE1191-23 |
5 Oct 2023 |
4 Mar 2024 |
Valid until 4 Mar 2024 and Superseded by
GW-RE0208-24 |
GW-RE0208-24 |
5 Mar2024 |
4 Sep 2024 |
Valid |
Quantity |
|||||||
|
Inert C&D Materials |
Non-inert C&D Materials |
|||||
Reporting Period |
Total Quantity Generated (in '000m3) |
Disposed as Public Fill (in '000m3) |
Others, e.g. general refuse (in '000m3) |
Metals (in '000kg) |
Paper/cardboard Packaging (in '000kg) |
Plastics (in '000kg) |
Chemical waste (in '000kg) |
Mar 2024 |
0.550 |
0.550 |
0.276 |
0 |
0 |
0 |
0 |
Parameters |
Date |
Observations |
Follow-up Actions |
Water Quality |
N/A |
No environmental deficiency was identified in the
reporting period. |
N/A |
Air Quality |
N/A |
No environmental deficiency was identified in the
reporting period. |
N/A |
Noise |
N/A |
No environmental deficiency was identified in the
reporting period. |
N/A |
Waste / Chemical Management |
5 March 2024 |
General refuse should be
disposed of regularly and properly. |
General refuse been
removed. |
Land Contamination |
N/A |
No environmental deficiency was identified in the
reporting period. |
N/A |
Landscape and Visual |
N/A |
No environmental deficiency was identified in the
reporting period. |
N/A |
Permits /Licences |
N/A |
No environmental deficiency was identified in the
reporting period. |
N/A |
EP Condition (EP-457/2013/D) |
Submission |
Submission
Date |
Condition 3.4 |
Monthly
EM&A Report (February 2024) |
14 March 2024 |
Figure 1.1
Site Layout Plan
Figure 1.2
Project Organisation for
Environmental Monitoring and Audit
Appendix A
Construction Programme
Appendix B
Summary of Waste Generation
and Disposal Records
Appendix C
Environmental Mitigation
Implementation Schedule (EMIS)
Appendix D
Summaries of Environmental
Complaint, Warning, Summon and Notification of Successful Prosecution
