I.
Introduction
This
is the 11th Monthly EM&A Report prepared by Fugro Technical
Services Limited for the Contract no. HY/2018/08 Central Kowloon Route ¡V
Central Tunnel. The Contract no. HY/2018/08 commenced on 19 September 2019.
This report summarized the monitoring results and audits findings of the
EM&A programme under the issued EP (EP No.: EP-457/2013/C) and in
accordance with the EM&A Manual during the reporting period from 01/07/2020
to 31/07/2020.
II.
Summary
of Main Works Undertaken and Key Measures Implemented
The main construction
works carried out in the reporting period were as follow:
¡P
Drill
and Blast excavation;
¡P
Mucking
out from tunnel;
¡P
Construction
of spoil basin;
¡P
Construction
of noise enclosure;
¡P
Installation
of gantry crane;
¡P
Shaft
installation;
¡P
Extensive
grouting.
III.
Summary
of Exceedances, Investigation and Follow-up
No
Action and Limit Level exceedance was recorded for construction dust monitoring
in the reporting month.
Three
(3) Action Level exceedances were recorded for construction
noise due to the noise-related complaints. No Limit Level exceedance was
recorded for construction noise monitoring in the reporting month.
IV.
Complaint
Handling, Prosecution and Public Engagement.
Three (3) noise-related,
one (1) landscape and visual and two (2) waste management related complaints
were received in the reporting month. The complaint cases in July 2020 are
summarized in Table I.
Table I Environmental
Complaints Log
Complaint Log No. |
Date of Complaint |
Received From |
Nature of Complaint |
Status |
EC019_CKRCT20200703_063 |
3rd July 2020 |
Contract Complaint Hotline |
Construction Noise |
Under investigation and the investigation results will be reported in the subsequent
Monthly EM&A Report. |
EC020_CKRCT20200710_066 |
10th July 2020 |
Contract Complaint Hotline |
Waste Management |
Investigation report was finalized on 23 July 2020. |
EC021_CKRCT20200710_067 |
10th July 2020 |
Contract Complaint Hotline |
Construction Noise |
Investigation report was finalized on 23 July 2020. |
EC022_CKRCT20200722_070 |
22nd July 2020 |
Contract Complaint Hotline |
Waste Management |
Investigation report was finalized on 31 July 2020. |
EC023_CKRCT20200725_072 |
25th July 2020 |
Contract Complaint Hotline |
Landscape and Visual |
Investigation report was finalized on 31 July 2020. |
EC024_CKRCT20200728_073 |
28th July 2020 |
Contract Complaint Hotline |
Construction Noise |
Investigation report was finalized on 4 August 2020. |
No notification of
summons and prosecutions were received in the reporting period.
No public engagement
activities were conducted in the reporting period.
V.
Reporting
Change
There were no
reporting changes during the reporting month.
VI.
Future
Key Issues
The main works will be
anticipated in the next reporting period are as follow:
¡P
Drill
and Blast excavation;
¡P
Mucking
out from tunnel;
¡P
Construction
of spoil basin;
¡P
Construction
of noise enclosure;
¡P
Shaft
Installation;
¡P
Extensive
grouting.
The
recommended mitigation measures corresponding to the main works in the next
reporting period are listed as follow:
¡P
Mitigation
measures in form of regular watering under a good site practice should be
adopted, particularly for the earthwork and breaking activities;
¡P
Any
excavated, stockpile of dusty material or load of dusty materials on a vehicle
leaving a construction site should be covered entirely by impervious sheeting;
¡P
All
construction plants / machineries should be checked / serviced on a regular
basis during the courses of construction to minimize the emission of noise
generation and eliminate dark smoke emission;
¡P
All
C&D materials generated should be transported and stored at temporary
storage area. Suitable materials should be sorted for reuse on-site;
¡P
Every
vehicle shall be cleaned thorough at the designated wheel washing area onsite;
¡P
Wastewater
generated from drilling shall be properly collected for reuse or treated by
wastewater treatment facilities before discharge;
¡P
Provision
of drip trays for equipment likely cause spillage of chemical / fuel, and
provide routine maintenance;
¡P
Erecting
temporary noise barrier for noisy Powered Mechanical Equipment (PME) and
deployment of Quality Powered Mechanical Equipment (QPME) as many as
practicable;
¡P
Conditions
in the Environmental Permit and License should be followed;
¡P
All
recommended mitigation measures specified in the approved EIA Report and
EM&A Manual shall be implemented.
The
following EP submissions (EP-457/2013/C) were submitted during the reporting
month:
Table II Status
of Required Submission under Environmental Permit
EP Condition |
Submission |
Submission
Date |
3.4 |
Monthly EM&A Report (June 2020) |
14 July 2020 |
Contents
1.3 Construction Programme and Activities
1.4 Works undertaken during the month
1.5 Status of Environmental Licences, Notification and
Permits
2.1 Construction Dust and Noise Monitoring Location
2.2 Construction Dust Monitoring
2.3 Construction Noise Monitoring
2.4 Construction Dust and Noise Monitoring Schedule
2.5 The Action and Limit Levels
3.1 Construction Dust Monitoring
3.2 Construction Noise Monitoring
5.1 Complaint Handling, Prosecution and Public
Engagement
5.2 Summary of Environmental Non-Compliance
5.3 Summary of Monitoring Exceedance
Tables
Table I ¡V Environmental Complaints Log
Table II
¡V Status of Required Submission under Environmental Permit
Table 1.1
¡V Contact Information of Key Personnel
Table 1.2
¡V Environmental Licenses, Notification and Permits Summary
Table 2.1
¡V Construction Dust and Noise Monitoring Location
Table 2.2
¡V Construction Dust Monitoring Equipment
Table 2.3
¡V Construction Noise Monitoring Parameters, Frequency and Duration
Table 2.4
¡V Construction Noise Monitoring Equipment
Table 3.1
¡V Summary of 1-hour TSP Monitoring Results in the Reporting Period
Table 3.2
¡V Summary of 24-hour TSP Monitoring Results in the Reporting Period
Table 3.3
¡V Summary of Construction Noise Monitoring Results in the Reporting Period
Table 4.1
¡V Observations and Recommendation of Site Inspection in the Reporting Period
Table 5.1
¡V Environmental Complaints Log
Table 6.1
¡V Status of Required Submission under Environmental Permit
Figures
Figure 1 The Site Layout Plan of the Contract
Figure 2 The Location of the Construction
Dust and Noise Monitoring Station
Appendices
Appendix A Construction Programme
Appendix
B Project Organization Chart
Appendix
C Calibration Certificate for
Construction Dust Monitoring Equipment
Appendix
D Calibration Certificate for Construction
Noise Monitoring Equipment
Appendix
E Environmental Monitoring Schedule
Appendix
F Action and Limit Levels for
Construction Dust and Noise Monitoring
Appendix
G Construction Dust Monitoring Results and
Meteorological Observations
Appendix
H Construction Noise Monitoring Results
Appendix
I Event and Action Plan
Appendix
J Implementation Status of
Environment Mitigation Measures (Construction Phase)
1.1.1 In order to meet the traffic demand and
relieve traffic congestion on the existing east-west roads across Central
Kowloon, Central Kowloon Route (CKR) (hereinafter referred to as ¡§the Project¡¨)

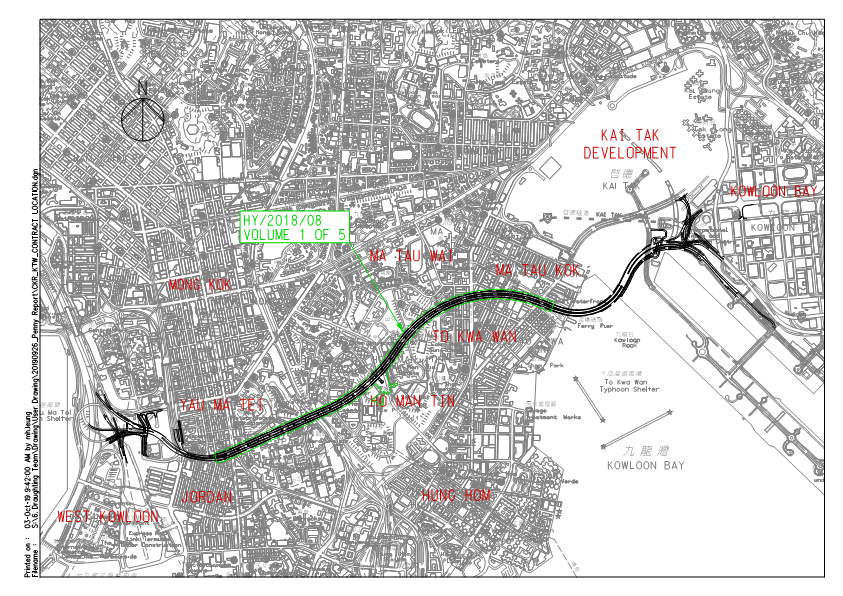

is proposed which is a 4.7 km long dual 3-lane trunk road in Central Kowloon
linking Yau Ma Tei Interchange in West Kowloon with the road network on Kai Tak
Development and Kowloon Bay in East Kowloon.
1.1.2 The Central Kowloon Route ¡V Design and
Construction Environmental Impact Assessment Report (Register No.:
AEIAR-171/2013) was approved with conditions by the Environmental Protection
Department (EPD) on 11 July 2013. An Environmental Permit (EP-457/2013) was issued
on 9 August 2013. Variations of EP (VEP) was subsequently applied for and the
latest EP (EP-457/2013/C) was issued by EPD on 16 January 2017.
1.1.3 Contract no. HY/2018/08 Central Kowloon
Route ¡V Central Tunnel (hereinafter referred to as ¡§the Contract¡¨), is one of
the contracts of CKR which included the construction of the central tunnel,
cut-and-cover tunnels at Yau Ma Tei and Ma Tau Kok and construction of piles
and diaphragm walls for Ho Man Tin ventilation building.
1.1.4 Fugro Technical Services Limited (FTS) was
appointed by Bouygues Travaux Publics (BTP) as the Environmental Team (ET)
under the Contract no. HY/2018/08) to execute the environmental monitoring and
audit (EM&A) programme under the issued EP (EP No.: EP-457/2013/C) and in
accordance with the EM&A Manual.
1.1.5
This
is the 11th Monthly EM&A Report prepared by FTS for the Contract
no. HY/2018/08 Central Kowloon Route ¡V Central Tunnel. The Contract no.
HY/2018/08 commenced on 19 September 2019. This report summarized the
monitoring results and audits findings of the EM&A programme under the
issued EP (EP No.: EP-457/2013/C) and in accordance with the EM&A Manual
during the reporting period from 01/07/2020 to 31/07/2020.
1.2.1 The Project Organization structure is
shown in Appendix B. The key personnel contact
names and numbers are summarized in Table 1.1.
Table 1.1 Contact
Information of Key Personnel
Party |
Position |
Name |
Telephone |
Highways Department (HyD) |
E13/CKR |
Mr. Joe Lam |
2762 3380 |
Arup-Mott MacDonald Joint Venture (AMMJV) |
Senior Resident Engineer |
Mr. Ben Poon |
3619 5967 |
ERM-Hong Kong, Limited (ERM) |
Independent Environmental
Checker (IEC) |
Ms. Mandy To |
2271 3000 |
Bouygues Travaux Publics (BTP) |
Environmental Manager |
Mr. Simon Wong |
9281 4346 |
Fugro Technical Services Limited |
ET Leader |
Mr. David Hung |
3565 4371 |
1.3
Construction
Programme and Activities
1.3.1 The construction phase of this Contract
under the EP was commenced in October 2019. The site layout plan of the
Contract is shown in Figure 1.
1.3.2 The construction programme of this
Contract is shown in Appendix A.
1.4
Works
undertaken during the month
1.4.1 The main construction works carried out in
the reporting period were as follow:
¡P
Drill
and Blast excavation;
¡P
Mucking
out from tunnel;
¡P
Construction
of spoil basin;
¡P
Construction
of noise enclosure;
¡P
Installation
of gantry crane;
¡P
Shaft
installation;
¡P
Extensive
grouting.
1.5
Status of
Environmental Licences, Notification and Permits
1.5.1 A summary of the relevant permits,
licenses and/or notifications on environmental protection for this Contract is
presented in Table 1.2.
Table 1.2 Environmental
Licenses, Notification and Permits Summary
Permit/
Notification/ License |
Reference No |
Valid From |
Valid Till |
Form NB |
448930, 448970, 448971 |
Mid-Sep 2019 |
NA |
Billing Account for
Disposal of C&D waste |
Account no. 7034790 |
6 Aug 2019 |
NA |
Chemical Waste
Producer Registration |
5111-236-B2557-02 |
25 Sep 2019 |
NA |
Construction Noise
Permit (Ho Man Tin Construction
site) |
GW-RE0533-20 |
22 Jun
2020 |
15 Nov
2020 |
Water Discharge
License |
WT00034873-2019 |
22 Nov
2019 |
30 Nov
2024 |
WT00035436-2019 |
2 Apr
2020 |
30 Apr
2025 |
2. ENVIRONMENTAL
MONITORING REQUIREMENTS
2.1 Construction
Dust and Noise Monitoring Location
2.1.1 The monitoring station for construction
dust and noise monitoring pertinent to the Project has been identified based on
the approved EM&A Manual for the Project. The location of the construction
dust and noise monitoring station is summarized in Table 2.1 and displayed in Figure
2.
Table 2.1
Construction Dust and Noise Monitoring Location
Dust
Monitoring Station ID |
Noise
Monitoring Station ID |
Monitoring
Location |
M-A3 |
M-N3 |
SKH Tsoi Kung Po Secondary School |
Notes:
1. The dust and noise monitoring station
proposed in the EM&A Manual (i.e. Ko Fai House, Kwun Fai Court with ID:
M-A6/ M-N6) was not available for impact dust and noise monitoring, therefore
impact monitoring was conducted at M-A3/M-N3 as an alternative which was agreed
by the ER, IEC and EPD;
2. The coordinates of SKH Tsoi Kung Po
Secondary School can be represented as follow:
Latitude: 22.314719, Longitude: 114.180694
(HK80 Geographical Coordinates)
2.2
Construction Dust Monitoring
Monitoring Requirement
2.2.1 In accordance with the approved EM&A
Manual, 1-hour and 24-hour Total Suspended Particulates (TSP) levels should be
measured at the designated air quality monitoring stations to indicate the
impacts of construction dust on air quality. Regular Impact 24-hour TSP
monitoring should be carried out for at least once every 6 days, and 1-hour TSP
monitoring should be done at least 3 times every 6 days when the highest dust
impact occurs.
Monitoring Equipment
2.2.2
24-hour
TSP air quality monitoring was performed using High Volume Sampler (HVS)
deployed at the designated monitoring station. The HVS shall meet all the
requirements of the EM&A Manual.
2.2.3 A portable direct reading dust meter was
used to carry out the 1-hour TSP monitoring.
2.2.4 The model of the dust monitoring equipment
used is summarized in Table 2.2.
Table 2.2 Construction
Dust Monitoring Equipment
Equipment |
Brand |
Model |
Serial No. |
High Volume Sampler (24-hour TSP) |
Tisch |
TE-5170 |
4388 |
Calibrator |
Tisch |
TE-5025A |
2456 |
Portable direct reading dust meter (1-hour TSP) |
Sibata |
LD-5R |
882148 |
Monitoring Methodology for HVS
2.2.5
The
following guidelines were adopted during the installation of HVS:
¡P
Sufficient
support is provided to secure the samplers against gusty wind.
¡P
No
two samplers are placed less than 2 meters apart.
¡P
The
distance between the sampler and an obstacle, such as buildings, is at least
twice the height that the obstacle protrudes above the sampler.
¡P
A
minimum of 2 meters of separation from walls, parapets and penthouses is
required for rooftop samples.
¡P
A
minimum of 2 meters separation from any supporting structure, measured
horizontally is required.
¡P
No
furnaces or incineration flues are nearby.
¡P
Airflow
around the samplers is unrestricted.
¡P
The
samplers are more than 20 meters from the drip line.
¡P
Any
wire fence and gate, to protect the sampler, should not cause any obstruction
during monitoring.
¡P
Permission
must be obtained to set up the samplers and to obtain access to the monitoring
stations.
¡P
A
secured supply of electricity is needed to operate the samplers.
2.2.6
Prior
to the commencement of the dust sampling, the flow rate of the high volume
sampler shall be properly set. The power supply should be checked to ensure the
proper functioning of the sampler. The sampler is recommended to be operated
for 5 minutes to establish thermal equilibrium before placing any filter media
at the designated air monitoring station.
2.2.7
The
filter holding frame should be removed by loosening the four nuts and placing
carefully a weighted and conditioned filter at the centre with the stamped
number upwards on a supporting screen.
2.2.8
The
filter should be aligned on the screen so that the gasket formed an airtight
seal on the outer edges of the filter. The filter holding frame should be
tightened to the filter holder with swing bolts. The applied pressure should be
sufficient to avoid air leakage at the edges.
2.2.9
A
programmed timer should be used to control the duration of operation.
Information should be recorded on the record sheet, which included the starting
time, the weather condition and the filter number.
2.2.10
After
sampling process is finished, the filter should be removed and sent to the
laboratory for weighting. The elapsed time should also be recorded.
2.2.11
All
filters should be equilibrated in a conditioning environment for 24 hours
before weighting. The conditioning environment temperature should be between
25¢XC and 30¢XC and not vary by more than ¡Ó3¢XC; the relative humidity (RH) should be
<50% and not vary by more than ¡Ó5%. A convenient working RH is 40%.
Maintenance and Calibration for HVS
2.2.12
The
high volume motors and their accessories should be properly maintained,
including routine motor brushes replacement and electrical wiring checking, to
ensure that the equipment and a continuous power supply were in good working
condition.
2.2.13 Initial calibration of dust monitoring
equipment shall be conducted upon installation and thereafter at fortnightly
intervals. The transfer standard shall be traceable to the internationally
recognized primary standard and be calibrated annually. The calibration certificate
for the HVS is provided in Appendix C.
Monitoring Methodology for Direct Reading Dust Meter
2.2.14
Portable
Laser Particle Photometer Monitors should be operated in accordance with the
Manufacturer¡¦s instruction Manual as below:
a) Pulling up the air sampling inlet cover
b) Changing the Mode 0 to BG
c) Pressing Start/Stop switch
d) Turning the knob to SENSI.ADJ and press it
e) Pressing Start/Stop switch again
f) Returning the knob to the position MEASURE slowly
g) Pressing the timer set switch to set measuring time
h) Removing the cap and start the measurement
Maintenance and Calibration for Direct Reading Dust Meter
2.2.15 ET shall submit sufficient information to
the IEC to prove that the instrument is capable of achieving comparable results
to the HVS. The instrument should also be calibrated regularly, and the 1-hour
sampling shall be determined periodically by the HVS to check the validity and
accuracy of the results measured by direct reading method. The calibration
certificate for the direct reading dust meter is provided in Appendix
C.
2.3 Construction
Noise Monitoring
Monitoring Requirement
2.3.1
In
accordance with the EM&A Manual, impact noise monitoring should be
conducted at the designated noise monitoring stations for at least once a week
during the construction phase of the Project. The parameters, frequency and
duration of impact noise monitoring is summarized in Table 2.3.
Table 2.3
Construction Noise Monitoring Parameters, Frequency and Duration
Parameter |
Duration |
Frequency |
A-weighted equivalent
continuous sound pressure level (Leq). L10 and L90 were also recorded |
30 minutes |
At least once per week |
Monitoring Equipment
2.3.2
Noise
monitoring was performed using sound level meter at the designated monitoring
station. The sound level meters deployed comply with the International
Electrotechnical Commission Publications 651:1979 (Type 1) and 804:1985 (Type
1) specifications. Acoustic calibrator was deployed to check the sound level
meters at a known sound pressure level.
2.3.3 The model of the noise monitoring
equipment used is summarized in Table
2.4.
Table 2.4 Construction
Noise Monitoring Equipment
Equipment |
Brand |
Model |
Serial No. |
Acoustic Calibrator |
Casella |
CEL-120/1 |
4358443 |
Sound Level Meter |
Casella |
CEL-63X |
4181568 |
Monitoring Methodology
2.3.4
Noise
measurement should be conducted as the following procedures:
a) Free field measurements was made at monitoring location M-N3. A
correction of +3 dB(A) shall be made to the free field measurements.
b) The battery condition should be checked to ensure good functioning of
the meter.
c) Parameters such as frequency weighting, the time weighting and the
measurement time should set as follow:
(i) Frequency
weighting: A
(ii) Time
weighting: Fast
(iii) Measurement
time: continuous 5 minutes interval
d) Prior to and after noise measurement, the meter shall be calibrated
using the calibrator for 94.0 dB at 1000 Hz. If the difference in the
calibration level before and after measurement is more than 1.0 dB, the
measurement will be considered invalid and repeat of noise measurement is
required after re-calibration or repair of the equipment.
e) The wind speed at the monitoring station shall be checked with the
portable wind meter. Noise monitoring should be cancelled in the presence of
fog, rain, and wind with a steady speed exceeding 5 m/s, or wind with gusts
exceeding 10 m/s.
f) Noise measurement should be paused during periods of high intrusive
noise if possible and observation shall be recorded when intrusive noise is not
avoided.
g) At the end of the monitoring period, the Leq, L10 and L90 should be
recorded. In addition, site conditions and noise sources should also be
recorded on a standard record sheet.
Maintenance and Calibration
2.3.5
Maintenance
and calibration procedures should also be carried out, including:
a) The microphone head of the sound level
meter and calibrator should be cleaned with a soft cloth at quarterly
intervals.
b) The sound level meter and calibrator
should be calibrated annually by a HOKLAS laboratory or the manufacturer.
The
calibration certificates for noise monitoring equipment are provided in Appendix
D.
2.4 Construction
Dust and Noise Monitoring Schedule
2.4.1
The
environmental monitoring schedule for the reporting period is provided in Appendix E.
2.5 The Action
and Limit Levels
2.5.1
The
Action and Limit Levels for construction dust and noise monitoring are provided
in Appendix F.
2.6.1
As
per the EM&A Manuals, the landscape and visual mitigation measures shall be
implemented and site inspections should be undertaken once every two weeks
during the construction period. A summary of the implementation status is
presented in Section 4.
3. ENVIRONMENTAL
MONITORING RESULTS
3.1 Construction
Dust Monitoring
3.1.1 The monitoring results for 1-hour TSP and
24-hour TSP are summarized in Table 3.1 and Table 3.2
respectively. Detailed construction dust monitoring results and daily extract
of meteorological observations are presented in Appendix G.
Table 3.1 Summary
of 1-hour TSP Monitoring Results in the Reporting Period
Station ID |
Average (µg/m3) |
Range (µg/m3) |
Action Level
(µg/m3) |
Limit Level (µg/m3) |
M-A3 |
33 |
20-47 |
333 |
500 |
Table 3.2 Summary
of 24-hour TSP Monitoring Results in the Reporting Period
Station ID |
Average (µg/m3) |
Range (µg/m3) |
Action Level
(µg/m3) |
Limit Level (µg/m3) |
M-A3 |
28 |
13-49 |
153 |
260 |
3.1.2 No Action and Limit Level exceedance was
recorded for 1-hour TSP monitoring and 24-hour TSP monitoring at the monitoring
location in the reporting month.
3.1.3 Major dust sources during the monitoring
included nearby traffic emission.
3.1.4 The Event and Action Plan for the
construction dust monitoring is given in Appendix I.
3.2
Construction Noise Monitoring
3.2.1 The monitoring results for noise are
summarized in Table 3.3 and the monitoring data is given in Appendix H.
Table 3.3 Summary
of Construction Noise Monitoring Results in the Reporting Period
Station ID |
1Measured
Noise Level, dB(A), Leq (30 mins) |
2Corrected
Noise Level, dB(A), Leq (30 mins) |
Action Level |
3Limit Level
dB(A), Leq (30 mins) |
M-N3 |
68.4-70 |
64.8 |
When one documented
compliant is received |
For Schools: 70dB(A) during normal
teaching period and 65 dB(A) during examination periods |
Notes:
1.
Free field noise levels were adjusted with a correlation of +3 dB(A);
2.
Corrected Noise Level was applied on 6 July 2020;
Corrected Noise Level =10* log
(10^ (Measured Noise Level/10) ¡V 10^ (Baseline Noise Level/10));
3.
The Limit Level was 70 dB(A) for teaching period (from 7 to 30 July
2020) and 65 dB(A) for
examination period (from 2 to 6 July 2020).
3.2.2
No Limit Level
exceedance was recorded for construction noise monitoring at the monitoring
location in the reporting month.
3.2.3
Three (3) Action Level
exceedances were recorded for construction noise due to the noise-related
complaints received in the reporting month.
3.2.4
Major noise sources
during the monitoring included nearby traffic emission and school activities.
The Event and Action
Plan for the construction noise monitoring is given in Appendix
I.
3.3
Waste Management
3.3.1 Auditing of waste management practices
during regular site inspections were confirmed that the waste generated during
construction were properly, stored, handled and disposed of in general. The
Contractor was responsible for the implementation of any mitigation measures to
reduce waste or redress issues arising from the waste materials.
3.3.2 The implemented environmental mitigation
measures for the waste management in the reporting period are summarized in Appendix J. The summary of observations and
recommendations made for waste management during the site inspections are
presented in Table 4.1
3.3.3 Monthly summary of waste flow table is
detailed in Appendix L.
3.4.1 Bi-weekly inspection of the implementation
of landscape and visual mitigation measures were conducted on 7 and 21 July
2020. The implementation the landscape and visual mitigation measures in the
reporting period are summarized in Appendix J. The summary of observations and
recommendations made for landscape and visual mitigation measures during the
site inspections are presented in Table 4.1.
3.4.2 The Event and Action Plan for landscape
and visual during construction phase is given in Appendix
I.
4. ENVIRONMENTAL
SITE INSPECTION AND AUDIT
Site inspections were
carried out on a weekly basis to monitor the implementation of proper
environmental pollution control and mitigation measures for the Project. A
summary of the mitigation measures implementation status is provided in Appendix
J.
In the reporting month,
four site inspections were carried out on 7, 14, 21 (with IEC) and
30 July 2020. Details of observations recorded during the site inspections are
presented in Table 4.1.
Table 4.1 Observations
and Recommendation of Site Inspection in the Reporting Period
Environmental
Aspect |
Date |
Observations
and Recommendations |
Follow-up
Actions |
Air Quality |
Nil |
Nil |
Nil |
Noise |
Nil |
Nil |
Nil |
Water Quality |
Nil |
Nil |
Nil |
Waste Management |
Nil |
Nil |
Nil |
Landscape and Visual |
7 July 2020 |
Tree protection zone should be enhanced. |
The item was rectified by the Contractor on 14
July 2020. |
Permit/ Licenses |
Nil |
Nil |
Nil |
Complaint Handling, Prosecution and Public
Engagement
5.1.1
No environmental
related prosecutions or notification of summons were received in the reporting
period.
5.1.2
Three (3) noise-related,
one (1) landscape and visual and two (2) waste management related complaints
were received in the reporting month. The
complaint cases in July 2020 are summarized in Table 5.1.
Table 5.1 Environmental
Complaints Log
Complaint Log No. |
Date of Complaint |
Received From |
Nature of Complaint |
Status |
EC019_CKRCT20200703_063 |
3rd July 2020 |
Contract Complaint Hotline |
Construction Noise |
Under investigation and the investigation results will be reported in the subsequent
Monthly EM&A Report. |
EC020_CKRCT20200710_066 |
10th July 2020 |
Contract Complaint Hotline |
Waste management |
Investigation report was finalized on 23 July 2020. |
EC021_CKRCT20200710_067 |
10th July 2020 |
Contract Complaint Hotline |
Construction Noise |
Investigation report was finalized on 23 July 2020. |
EC022_CKRCT20200722_070 |
22nd July 2020 |
Contract Complaint Hotline |
Waste management |
Investigation report was finalized on 31 July 2020. |
EC023_CKRCT20200725_072 |
25th July 2020 |
Contract Complaint Hotline |
Landscape and Visual |
Investigation report was finalized on 31 July 2020. |
EC024_CKRCT20200728_073 |
28th July 2020 |
Contract Complaint Hotline |
Construction Noise |
Investigation report was finalized on 4 August 2020. |
5.1.3
Cumulative complaint
log, summaries of complaints, notification of summons and successful
prosecutions are presented in Appendix K.
No public engagement
activities were conducted in the reporting period.
Summary of Environmental Non-Compliance
5.1.4
No environmental
non-compliance was recorded in the reporting period
Summary of Monitoring Exceedance
5.1.5
Three (3) Action Level
exceedances were recorded for construction noise due to the noise-related
complaints received in the reporting month. No Limit Level exceedance was
recorded for construction noise monitoring in the reporting month.
5.1.6
No Action and Limit
Level exceedance was recorded for construction dust monitoring in the reporting
month.
6.
IMPLEMENTATION STATUS OF
ENVIRONMENTAL MITIGATION MEASURE
6.1.1 The Contractor had implemented
environmental mitigation measures and requirements as stated in the EIA
Reports, the EP and EM&A Manuals. The implementation status of the
environmental mitigation measures during the reporting period is summarized in Appendix J. Status of required submissions under the
EP during the reporting period is summarised in Table 6.1.
Table 6.1
Status of Required Submission under Environmental Permit
EP Condition |
Submission |
Submission
Date |
3.4 |
Monthly EM&A
Report (June 2020) |
14 July
2020 |
The main works will be
anticipated in the next reporting period are as follow:
¡P
Drill
and Blast excavation;
¡P
Mucking
out from tunnel;
¡P
Construction
of spoil basin;
¡P
Construction
of noise enclosure;
¡P
Shaft
installation;
¡P
Extensive
grouting.
The recommended
mitigation measures corresponding to the main works in the next reporting
period are listed as follow:
¡P
Mitigation
measures in form of regular watering under a good site practice should be
adopted, particularly for the earthwork and breaking activities;
¡P
Any
excavated, stockpile of dusty material or load of dusty materials on a vehicle
leaving a construction site should be covered entirely by impervious sheeting;
¡P
All
construction plants / machineries should be checked / serviced on a regular
basis during the courses of construction to minimize the emission of noise
generation and eliminate dark smoke emission;
¡P
All
C&D materials generated should be transported and stored at temporary
storage area. Suitable materials should be sorted for reuse on-site;
¡P
Every
vehicle shall be cleaned thorough at the designated wheel washing area onsite;
¡P
Wastewater
generated from drilling shall be properly collected for reuse or treated by
wastewater treatment facilities before discharge;
¡P
Provision
of drip trays for equipment likely cause spillage of chemical / fuel, and
provide routine maintenance;
¡P
Erecting
temporary noise barrier for noisy Powered Mechanical Equipment (PME) and
deployment of Quality Powered Mechanical Equipment (QPME) as many as
practicable;
¡P
Conditions
in the Environmental Permit and License should be followed;
¡P
All
recommended mitigation measures specified in the approved EIA Report and
EM&A Manual shall be implemented.
The environmental
monitoring schedule for the next reporting month is provided in Appendix
E.
8.
CONCLUSION AND
RECOMMENDATIONS
8.1.1 The 11th Monthly EM&A
Report for the Contract no. HY/2018/08 Central Kowloon Route ¡V Central Tunnel
summarized the monitoring results and audits findings of the EM&A programme
under the issued EP (EP No.: EP-457/2013/C) and in accordance with the EM&A
Manual during the reporting period from 01/07/2020 to 31/07/2020.
8.1.2 Construction dust (including 1-hour and
24-hour TSP) and noise monitoring were carried out in the reporting period.
8.1.3 Three (3) Action Level exceedances were
recorded for construction noise due to the noise-related complaints received in
the reporting month. No Limit Level exceedance was recorded for construction
noise monitoring in the reporting month. No Action and Limit Level exceedance
was recorded for construction dust monitoring in the reporting month.
8.1.4 Weekly environmental site inspections were
conducted during the reporting period. In general, the Contractor had
implemented environmental mitigation measures and requirements as stated in the
EIA Reports, the EP and EM&A Manuals.
8.1.5 Three (3) noise-related, one (1) landscape
and visual and two (2) waste management related complaints were received respectively
on 3, 10, 22, 25 and 28 July 2020 via the complaint hotline of the Contractor.
The investigation report of 3 July 2020 was under investigation and the
investigation results will be reported in the subsequent Monthly EM&A
Report. The investigation reports for the complaints were finalized on 23, 31
July 2020 and 4 August 2020 respectively.
8.1.6 No environmental related prosecutions or
notification of summons were received in the reporting period.
8.1.7 No environmental non-compliance was
recorded in the reporting period.
8.1.8 According to the environmental site
inspections performed in the reporting month, the following recommendations
were provided:
Air Quality Impact
¡P
No specific observation was identified in the
reporting month.
Construction Noise Impact
¡P
No specific observation was identified in the
reporting month.
Water Quality Impact
¡P
No specific observation was identified in the
reporting month.
Waste Management
¡P
No specific observation was identified in the
reporting month.
Landscape and Visual Impact
¡P
Tree protection zone should be enhanced.
Permit/ Licenses
¡P
No specific observation was identified in the
reporting month.
