TABLE OF CONTENTS
Construction Activities
undertaken during the Reporting Month
Statues of Environmental
Licensing and Permitting
Monitoring Parameters,
Frequency and Duration
Monitoring Methodology and
QA/QC Procedure
Monitoring Parameters,
Frequency and Duration
Monitoring Methodology and
QA/QC Procedure
Implementation Status of
Environmental Mitigation Measures
Implementation Status of
Event and Action Plans
Summary of Complaint,
Warning, Notification of any Summons and Successful Prosecution
Monitoring Schedule for
Next Month
lIST OF TABLES
Table I............... Summary of Complaint/Summons/Prosecution in
the Reporting Month
Table
1.1............ Key Project Contacts
Table
1.2............ Summary of Environmental Licensing and
Permit Status
Table
2.1 ........... Locations for Air Quality Monitoring
Table
2.2 ........... Air Quality Monitoring Equipment
Table
2.3 ........... Impact Dust Monitoring Parameters,
Frequency and Duration
Table
3.1 ........... Noise Monitoring Stations
Table
3.2 ........... Noise Monitoring Equipment
Table
3.3 ........... Noise Monitoring Parameters, Frequency and
Duration
Table
3.4 ........... Baseline Noise Level and Noise Limit Level
for Monitoring Stations
Table
4.1............ Quantities of Waste Generated from the
Project
Table
6.1............ Observations and Recommendations of Site
Inspections
Table
6.2............ Status of Required Submission under
Environmental Permit
lIST OF FIGUREs
Figure 2 Project Organisation for
Environmental Monitoring and Audit
Figure 3 Location
of Monitoring Station
lIST OF APPENDIces
Appendix A Action and Limit Levels for Air Quality and Noise
Appendix B Copies of Calibration Certificates
Appendix C Weather Information
Appendix D Environmental Monitoring Schedules
Appendix E 1-hour TSP Monitoring Results and Graphical Presentations
Appendix F 24-hour TSP Monitoring Results and Graphical Presentations
Appendix G Noise Monitoring Results and Graphical Presentations
Appendix H Summary of Exceedance
Appendix J Environmental Mitigation Implementation Schedule (EMIS)
Appendix L Summary of Waste Generation and Disposal Records
Appendix M Construction Programme
Introduction
1. This is the 14th Monthly Environmental Monitoring and Audit (EM&A) Report prepared by the Environmental Team (ET), Cinotech Consultants Ltd., for Contract No. HY/2019/13 “Central Kowloon Route – Buildings, Electrical and Mechanical Works”. This report summarized the monitoring results and audit findings of the EM&A programme under the issued EP No. EP-457/2013/D, and in accordance with the EM&A programme in Central Tunnel (Ho Man Tin Area) during the reporting period from 1st February 2025 – 28th February 2025.
2. The major site activities undertaken in the reporting month included:
l
E&M Installation
l
T&C
Environmental
Monitoring Works
3. Environmental monitoring for the Project was performed in accordance with the EM&A Manual and the monitoring results were checked and reviewed. Joint weekly site inspections with the representative of ET, Engineer Representative and the Contractor for Contract No. HY/2019/13 were conducted on 4, 11, 18 & 25 February 2025, whereas joint site inspection with the representative of IEC was conducted on 11 February 2025. The implementation of the environmental mitigation measures, Event and Action Plans and environmental complaint handling procedures were also checked.
4.
A summary of the non-compliance (exceedance) during the reporting month (February 2025) and the investigation results and/or follow-up actions
is provided below:
Air Quality Monitoring
l No Action/Limit Level exceedance for 1-hour TSP was recorded.
l No Action/Limit Level exceedance for 24-hour TSP was recorded.
l
No Action Level exceedance for construction noise was recorded.
l No Limit Level exceedance for construction noise was recorded.
Landscape and Visual Monitoring
l No non-conformity for landscape and visual was recorded.
Complaint Handling, Prosecution and Public Engagement
5.
Summary of complaint/summons/prosecution in the
reporting month is tabulated in Table I.
Table I Summary of Complaint/Summons/Prosecution in the Reporting Month
Event |
Event Details |
Follow-up/ Remedial Actions |
Status/ Remarks |
|
Number |
Brief Description |
|||
Complaints
Received |
0 |
- |
- |
- |
Notification
of Summons and Prosecutions Received |
0 |
- |
- |
- |
Reporting Changes
6. There were no reporting changes during the reporting month.
Future Key Issues
7. The key works or activities will be anticipated in the coming two months are as follows:
l
E&M Installation
l
T&C
l
FSI
1.2 The Environmental Impact Assessment Report for Central Kowloon Route – Design and Construction (Register No.: AEIAR-171/2013) was approved under the Environmental Impact Assessment Ordinance (EIAO) on 11 July 2013. An Environmental Permit (EP No.: EP- 457/2013) was issued on 9 August 2013. Variations of Environmental Permit (VEP) was subsequently applied and an EP (EP No. EP-457/2013/C) was issued on 16 January 2017. The latest EP (EP No. EP-457/2013/D) was issued by Environmental Protection Department (EPD) on 15 June 2021.
1.3 The construction of the CKR had been divided into different sections. This Contract No. HY/2019/13 – Central Kowloon Route – Buildings, Electrical and Mechanical Works (“The Project”) will include the architectural, civil and structural construction works of Yau Ma Tei Ventilation Building (YVB), Ho Man Tin Ventilation Building (HVB), Kai Tak Ventilation Building (KVB) and Central Kowloon Route Administration Building (ADB) for the CKR. The landscaping and electrical and mechanical (E&M) works within the building sites will be involved as well.
1.4
Cinotech Consultants Limited
was assigned as the Environmental Team (ET) to undertake the EM&A works for
the Project. The construction of this Contract was commenced on 12th
December 2020.
1.5 The construction work on the Ho Man Tin area under Contract no. HY/2018/08 Central Kowloon Route – Central Tunnel was completed on 31 December 2023. Contract no. HY/2019/13 Central Kowloon Route – Buildings, Electrical and Mechanical Works in Ho Man Tin area was then commenced on 1 January 2024 and took over the site of Ho Man Tin area.
1.6 The baseline report for environmental monitoring was used the same as the HY/2018/08 on the Ho Man Tin area. The baseline air quality and noise monitoring were conducted in January 2018. The baseline monitoring results are presented in the Approved Baseline Monitoring Reports in accordance with EP-457/2013/C Condition 3.3 under Contract no. HY/2014/09 Central Kowloon Route – Ho Man Tin Access Shaft.
1.7 This is the 14th Monthly EM&A Report which summarises the impact monitoring results and audit findings for the EM&A programme in Central Tunnel (Ho Man Tin Area) during the reporting period from 1st February 2025 – 28th February 2025. The Central Tunnel (Ho Man Tin Area) site layout plan for the Project is shown in Figure 1.
1.8 Different Parties with different levels of involvement in the project organization include:
l Project Proponent – Highways Department (HyD)
l Engineer Representative (ER) – Arup – Mott MacDonald Joint Venture (AMMJV)
l Environmental Team (ET) – Cinotech Consultants Limited (Cinotech)
l Independent Environmental Checker (IEC) – Environmental Resources Management – Hong Kong Limited (ERM)
l
Contractor – Gammon Construction Limited (GCL)
1.9 The key contacts of the Project are shown in Table 1.1.
Table 1.1 Key Project Contacts
Party |
Role |
Contact Person |
Phone No. |
AMMJV |
Engineer Representative |
Mr. Tommy Wong |
3695 0419 |
Cinotech |
Environmental Team |
Ms. Betty Choi |
2151 2072 |
ERM |
Independent Environmental Checker |
Ms. Mandy To |
2271 3113 |
GCL |
Contractor |
Mr. William Chan |
5408 3045 |
1.10 The Organizational Structure for Environmental Management is shown in Figure 2.
Construction Activities undertaken during the Reporting Month
1.11 The construction programme is presented in Appendix M.
1.12 The major site activities undertaken in the reporting month included:
l
E&M Installation
l
T&C
1.13 The EM&A programme requires air quality monitoring, noise monitoring, landscape and visual monitoring, and environmental site audit. The EM&A requirements for each parameter are described in the following sections, including:
l Environmental requirements and mitigation measures, as recommended in the EM&A Manual under the EP.
Statues of Environmental Licensing and Permitting
1.15 All permits/licenses obtained for the Project are summarized in Table 1.2.
Table 1.2 Summary of Environmental Licensing and Permit Status
Permit / License No. |
Valid Period |
Status |
|
From |
To |
||
Environmental Permit (EP) |
|||
EP-457/2013/D |
15
Jun 2021 |
N/A |
Valid |
Notification of Construction Works under
Air Pollution Control Ordinance (APCO) |
|||
457345 |
19
Jun 2020 |
End
of Project |
Valid |
Billing Account for Construction Waste
Disposal |
|||
7037679 |
26
Jun 2020 |
N/A |
Valid |
Registration of Chemical Waste Producer –
Ho Man Tin |
|||
5213-236-G2347-61 |
28
Nov 2023 |
N/A |
Valid |
Wastewater Discharge Licence - Ho Man Tin |
|||
WT10002215-2023 |
2
Feb 2024 |
31
Jan 2029 |
Valid |
Construction Noise Permit - Ho Man Tin |
|||
GW-RE1255-24 |
14 Oct 2024 |
13 Apr 2025 |
Valid |
2.1 According to EM&A Manual under the EP, 1-hour and 24-hour TSP monitoring were conducted to monitor the air quality for this Project. For regular impact monitoring, a sampling frequency of at least once in every six days at all of the monitoring stations for 24-hour TSP monitoring. For 1-hour TSP monitoring, the sampling frequency of at least three times in every six days shall be undertaken when the highest dust impact occurs. Appendix A shows the established Action/Limit Levels for the environmental monitoring works.
2.2 Only one designated monitoring station was selected for 1-hour and 24-hour TSP impact dust monitoring programme. Both dust monitoring was conducted at the designated monitoring station (M-A3).
2.3 Table 2.1 describes the air quality monitoring locations, which are also depicted in Figure 3.
Table 2.1 Locations for Air Quality Monitoring
Monitoring
Stations |
Locations |
Location of Measurement |
M-A3 |
S.K.H. Tsoi Kung Po Secondary School |
Rooftop (above 3/F) Area |
2.4 Table 2.2 summarizes the equipment used in the impact air monitoring programme. Copies of calibration certificates are attached in Appendix B.
Table 2.2 Air Quality Monitoring Equipment
Equipment |
Model and Make |
Serial No. |
Quantity |
Calibrator |
TISCH TE-5025A |
3864 |
1 |
1-hour
TSP Dust Meter |
Dust Monitor System OC-9200 |
OC20210316224101 |
1 |
High
Volume Sampler |
TE-5170 c/w of TSP sampling inlet |
2204 |
1 |
Wind
Anemometer |
C-OC-9200-wind |
OC20210316224101 |
1 |
Monitoring Parameters, Frequency and Duration
2.5 Table 2.3 summarizes the monitoring parameters and frequencies of impact dust monitoring for the whole construction period. The air quality monitoring schedule for the reporting month is shown in Appendix D.
Table 2.3 Impact Dust Monitoring Parameters, Frequency and Duration
Parameters |
Frequency |
1-hour
TSP |
Three times /
6 days |
24-hour
TSP |
Once / 6 days |
Monitoring Methodology and QA/QC Procedure
1-hour TSP Monitoring
Measuring Procedures
2.6 The measuring procedures of the 1-hour dust meters were in accordance with the Manufacturer’s Instruction Manual as follows: (OC-9200 Dust Monitoring System)
l The 1-hour dust meter is placed at least 1.3 meters above ground.
l Set POWER to “ON” and make sure that the battery level was not flash or in low level.
l Allow the instrument to stand for about 3 minutes and then the cap of the air sampling inlet has been released.
l Push the knob at MEASURE position.
l Set time/mode setting to [BG] by pushing the time setting switch. Then, start the background measurement by pushing the start/stop switch once. It will take 6 sec. to complete the background measurement.
l Push the time setting switch to change the time setting display to [MANUAL] at the bottom left of the liquid crystal display.
l Finally, push the start/stop switch to stop the measuring after 1 hour sampling.
l Information such as sampling date, time, count value and site condition were recorded during the monitoring period.
Maintenance/Calibration
2.7 The following maintenance/calibration was required for the direct dust meters:
l Check and calibrate the meter by HVS to check the validity and accuracy of the results measured by direct reading method at 2-month intervals throughout all stages of the air quality monitoring.
24-hour TSP Monitoring
Instrumentation
2.8 High volume (HVS) samplers (Model TE-5170), completed with appropriate sampling inlets, were employed for 24-hour TSP monitoring. The sampler was composed of a motor, a filter holder, a flow controller and a sampling inlet and its performance specification complied with that required by USEPA Standard Title 40, Code of Federation Regulations Chapter 1 (Part 50). Moreover, the HVS also met all the requirements in section 2.5 of the updated EM&A Manual.
2.9
The positioning of the HVS
samplers are as follows:
l A horizontal platform was provided with appropriate support to secure the samplers against gusty wind.
l No two samplers were placed less than 2 meters apart.
l The distance between the sampler and an obstacle, such as buildings, was at least twice the height that the obstacle protrudes above the sampler.
l A minimum of 2 meters of separation from walls, parapets and penthouses was required for rooftop samples.
l A minimum of 2 meters separation from any supporting structure, measured horizontally was required.
l No furnaces or incineration flues were nearby.
l Airflow around the sampler was unrestricted.
l The sampler was more than 20 meters from the drip line.
l Any wire fence and gate, to protect the sampler, should not cause any obstruction during monitoring.
Operating/analytical procedures for the operation of HVS
2.10
Operating/analytical procedures for the air quality monitoring are
highlighted as follows:
l Prior to the commencement of the dust sampling, the flow rate of the high volume sampler was properly set (between 1.1 m3/min. and 1.4 m3/min.) in accordance with the manufacturer’s instruction to within the range recommended in USEPA Standard Title 40, CFR Part 50.
l For TSP sampling, fiberglass filters have a collection efficiency of > 99% for particles of 0.3μm diameter were used.
l The power supply was checked to ensure the sampler worked properly. On sampling, the sampler was operated for 5 minutes to establish thermal equilibrium before placing any filter media at the designated air monitoring station.
l The filter holding frame was then removed by loosening the four nuts and a weighted and conditioned filter was carefully centred with the stamped number upwards, on a supporting screen.
l The filter was aligned on the screen so that the gasket formed an airtight seal on the outer edges of the filter. Then the filter holding frame was tightened to the filter holder with swing bolts. The applied pressure should be sufficient to avoid air leakage at the edges.
l The shelter lid was closed and secured with the aluminium strip.
l The timer was then programmed. Information was recorded on the record sheet, which included the starting time, the weather condition and the filter number (the initial weight of the filter paper can be found by using the filter number).
l After sampling, the filter was removed and sent to the HOKLAS laboratory (High Precision Chemical Testing Ltd.) for weighing. The elapsed time was also recorded.
l Before weighing, all filters were equilibrated in a conditioning environment for 24 hours.
l The conditioning environment temperature should be between 25°C and 30°C and not vary by more than ±3°C; the relative humidity (RH) should be < 50% and not vary by more than ±5%. A convenient working RH is 40%.
Maintenance/Calibration
2.11 The following maintenance/calibration was required for the HVS:
l The high-volume motors and their accessories were properly maintained. Appropriate maintenance such as routine motor brushes replacement and electrical wiring checking were made to ensure that the equipment and necessary power supply are in good working condition.
l High volume samplers were calibrated at bi-monthly intervals using TE-5025A Calibration Kit through\hout all stages of the air quality monitoring.
2.12 All 1-hour TSP monitoring was conducted as scheduled in the reporting month.
2.13 No Action/Limit Level exceedance of the 1-hour TSP monitoring was recorded.
2.14 All 24-hour TSP monitoring was conducted as scheduled in the reporting month. The monitoring schedule for the reporting month is shown in Appendix D.
2.15 No Action/Limit Level exceedance of the 24-hour TSP monitoring was recorded.
2.16 The weather information for the reporting month is summarized in Appendix C.
2.17 The monitoring data and graphical presentations of 1-hour and 24-hour TSP monitoring results are shown in Appendix E and Appendix F respectively.
2.18 No exceedance was recorded for the air quality monitoring. The summary of exceedance record in reporting month is shown in Appendix H.
2.19 Site audits were carried out on a weekly basis to monitor and audit the timely implementation of air quality mitigation measures within the site boundaries of this Project. The summary of site audits is shown in Table 6.1 of this report.
2.20 According to our field observations during the monitoring, the major dust source identified at the designated air quality monitoring stations are road traffic dust, exposed site area and open stockpiles, excavation works and site vehicle movements.
3.1 According to EM&A Manuals under the EP, construction noise monitoring was conducted to monitor the construction noise arising from the construction activities. The regular monitoring frequency for each monitoring station shall be on a weekly basis and conduct one set of measurements between 0700 and 1900 hours on normal weekdays. Appendix A shows the established Action and Limit Levels for the environmental monitoring works.
3.2 Only one designated monitoring station was selected for the noise monitoring programme. Noise monitoring was conducted at the designated monitoring station (M-N3).
3.3 Table 3.1 describes the noise monitoring locations, which are also depicted in Figure 3.
Table 3.1 Noise Monitoring Stations
Monitoring
Stations |
Locations |
Location of Measurement |
M-N3 |
S.K.H. Tsoi Kung Po Secondary School |
Rooftop (above 3/F) Area |
3.4 Table 3.2 summarizes the noise monitoring equipment. Copies of calibration certificates are provided in Appendix B.
Table 3.2 Noise Monitoring Equipment
Equipment |
Model and Make |
Serial No. |
Quantity |
Sound
Calibrator |
Hangzhou Aihua
Instruments Co., Ltd. AWA6021A |
1023253 |
1 |
Integrating
Sound Level Meter |
SVANTEK SVAN
979 |
27189 |
1 |
BSWA
Technology BSWA 308 |
580238, 580156 |
2 |
Monitoring Parameters, Frequency and Duration
3.5 Table 3.3 summarizes the monitoring parameters, frequency and total duration of monitoring. The noise monitoring schedule is shown in Appendix D.
Table 3.3 Noise Monitoring Parameters, Frequency and Duration
Monitoring
Stations |
Parameter |
Period |
Frequency |
Measurement |
M-N3 |
L10(30
min.) dB(A) L90(30
min.) dB(A) Leq(30
min.) dB(A) |
0700-1900 hrs
on normal weekdays |
Once per week |
Façade |
Monitoring Methodology and QA/QC Procedure
3.6 The procedures for noise monitoring were as follows:
l The Sound Level Meter was set on a tripod at a height of 1.2 m above the ground.
l The battery condition was checked to ensure the correct functioning of the meter.
l Parameters such as frequency weighting, the time weighting and the measurement time were set as follows:
— frequency weighting : A
— time weighting : Fast
— time measurement : 30 minutes
l Prior to and after each noise measurement, the meter was calibrated using a Calibrator for 94.0 dB at 1000 Hz. If the difference in the calibration level before and after measurement was more than 1.0 dB, the measurement would be considered invalid and repeat of noise measurement would be required after re-calibration or repair of the equipment.
l The wind speed was frequently checked with the portable wind meter.
l At the end of the monitoring period, the Leq, L90 and L10 were recorded. In addition, site conditions and noise sources were recorded on a standard record sheet.
l Noise measurement was paused temporarily during periods of high intrusive noise if possible and observation was recorded when intrusive noise was not avoided.
l Noise monitoring was cancelled in the presence of fog, rain, and wind with a steady speed exceeding 5 m/s, or wind with gusts exceeding 10 m/s.
Maintenance and Calibration
3.7 The microphone head of the sound level meter and calibrator were cleaned with a soft cloth at quarterly intervals.
3.8 The sound level meter and calibrator were checked and calibrated at yearly intervals.
3.9 Immediately prior to and following each noise measurement the accuracy of the sound level meter shall be checked using an acoustic calibrator generating a known sound pressure level at a known frequency. Measurements may be accepted as valid only if the calibration levels from before and after the noise measurement agree to within 1.0 dB.
3.10 All construction noise monitoring was conducted as scheduled in the reporting month. The monitoring schedule for the reporting month is shown in Appendix D.
3.11 The Baseline Noise Level and the Noise Limit Level at the designated noise monitoring station are presented in Table 3.4.
Table 3.4 Baseline Noise Level and Noise Limit Level for Monitoring Stations
Monitoring Stations |
Baseline
Noise Level, dB (A) |
Noise Limit Level, dB (A) |
M-N3 |
67.7(1) (at 0700 – 1900 hrs on normal weekdays) |
70(*) (at 0700 – 1900 hrs on normal weekdays) |
(*) Noise Limit Level is 65 dB(A) during school
examination periods.
Note (1): The noise level due to the construction
work (CNL) was calculated by the following formula:
CNL = 10 log
(10MNL/10 – 10BNL/10)
Remarks: MNL =
Measured Noise Level, BNL = Baseline
Noise Level
3.12 No Action Level and Limit Level exceedance was recorded. The summary of exceedance record in reporting month is shown in Appendix H.
3.13 Noise monitoring results and graphical presentations are shown in Appendix G.
3.14
Site audits were carried out on a weekly basis to monitor and audit the
timely implementation of construction noise mitigation measures within the site
boundaries of this Project. The summary
of site audits are shown in Table 6.1 of this report.
3.15 According to our field observations during the monitoring, the major noise sources identified at the designated noise monitoring stations are road traffic noise, site vehicle movement, excavation works and daily school activities.
4.1
Waste generated from this
Project includes inert construction and demolition (C&D) materials and
non-inert C&D materials. Inert C&D waste includes soil, broken rock,
broken concrete and building debris, while non-inert C&D materials are made
up of C&D waste which cannot be reused or recycled and has to be disposed
of at the designated landfill sites.
4.2 The quantities of different types of waste generated in the reporting month are summarised in Table 4.1. Details of the amount of wastes generated by the major site activities of this Project during the reporting month is shown in Appendix L.
Table 4.1 Quantities of Waste Generated from the Project
Quantity |
|||||||
|
Inert C&D Materials |
Non-inert C&D Materials |
|||||
Reporting
Period |
Total
Quantity Generated (in
'000m3) |
Disposed
as Public
Fill (in '000m3) |
Others,
e.g. general
refuse (in '000m3) |
Metals (in
'000kg) |
Paper/cardboard Packaging (in
'000kg) |
Plastics (in
'000kg) |
Chemical
waste (in '000kg) |
Feb 2025 |
0.125 |
0.125 |
0.134 |
0 |
0 |
0 |
0 |
4.3
Site audits were carried out on
a weekly basis to monitor and audit to ensure that proper storage,
transportation, and disposal practices of waste materials generated during
construction activities, such as construction and demolition (C&D)
materials and general refuse are being implemented. The summary of site audits is
shown in Table 6.1 of this report. The implementation status of the waste/chemical management
measures in the reporting period are summarized in Appendix J.
5.1 According to the EM&A Manual, site audits would be undertaken during the construction phase of the Project to check that the proposed landscape and visual mitigation measures are properly implemented and maintained as per their intended objectives. Site inspections of the implementation of landscape and visual mitigation measures would be undertaken at least once every two weeks during the construction period.
5.2
Bi-weekly inspection of the
implementation of landscape and visual mitigation measures within the site
boundaries of this Project was conducted on 11 & 25 February
2025. The implementation status of the landscape
and visual mitigation measures in the reporting period are summarized in Appendix J. The summary of observations and
recommendations made for landscape and visual mitigation measures during site
audits are shown in Table 6.1 of this report.
5.3
No non-compliance of the
landscape and visual impact was recorded in the reporting month.
5.4
Should non-compliance of the landscape and visual impact occur, action
in accordance with the action plan presented in Appendix I shall be
performed.
6.1 Site audits were carried out on a weekly basis to monitor the timely implementation of proper environmental management practices and mitigation measures in the Project site.
6.2 Site audits for Contract No. HY/2019/13 were conducted on 4, 11, 18 & 25 February 2025 in the reporting month. Joint site inspection with the representative of IEC was conducted on 11 February 2025. No non-compliance was observed during the site audit.
Implementation Status of Environmental Mitigation Measures
6.3
According to Environmental
Permit, the approved EIA Report
(Register No.: AEIAR-171/2013), and the EM&A Manual
of the Project, the mitigation measures detailed in the documents are
recommended to be implemented during the construction phase. An Environmental Mitigation Implementation
Schedule (EMIS) is provided in Appendix
J.
6.4 The ET weekly site inspections were carried out during the reporting month and the observations and follow-up actions in Ho Man Tin Area are summarized in Table 6.1.
Table 6.1 Observations and Recommendations of Site Inspections
Parameters |
Date |
Observations |
Follow-up
Actions |
Water Quality |
N/A |
No environmental
deficiency was identified in the reporting period. |
N/A |
Air Quality |
N/A |
No environmental
deficiency was identified in the reporting period. |
N/A |
Noise |
N/A |
No environmental
deficiency was identified in the reporting period. |
N/A |
Waste / Chemical
Management |
4 Feb 2025 |
General refuse
should be disposed of regularly. |
General refuse has been removed. |
Land
Contamination |
N/A |
No environmental
deficiency was identified in the reporting period. |
N/A |
Landscape and Visual |
N/A |
No environmental
deficiency was identified in the reporting period. |
N/A |
Permits /Licences |
N/A |
No environmental
deficiency was identified in the reporting period. |
N/A |
Implementation Status of Event and Action Plans
6.5 The Event Action Plans for air quality, noise and landscape and visual are presented in Appendix I.
Air Quality Monitoring
l No Action/Limit Level exceedance for 1-hour TSP was recorded.
l No Action/Limit Level exceedance for 24-hour TSP was recorded.
Noise Monitoring
l No Action Level exceedance for noise was recorded.
l No Limit Level exceedance for noise was recorded.
Landscape and Visual Monitoring
l No non-conformity for landscape and visual was recorded.
Summary of Complaint, Warning, Notification of any Summons and Successful Prosecution
6.6 No environmental complaints and warnings, notifications of summons and successful prosecutions were received in the reporting month.
6.7 The summary of environmental complaint, warning, summon and notification of successful prosecution for the Project is presented in Appendix K.
6.8 Status of required submission under EP-457/2013/D during the reporting period are summarized in Table 6.2.
Table 6.2 Status of Required Submission under Environmental Permit
EP Condition (EP-457/2013/D) |
Submission |
Submission Date |
Condition
3.4 |
Monthly
EM&A Report (January
2025) |
13 February 2025 |
7.1 Major site activities undertaken for the coming two months include:
l
E&M Installation
l
T&C
l
FSI
7.2 Key environmental issues in the coming two months include:
l Stockpile accumulation on-site;
l Water spraying for dust generating activities and on haul road;
l Wastewater and runoff discharge from site;
l Coverage of open manholes to avoid dirty runoff to drainage system;
l Noise from operation of the equipment, especially for excavation works and machinery onsite;
l Accumulation of general refuse and construction waste on-site;
l Proper storage of construction materials on-site; and
l Storage of chemicals/fuel and chemical waste/waste oil on-site.
Monitoring Schedule for Next Month
7.3
The tentative environmental monitoring schedules for next month are
shown in Appendix D.
8.1 This is the 14th Monthly EM&A Report which presents the EM&A works undertaken in Ho Man Tin area during the reporting month from 1st February 2025 – 28th February 2025 in accordance with the EM&A Manual and the requirements under the EP.
Air Quality Monitoring
8.2
All 1-hr TSP monitoring was conducted as scheduled in the reporting
month.
8.3
No Action/Limit Level exceedance was recorded for all 1-hour TSP
monitoring in the reporting month.
8.4 All 24-hr TSP monitoring was conducted as scheduled in the reporting month.
8.5
No Action/Limit Level exceedance was recorded for all 24-hour TSP
monitoring in the reporting month.
Construction Noise Monitoring
8.6
All construction noise monitoring was conducted as scheduled in the
reporting month.
8.7
No Action Level and Limit Level exceedance was recorded.
Landscape and visual
8.8 No non-compliance was recorded in the reporting month.
Site Audit
8.9
4 ET joint weekly environmental
site inspections were conducted in the reporting month. Joint weekly site inspections with the representative of ET,
Engineer Representative and the Contractor for Contract No. HY/2019/13 were
conducted on 4, 11, 18 &
25 February 2025,
whereas joint site inspection with the representative of IEC was conducted on 11 February
2025. All environmental deficiencies observed
during site inspections were rectified by the Contractor.
Complaint, Notification of Summons and Successful Prosecution
8.10
No environmental complaints and notifications of summons and successful
prosecutions were received in the reporting month.
I. Introduction
This is the 66th Monthly EM&A
Report prepared by Fugro Technical Services Limited for the Contract No.
HY/2018/08 Central Kowloon Route – Central Tunnel. The Contract No. HY/2018/08
commenced on 19 September 2019. This report summarized the monitoring results
and audits findings of the EM&A programme under the issued EP (EP No.:
EP-457/2013/D) and in accordance with the EM&A Manual during the reporting
period from 01/02/2025 to 28/02/2025.
II. Summary of Main
Works Undertaken and Key Measures Implemented
The main construction works carried out in the
reporting period were as follow:
Yau Ma Tei
· Site
reinstatement work.
Ma Tau Kok
· Plant and
material lifting;
· Cut and
cover construction;
· Dismantling
work of noise enclosure.
Ho Man Tin
· Slope work
maintenance.
III. Summary of
Exceedances, Investigation and Follow-up
The last impact monitoring conducted by ET of
Contract HY/2018/08 at M-A3/ M-N3 was on 27 December 2023. Impact monitoring at
M-A3/ M-N3 was subsequently conducted by Environmental Team of Contract
HY/2019/13 since January 2024. The monitoring results at M-A3 and M-N3 are
presented in the monthly EM&A Report prepared by Contract No. HY/2019/13.
No Action and Limit Level exceedance was recorded
for construction dust monitoring in the reporting month.
No Action and Limit Level exceedance was recorded
for construction noise monitoring in the reporting month.
IV. Complaint
Handling, Prosecution and Public Engagement.
No complaints were received in the reporting month.
The complaint cases in February 2025 are summarized
in Table I.
Table I Environmental Complaints Log
Complaint
Log No. |
Date of
Complaint |
Received
From |
Nature of
Complaint |
Status |
Nil |
Nil |
Nil |
Nil |
No notification of summons and prosecutions were
received in the reporting period.
No public engagement activities were conducted in
the reporting period.
V. Reporting
Change
There were no reporting changes during the
reporting month.
VI. Future Key
Issues
The main works will be anticipated in the next
reporting period are as follow:
Yau Ma Tei
· Site
reinstatement work.
Ma Tau Kok
· Plant and
material lifting;
· Cut and
cover construction;
· Dismantling
work of noise enclosure.
Ho Man Tin
· Slope work
maintenance.
The recommended mitigation measures corresponding
to the main works in the next reporting period are listed as follow:
· Good
relationship shall be maintained with the nearby sensitive receivers/
stakeholders which may be affected by the construction works such as providing
better/ more detail information of the work nature and inform in advance of the
works to the nearby residents;
· Any excavated,
stockpile of dusty material or load of dusty materials on a vehicle leaving a
construction site should be covered entirely by impervious sheeting;
· All
construction plants / machineries should be checked / serviced on a regular
basis during the courses of construction to minimize the emission of noise
generation and eliminate dark smoke emission;
· All C&D
materials generated should be transported and stored at temporary storage area.
Suitable materials should be sorted for reuse on-site;
· Every vehicle
shall be cleaned thorough at the designated wheel washing area onsite;
· Wastewater
generated from drilling shall be properly collected for reuse or treated by
wastewater treatment facilities before discharge;
· Provision of
drip trays for equipment likely cause spillage of chemical / fuel, and provide
routine maintenance;
· Erecting
temporary noise barrier for noisy Powered Mechanical Equipment (PME) and
deployment of Quality Powered Mechanical Equipment (QPME) as many
as practicable;
· Conditions in
the Environmental Permit and License should be followed;
· All recommended
mitigation measures specified in the approved EIA Report and EM&A Manual
shall be implemented;
· All vehicles
should be cleaned before leaving the construction site to ensure no muddy
deposited by them on roads.
The following EP submissions were submitted during
the reporting month:
Table II Status of Required Submission under Environmental
Permit
EP Condition |
Submission |
Submission Date |
3.4 |
Monthly EM&A Report (January 2024) |
5
February 2025 |
Contents
1.3 Construction Programme and Activities
1.4 Works undertaken during the month
1.5 Status of Environmental Licences,
Notification and Permits
2 ENVIRONMENTAL
MONITORING REQUIREMENTS
2.1 Construction
Dust and Noise Monitoring Locations
2.2 Construction
Dust Monitoring
2.3 Construction
Noise Monitoring
3 ENVIRONMENTAL
MONITORING RESULTS
3.1 Construction
Dust Monitoring
3.2 Construction
Noise Monitoring
5 ENVIRONMENTAL
COMPLAINT AND NON-COMPLIANCE
5.1 Complaint
Handling, Prosecution and Public Engagement
5.2 Summary of
Environmental Non-Compliance
5.3 Summary of
Monitoring Exceedance
8 CONCLUSION
AND RECOMMENDATIONS
Tables
Table I – Environmental
Complaints Log
Table II – Status of Required Submission under Environmental Permit
Table 1.1 – Contact Information of Key Personnel
Table 1.2 – Environmental Licenses, Notification and Permits
Summary
Table 2.1 – Construction Dust and Noise Monitoring Location
Table 2.2 – Construction Noise Monitoring Parameters, Frequency and
Duration
Table 4.1 – Observations and Recommendation of Site Inspection in
the Reporting Period
Table 5.1 – Environmental Complaints Log
Table 6.1 – Status of Required Submission under Environmental
Permit
Figures
Figure 1 The Site
Layout Plan of the Contract
Figure 2.1 The Location
of the Construction Dust and Noise Monitoring Stations (Ho Man Tin)
Figure 2.2 The Location
of the Construction Dust and Noise Monitoring Stations (Ma Tau Kok)
Figure 2.3 The Location
of the Construction Dust and Noise Monitoring Stations (Yau Ma Tei)
Appendices
Appendix A Construction Programme
Appendix B Project Organization Chart
Appendix C Event and Action Plan
Appendix D Implementation Status of
Environment Mitigation Measures (Construction Phase)
1.1.1 In order
to meet the traffic demand and relieve traffic congestion on the existing
east-west roads across Central Kowloon, Central Kowloon Route (CKR)
(hereinafter referred to as “the Project”) is proposed which is a 4.7 km long
dual 3-lane trunk road in Central Kowloon linking Yau
Ma Tei Interchange in West Kowloon with the road network on Kai Tak
Development and Kowloon Bay in East Kowloon.
1.1.2 The Central
Kowloon Route – Design and Construction Environmental Impact Assessment Report
(Register No.: AEIAR-171/2013) was approved with conditions by the
Environmental Protection Department (EPD) on 11 July 2013. An Environmental
Permit (EP-457/2013) was issued on 9 August 2013. A variation of EP
(VEP-594/2021) was applied on 26 May 2021 and the latest EP (EP-457/2013/D) was
issued by EPD on 15 June 2021.
1.1.3 Contract No.
HY/2018/08 Central Kowloon Route – Central Tunnel (hereinafter referred to as
“the Contract”), is one of the contracts of CKR which included the construction
of the central tunnel, cut-and-cover tunnels at Yau Ma Tei and Ma Tau
Kok and construction of piles and diaphragm walls for Ho Man Tin ventilation
building.
1.1.4 Fugro Technical
Services Limited (FTS) was appointed by Bouygues Travaux Publics (BTP) as the
Environmental Team (ET) under the Contract no. HY/2018/08 to execute the
environmental monitoring and audit (EM&A) programme under the issued EP (EP
No.: EP-457/2013/D) and in accordance with the EM&A Manual.
1.1.5 This is the 66th Monthly
EM&A Report prepared by FTS for the Contract No. HY/2018/08 Central Kowloon
Route – Central Tunnel. The Contract No. HY/2018/08 commenced on 19 September
2019. This report summarized the monitoring results and audits findings of the
EM&A programme under the issued EP (EP No.: EP-457/2013/D) and in
accordance with the EM&A Manual during the reporting period from 01/02/2025
to 28/02/2025.
1.2.1 The Project
Organization structure is shown in Appendix B. The key personnel
contact names and numbers are summarized in Table 1.1.
Table 1.1 Contact
Information of Key Personnel
Party |
Position |
Name |
Telephone |
Highways Department (HyD) |
E13/CKR |
Mr. Joe Lam |
2762 3380 |
Arup-Mott MacDonald Joint Venture (AMMJV) |
Senior Resident Engineer |
Mr. Ben Poon |
3619 5967 |
ERM-Hong Kong, Limited (ERM) |
Independent Environmental Checker (IEC) |
Ms. Mandy To |
2271 3000 |
Bouygues Travaux Publics (BTP) |
Environmental Manager |
Mr. Simon Wong |
9281 4346 |
Fugro Technical Services Limited |
ET Leader |
Mr. Calvin Leung |
3565 4441 |
1.3 Construction Programme and Activities
1.3.1 The
construction phase of this Contract under the EP commenced in October 2019. The

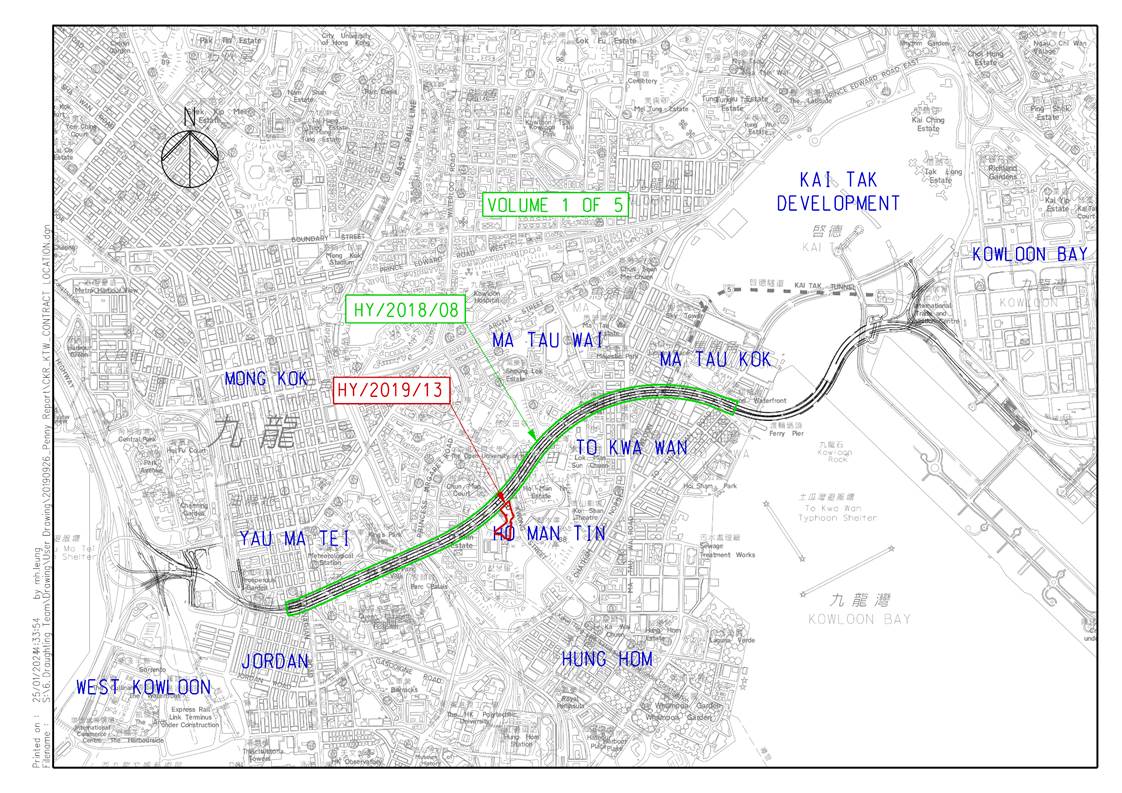

site layout plan of the Contract is shown in Figure 1.
1.3.2 The
construction programme of this Contract is shown in Appendix A.
1.4 Works undertaken during the month
1.4.1 The main
construction works carried out in the reporting period were as follow:
Yau Ma Tei
· Site
reinstatement work.
Ma Tau Kok
· Plant and
material lifting;
· Cut and
cover construction;
· Dismantling
work of noise enclosure.
Ho Man Tin
· Slope work
maintenance.
1.5 Status of Environmental Licences, Notification and Permits
1.5.1 A summary of
the relevant permits, licenses and/or notifications on environmental protection
for this Contract is presented in Table 1.2.
Table 1.2 Environmental
Licenses, Notification and Permits Summary
Reference No |
Valid From |
Valid Till |
|
Form NB |
448930, 448970, 448971 |
Mid-Sep 2019 |
NA |
Billing Account for
Disposal of C&D waste |
Account no. 7034790 |
06 Aug 2019 |
NA |
Chemical Waste Producer
Registration (Ho Man Tin Construction site) |
5111-236-B2557-02 |
25 Sep 2019 |
NA |
Chemical Waste Producer
Registration (Yau Ma Tei Construction site) |
5213-225-B2557-05 |
19 Apr 2021 |
NA |
Chemical Waste Producer
Registration (Ma Tau Kok Construction site) |
5213-247-B2557-06 |
19 Apr 2021 |
NA |
Construction Noise Permit |
|||
Construction Noise Permit (Yau
Ma Tei Construction site) |
GW-RE1100-24 |
1 Sep 2024 |
28 Feb 2025 |
Construction
Noise Permit (Ma Tau Kok Construction site) |
GW-RE1111-24 |
1 Sep 2024 |
28 Feb 2025 |
Water Discharge License |
|||
Water Discharge License |
WT00035436-2019 (Portion 18) |
02 Apr 2020 |
30 Apr 2025 |
WT00037723-2021 (Yau Ma Tei Construction site) |
07 Apr 2021 |
30 Apr 2026 |
|
WT00037883-2021 (Ma Tau Kok Construction site) |
30 Apr 2021 |
30 Apr 2026 |
|
WT00042304-2022 (Sheung Lok Street) |
13 Oct 2022 |
31 Oct 2027 |
|
WT10001427-20233 (Ma Hang Chung Road) |
4 Dec 2023 |
31 Dec 2028 |
|
WT00041154-2022 (Kai Tak Barging Facility) |
12 Jul 2022 |
31 Jul 2027 |
2 ENVIRONMENTAL MONITORING
REQUIREMENTS
2.1 Construction Dust and Noise Monitoring Locations
2.1.1 Three construction dust monitoring locations and
five construction noise monitoring locations pertinent to the Project have been
identified based on the approved EM&A Manual for the Project. The locations
of the construction dust and noise monitoring stations are summarized in Table
2.1 as displayed in Figures 2.1 - 2.3.
Table 2.1 Construction
Dust and Noise Monitoring Locations
Dust Monitoring Station ID |
Noise Monitoring Station ID |
Monitoring Location |
M-A3 |
M-N3 |
SKH Tsoi Kung
Po Secondary School |
/ |
E-N12a |
19 Hing Yan
Street |
E-A14a |
E-N21a |
Block B of
Merit Industrial Centre |
W-A6 |
/ |
Man Cheong
building |
/ |
W-N18 |
Hydan Place |
/ |
W-N25A |
Prosperous
Garden Block 1 |
Notes:
1. The dust and
noise monitoring stations proposed in the EM&A Manual for M-A6/ M-N6 (i.e. Ko
Fai House, Kwun Fai Court) was not available for impact dust and noise
monitoring, therefore impact monitoring was conducted at M-A3/ M-N3 as an
alternative which was agreed by the ER, IEC and EPD;
2. The noise
monitoring station proposed in the EM&A Manual for E-N12 (i.e. Grand
Waterfront Tower 3) was not available for impact dust and noise monitoring,
therefore impact monitoring was conducted at E-N12a as an alternative which was
agreed by the ER, IEC and EPD;
3. The dust and
noise monitoring stations proposed in the EM&A Manual for E-A14 (i.e. Wyler
Gardens) and E-N21 (i.e Hang Chien Court Block J) was not available for
impact dust and noise monitoring, therefore impact monitoring was conducted at
E-A14a/ E-N21a as an alternative which was agreed by the ER, IEC and EPD;
4. The dust
monitoring stations proposed in the EM&A Manual for W-A5 (i.e. The
Coronation) was not available for impact dust monitoring, therefore impact
monitoring was conducted at W-A6 as an alternative which was agreed by the ER,
IEC and EPD.
2.1.2 The last impact monitoring conducted by ET of
Contract HY/2018/08 at M-A3/ M-N3 was on 27 December 2023. Impact monitoring at
M-A3/ M-N3 was subsequently conducted by Environmental Team of Contract
HY/2019/13 since January 2024 (Figure 2.1).
2.1.3 The
construction dust and noise monitoring locations at M-A3 and M-N3 are covered
by Contract No. HY/2019/13 Central Kowloon Route – Buildings, Electrical and
Mechanical Works. The monitoring results at M-A3 and M-N3 are presented in the
monthly EM&A Report prepared by Contract No. HY/2019/13.
2.1.4 The
construction dust and noise monitoring locations at E-A14a, E-N12a and E-N21a
are now covered by Contract No. HY/2014/07 Central Kowloon Route – Kai Tak
West. The monitoring results at E-A14a, E-N12a and E-N21a in the reporting
month are presented in the monthly EM&A Report prepared by Contract No.
HY/2014/07.
2.1.5 The
construction dust and noise monitoring locations at W-A6, W-N18 and W-N25A are
now covered by Contract No. HY/2014/08 Central Kowloon Route –Yau
Ma Tei East. The monitoring results at W-A6, W-N18 and W-N25A in the
reporting month are presented in the monthly EM&A Report prepared by
Contract No. HY/2014/08.
2.2 Construction Dust Monitoring
Monitoring Requirement
2.2.1 In accordance
with the approved EM&A Manual, 1-hour and 24-hour Total Suspended
Particulates (TSP) levels should be measured at the designated air quality
monitoring stations to indicate the impacts of construction dust on air
quality. Regular Impact 24-hour TSP monitoring should be carried out for at
least once every 6 days, and 1-hour TSP monitoring should be done at least 3
times every 6 days when the highest dust impact occurs.
Monitoring Equipment
2.2.2 24-hour TSP air
quality monitoring was performed using High Volume Sampler (HVS) deployed at
the designated monitoring station. The HVS shall meet all the requirements of
the EM&A Manual.
2.2.3 A portable
direct reading dust meter was used to carry out the 1-hour TSP monitoring.
2.3 Construction Noise Monitoring
Monitoring Requirement
2.3.1 In accordance
with the EM&A Manual, impact noise monitoring should be conducted at the
designated noise monitoring stations for at least once a week during the
construction phase of the Project. The parameters, frequency and duration of
impact noise monitoring is summarized in Table 2.2.
Table 2.2 Construction
Noise Monitoring Parameters, Frequency and Duration
Parameter |
Duration |
Frequency |
A-weighted
equivalent continuous sound pressure level (Leq). L10 and L90 were also
recorded |
30 minutes |
At least once
per week |
Monitoring Equipment
2.3.2 Noise
monitoring was performed using sound level meter at the designated monitoring
station. The sound level meters deployed comply with the International
Electrotechnical Commission Publications 651:1979 (Type 1) and 804:1985 (Type
1) specifications. Acoustic calibrator was deployed to check the sound level
meters at a known sound pressure level.
2.4.1 As per the
EM&A Manual, the landscape and visual mitigation measures shall
be implemented and site inspections should be undertaken once every
two weeks during the construction period. A summary of the implementation
status is presented in Section 4.
3 ENVIRONMENTAL MONITORING
RESULTS
3.1 Construction Dust Monitoring
3.1.1 The last impact monitoring conducted by ET of
Contract HY/2018/08 was on 27 December 2023. Impact monitoring at M-A3 was
subsequently conducted by Environmental Team of Contract HY/2019/13 since
January 2024. The monitoring results at M-A3 and M-N3 are presented in the
monthly EM&A Report prepared by Contract No. HY/2019/13.
3.1.2 No Action and
Limit Level exceedance was recorded for construction dust monitoring in the
reporting month.
3.2 Construction Noise Monitoring
3.2.1 The last impact
monitoring conducted by ET of Contract HY/2018/08 was on 27 December 2023.
Impact monitoring at M-N3 was subsequently conducted by Environmental Team of
Contract HY/2019/13 since January 2024. The monitoring results at M-A3 and M-N3
are presented in the monthly EM&A Report prepared by Contract No.
HY/2019/13.
3.2.2 No Action and
Limit Level exceedance was recorded for construction noise monitoring in the
reporting month.
3.3.1 Auditing of waste management practices during
regular site inspections confirmed that the waste generated during construction
were properly, stored, handled and disposed of in general. The Contractor was responsible for the
implementation of any mitigation measures to reduce waste or redress issues
arising from the waste materials.
3.3.2 The implemented
environmental mitigation measures for the waste management in the reporting
period are summarized in Appendix D. The summary of observations
and recommendations made for waste management during the site inspections are
presented in Table 4.1.
3.3.3 Monthly summary
of waste flow table is detailed in Appendix F.
3.4.1 Bi-weekly
inspections of the implementation of landscape and visual mitigation measures
were conducted on 11 and 25 February 2025. The implementation the landscape and
visual mitigation measures in the reporting period are summarized in Appendix
D. The summary of observations and recommendations made for landscape and
visual mitigation measures during the site inspections are presented in Table
4.1.
3.4.2 The Event and
Action Plan for landscape and visual during construction phase is given
in Appendix C.
4 ENVIRONMENTAL SITE
INSPECTION AND AUDIT
4.1.1 Site
inspections were carried out on a weekly basis to monitor the implementation of
proper environmental pollution control and mitigation measures for the Project.
A summary of the mitigation measures implementation status is provided in Appendix
D.
4.1.2 In the
reporting month, four site inspections were carried out on 4 (with IEC), 11, 18
and 25 February 2025. Details of observations recorded during the site
inspections are presented in Table 4.1.
Table 4.1 Observations
and Recommendation of Site Inspection in the Reporting Period
Environmental
Aspect |
Date |
Observations,
Reminders, and Recommendations |
Follow-up
Actions |
Air Quality |
Nil |
Nil |
Nil |
Noise |
Nil |
Nil |
Nil |
Water Quality |
Nil |
Nil |
Nil |
Waste Management |
Nil |
Nil |
Nil |
Landscape and
Visual |
Nil |
Nil |
Nil |
Permit/
Licenses |
Nil |
Nil |
Nil |
5 ENVIRONMENTAL COMPLAINT AND
NON-COMPLIANCE
5.1 Complaint Handling, Prosecution and Public
Engagement
5.1.1 No complaints were received in the reporting month.
5.1.2 The complaint
cases in February 2025 are summarized in Table 5.1.
Table 5.1 Environmental
Complaints Log
Complaint
Log No. |
Date of
Complaint |
Received
From |
Nature of
Complaint |
Status |
Nil |
Nil |
Nil |
Nil |
Nil |
5.1.3 Cumulative
complaint log, summaries of complaints, notification of summons and successful
prosecutions are presented in Appendix E.
5.1.4 No public
engagement activities were conducted in the reporting period.
5.2 Summary of Environmental Non-Compliance
5.2.1 No
environmental non-compliance was recorded in the reporting period.
5.3 Summary of Monitoring Exceedance
5.3.1 The last impact
monitoring conducted by ET of Contract HY/2018/08 at M-A3/ M-N3 was on 27
December 2023. Impact monitoring at M-A3/ M-N3 was subsequently conducted by
Environmental Team of Contract HY/2019/13 since January 2024. The monitoring results at M-A3 and M-N3 are presented in
the monthly EM&A Report prepared by Contract No. HY/2019/13.
5.3.2 No Action and
Limit Level exceedance was recorded for construction dust monitoring in the
reporting month.
5.3.3 No Action and
Limit Level exceedance was recorded for construction noise monitoring in the
reporting month.
6 IMPLEMENTATION STATUS OF
ENVIRONMENTAL MITIGATION MEASURE
6.1.1 The Contractor
had implemented environmental mitigation measures and requirements as stated in
the EIA Report, the EP and EM&A Manual. The implementation status of the
environmental mitigation measures during the reporting period is summarized
in Appendix D. Status of required submissions under the EP during
the reporting period is summarised in Table 6.1.
Table 6.1 Status
of Required Submission under Environmental Permit
EP Condition |
Submission |
Submission Date |
3.4 |
Monthly EM&A Report (January 2024) |
5 February 2025 |
7.1.1 The main works
will be anticipated in the next reporting period are as follow:
Yau Ma Tei
· Site
reinstatement work.
Ma Tau Kok
· Plant and
material lifting;
· Cut and
cover construction;
· Dismantling
work of noise enclosure.
Ho Man Tin
· Slope work
maintenance.
7.1.2 The recommended
mitigation measures corresponding to the main works in the next reporting
period are listed as follows:
· Good
relationship shall be maintained with the nearby sensitive receivers/
stakeholders which may be affected by the construction works such as providing
better/ more detail information of the work nature and inform in advance of the
works to the nearby residents;
· Any excavated,
stockpile of dusty material or load of dusty materials on a vehicle leaving a
construction site should be covered entirely by impervious sheeting;
· All
construction plants / machineries should be checked / serviced on a regular
basis during the courses of construction to minimize the emission of noise
generation and eliminate dark smoke emission;
· All C&D
materials generated should be transported and stored at temporary storage area.
Suitable materials should be sorted for reuse on-site;
· Every vehicle
shall be cleaned thorough at the designated wheel washing area onsite;
· Wastewater
generated from drilling shall be properly collected for reuse or treated by
wastewater treatment facilities before discharge;
· Provision of
drip trays for equipment likely cause spillage of chemical / fuel, and provide
routine maintenance;
· Erecting
temporary noise barrier for noisy Powered Mechanical Equipment (PME) and
deployment of Quality Powered Mechanical Equipment (QPME) as many
as practicable;
· Conditions in
the Environmental Permit and License should be followed;
· All recommended
mitigation measures specified in the approved EIA Report and EM&A Manual
shall be implemented;
· All vehicles
should be cleaned before leaving the construction site to ensure no muddy
deposited by them on roads.
8 CONCLUSION AND
RECOMMENDATIONS
8.1.1 The 66th Monthly
EM&A Report for the Contract No. HY/2018/08 Central Kowloon Route – Central
Tunnel summarized the monitoring results and audits findings of the EM&A
programme under the issued EP (EP No.: EP-457/2013/D) and in accordance with
the EM&A Manual during the reporting period from 01/02/2025 to 28/02/2025.
8.1.2 No construction noise monitoring was conducted in
the reporting month as the site had been handed over to Contract No. HY/2019/13
on 30 December 2023. Impact monitoring at M-A3/ M-N3 has been conducted by
Environmental Team (HY/2019/13) since January 2024.
8.1.3 No Action and
Limit Level exceedance was recorded for construction noise monitoring in the
reporting month. No Action and Limit Level exceedance was recorded for
construction dust monitoring in the reporting month.
8.1.4 Weekly
environmental site inspections were conducted during the reporting period. In
general, the Contractor had implemented environmental mitigation measures and
requirements as stated in the EIA Report, the EP and EM&A Manual.
8.1.5 No complaints
were received in the reporting month.
8.1.6 No
environmental related prosecutions or notification of summons were received in
the reporting period.
8.1.7 No
environmental non-compliance was recorded in the reporting period.
8.1.8 According to
the environmental site inspections performed in the reporting month, the
following recommendations were provided:
Air Quality Impact
· No specific
observation was identified in the reporting month.
Construction Noise Impact
· No specific
observation was identified in the reporting month.
Water Quality Impact
· No specific
observation was identified in the reporting month.
Waste Management
· No specific
observation was identified in the reporting month.
Landscape and Visual Impact
· No specific
observation was identified in the reporting month.
Permit/ Licenses
· No specific
observation was identified in the reporting month.
